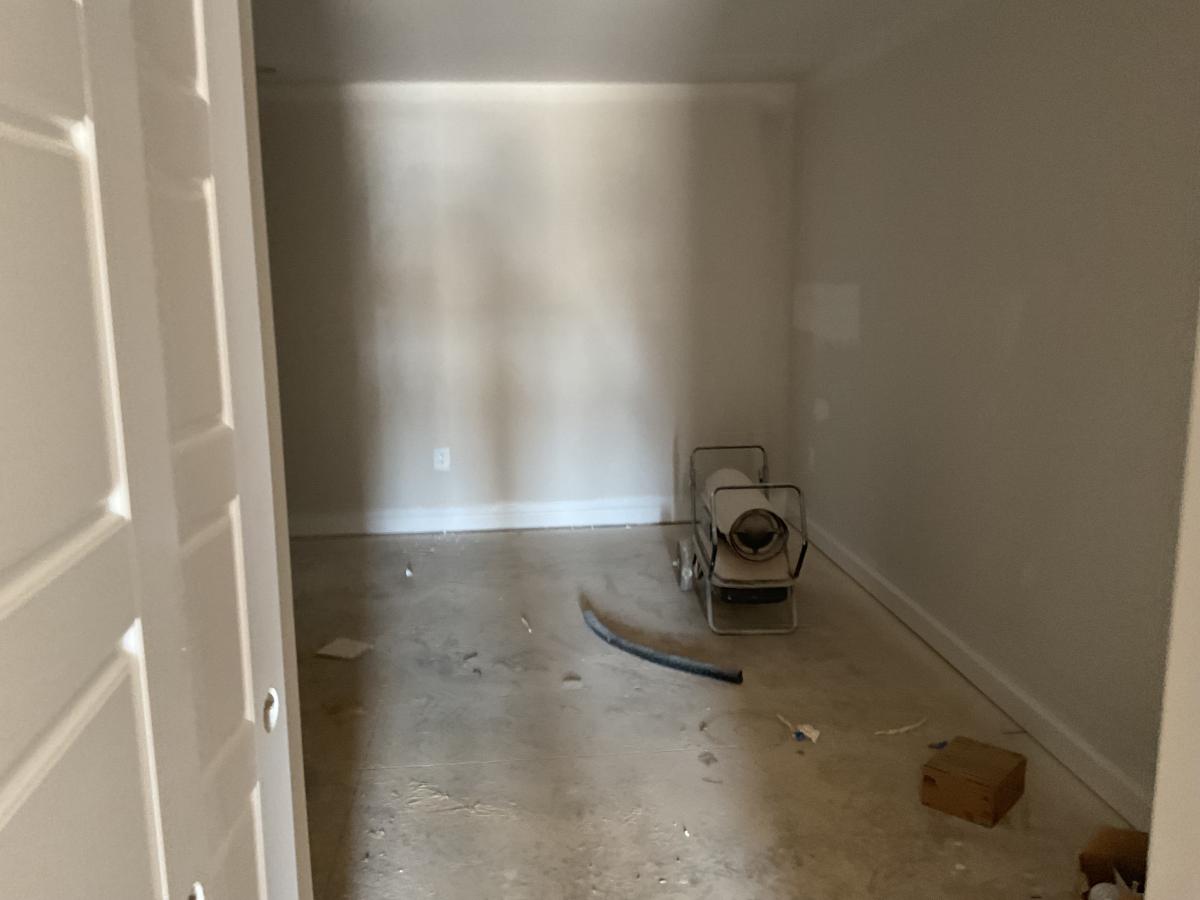

| Finished Bonus Room | ||||

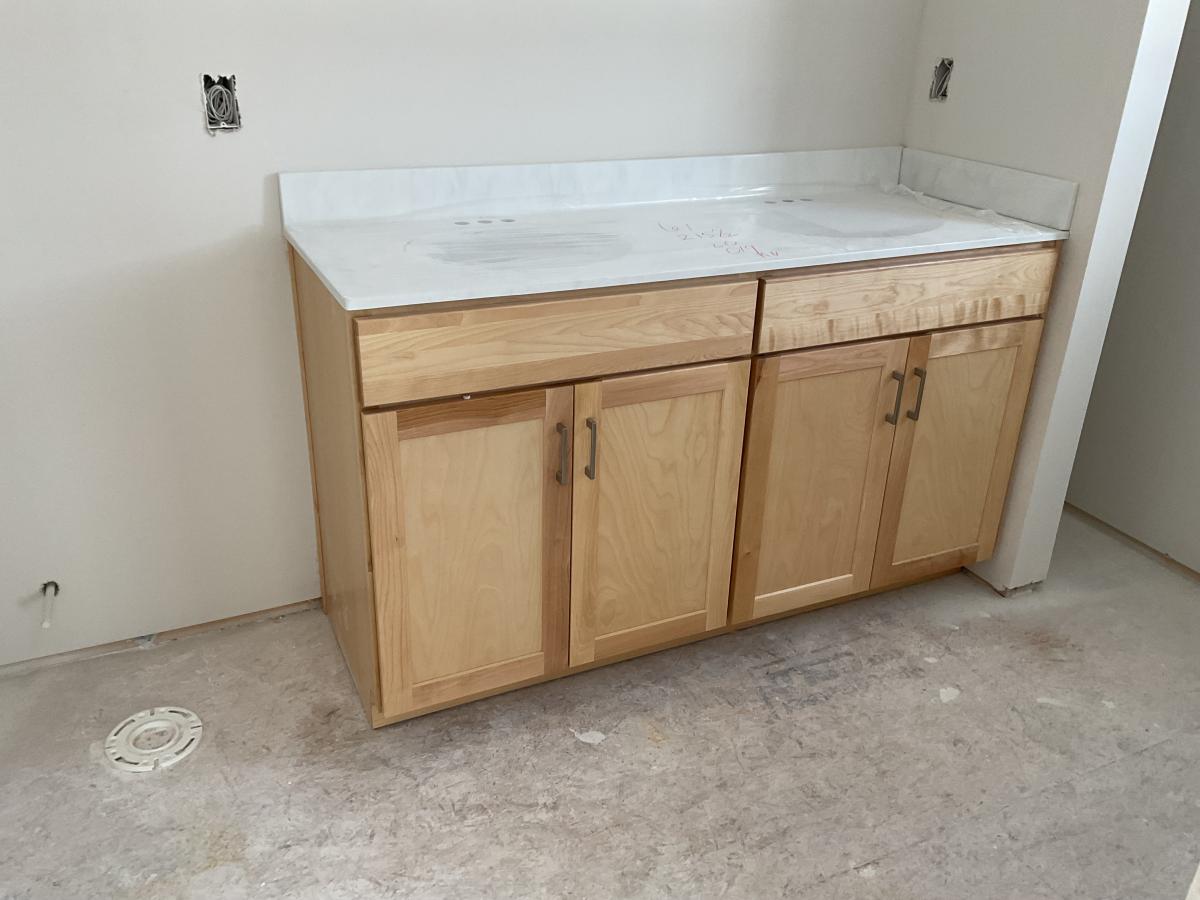

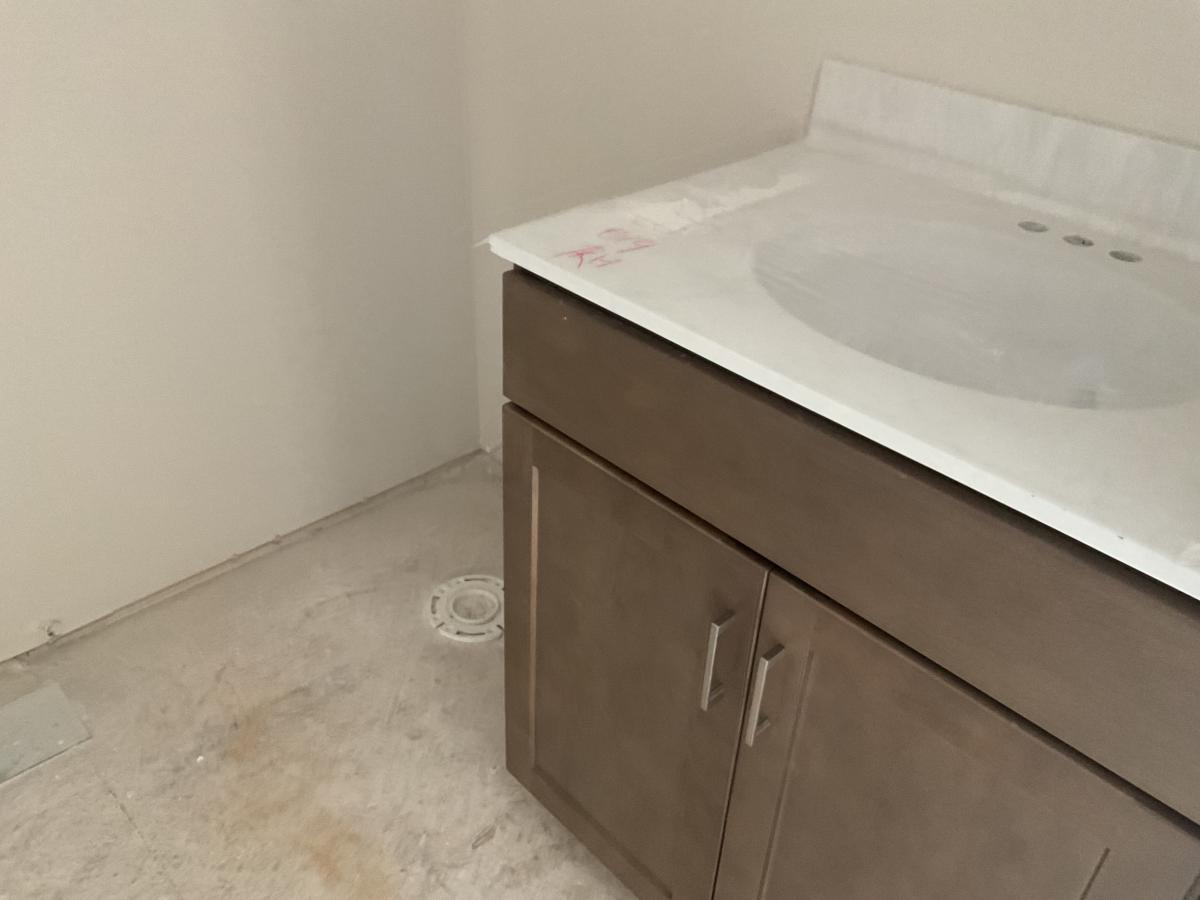

| Finished Bonus Bath | ||||
| Quartz Level 0 | ||||

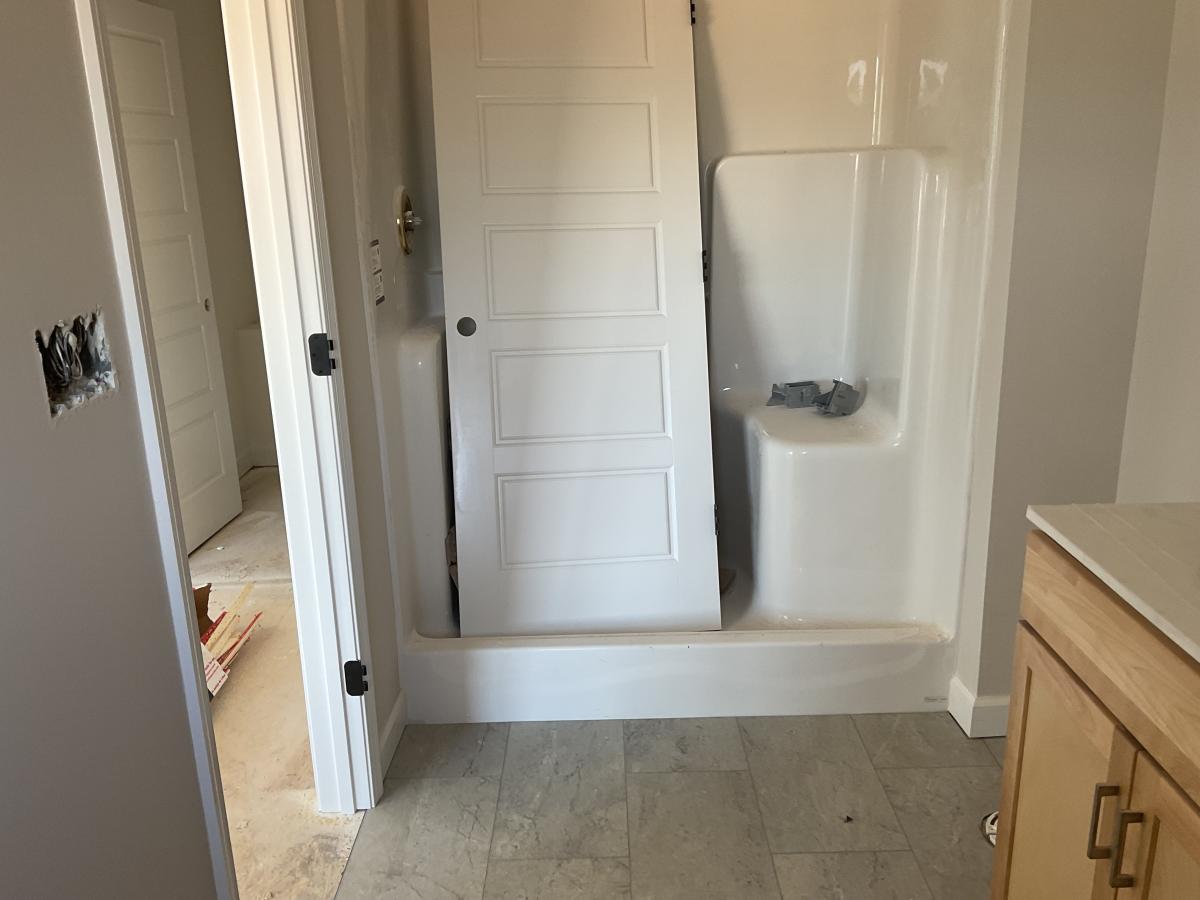

| Changing upstairs hall bathtub to 5 foot walk in shower | ||||
| Microwave vented to exterior | ||||
| wifi enabled Thermostat | ||||
| Sun | Nov 2 | Settlement Agent Confirmed (0) | 10/16: sent to Brittany | |
| Sun | Nov 2 | Order Tubs / Showers (0) | ||
| Sun | Nov 2 | Framing III (8) * | ||
| Wed | Nov 12 | Verify Window & Roof Structure (0) | ||
| Wed | Nov 12 | Install Stairs (0) * | ||
| Wed | Nov 12 | Windows & Doors (0) * | ||
| Wed | Nov 12 | House Number and Status in Window (0) | ||
| Wed | Nov 12 | Roofing (0) * | ||
| Wed | Nov 12 | Order Cabinets (0) | ||
| Wed | Nov 12 | Order Appliances (0) | ||
| Wed | Nov 12 | Deck (0) | ||
| Wed | Nov 12 | Gutters (0) | ||
| Wed | Nov 12 | Driveway (0) * | ||
| Wed | Nov 12 | Patio (0) | ||

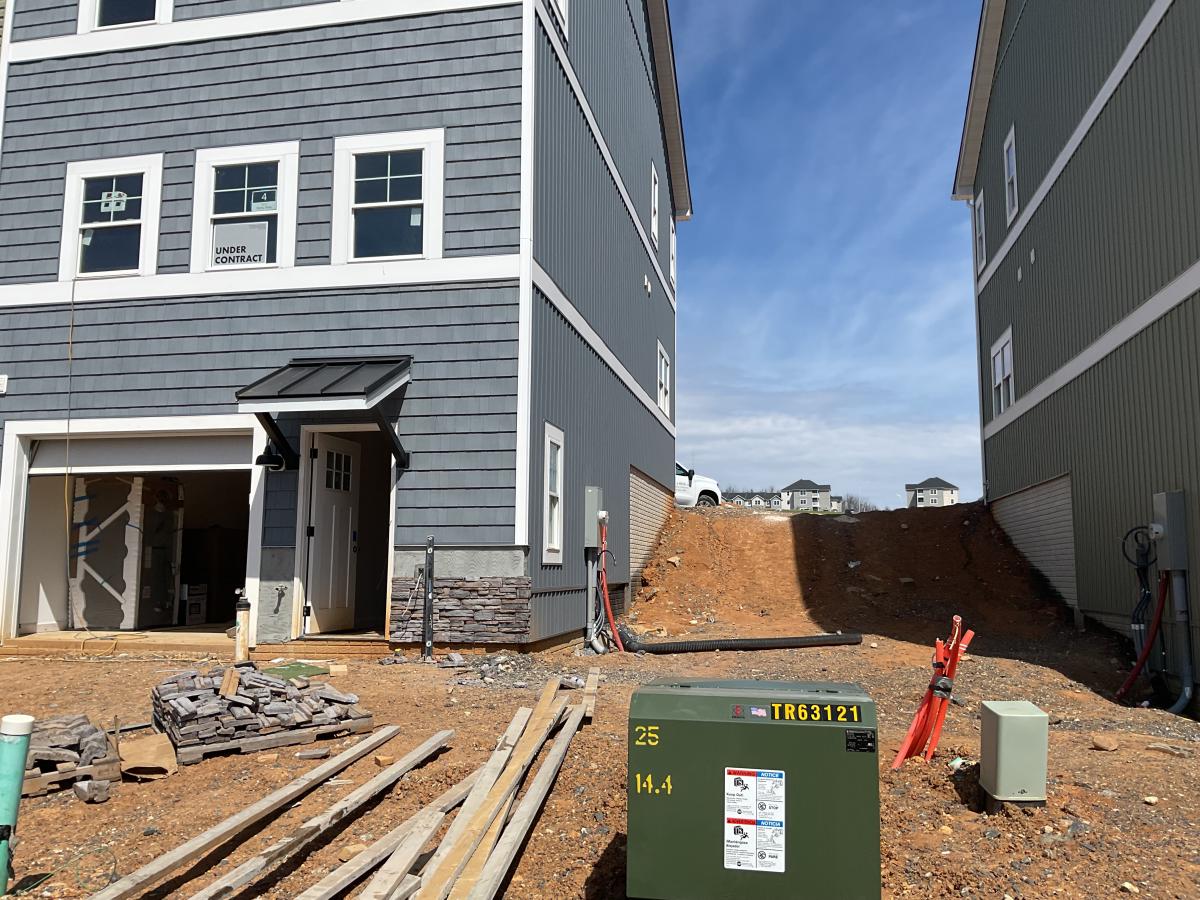

| Wed | Nov 12 | Privacy Divider / Fence (0) * | ||

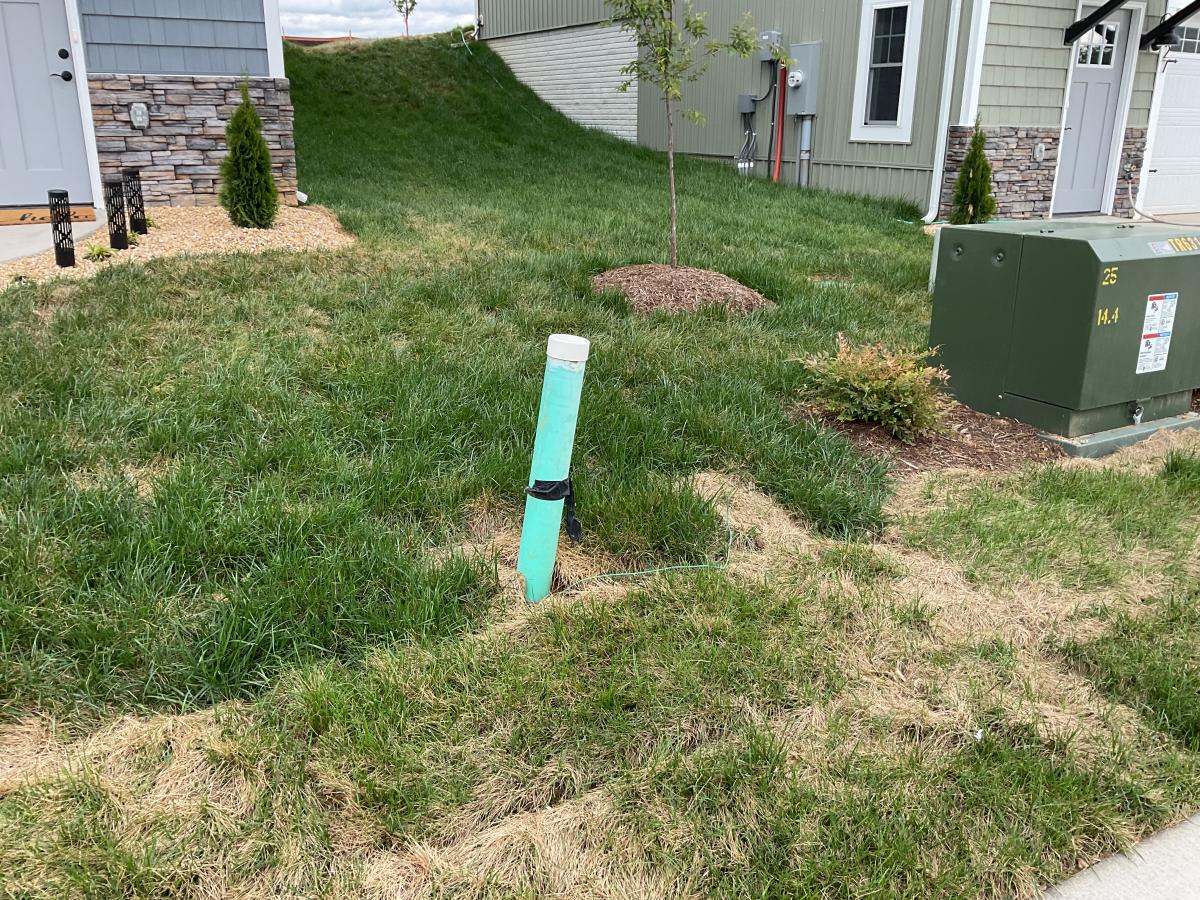

| Wed | Nov 12 | Sod / Seed / Landscaping (0) | ||
| Wed | Nov 12 | HVAC Rough In (4) | ||
| Tue | Nov 18 | Rough In Microwave Vent (0) | ||
| Tue | Nov 18 | Plumbing Rough In (4) | ||
| Mon | Nov 24 | Electric Rough In (4) | ||
| Fri | Nov 28 | Inspection (Rough In HVAC) (1) | ||
| Mon | Dec 1 | Inspection (Rough In Plumbing) (1) | ||
| Tue | Dec 2 | Inspection (Rough In Electric) (1) | ||
| Wed | Dec 3 | Inspection (Framing) (1) * | ||
| Thu | Dec 4 | Inspection (Deck Piers) (0) | ||

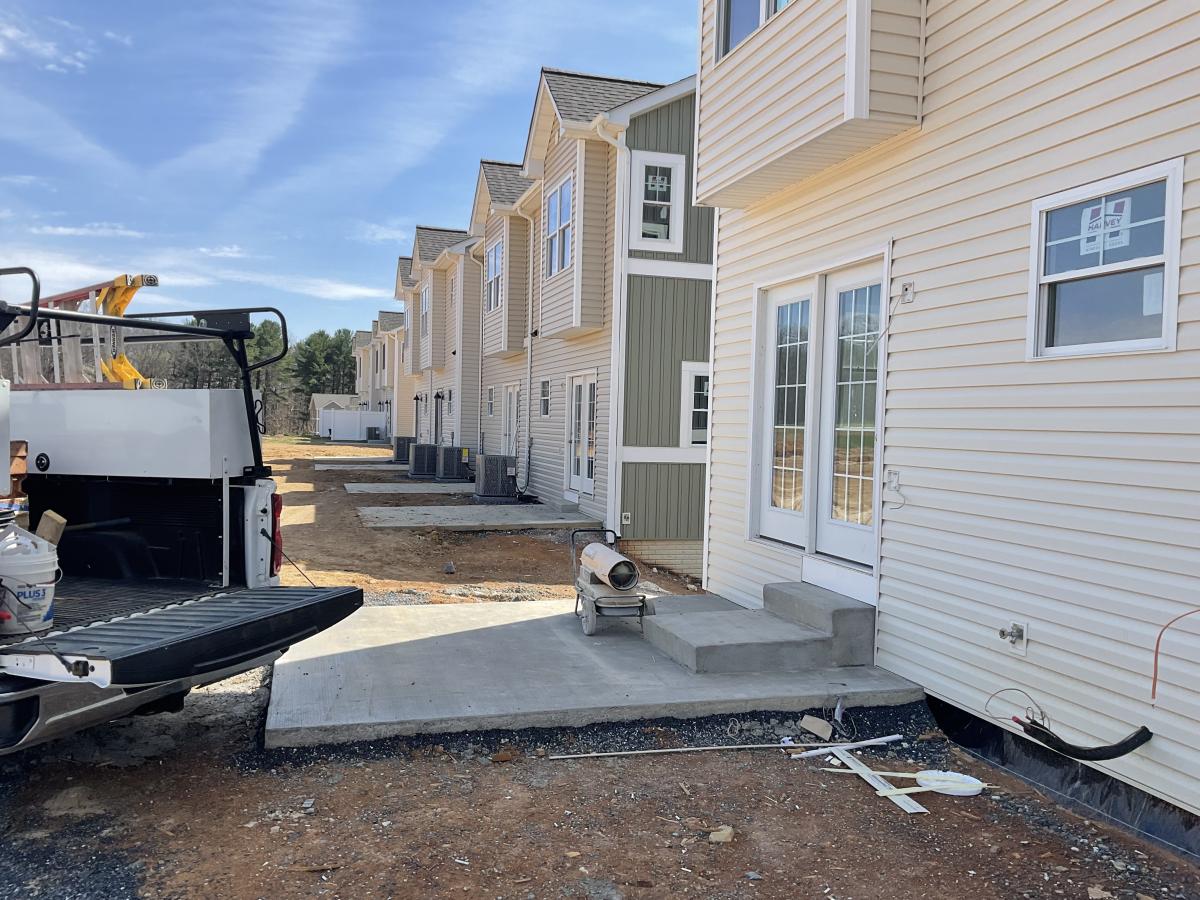

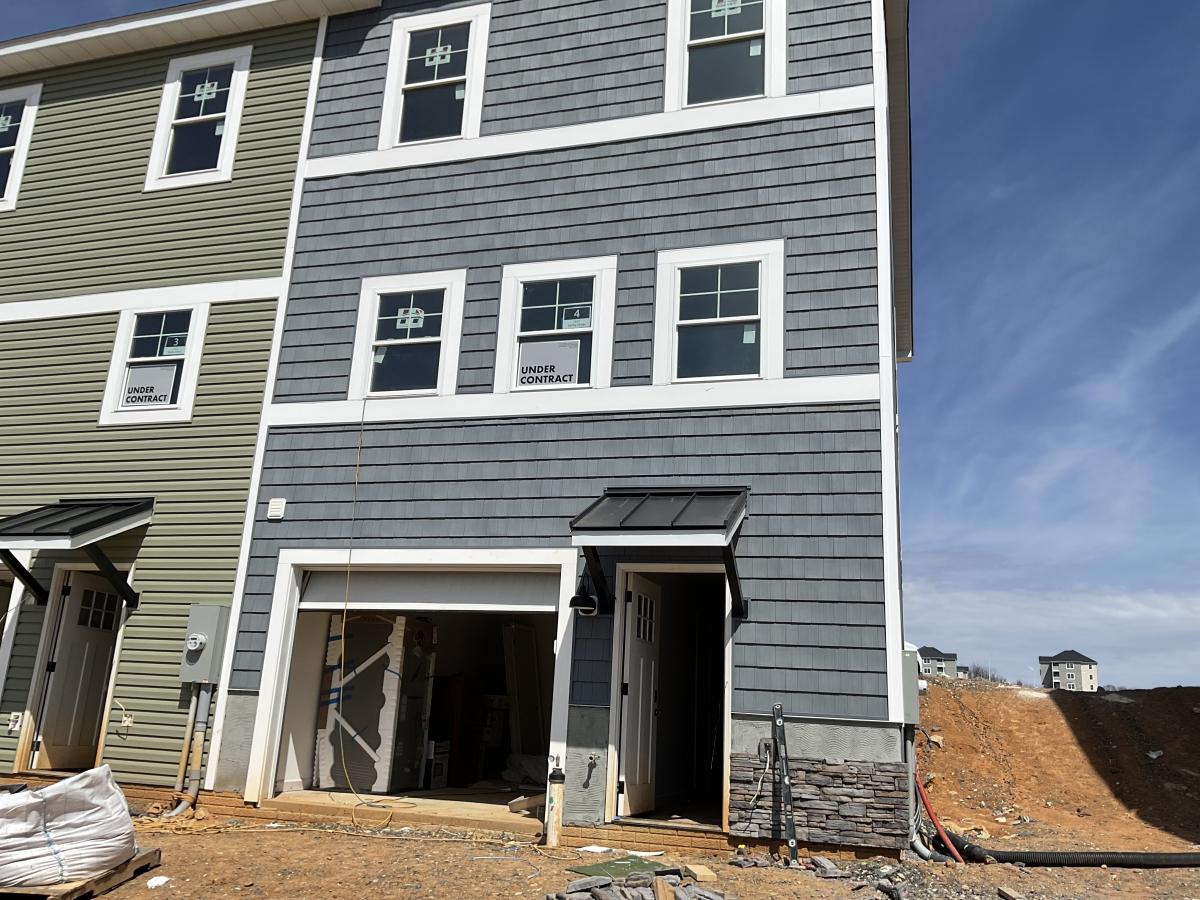

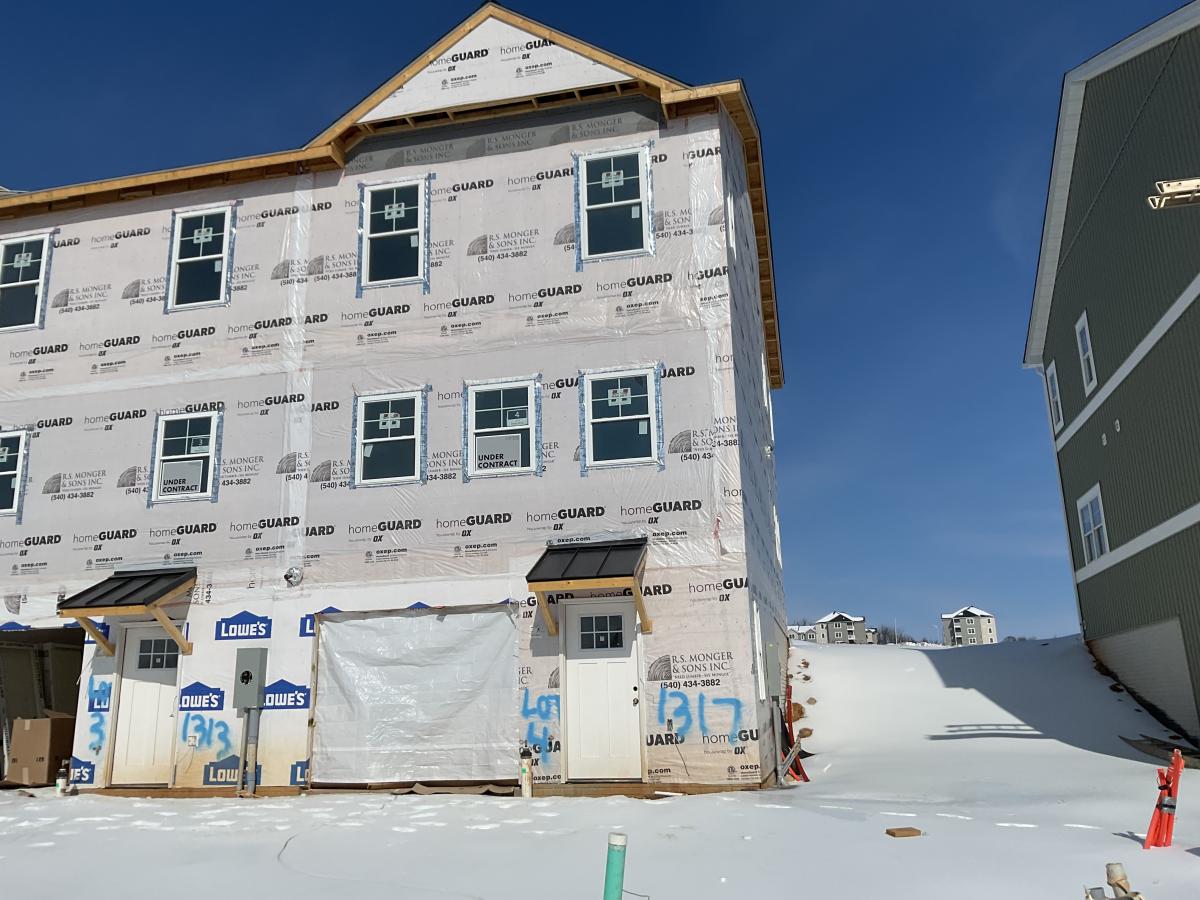

| Thu | Dec 4 | Exterior Vinyl (0) * | ||
| Thu | Dec 4 | Exterior Stone (0) | ||

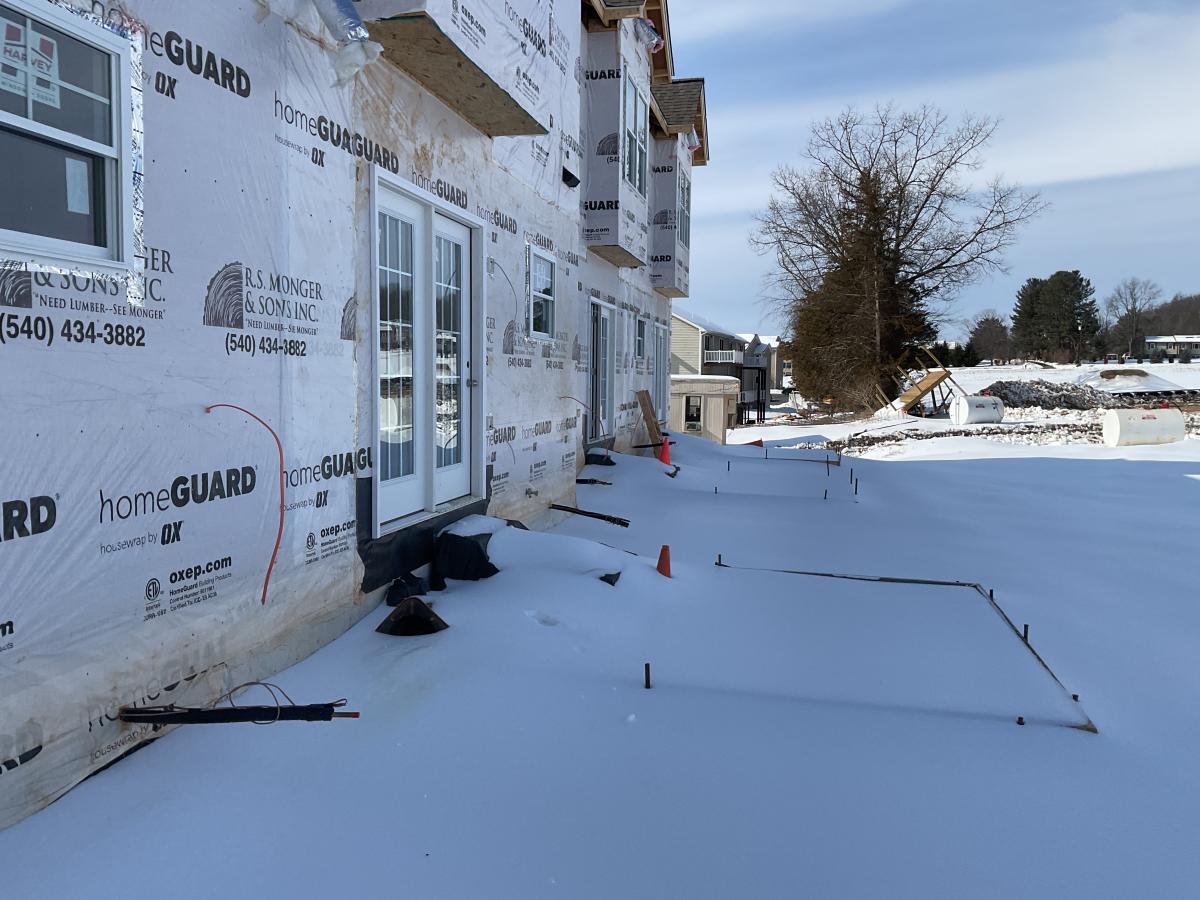

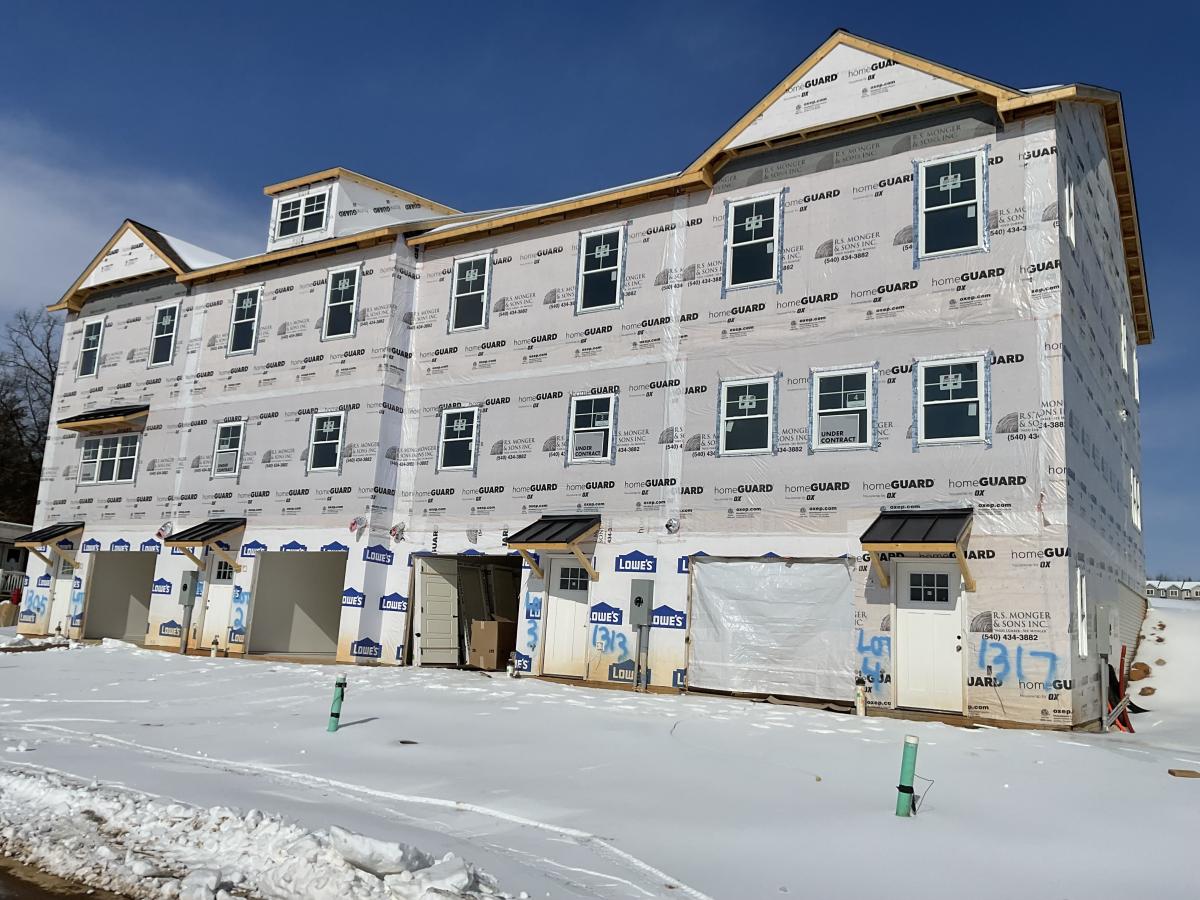

| Thu | Dec 4 | Insulation (2) * | ||
| Mon | Dec 8 | Inspection (Insulation) (1) | ||
| Tue | Dec 9 | Inspection (Electric Service) (0) | ||
| Tue | Dec 9 | Set Electric Meter (0) * | ||
| Tue | Dec 9 | Inspection (Main Sewer Line) (0) 08.18.2025 | ||
| Tue | Dec 9 | Inspection (Main Water Line) (0) 08.18.2025 | ||
| Tue | Dec 9 | Order Interior Doors & Trim (0) | ||

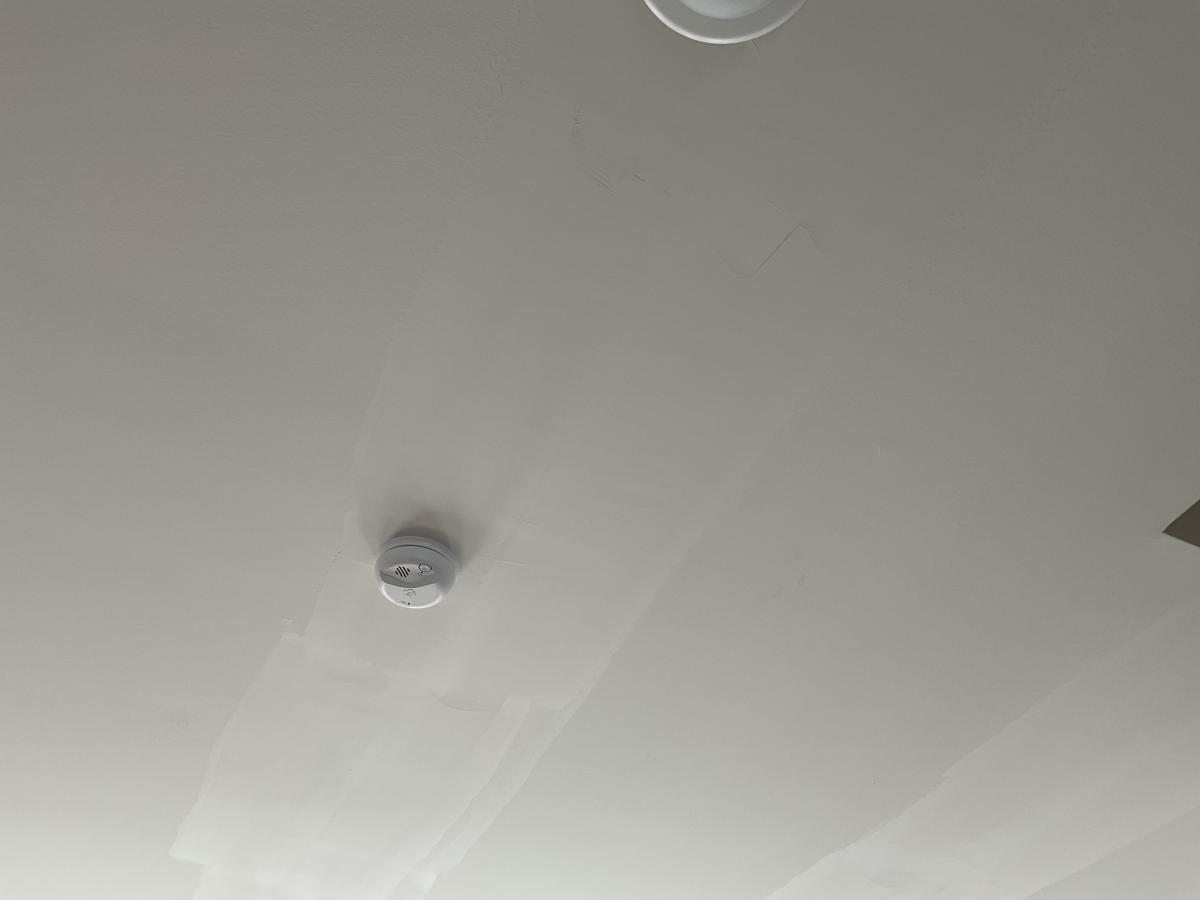

| Tue | Dec 9 | Drywall (Hang) (4) * | ||
| Mon | Dec 15 | Loan Approval (0) | JoDee @ United (97% Conventional) | |
| Mon | Dec 15 | Deed Preparation (0) | ||

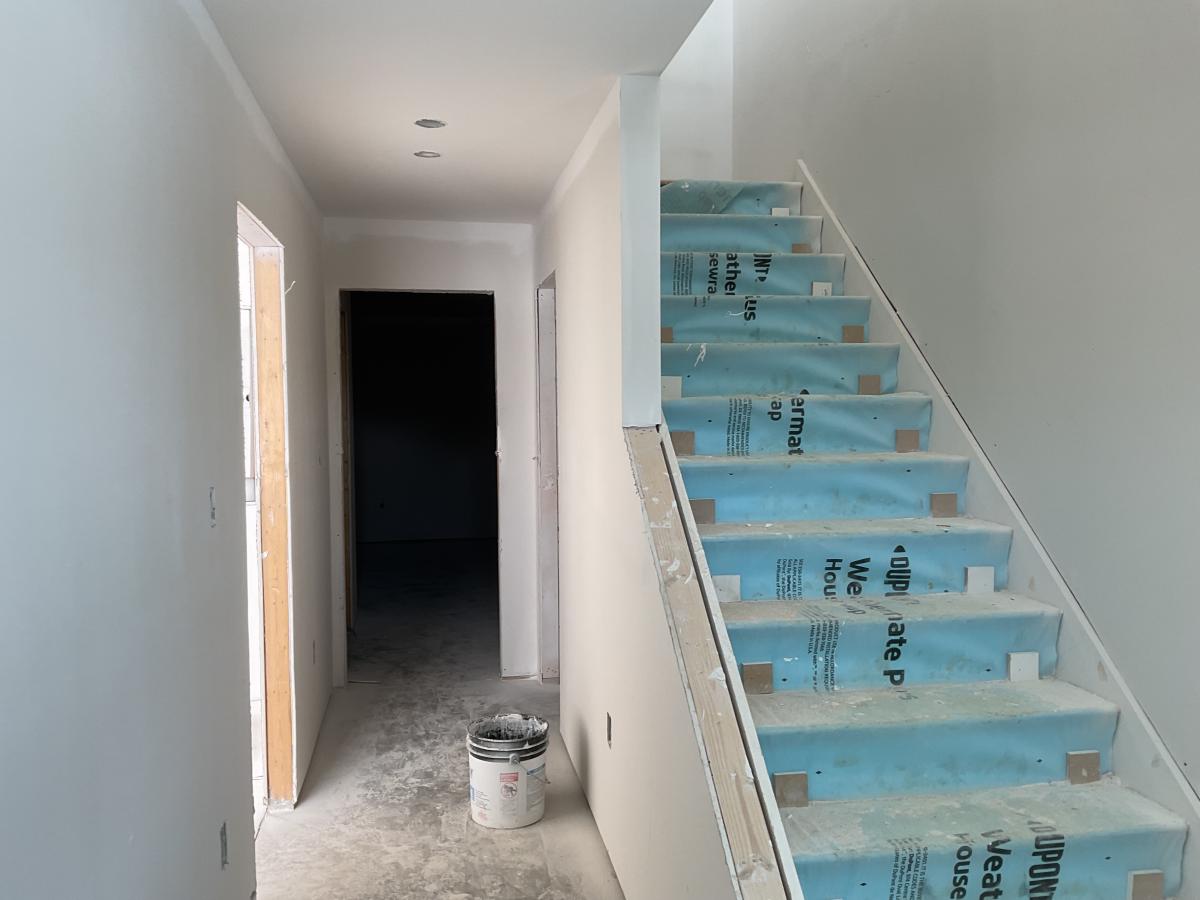

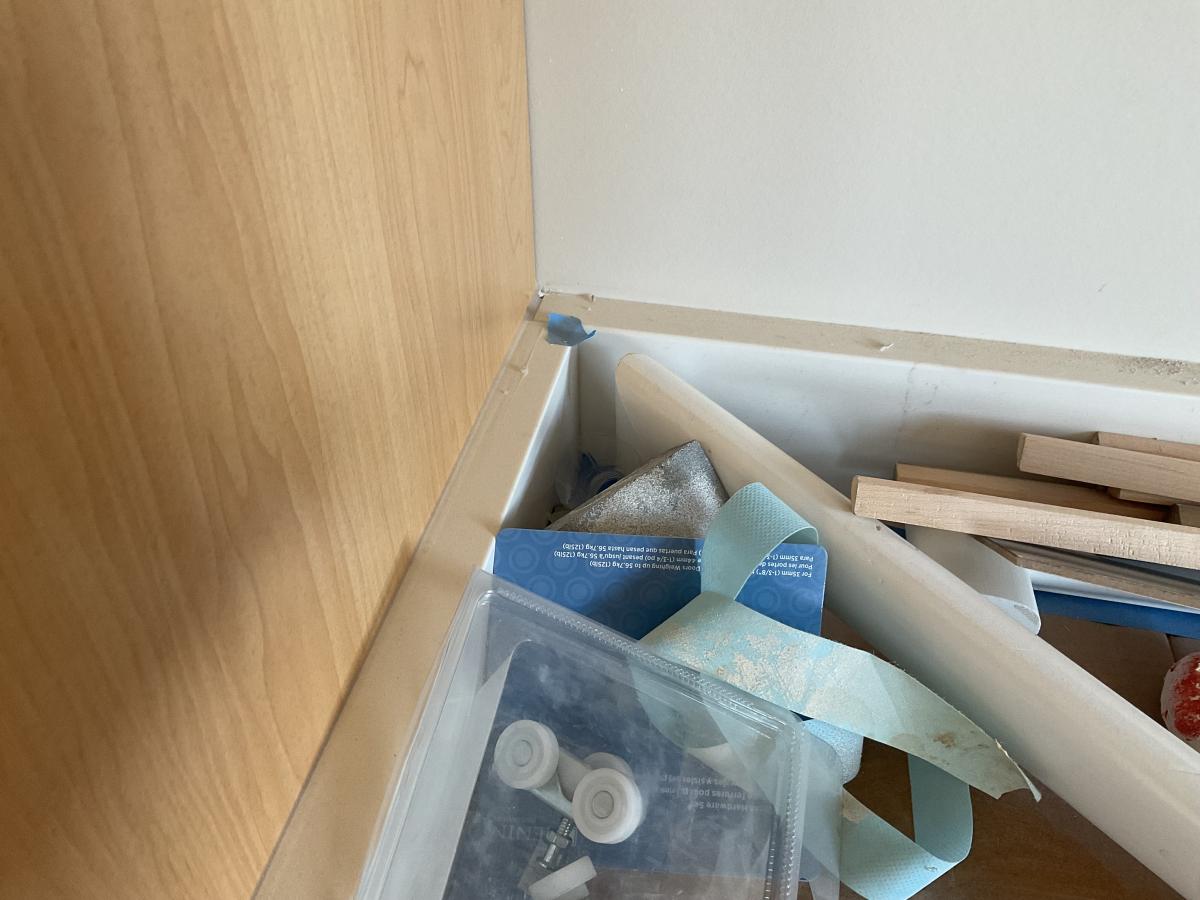

| Mon | Dec 15 | Drywall (Tape, Block, Skim, Sand) (6) * | ||
| Tue | Dec 23 | Paint 1 (1) | ||

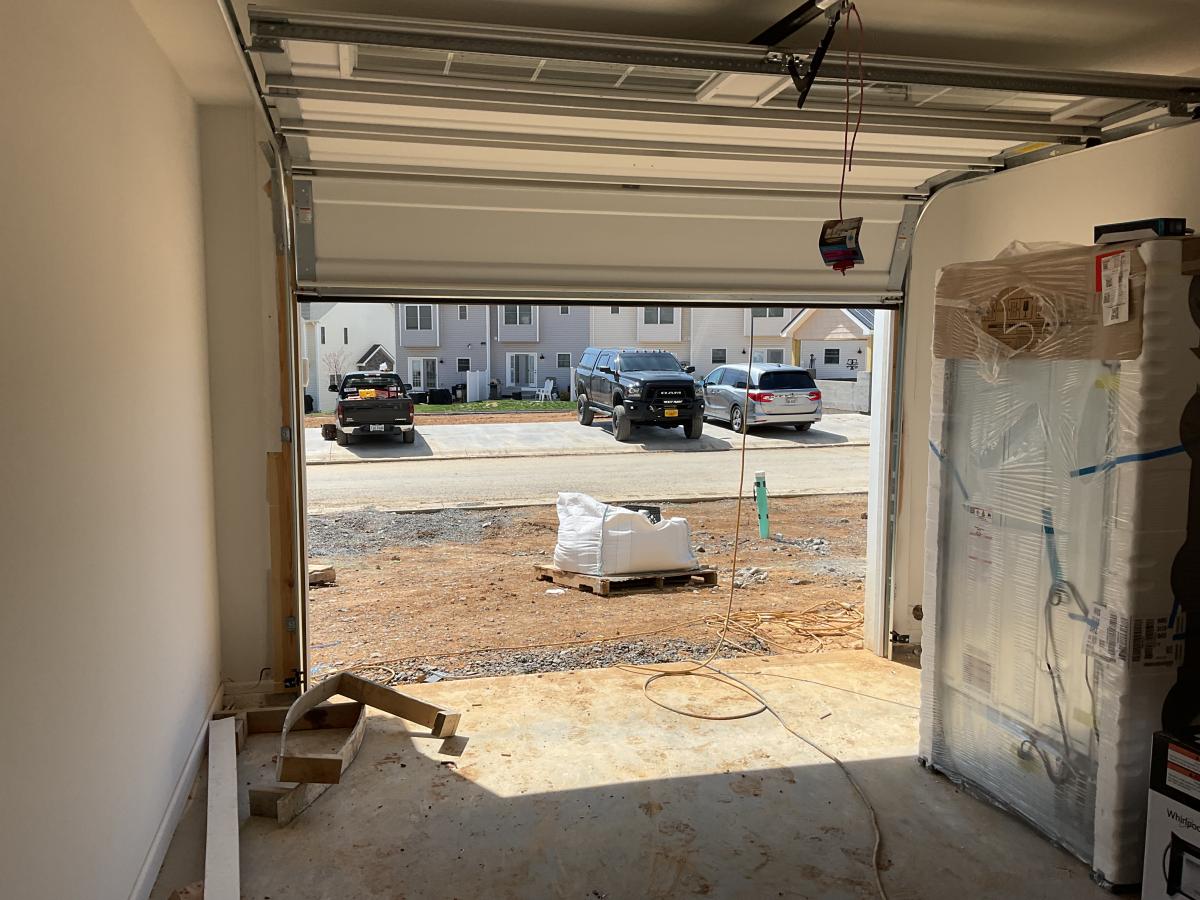

| Wed | Dec 24 | Garage Door (0) | ||
| Wed | Dec 24 | House Numbers (0) | ||
| Wed | Dec 24 | Mailbox (0) | ||

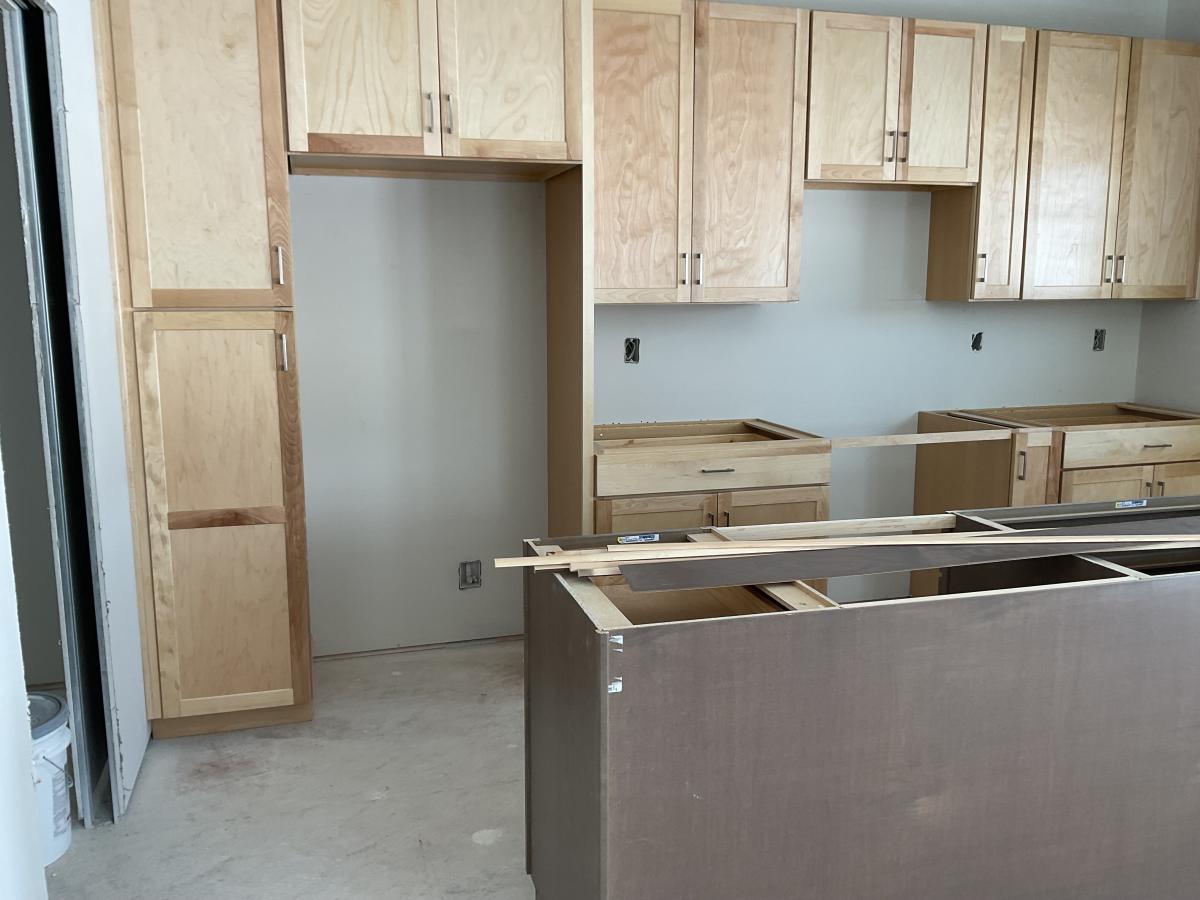

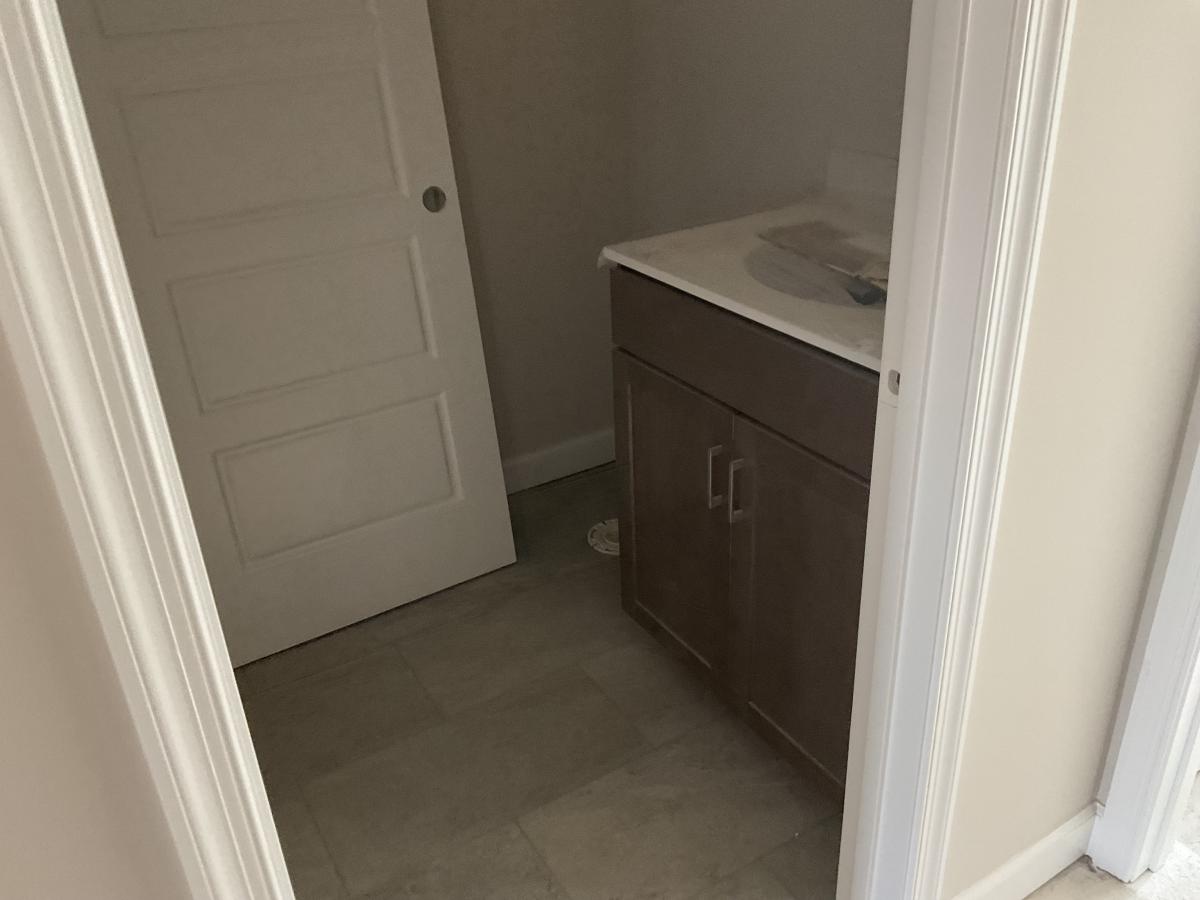

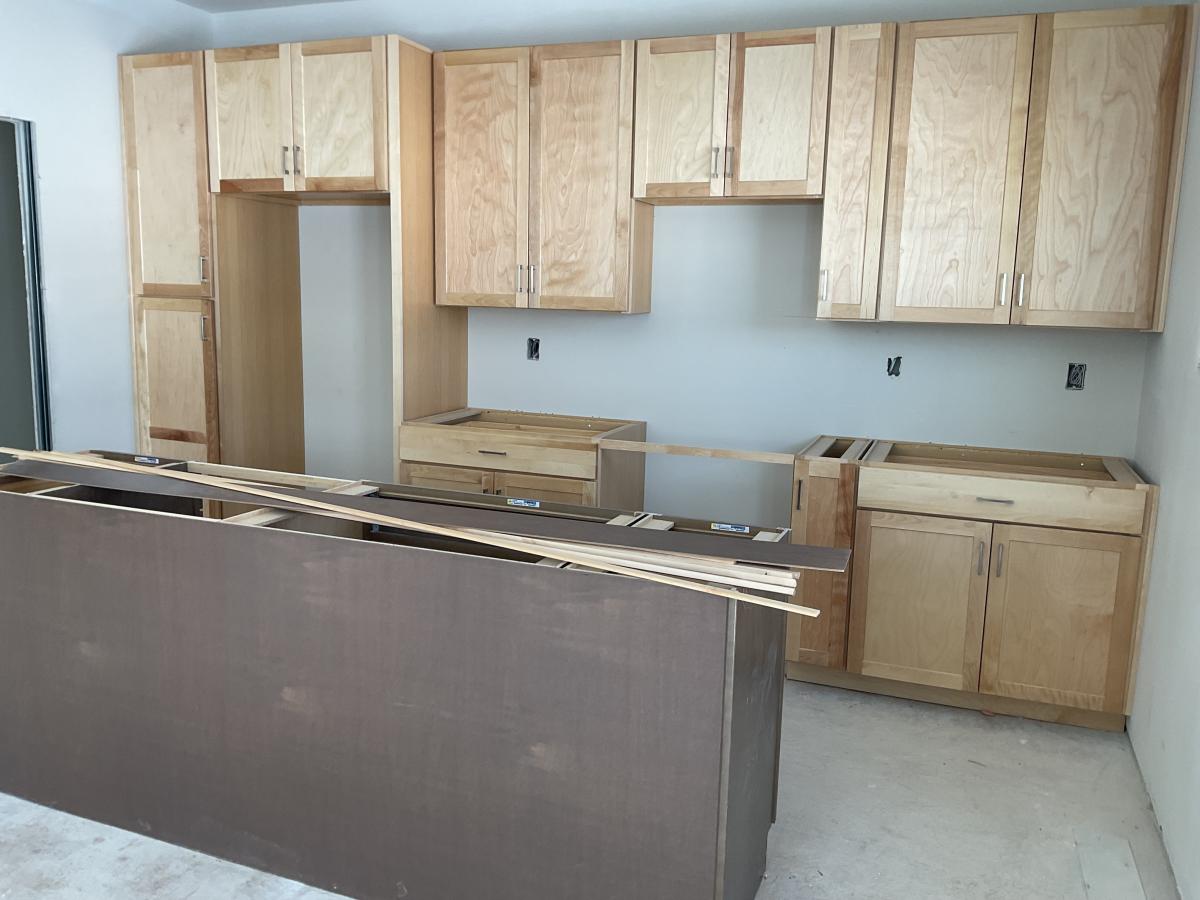

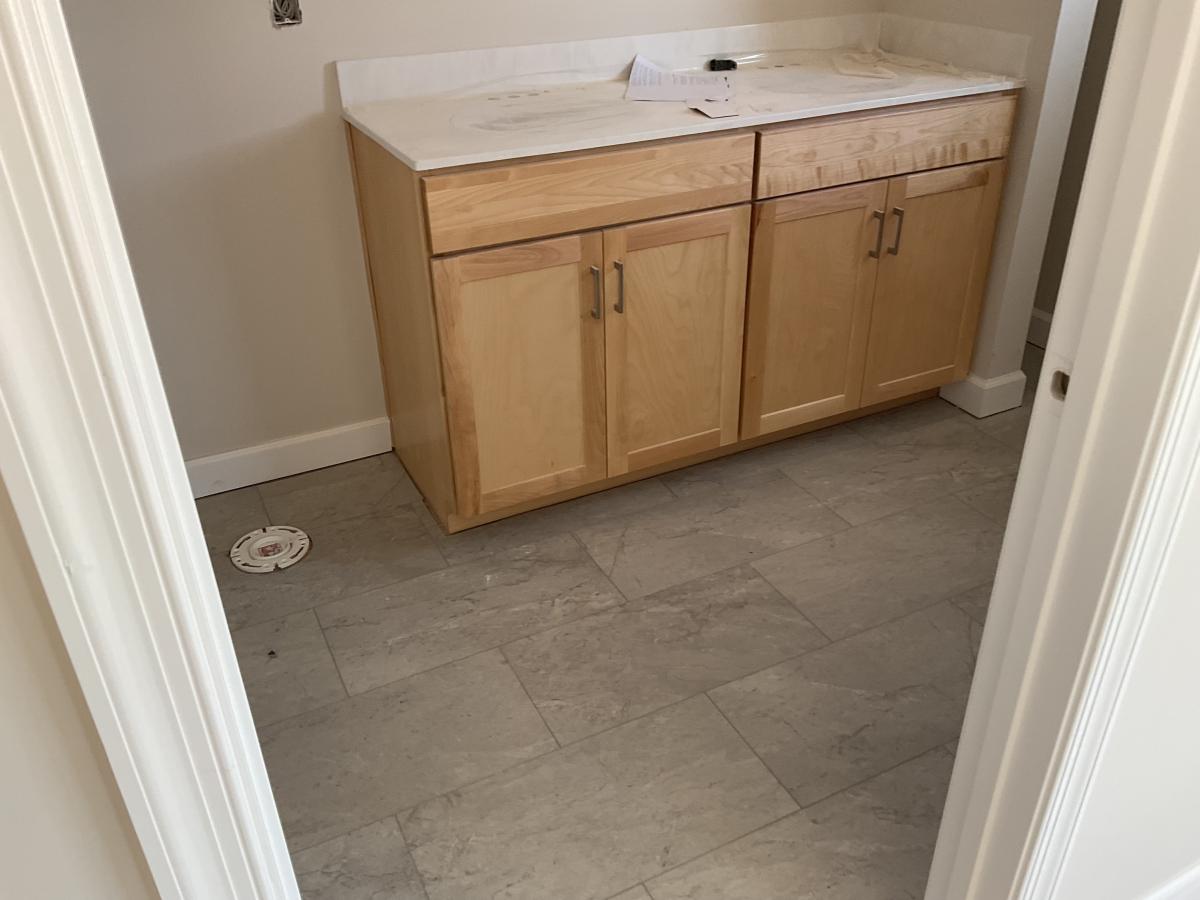

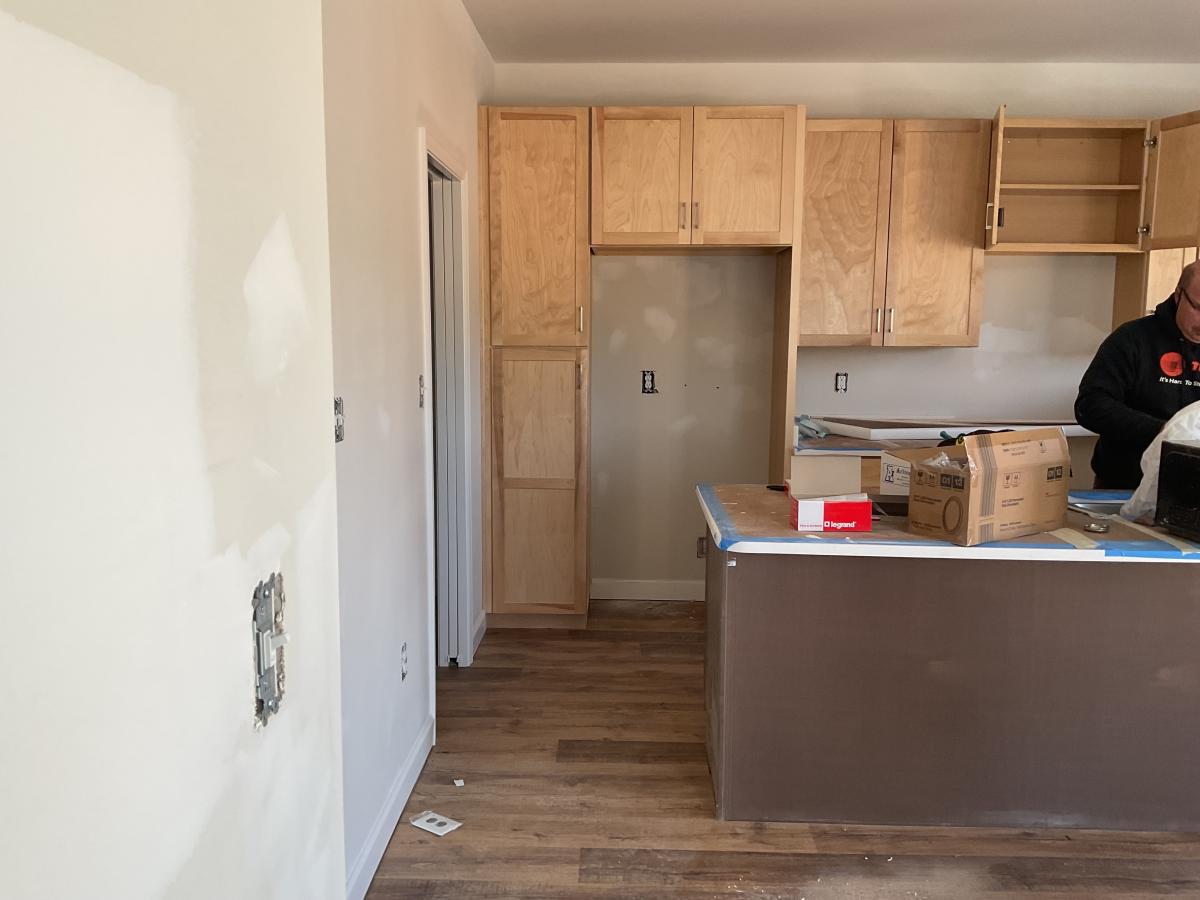

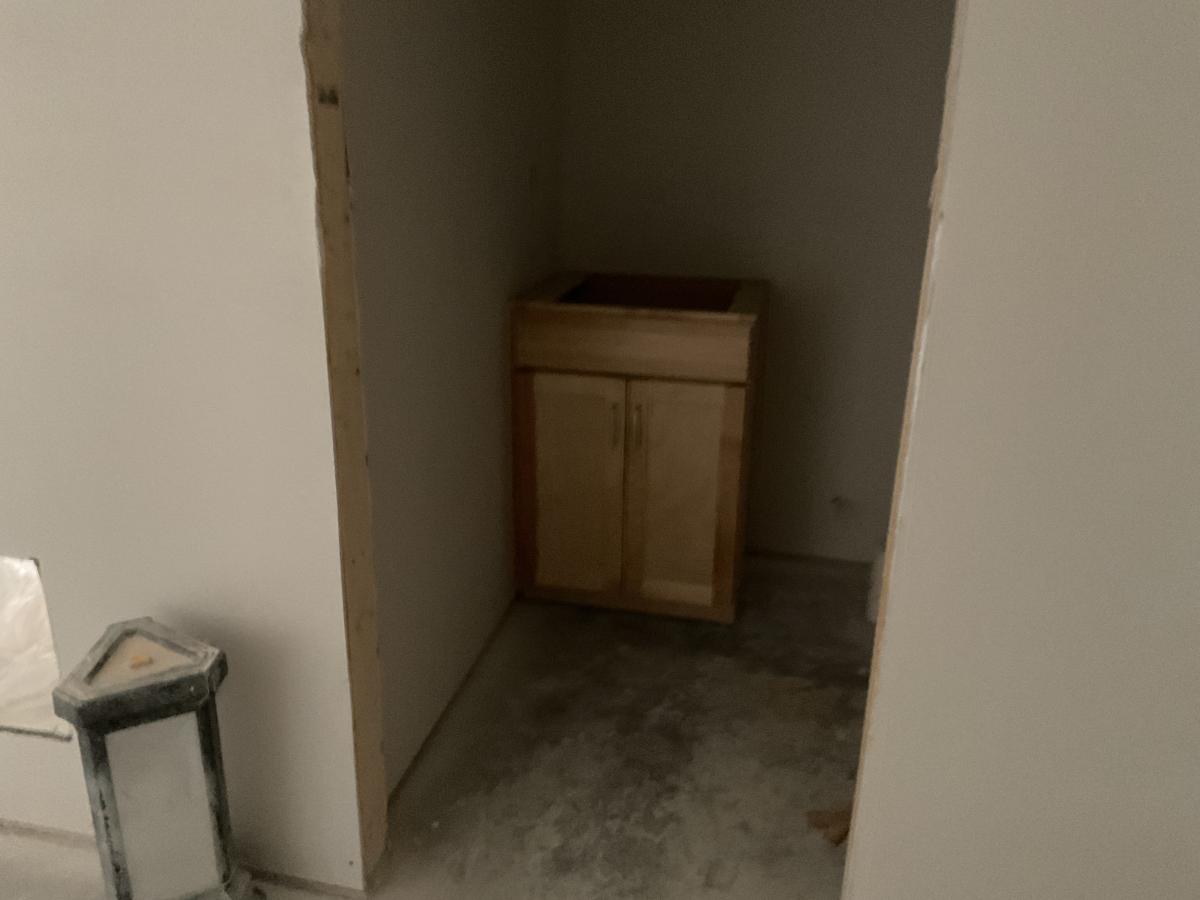

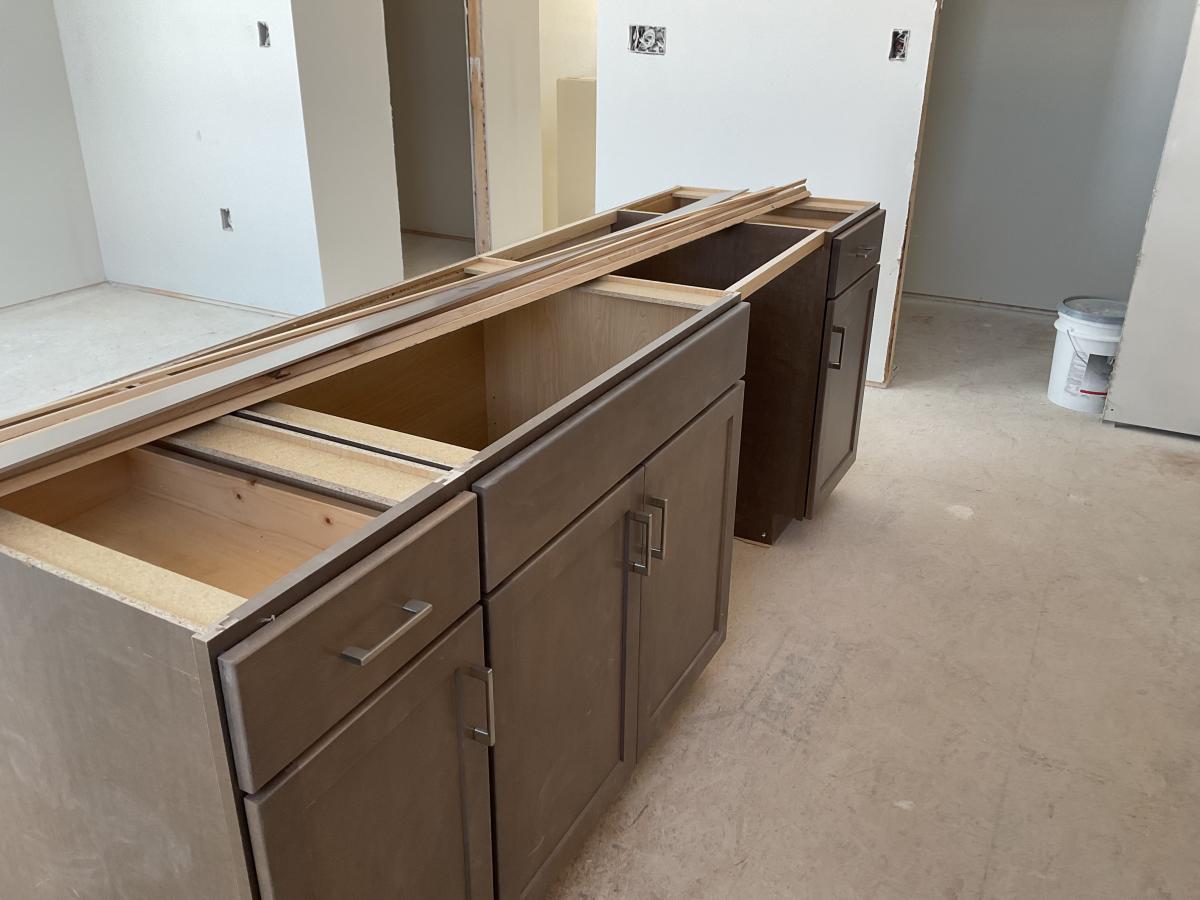

| Wed | Dec 24 | Cabinet Installation (2) * | ||
| Fri | Dec 26 | Granite Installation (1) * | ||

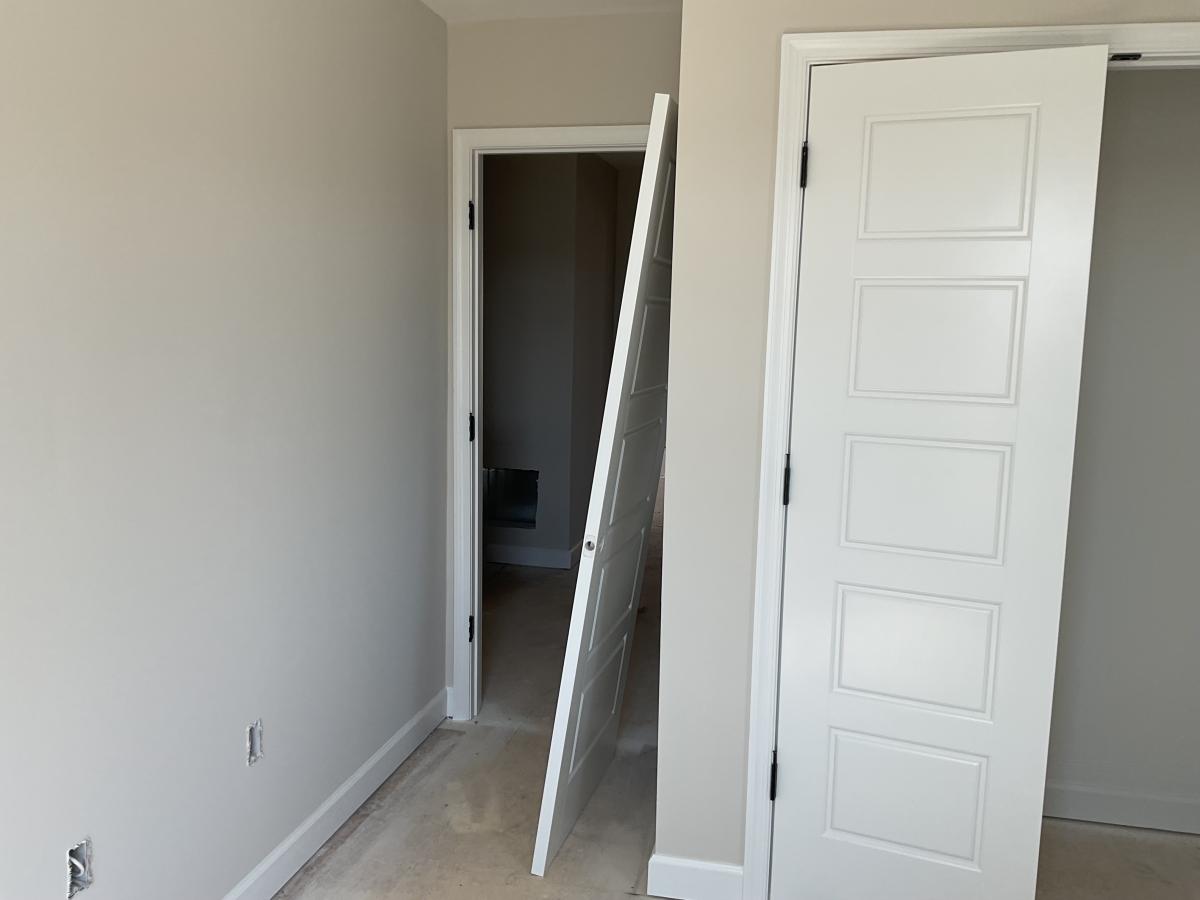

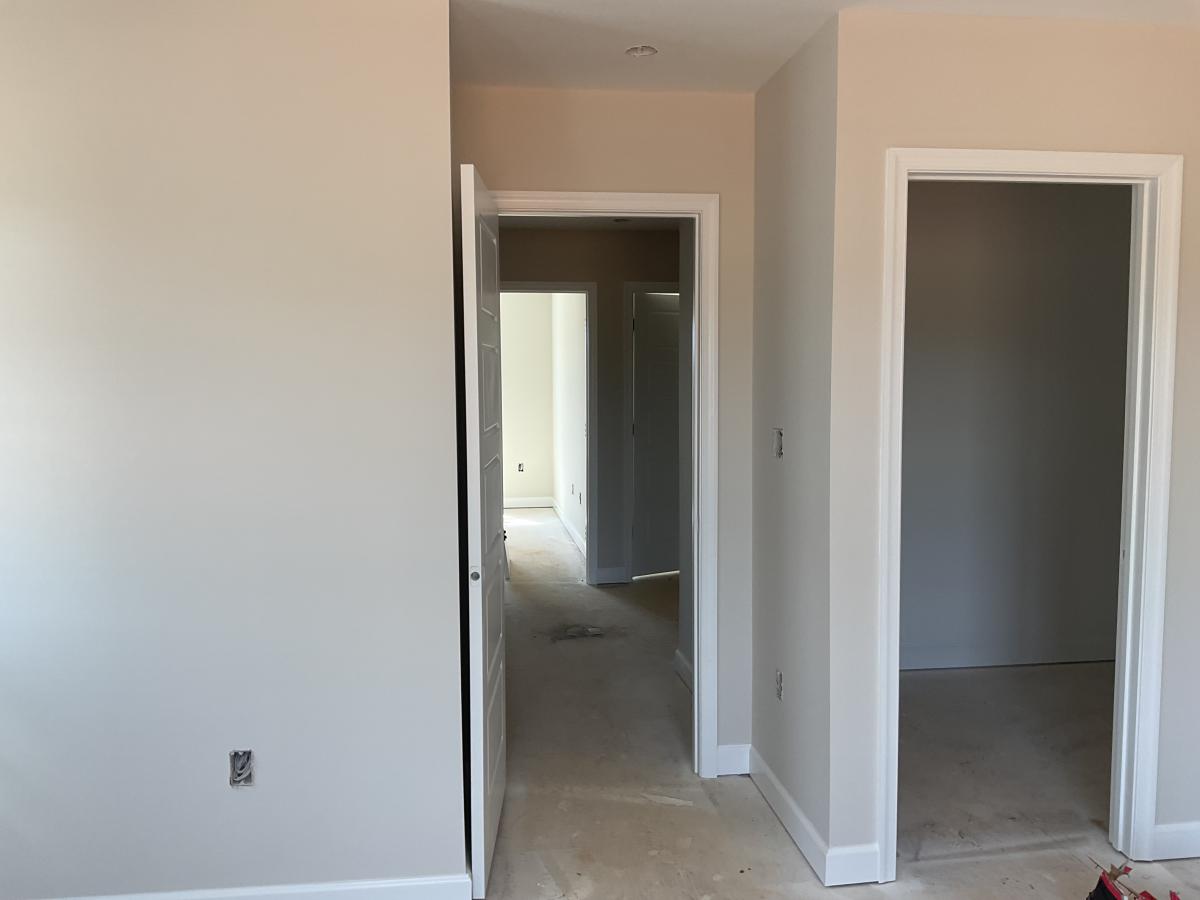

| Mon | Dec 29 | Interior Trim - Install (3) * | ||
| Thu | Jan 1 | Order Plumbing / Lighting Fixtures (0) | ||
| Thu | Jan 1 | Interior Trim - Paint (1) | ||

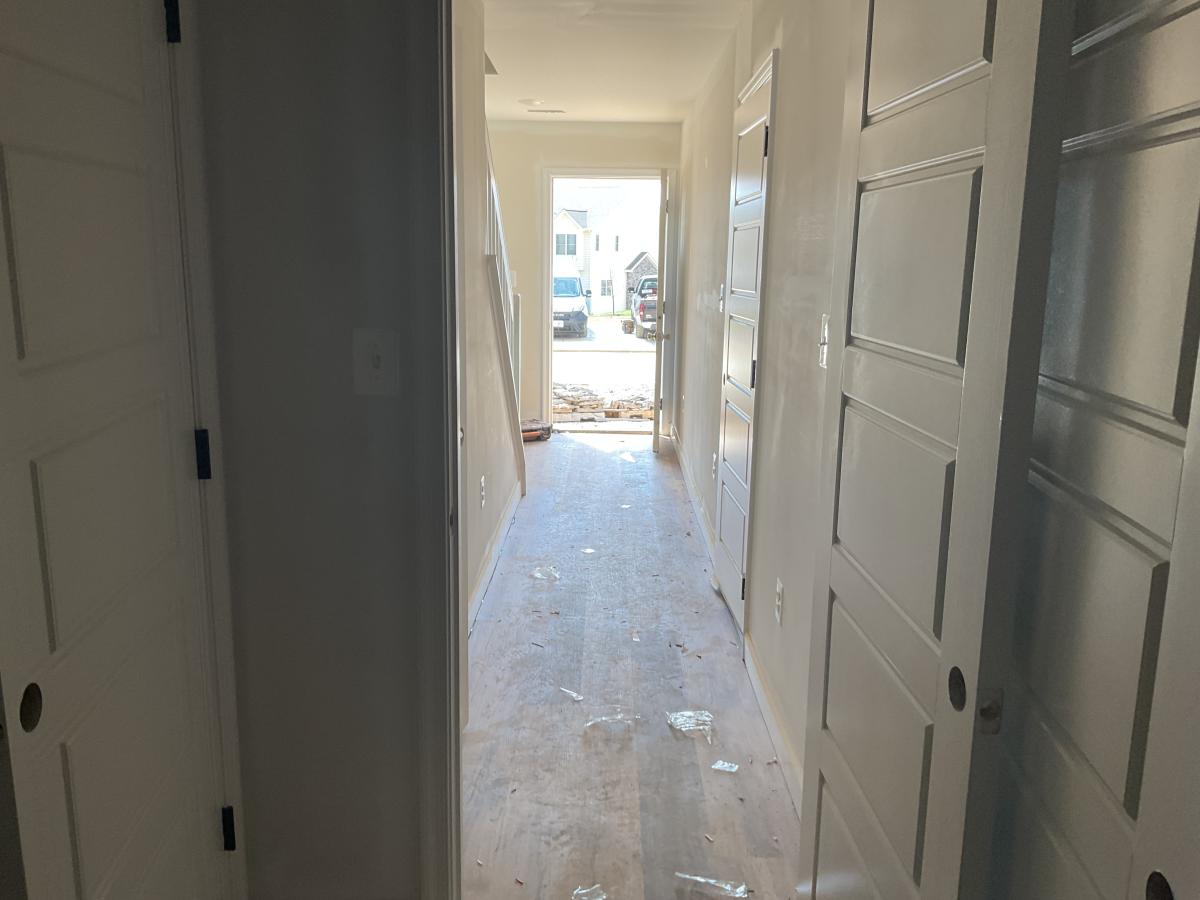

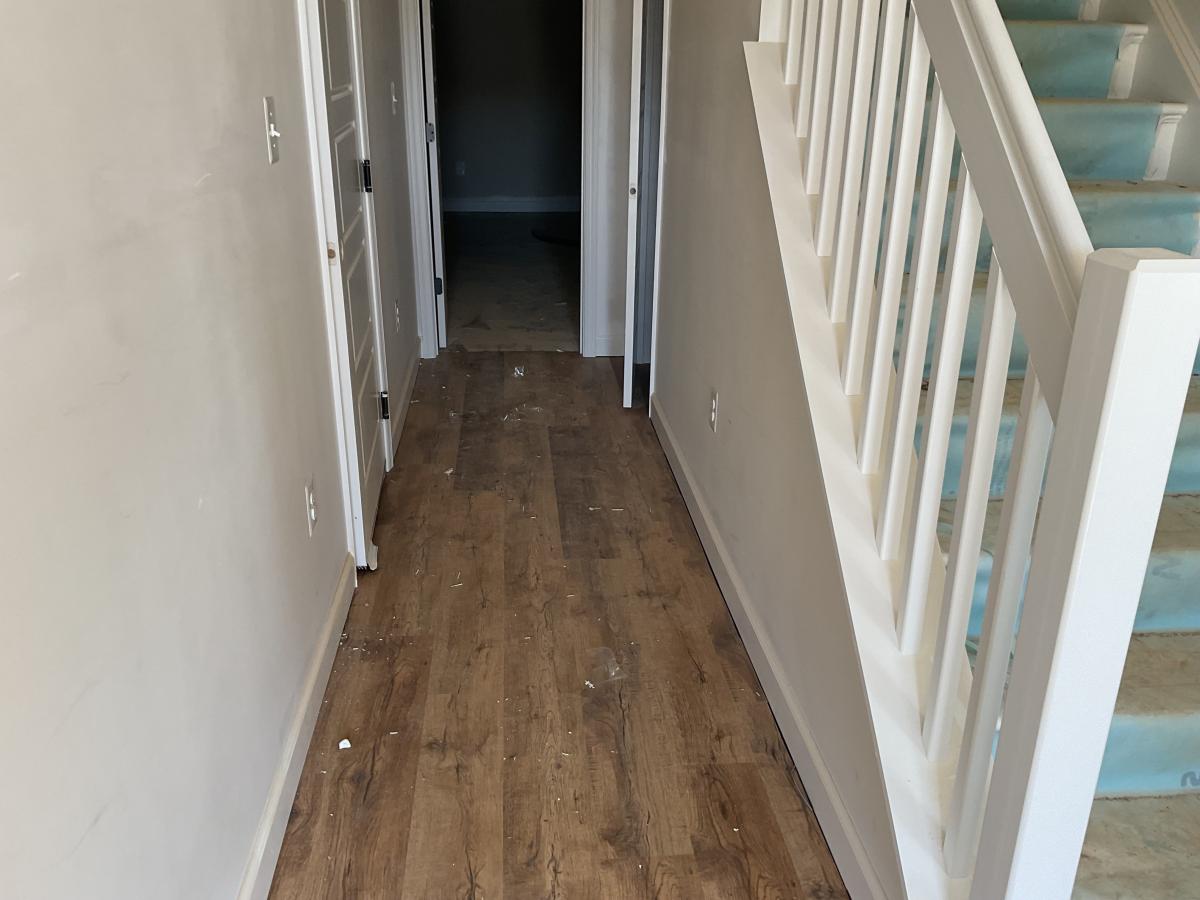

| Fri | Jan 2 | Luxury Vinyl Plank (3) * | ||
| Wed | Jan 7 | Luxury Vinyl Tile (0) | ||

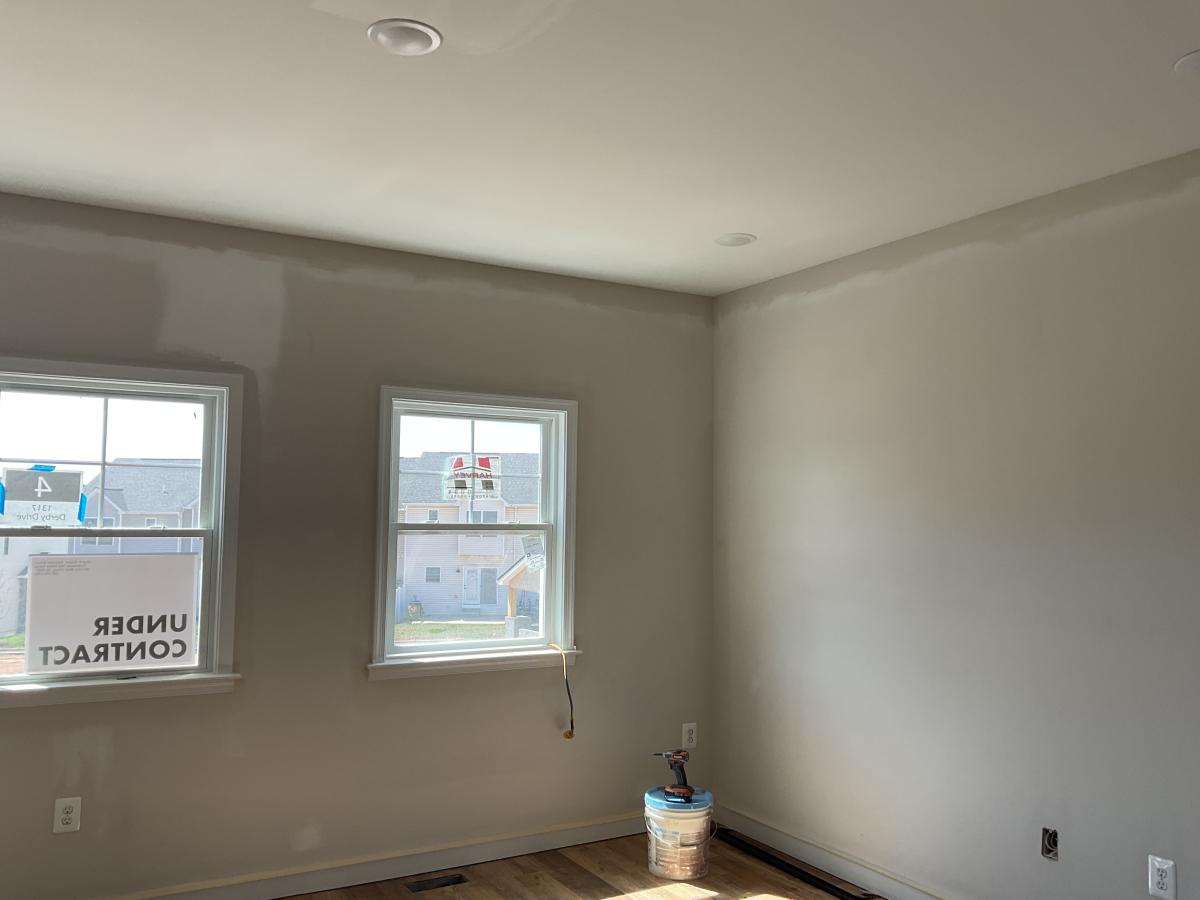

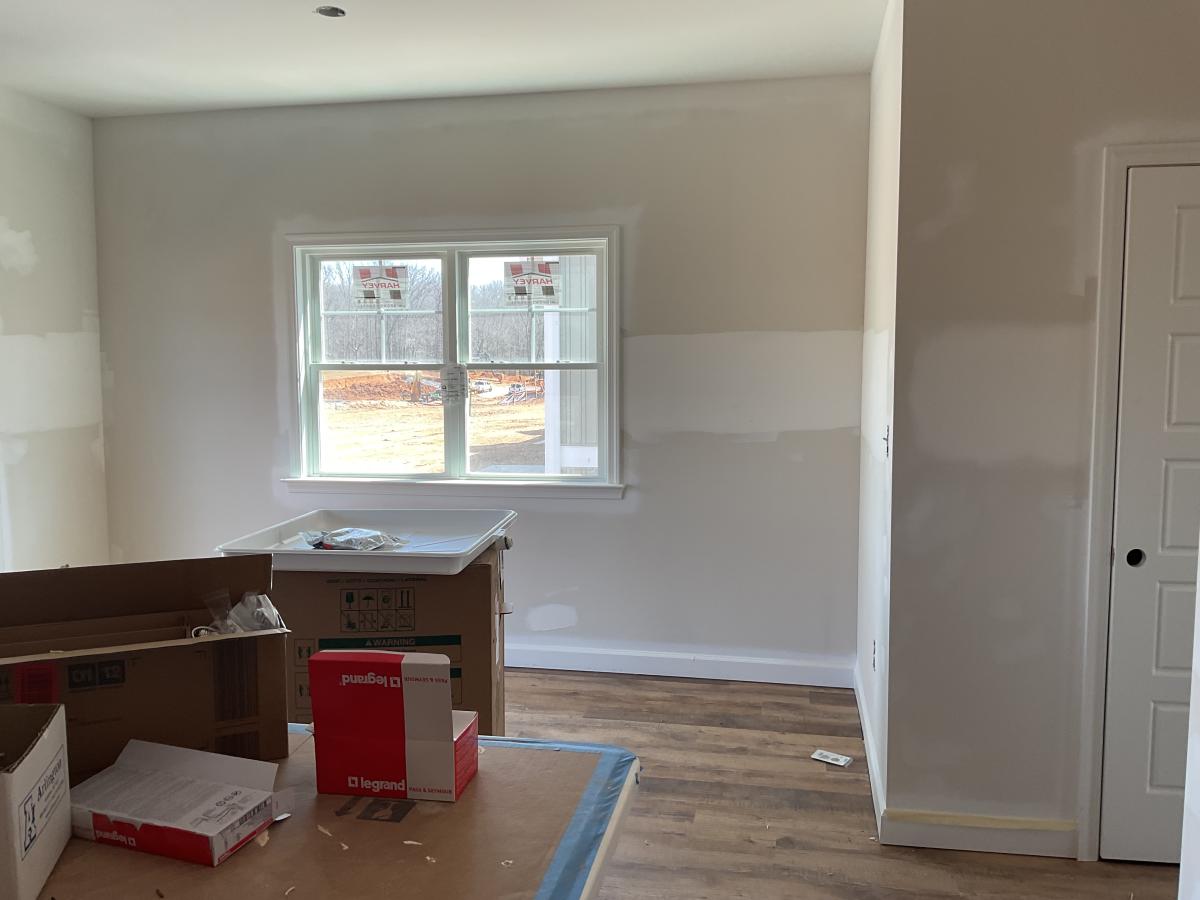

| Wed | Jan 7 | Paint 2 (3) | ||
| Mon | Jan 12 | Cover Floors (1) | ||
| Tue | Jan 13 | Deliver Plumbing / Lighting Fixtures (0) | ||
| Tue | Jan 13 | Shoe Moulding (0) | ||
| Tue | Jan 13 | Shelving, Door Knobs, Fire Extinguisher (0) * | ||
| Tue | Jan 13 | Install Coded Lockbox (add extra keys) (0) | ||
| Tue | Jan 13 | Pay Water / Sewer Taps (0) | ||
| Tue | Jan 13 | Set Water Meter (0) * | ||
| Tue | Jan 13 | Electric Trim Out (3) * | ||
| Fri | Jan 16 | Ceiling Fans (0) | ||
| Fri | Jan 16 | HVAC Trim Out (1) * | ||
| Mon | Jan 19 | Blower Door Test (1) | ||
| Tue | Jan 20 | Plumbing Trim Out (2) * | ||

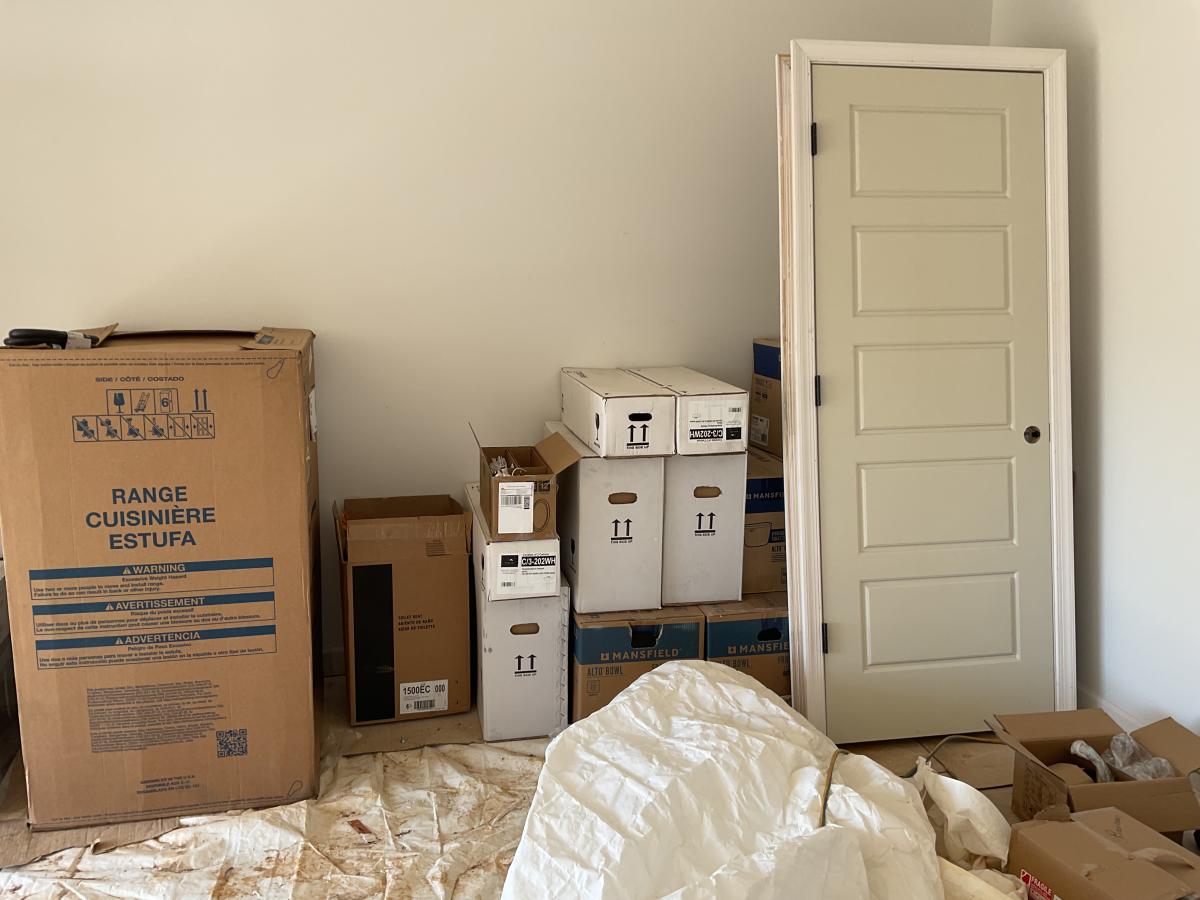

| Thu | Jan 22 | Install Appliances (0) * | ||
| Thu | Jan 22 | Paint 3 (2) * | ||
| Mon | Jan 26 | Carpet (2) | ||
| Wed | Jan 28 | Appraiser Confirms Construction Completion (0) | ||
| Wed | Jan 28 | Inspection (Final HVAC) (1) | ||
| Thu | Jan 29 | Inspection (Final Plumbing) (1) | ||
| Fri | Jan 30 | Inspection (Final Electric) (1) | ||
| Mon | Feb 2 | Inspection (Final Building) (2) * | ||
| Wed | Feb 4 | Pre Walk Through (0) | ||
| Wed | Feb 4 | Stain Hardwood Stairs (1) * | ||
| Thu | Feb 5 | Cleaning (1) | ||
| Fri | Feb 6 | Certificate of Occupancy (1) * | ||
| Mon | Feb 9 | C.O. to Lender (0) | ||
| Mon | Feb 9 | Schedule Closing (0) | ||
| Mon | Feb 9 | Buyer Walk Through (1) * | ||
| Tue | Feb 10 | Payment for Upgrades (0) | ||
| Tue | Feb 10 | Keys to Settlement Agent (0) | ||
| Tue | Feb 10 | Review Settlement Statement (0) | ||
| Tue | Feb 10 | Jerry Signs Closing Documents (0) | ||
| Tue | Feb 10 | Request Trash Tote From POA Manager (0) | ||
| Tue | Feb 10 | Closing (1) | ||
| Wed | Feb 11 | Remove Coded Lockbox (0) | ||
| -- | -- | No window in bonus room | ||
| -- | -- | Ratified Contract? (0) 07.29.2025 | ||
| Amendment to increase price by $17,980 | ||||
| -- | -- | $2500 Deposit Received (0) 07.29.2025 | ||
| -- | -- | Association Packet Requested (0) 07.29.2025 | ||
| -- | -- | Association Packet Received (0) 08.27.2025 | ||
| -- | -- | Selections Meeting (0) 08.27.2025 | ||
| -- | -- | Selections Sheet Signed (0) 10.01.2025 | 9/29: sent to Kelly | |
| -- | -- | Amendment for Upgrades (B,S,L,T,BCP) (0) 10.17.2025 | 10/4: signed by buyer, waiting on deposit | |
| -- | -- | Deposit For Upgrades Received (0) 10.16.2025 | ||
| -- | -- | Building Permit (30) * 05.24.2025 | ||
| -- | -- | Order Roof & Floor Trusses (1) 09.25.2025 | ||
| -- | -- | Order Windows & Doors (0) 10.23.2025 | ||
| -- | -- | Stake Out Home (1) 05.29.2025 | ||
| -- | -- | Excavate (2) 05.29.2025 | ||
| -- | -- | Inspection (Footers) (1) 06.02.2025 | ||
| -- | -- | Inspection (Concrete Wall) (1) 07.31.2025 | ||
| -- | -- | Pour Footers (1) * 06.02.2025 | ||
| -- | -- | Set Forms (2) 06.05.2025 | ||
| -- | -- | Pour Foundation Walls (1) 07.31.2025 | ||
| -- | -- | Plumb Slab (2) 07.31.2025 | ||
| -- | -- | Inspection (Plumbing Under Slab) (1) 09.28.2025 | ||
| -- | -- | Inspection (Conduit Under Slab) (1) 09.28.2025 | ||
| -- | -- | Prepare Slab (1) 09.04.2025 | ||
| -- | -- | Inspection (Slab) (1) 09.28.2025 | ||
| -- | -- | Inspection (Drain Tile) (0) 09.28.2025 | ||
| -- | -- | Pour Slab (1) * 09.28.2025 | ||
| -- | -- | Framing I (9) 10.09.2025 | ||
| -- | -- | Order Steps (0) 10.23.2025 | ||
| -- | -- | Framing II (8) 10.31.2025 | ||
