| Expanded Driveway | ||||
| Level zero quartz kitchen countertops | ||||
| Coffee bar with stained cabinetry with level 0 quartz | ||||
| Baguette seating | ||||
| Double waste basket in the island | ||||
| Cabinet crown molding | ||||
| Three drawer stack in both the base 36 and 18 inch cabinets | ||||
| Spice rack | ||||
| Upgraded luxury vinyl plank in the bonus room | ||||
| Luxury vinyl plank in upstairs hallway and bedrooms | ||||

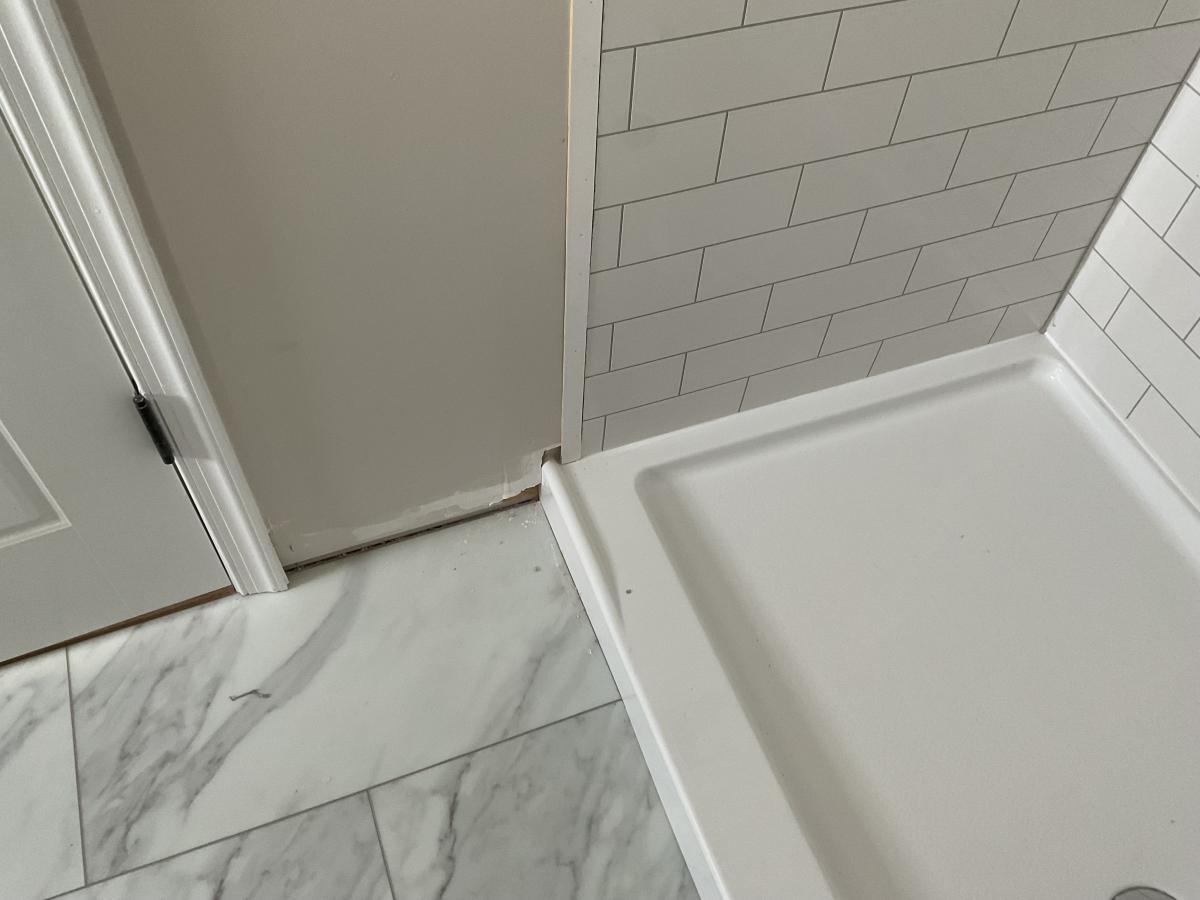

| Upgraded LVT in all baths and laundry | ||||
| Eggshell paint finish | ||||
| Living room ceiling fan | ||||
| Digital deadbolt | ||||
| Garage door opener keypad | ||||
| Ecobee3 light, smart Wi-Fi and enable thermostat | ||||
| 4 inch crown molding on main level | ||||

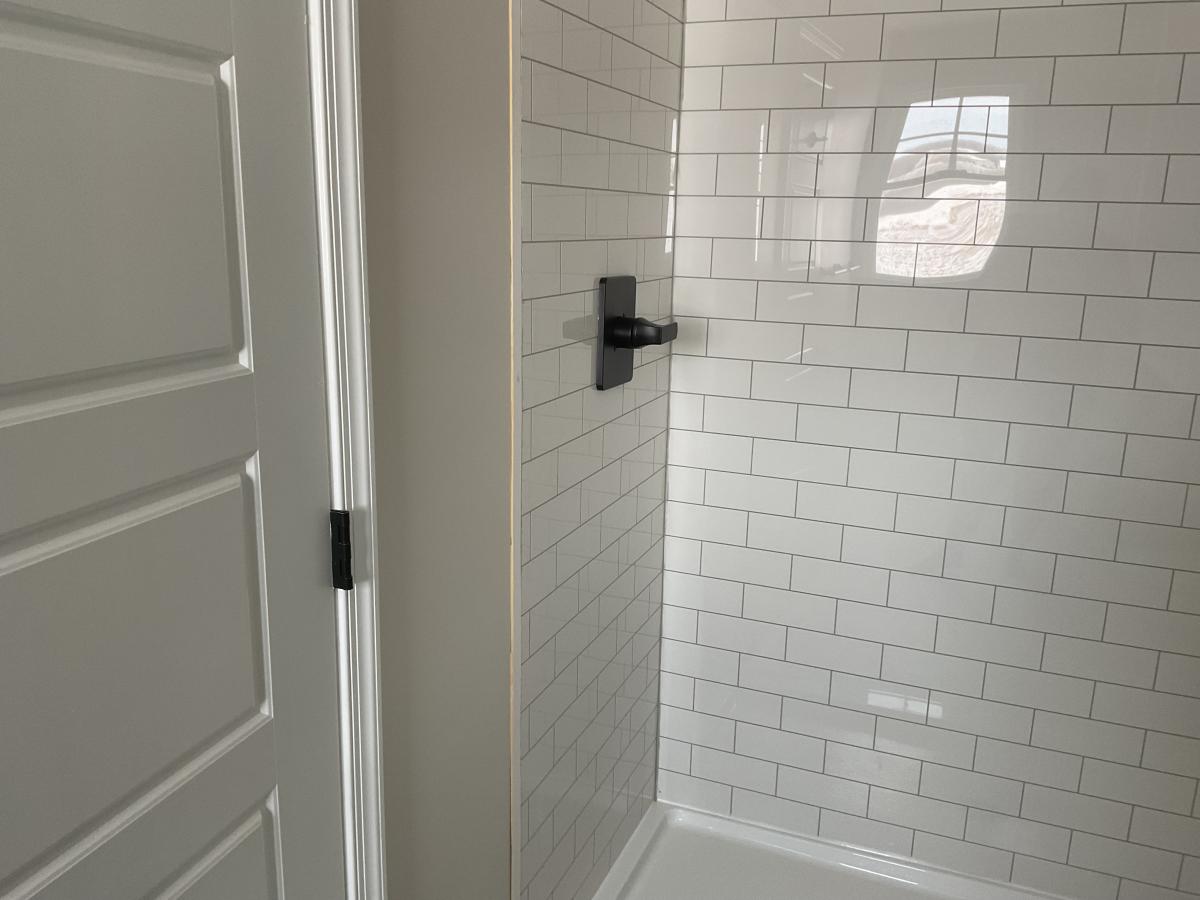

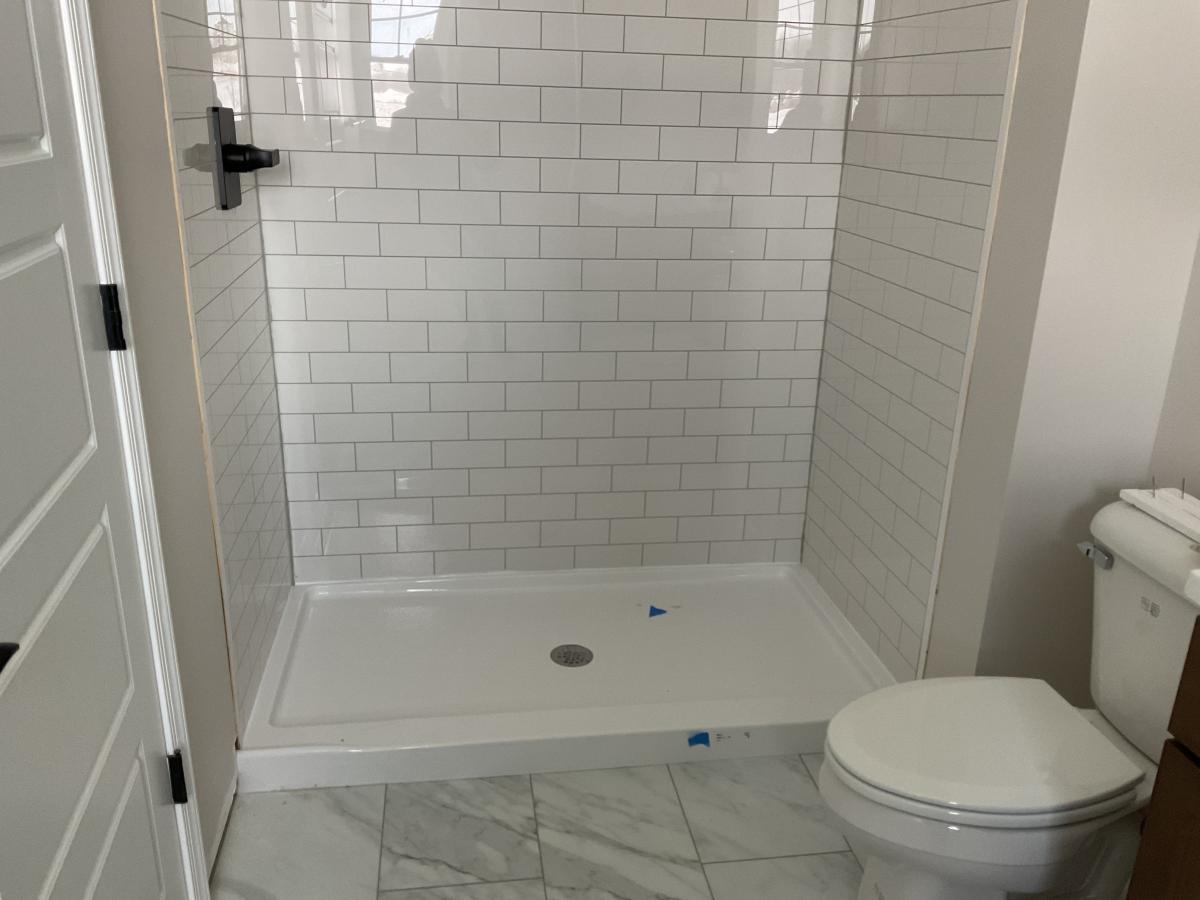

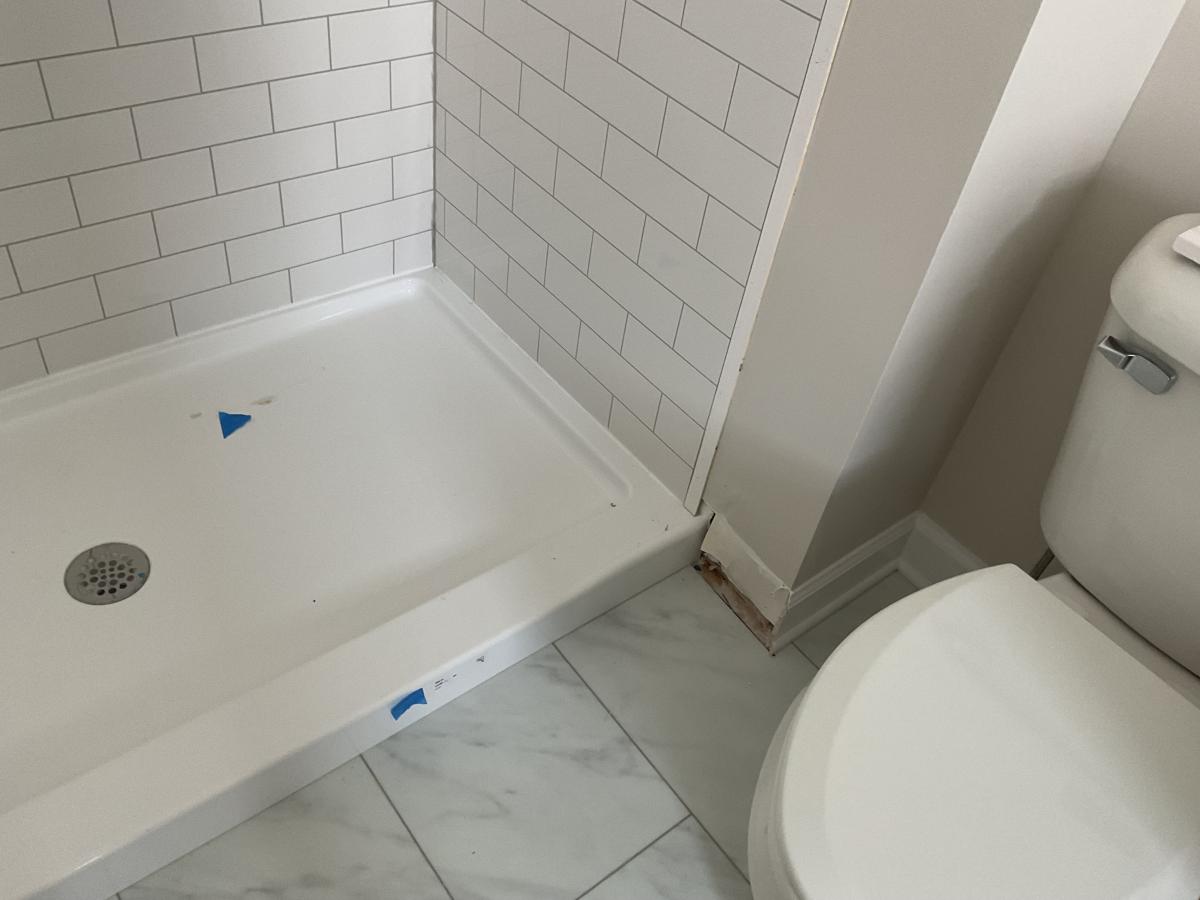

| White subway Tile shower walls in the master bathroom | ||||
| Heavy glass bypass shower door with black trim | ||||
| Farmhouse, plumbing package ( all baths) | ||||
| French Model Fridge | ||||
| Roll Out Trays in Base 36" | ||||
| Oak stairs to Bedroom Level | ||||
| Level 0 Quartz in ALL THREE bathrooms | ||||
| Sun | Nov 2 | Gutters (0) | ||
| Sun | Nov 2 | Driveway (0) * | ||
| Sun | Nov 2 | Patio (0) | Standard | |
| Sun | Nov 2 | Privacy Divider / Fence (0) * | ||
| Sun | Nov 2 | Sod / Seed / Landscaping (0) | ||
| Sun | Nov 2 | Inspection (Deck Piers) (0) | ||
| Sun | Nov 2 | Exterior Vinyl (0) * | ||
| Sun | Nov 2 | Exterior Stone (0) | ||
| Sun | Nov 2 | Set Electric Meter (0) * | ||
| Sun | Nov 2 | Order Interior Doors & Trim (0) | ||

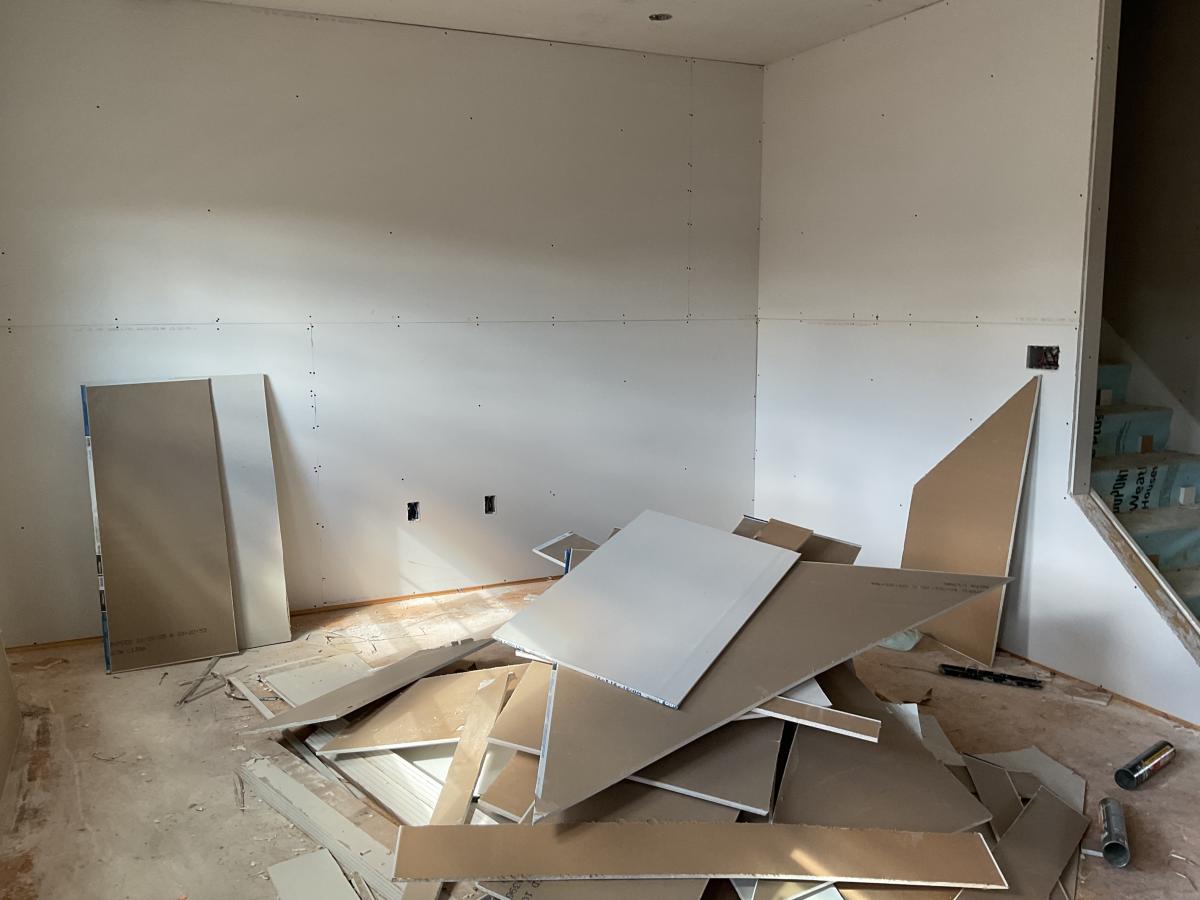

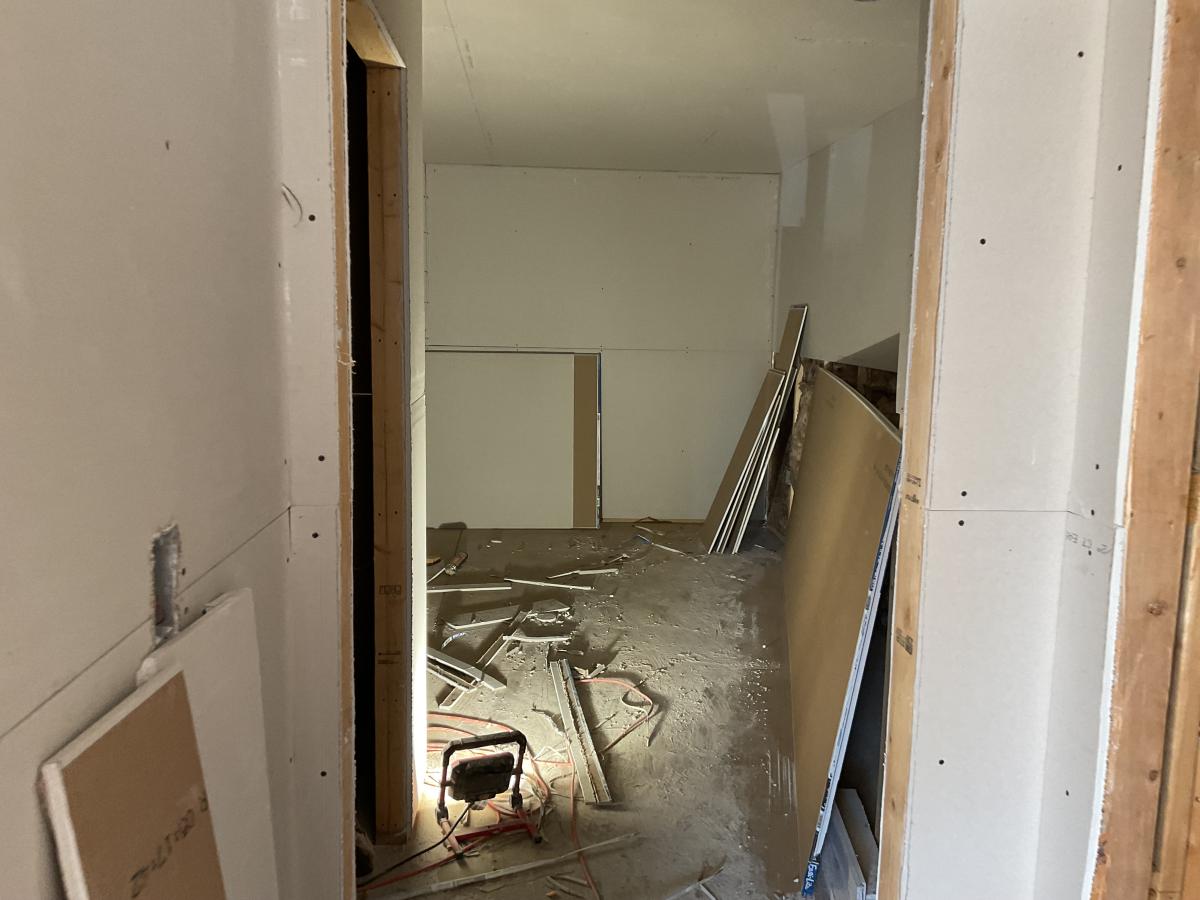

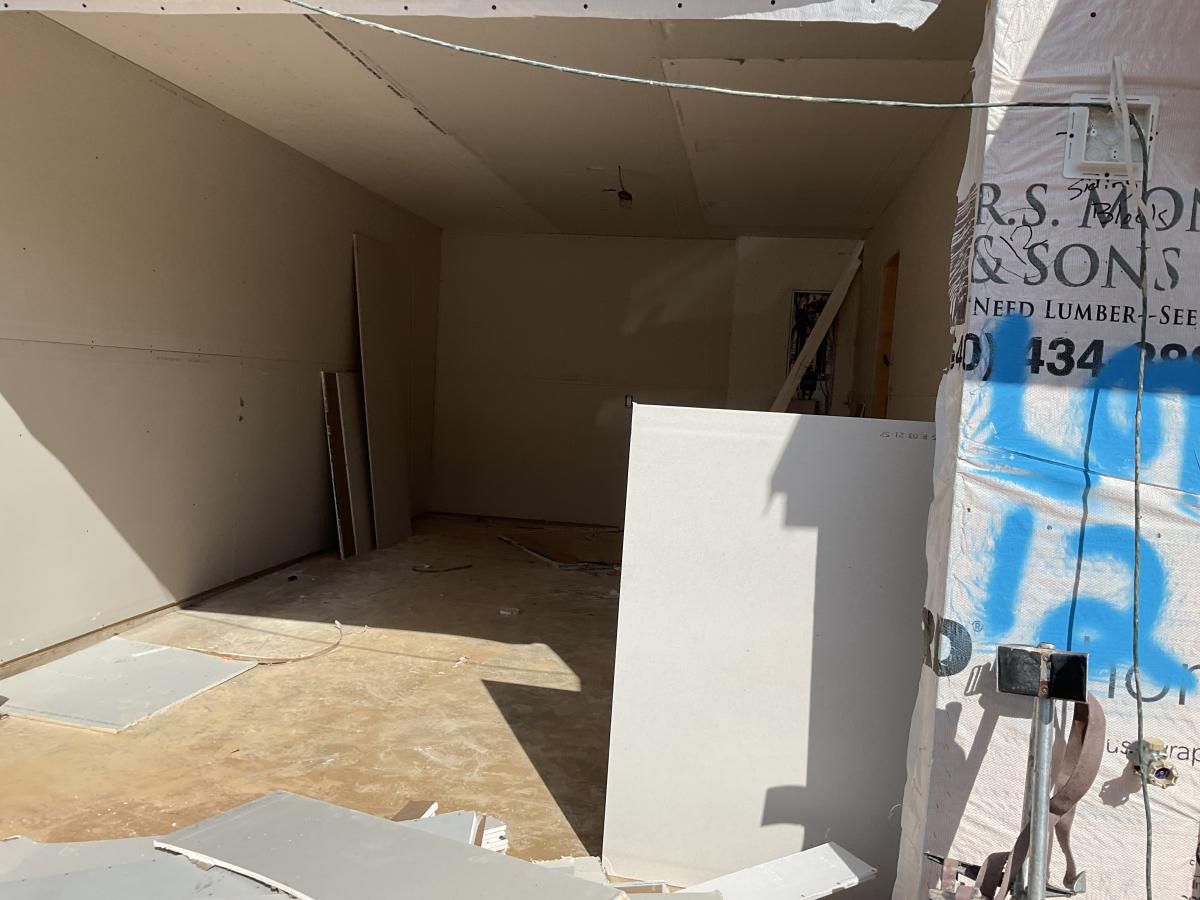

| Sun | Nov 2 | Drywall (Hang) (4) * | 99% completed 10/31 | |
| Thu | Nov 6 | Loan Approval (0) 03.25.2025 | JoDee @ United Bank (80% LTV) | |
| Thu | Nov 6 | Deed Preparation (0) | ||

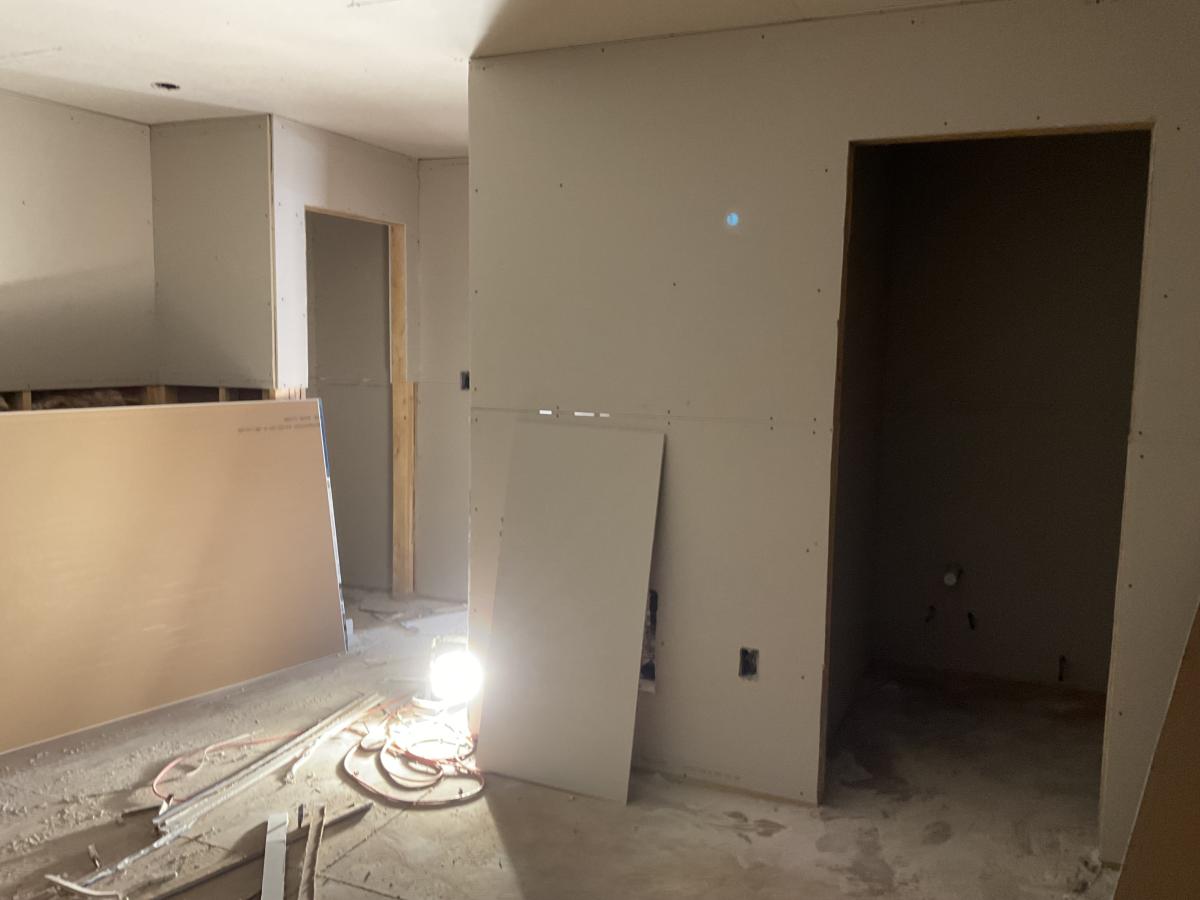

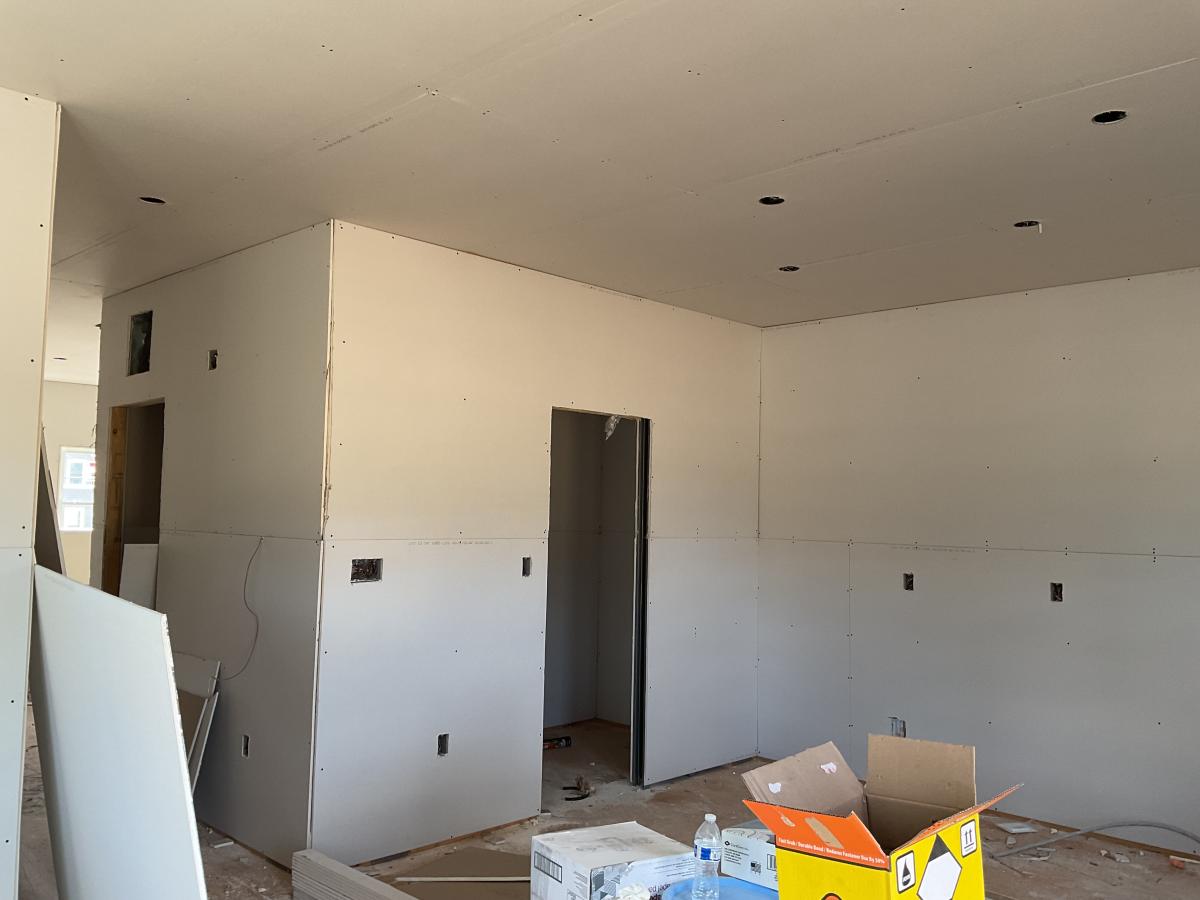

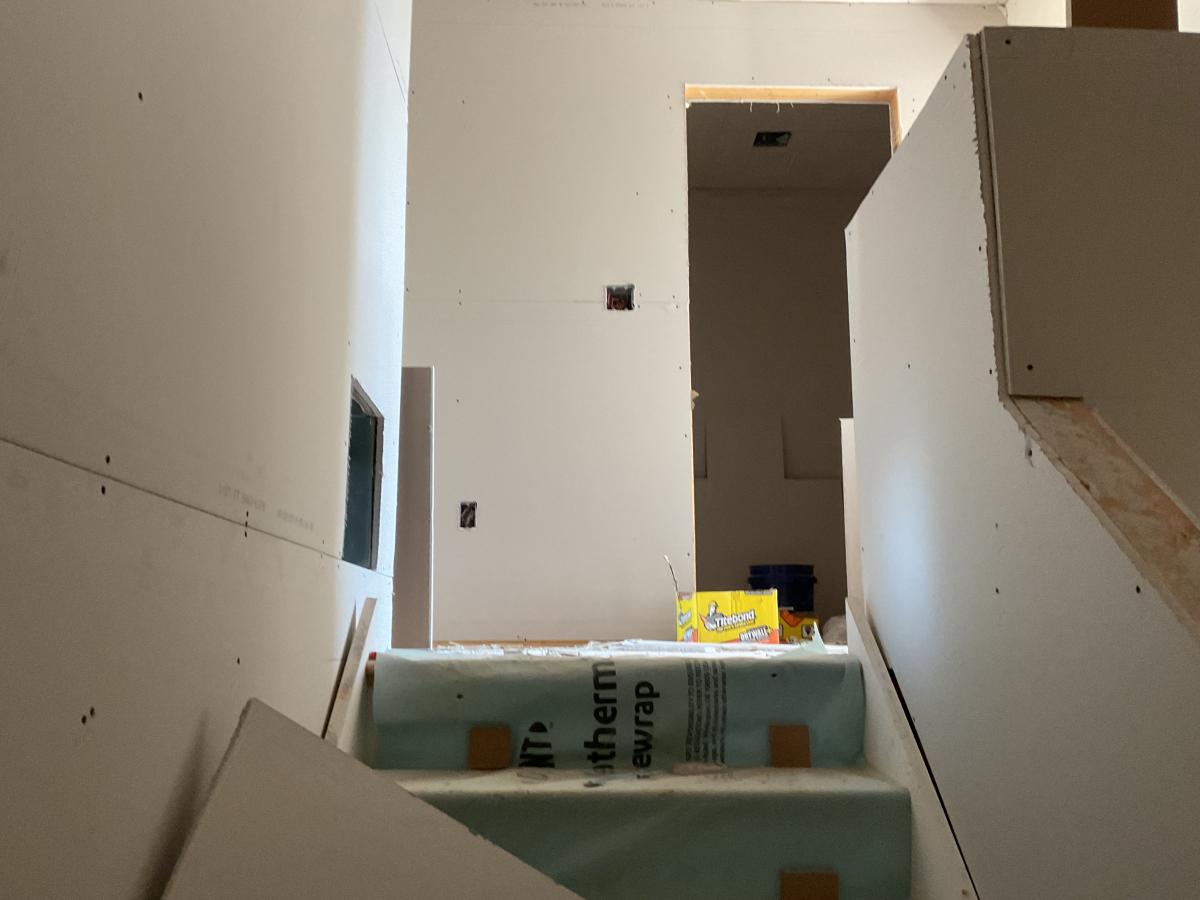

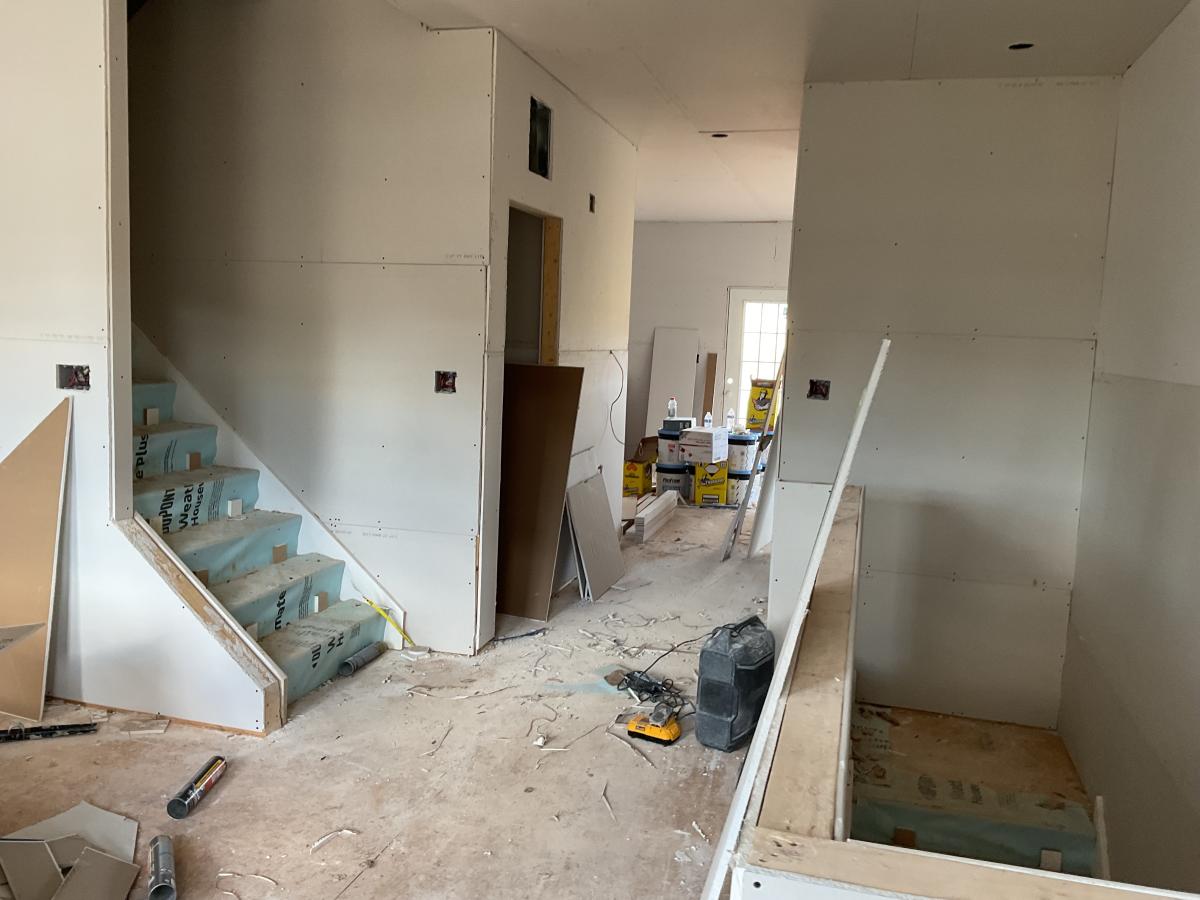

| Thu | Nov 6 | Drywall (Tape, Block, Skim, Sand) (6) * | ||

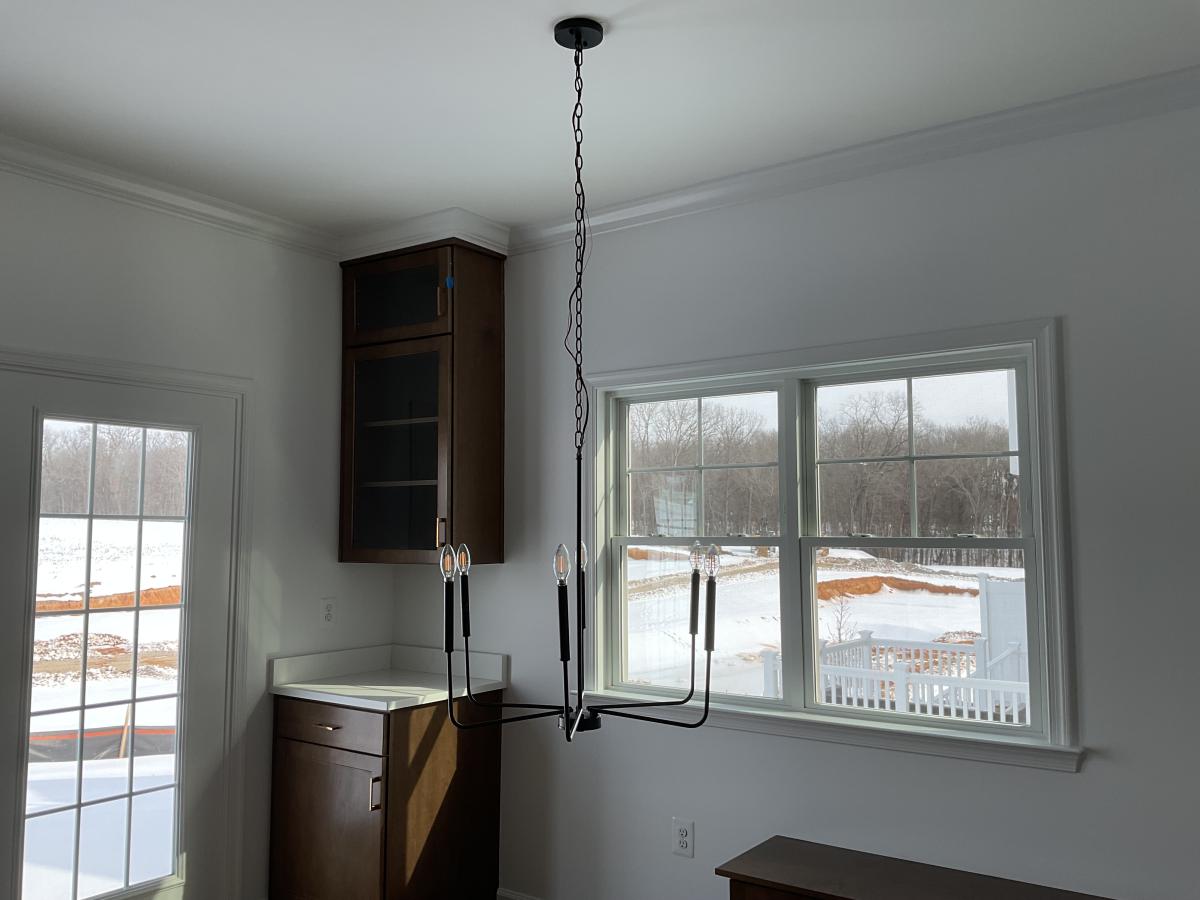

| Fri | Nov 14 | Paint 1 (1) | ||

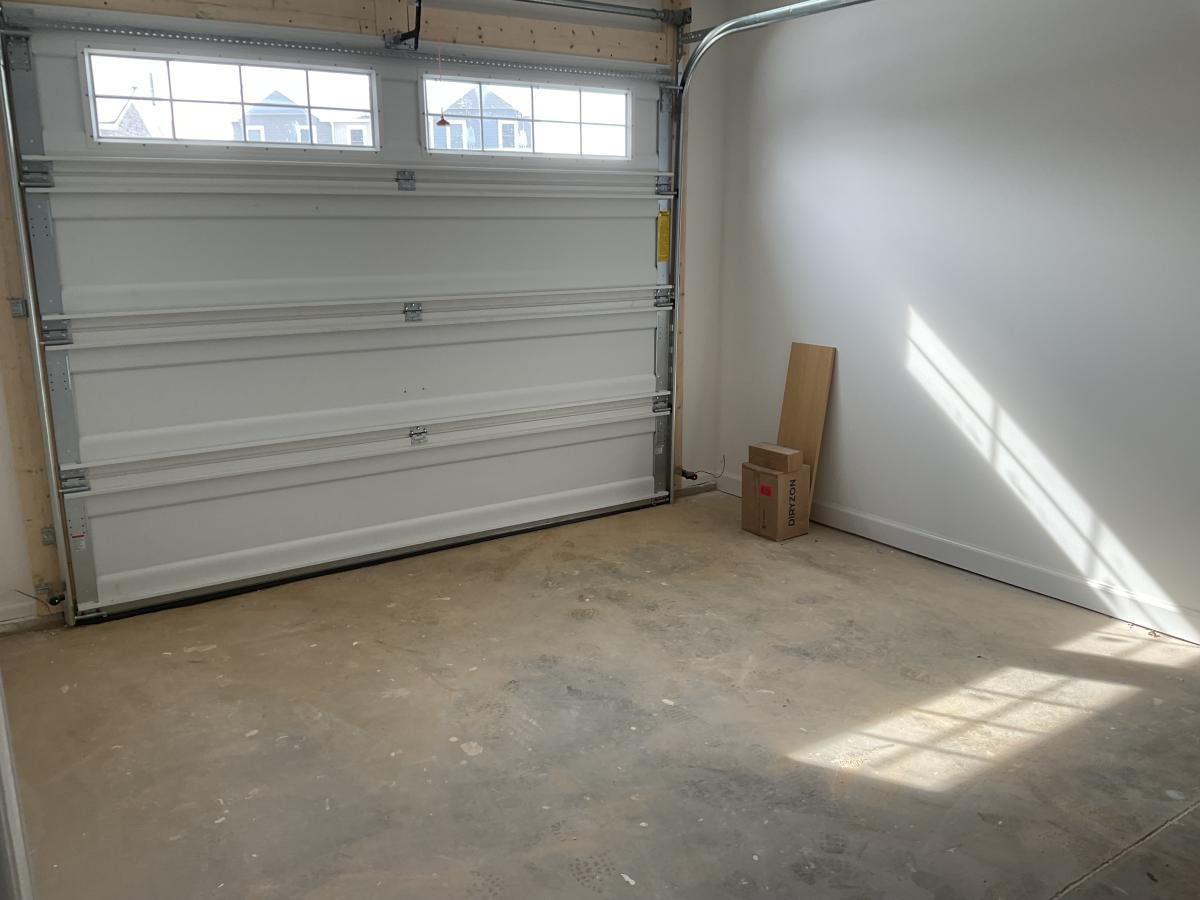

| Mon | Nov 17 | Garage Door (0) | ||
| Mon | Nov 17 | House Numbers (0) | ||
| Mon | Nov 17 | Mailbox (0) | ||

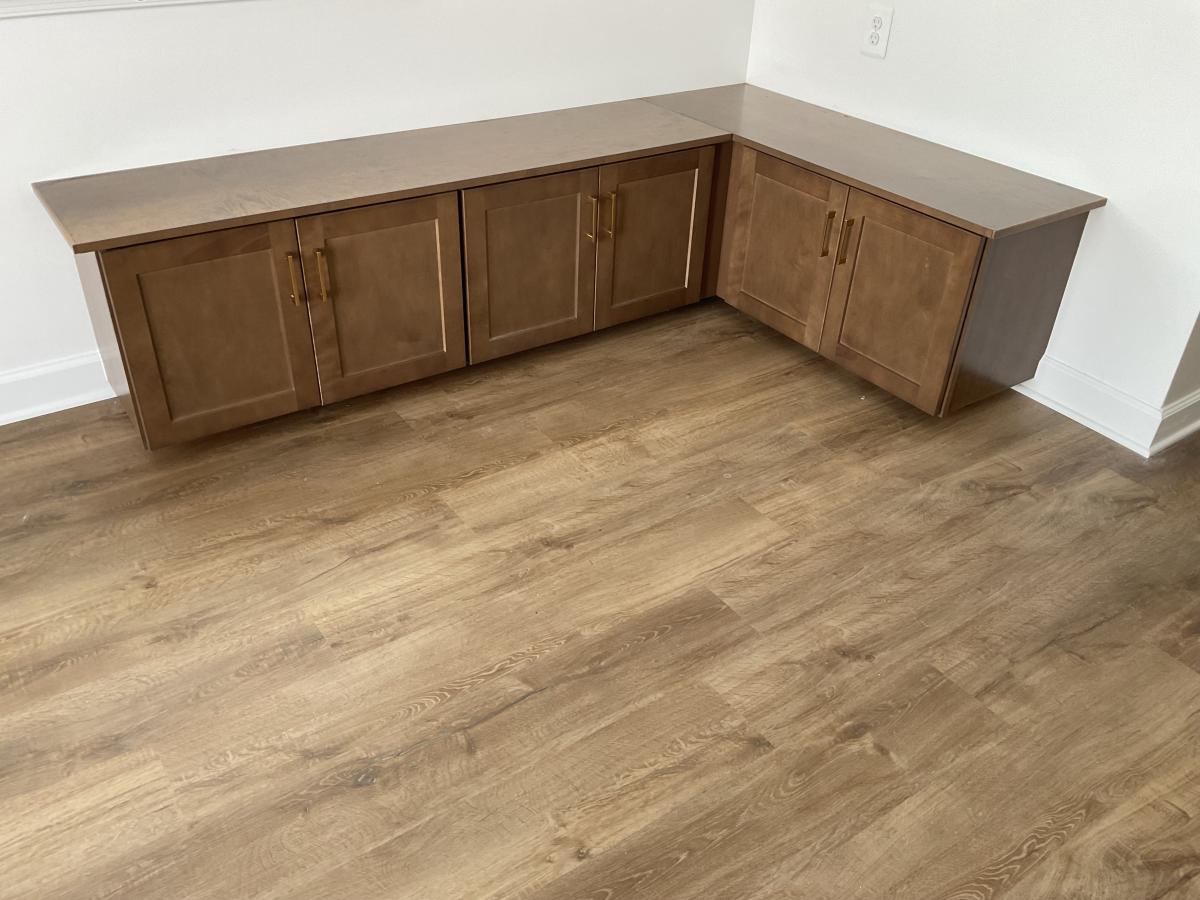

| Mon | Nov 17 | Cabinet Installation (2) * | ||
| Wed | Nov 19 | Granite Installation (1) * | ||
| Thu | Nov 20 | Interior Trim - Install (3) * | ||
| Tue | Nov 25 | Order Plumbing / Lighting Fixtures (0) | ||
| Tue | Nov 25 | Interior Trim - Paint (1) | ||

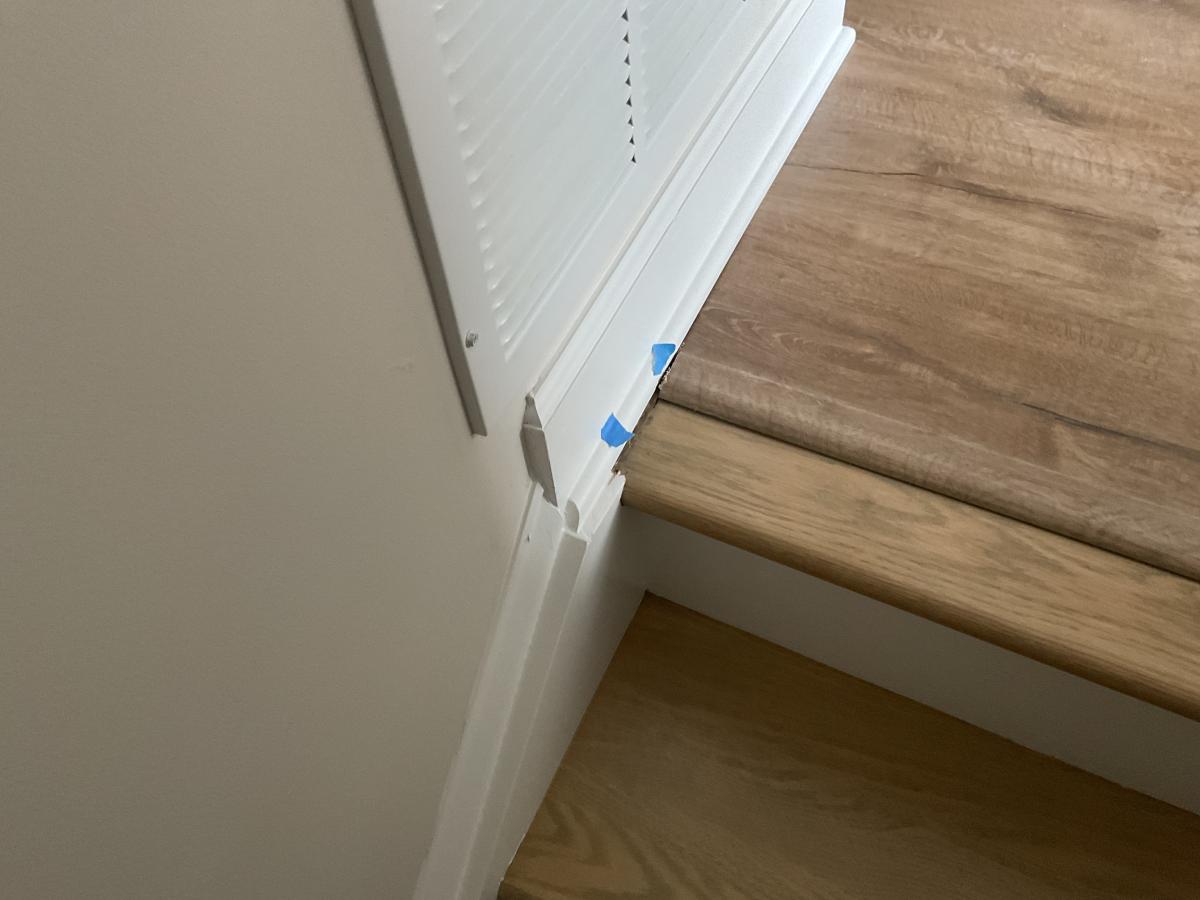

| Wed | Nov 26 | Luxury Vinyl Plank (3) * | ||
| Mon | Dec 1 | Luxury Vinyl Tile (0) | ||
| Mon | Dec 1 | Paint 2 (3) | ||
| Thu | Dec 4 | Cover Floors (1) | ||
| Fri | Dec 5 | Deliver Plumbing / Lighting Fixtures (0) | ||
| Fri | Dec 5 | Shoe Moulding (0) | ||
| Fri | Dec 5 | Shelving, Door Knobs, Fire Extinguisher (0) * | ||
| Fri | Dec 5 | Install Coded Lockbox (add extra keys) (0) | ||
| Fri | Dec 5 | Pay Water / Sewer Taps (0) | ||
| Fri | Dec 5 | Set Water Meter (0) * | ||
| Fri | Dec 5 | Electric Trim Out (3) * | ||
| Wed | Dec 10 | Ceiling Fans (0) | ||
| Wed | Dec 10 | HVAC Trim Out (1) * | ||
| Thu | Dec 11 | Blower Door Test (1) | ||
| Fri | Dec 12 | Plumbing Trim Out (2) * | ||
| Tue | Dec 16 | Install Appliances (0) * | Delivery set for 12/10 | |
| Tue | Dec 16 | Paint 3 (2) * | ||
| Thu | Dec 18 | Carpet (2) | ||
| Mon | Dec 22 | Appraiser Confirms Construction Completion (0) | ||
| Mon | Dec 22 | Inspection (Final HVAC) (1) | ||
| Tue | Dec 23 | Inspection (Final Plumbing) (1) | ||
| Wed | Dec 24 | Inspection (Final Electric) (1) | ||
| Thu | Dec 25 | Inspection (Final Building) (2) * | ||
| Mon | Dec 29 | Pre Walk Through (0) | ||

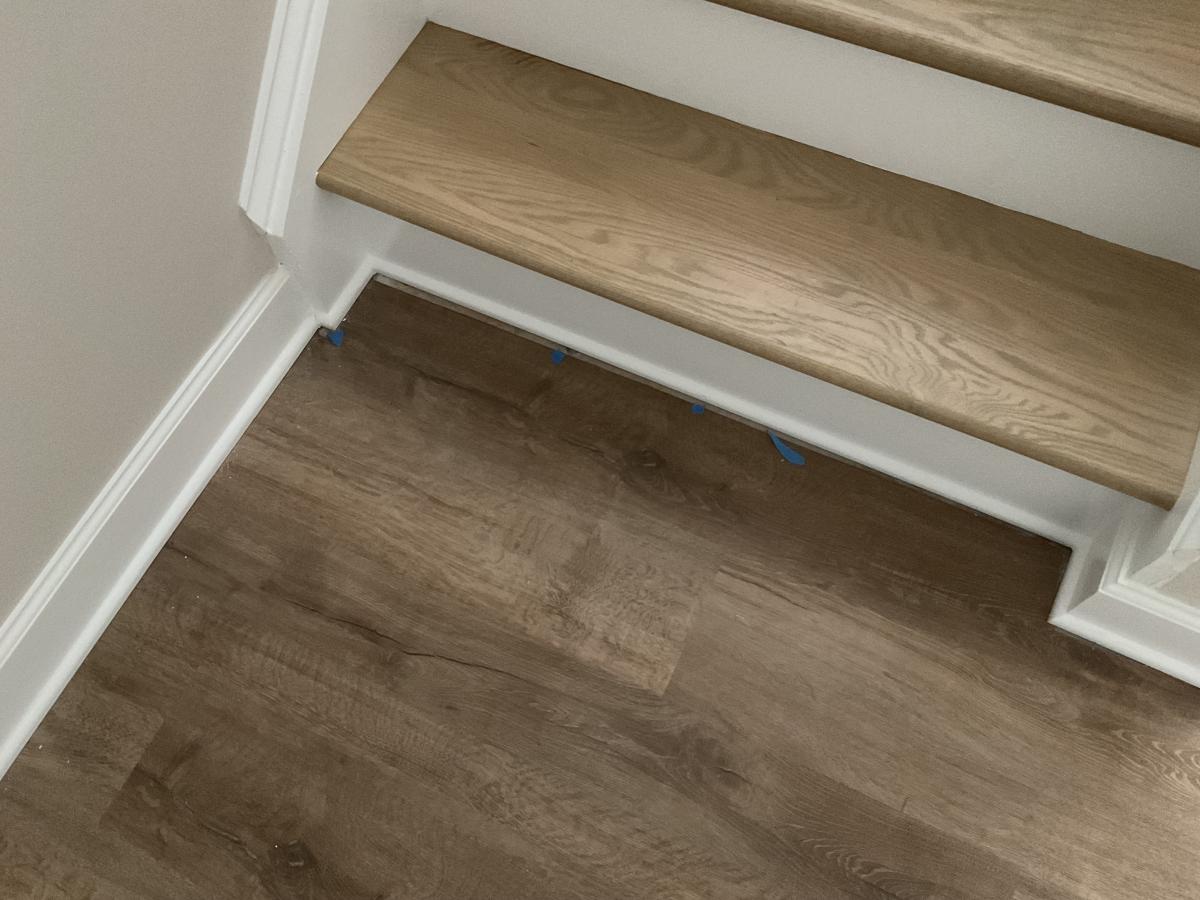

| Mon | Dec 29 | Stain Hardwood Stairs (1) * | ||
| Tue | Dec 30 | Cleaning (1) | ||
| Wed | Dec 31 | Certificate of Occupancy (1) * | ||
| Thu | Jan 1 | C.O. to Lender (0) | ||
| Thu | Jan 1 | Schedule Closing (0) | ||
| Thu | Jan 1 | Buyer Walk Through (1) * | ||
| Fri | Jan 2 | Payment for Upgrades (0) | ||
| Fri | Jan 2 | Keys to Settlement Agent (0) | ||
| Fri | Jan 2 | Review Settlement Statement (0) | ||
| Fri | Jan 2 | Jerry Signs Closing Documents (0) | ||
| Fri | Jan 2 | Request Trash Tote From POA Manager (0) | ||
| Fri | Jan 2 | Closing (1) | ||
| Mon | Jan 5 | Remove Coded Lockbox (0) | ||
| -- | -- | Shower pan and walls needed and plumbing trim out will be completed | ||
| -- | -- | Bathtub and garage needs to be installed and hooked up | ||
| -- | -- | Ratified Contract? (0) 03.07.2025 | ||
| Finish Bonus Room | ||||
| Finished Bathroom | ||||
| Farmhouse sink | ||||
| Amendment to increase price by $44,665 | ||||
| -- | -- | $2500 Deposit Received (0) 03.13.2025 | ||
| -- | -- | Association Packet Requested (0) 06.30.2025 | ||
| -- | -- | Association Packet Received (0) 03.07.2025 | ||
| -- | -- | Selections Meeting (0) 04.08.2025 | ||
| -- | -- | Selections Sheet Signed (0) 04.18.2025 | 4/16: sent to Tom | |
| -- | -- | Amendment for Upgrades (B,S,L,T,BCP) (0) 04.26.2025 | 4/25: sent to Jerry | |
| -- | -- | Deposit For Upgrades Received (0) 04.25.2025 | ||
| -- | -- | Building Permit (30) * 04.11.2025 | ||
| -- | -- | Order Roof & Floor Trusses (1) 08.04.2025 | ||
| -- | -- | Order Windows & Doors (0) 09.15.2025 | ||
| -- | -- | Stake Out Home (1) 05.27.2025 | ||
| -- | -- | Excavate (2) 05.27.2025 | ||
| -- | -- | Inspection (Footers) (1) 07.31.2025 | ||
| -- | -- | Inspection (Concrete Wall) (1) 07.31.2025 | ||
| -- | -- | Pour Footers (1) * 05.27.2025 | ||
| -- | -- | Set Forms (2) 05.27.2025 | ||
| -- | -- | Pour Foundation Walls (1) 05.27.2025 | ||
| -- | -- | Plumb Slab (2) 07.31.2025 | ||
| -- | -- | Inspection (Plumbing Under Slab) (1) 07.31.2025 | ||
| -- | -- | Inspection (Conduit Under Slab) (1) 07.31.2025 | ||
| -- | -- | Prepare Slab (1) 07.31.2025 | ||
| -- | -- | Inspection (Slab) (1) 07.31.2025 | ||
| -- | -- | Inspection (Drain Tile) (0) 09.28.2025 | ||
| -- | -- | Pour Slab (1) * 07.31.2025 | ||
| -- | -- | Settlement Agent Confirmed (0) 04.30.2025 | 4/26: sent to Brittany | |
| -- | -- | Framing I (9) 09.04.2025 | ||
| -- | -- | Order Steps (0) 09.15.2025 | ||
| -- | -- | Order Tubs / Showers (0) 09.28.2025 | ||
| -- | -- | Framing II (8) 09.17.2025 | ||
| -- | -- | Framing III (8) * 09.25.2025 | ||
| -- | -- | Verify Window & Roof Structure (0) 09.28.2025 | ||
| -- | -- | Install Stairs (0) * 09.26.2025 | ||
| -- | -- | Windows & Doors (0) * 09.28.2025 | ||
| -- | -- | House Number and Status in Window (0) 10.15.2025 | ||
| -- | -- | Roofing (0) * 09.28.2025 | ||
| -- | -- | Order Cabinets (0) 10.16.2025 | ||
| -- | -- | Order Appliances (0) 10.24.2025 | Kate will order 11/15 for 12/15 install | |
| -- | -- | Deck (0) 10.29.2025 | None | |
| -- | -- | HVAC Rough In (4) 10.04.2025 | ||
| -- | -- | Rough In Microwave Vent (0) 10.04.2025 | ||
| -- | -- | Plumbing Rough In (4) 10.04.2025 | ||
| -- | -- | Electric Rough In (4) 10.15.2025 | In process 10/8 | |
| -- | -- | Inspection (Rough In HVAC) (1) 10.22.2025 | ||
| -- | -- | Inspection (Rough In Plumbing) (1) 10.22.2025 | ||
| -- | -- | Inspection (Rough In Electric) (1) 10.22.2025 | ||
| -- | -- | Inspection (Framing) (1) * 10.22.2025 | ||
| -- | -- | Insulation (2) * 10.22.2025 | ||
| -- | -- | Inspection (Insulation) (1) 10.30.2025 | ||
| -- | -- | Inspection (Electric Service) (0) 10.30.2025 | ||
| -- | -- | Inspection (Main Sewer Line) (0) 10.30.2025 | ||
| -- | -- | Inspection (Main Water Line) (0) 10.30.2025 | ||
