CONGERS-3 - 35  ::  1442 Derby Drive
[ BUILD: 20242190 ]
CRITICAL PATH   |   INSPECTIONS   |   FLOOR PLANS   |   SELECTIONS   |   SPECS   |   CHANGES   |   NHS
view photo archive

--   --   Buyer Phone Number (540) 435-7747
--   --   Trim at farmhouse sink (burlap) Jorge
--   --   Deck door needs installed
--   --   Front dormer window needs installed
--   --   Farm Sink arriving Thursday 5/22.
--   --   Can someone walk through and put insulation in all the bathtubs? Somehow have it and some do not Hall bath needs it here
--   --   Need bonus bath vanity in the living room - Tom to install
--   --   Framingrepair needed closet door on foyer level Paint - Jesus
--   --   Blemish on powder toilet Replace tank lid, Jill will get it
--   --   Trim out garage Jorge
--   --   Plumbing trim out needed of bonus room when vanity arrives
--   --   CODED LOCKBOX 3535
--   --   Cover carpet on steps and upstairs and home Jill
--   --   Trim doors now that carpet has been installed Jorge
--   --   Finish shelving and master closet now that carpet has been installed Paul
--   --   No sign of shower doors, yet Paul
--   --   Powder bath needs a mirror
--   --   All mirrors needed Paul
--   --   Missing one house number Jill
--   --   Large metal piece in smaller bedroom upstairs window appears to be missing? Jill will show Courtney how to slide the piece up
--   --   A little bit of sanding needs to be done on the side of the shower door where it was caulked or painted Jesus
--   --   Bonus vanity light needed. An exterior electrical trim out needs to be completed on back patio. Electrician
--   --   A few lightbulbs need installed Electrician. Dining room.
--   --   Brown kitchen island receptacles need to be installed Electrician
--   --   Light receptacle in hand towel holder appear to be too close to the master bathroom mirror. Electrician
--   --   Missing two globes to the light fixture in the master bathroom vanity Electrician
--   --   Install correct handle closet under stairs once George has removed all of his equipment Jorge
--   --   Install handles and side splash on bonus vanity Tom
--   --   Exterior electrical outlet needs finishing
--   --   I think this patio is going to need stairs to the backyard Tom
--   --   Few steps have gapping and need painting on the hardwood treads to main level Jesus
--   --   Remove glue from upper transition strip to luxury vinyl plank on stairs Denny
--   --   Final touchup paint and railings need to be installed Jesus
--   --   Weatherstripping needed around garage door Jesus
--   --   Install handles on the bonus room vanity Buddy
--   --   Patch hole near bonus bath light Jesus
--   --   I don’t think these appliances are hooked up to electricity yet to test the microwave vent Jill, CJ
--   --   Install vent cover back on powder bath ceiling Jason
--   --   It needs to be adjusted in master bath so that it covers hole It = Light, Electrician
--   --   Replace shelf Kitchen cabinet, Fred
--   --   Replace powder toilet lid Jill, Northeastern
--   --   Fix towel holder in master bathroom Jill
--   --   Front door needs one side strip of weatherstripping Jill
--   --   Clean off deck Jill
--   --   Trim closet door under first set of steps Jorge - side of door
--   --   I needed trim next to farmhouse sink Jorge - burlap trim
--   --   Sweep off deck Jill or Lynn
--   --   Top needed for toilet in hall both ( swapped to 37) Jill
--   --   Put attic access panel in place Jill will coordinate
--   --   Toilet lid for powder room Jill
--   --   Hole in bonus bathroom light fixture needs to be patched Jesus
--   --   Stove is not plugged in CJ
--   --   Need lid to toilet in hall bath Jill
--   --   Piece of weatherstripping needed on front door Jill
--   --   Sand side of shower door Jesus
--   --   Bonus room needs a light fixture? Bathroom
--   --   Looks like quite a bit of paint is going to need to be removed from the luxury vinyl plank Jesus
--   --   Clean out the garage Needs to be swept out
--   --   Closing on Friday!
--   --   Looks like a lot of drywall mud needs to be removed from the garage floor Drywallees
--   --   Paint touchup Jesus - In process 9/24
--   --   Clean paint off deck Jill or Jesus
--   --   Clean paint off of LVP Jesus
--   --   Fill nail holes at the vanity in primary bath Jesus
--   --   Touch up shoe moulding in hall bath Jesus
-- -- Ratified Contract? (0)  12.21.2024
    Expanded Driveway
    White Painted Kitchen Cabinets
    Level 0 Quartz in kitchen
    Three Drawer Stack in place of B 36"
    Spice Rack in B 9"
    Microwave vented to Exterior
    White Painted Cabinetry in Bathrooms
    Shower Door with Black Trim
    Finished Bonus Room
    Finished Bonus Bathroom
    Gardenia LVT in all baths and laundry
    French Model Refrigerator
    12 x 18 deck
    10 x 10 Patio under deck
    Farmhouse Sink- white
    Amendment to increase price by $29,890
-- -- $2500 Deposit Received (0)  12.24.2024
-- -- Association Packet Requested (0)  06.30.2025
-- -- Association Packet Received (0)  12.27.2024
-- -- Selections Meeting (0)  01.17.2025
-- -- Selections Sheet Signed (0)  02.06.2025     2/4: sent to Hemen
-- -- Amendment for Upgrades (B,S,L,T,BCP) (0)  02.19.2025     2/5: sent to Hemen
-- -- Deposit For Upgrades Received (0)  02.19.2025
-- -- Building Permit (30) *   11.22.2024
-- -- Order Roof & Floor Trusses (1)  02.20.2025
-- -- Order Windows & Doors (0)  12.30.2024
-- -- Stake Out Home (1)  12.02.2024
-- -- Excavate (2)  12.02.2024
-- -- Inspection (Footers) (1)  12.02.2024
-- -- Inspection (Concrete Wall) (1)  12.02.2024
-- -- Pour Footers (1) *   12.02.2024
-- -- Set Forms (2)  12.19.2024
-- -- Pour Foundation Walls (1)  12.19.2024
-- -- Plumb Slab (2)  12.30.2024
-- -- Inspection (Plumbing Under Slab) (1)  12.30.2024
-- -- Inspection (Conduit Under Slab) (1)  12.30.2024
-- -- Prepare Slab (1)  02.02.2025
-- -- Inspection (Slab) (1)  02.20.2025
-- -- Inspection (Drain Tile) (0)  06.09.2025
-- -- Pour Slab (1) *   02.27.2025
-- -- Settlement Agent Confirmed (0)  02.24.2025
-- -- Framing I (9)  03.29.2025
-- -- Order Steps (0)  04.03.2025
-- -- Order Tubs / Showers (0)  04.07.2025
-- -- Framing II (8)  03.29.2025
-- -- Framing III (8) *   04.07.2025
-- -- Verify Window & Roof Structure (0)  05.10.2025
-- -- Install Stairs (0) *   04.19.2025
-- -- Windows & Doors (0) *   05.14.2025
-- -- House Number and Status in Window (0)  05.19.2025
-- -- Roofing (0) *   05.07.2025
-- -- Order Cabinets (0)  05.03.2025     Ordered 5/2
-- -- Order Appliances (0)  06.09.2025

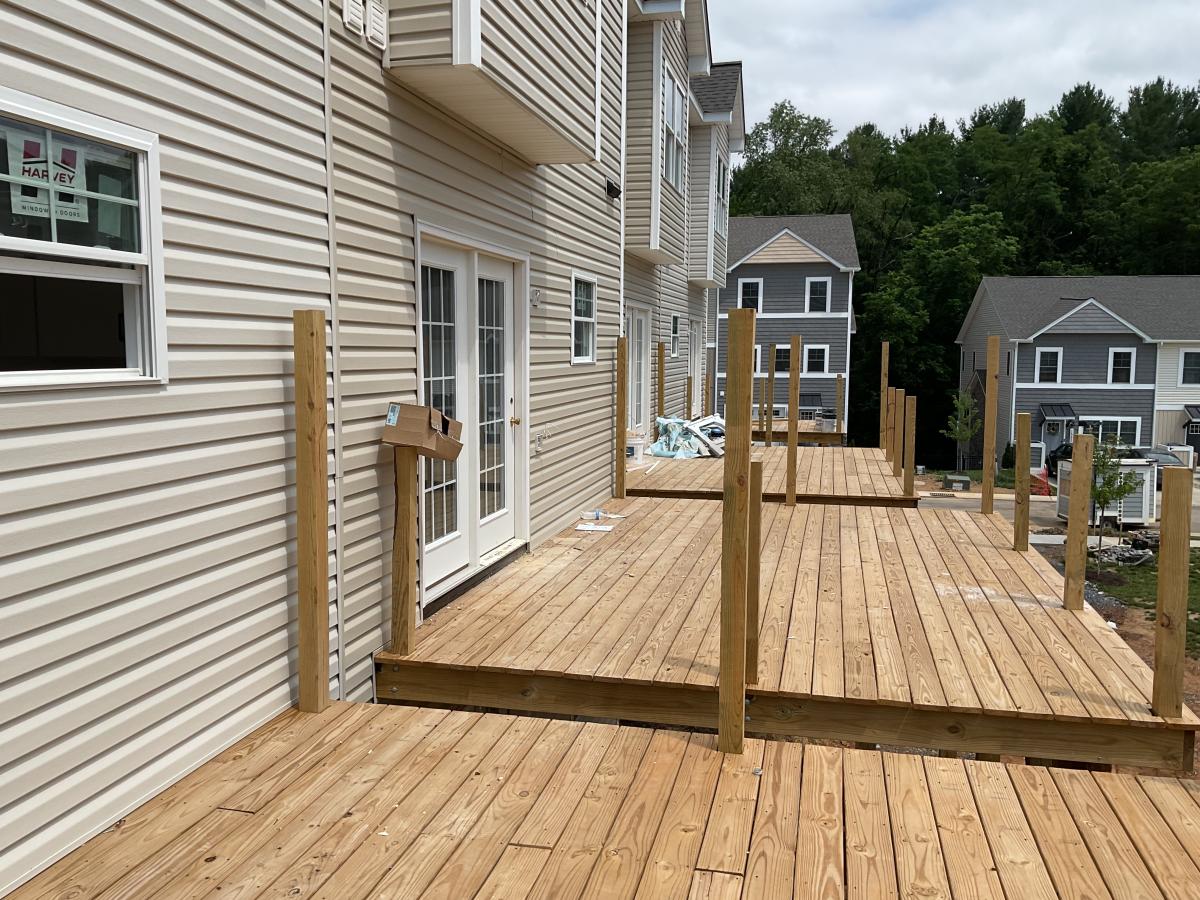

-- -- Deck (0)  05.14.2025     Expanded 12 x 18
-- -- Gutters (0)  07.02.2025
-- -- Driveway (0) *   06.25.2025     Expanded
-- -- Patio (0)  06.15.2025     Expanded 10 x 10- deck
-- -- Privacy Divider / Fence (0) *   07.09.2025
-- -- Sod / Seed / Landscaping (0)  09.13.2025
-- -- HVAC Rough In (4)  04.30.2025     In process 4/26
-- -- Rough In Microwave Vent (0)  04.26.2025
-- -- Plumbing Rough In (4)  05.10.2025     In process 4/30
-- -- Electric Rough In (4)  05.17.2025     In process 5/14. Almost completed.
-- -- Inspection (Rough In HVAC) (1)  05.17.2025
-- -- Inspection (Rough In Plumbing) (1)  05.17.2025
-- -- Inspection (Rough In Electric) (1)  05.17.2025
-- -- Inspection (Framing) (1) *   05.17.2025
-- -- Inspection (Deck Piers) (0)  06.24.2025
-- -- Exterior Vinyl (0) *   07.30.2025     In process 6/15
-- -- Exterior Stone (0)  07.07.2025
-- -- Insulation (2) *   05.17.2025
-- -- Inspection (Insulation) (1)  05.19.2025
-- -- Inspection (Electric Service) (0)  06.12.2025
-- -- Set Electric Meter (0) *   08.12.2025
-- -- Inspection (Main Sewer Line) (0)  06.09.2025
-- -- Inspection (Main Water Line) (0)  06.09.2025
-- -- Order Interior Doors & Trim (0)  06.24.2025
-- -- Drywall (Hang) (4) *   05.21.2025
-- -- Loan Approval (0)  09.20.2025     USDA
-- -- Deed Preparation (0)  07.07.2025
-- -- Drywall (Tape, Block, Skim, Sand) (6) *   06.04.2025     Just needs sanding 5/31
-- -- Paint 1 (1)  06.04.2025
-- -- Garage Door (0)  06.30.2025
-- -- House Numbers (0)  07.12.2025
-- -- Mailbox (0)  07.03.2025

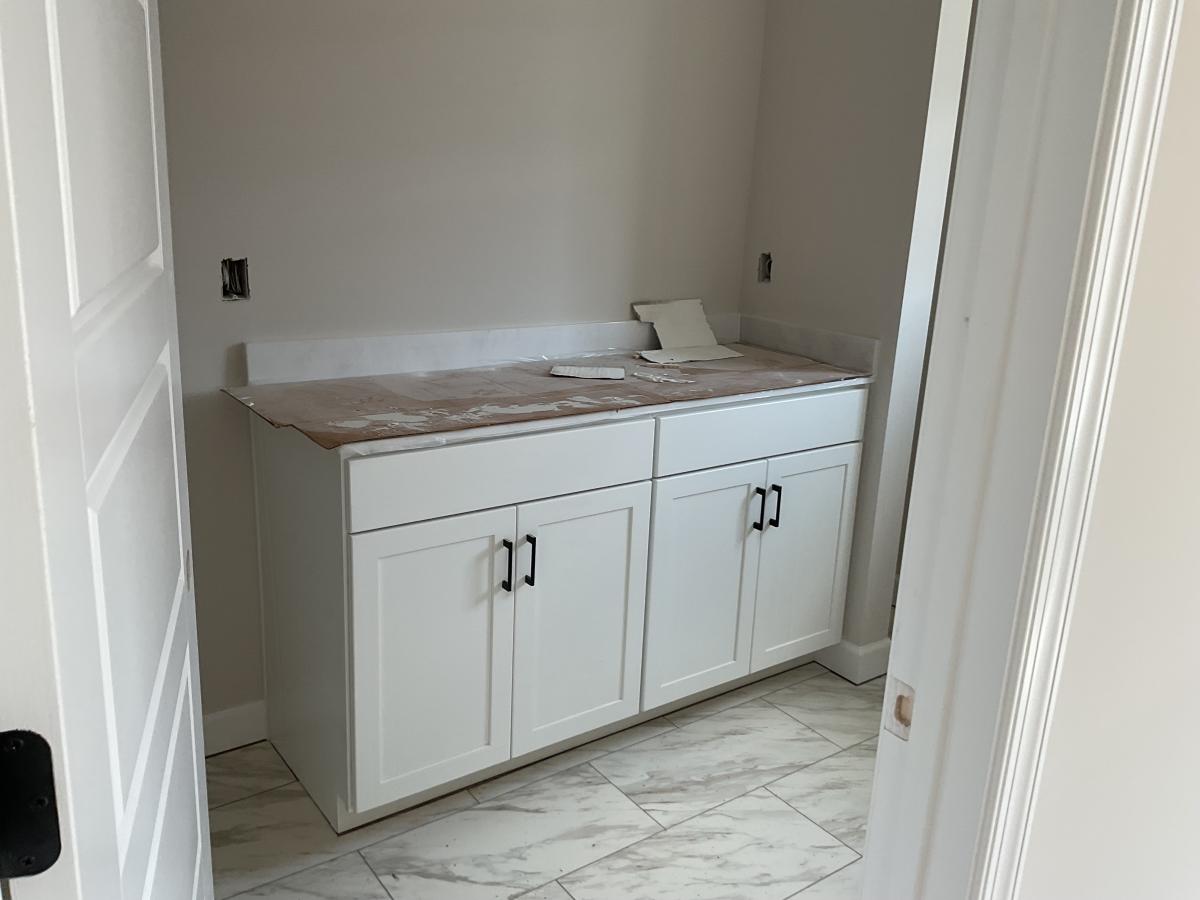

-- -- Cabinet Installation (2) *   06.04.2025     Deliver June 3, Install June 4
-- -- Granite Installation (1) *   06.21.2025
-- -- Interior Trim - Install (3) *   06.18.2025     Needs painting 6/15
-- -- Order Plumbing / Lighting Fixtures (0)  06.12.2025
-- -- Interior Trim - Paint (1)  06.18.2025

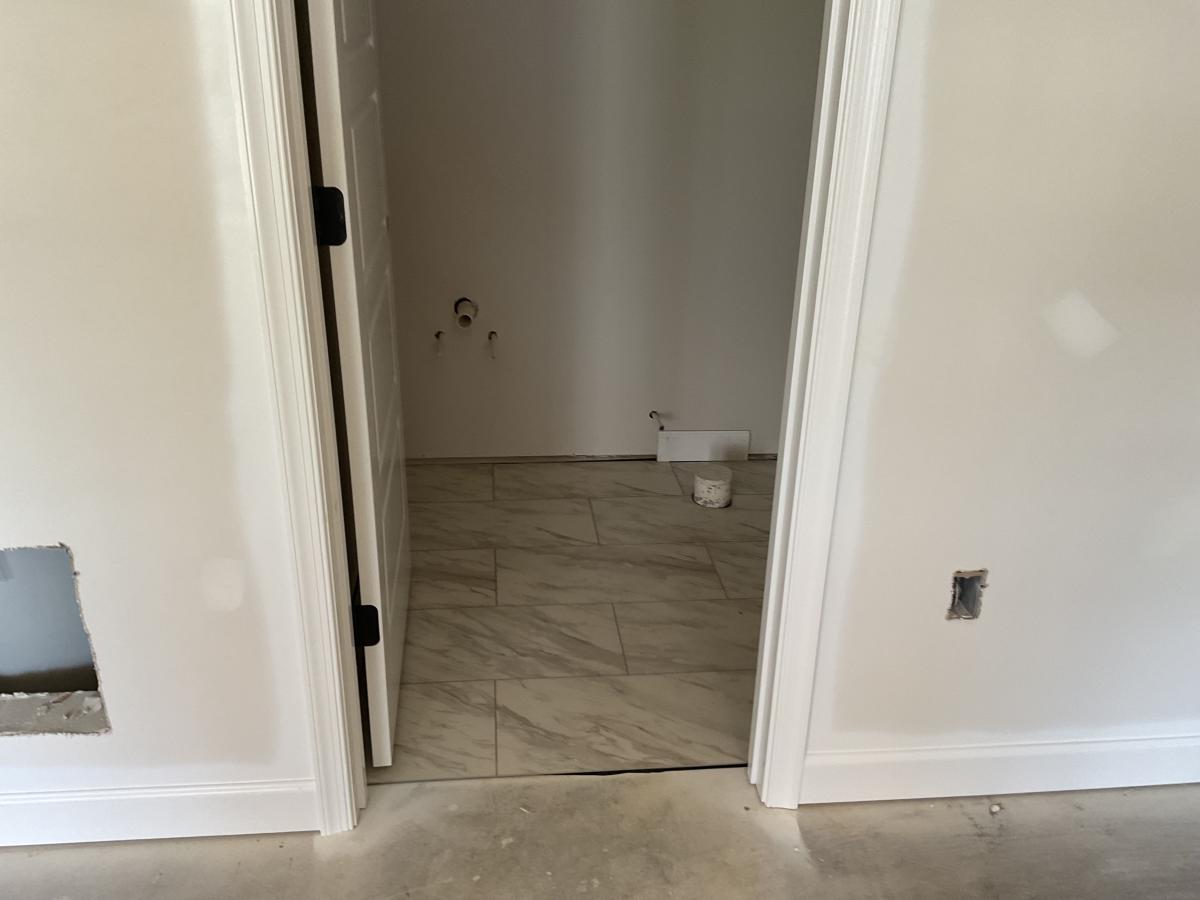

-- -- Luxury Vinyl Plank (3) *   06.27.2025     In process 6/25
-- -- Luxury Vinyl Tile (0)  06.27.2025     In process 6/25
-- -- Paint 2 (3)  06.27.2025     In process 6/18. Bathrooms have oven painted, but other areas have not.
-- -- Cover Floors (1)  07.04.2025
-- -- Deliver Plumbing / Lighting Fixtures (0)  06.19.2025
-- -- Shoe Moulding (0)  07.04.2025
-- -- Shelving, Door Knobs, Fire Extinguisher (0) *   07.09.2025     In process 7/2
-- -- Install Coded Lockbox (add extra keys) (0)  07.04.2025
-- -- Pay Water / Sewer Taps (0)  06.30.2025
-- -- Set Water Meter (0) *   07.03.2025
-- -- Electric Trim Out (3) *   07.12.2025     In process 7/9
-- -- Ceiling Fans (0)  07.12.2025
-- -- HVAC Trim Out (1) *   08.18.2025     HVAC trimout is completed except thermostat
-- -- Blower Door Test (1)  08.18.2025
-- -- Plumbing Trim Out (2) *   07.02.2025

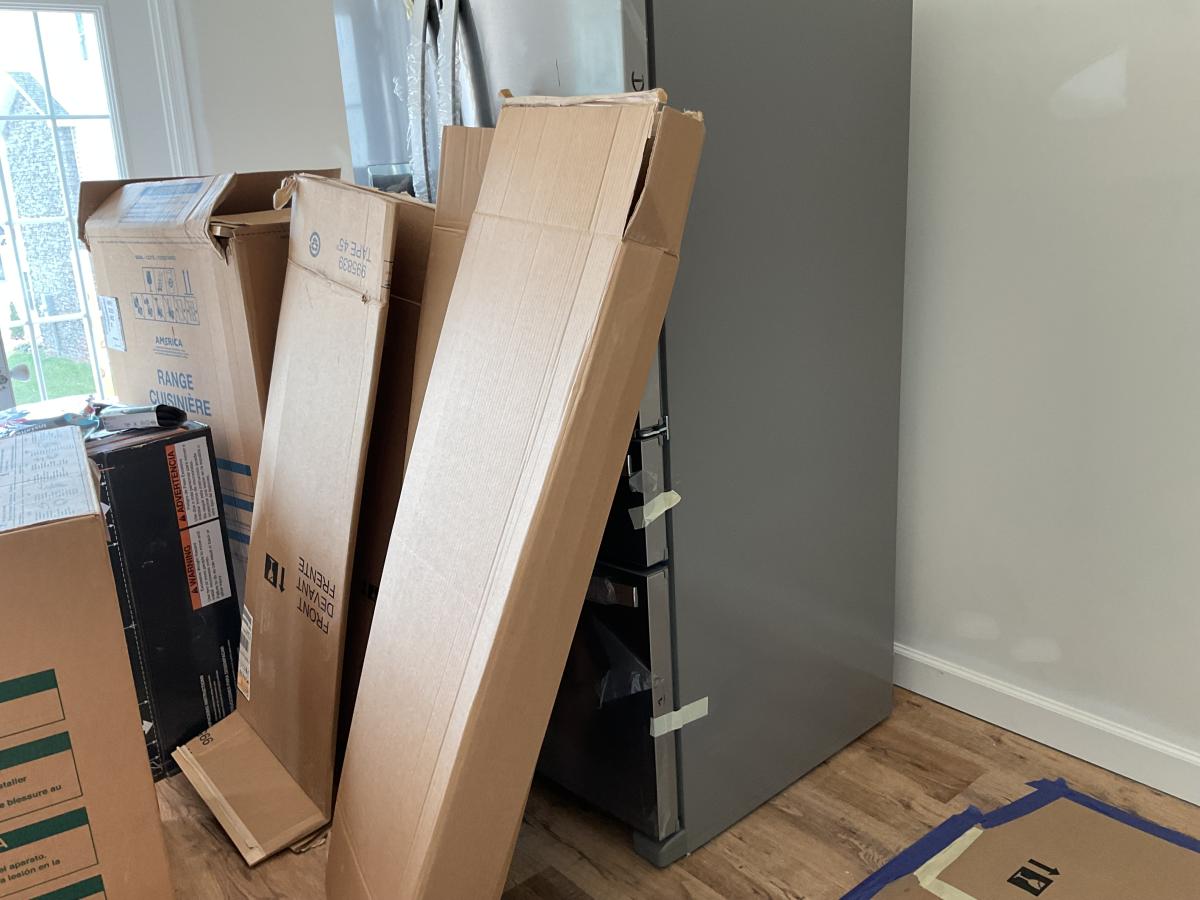

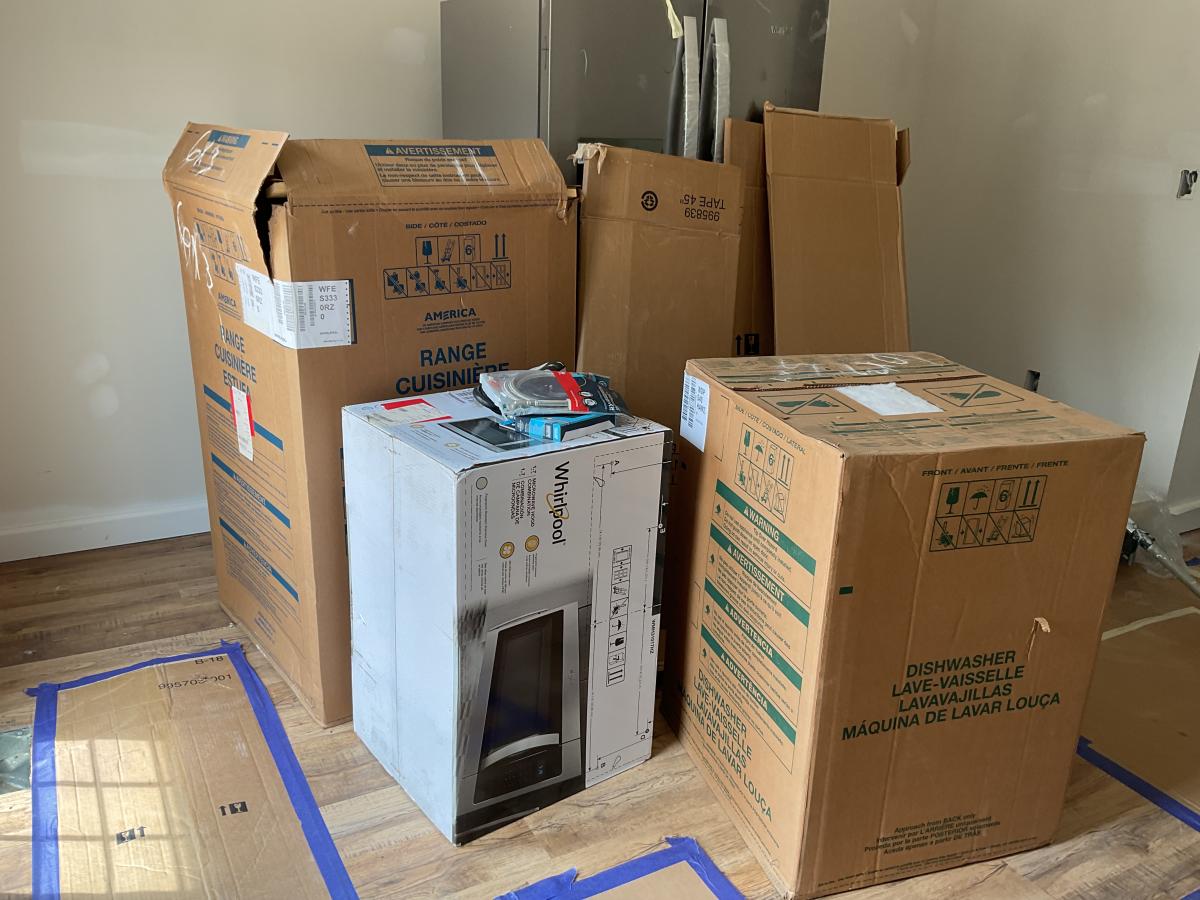

-- -- Install Appliances (0) *   07.02.2025     French/ Current Date: 7/7
-- -- Paint 3 (2) *   07.12.2025
-- -- Carpet (2)  07.04.2025
-- -- Appraiser Confirms Construction Completion (0)  09.20.2025
-- -- Inspection (Final HVAC) (1)  08.19.2025
-- -- Inspection (Final Plumbing) (1)  08.19.2025
-- -- Inspection (Final Electric) (1)  08.19.2025
-- -- Inspection (Final Building) (2) *   08.19.2025
-- -- Pre Walk Through (0)  09.20.2025
-- -- Stain Hardwood Stairs (1) *   07.18.2025     In process 7/16
-- -- Cleaning (1)  09.17.2025     Almost completed 9/13
-- -- Certificate of Occupancy (1) *   08.29.2025
-- -- C.O. to Lender (0)  08.29.2025
-- -- Schedule Closing (0)  09.20.2025
-- -- Buyer Walk Through (1) *   09.25.2025
-- -- Payment for Upgrades (0)  08.21.2025
-- -- Keys to Settlement Agent (0)  08.21.2025
-- -- Review Settlement Statement (0)  09.20.2025
-- -- Jerry Signs Closing Documents (0)  09.26.2025
-- -- Request Trash Tote From POA Manager (0)  08.15.2025
-- -- Closing (1)  09.26.2025     Brittany @ West View Title (Friday, Sep 26)
-- -- Remove Coded Lockbox (0)  09.29.2025
