Finished Bonus Room
|
|
|
|
Finished Bonus Bath
|
|
|
|
Expanded 10 x 18 Deck
|
|
|
|
Expanded Driveway
|
|
|
|
Microwave vented to exterior
|
|
|
|
Three additional ceiling fans (Living Room and upper bedrooms)
|
|
|
|
Upgraded Carpet Pad in Bonus Room, Stairs and Upstairs
|
|
|
|
Digital Deadbolt
|
|
|
|
Garage Door Keypad
|
|
|
|
Three Drawer Base in place of B 36" in kitchen
|
|
Tue |
Jul 1 |
Deposit For Upgrades Received (0) |
|
|
Tue |
Jul 1 |
Order Roof & Floor Trusses (1) |
|
|
Wed |
Jul 2 |
Order Windows & Doors (0) |
|
|
Wed |
Jul 2 |
Inspection (Drain Tile) (0) |
|
|
Wed |
Jul 2 |
Framing I (9) |
|
|
Tue |
Jul 15 |
Order Steps (0) |
|
|
Tue |
Jul 15 |
Order Tubs / Showers (0) |
|
|
Tue |
Jul 15 |
Framing II (8) |
|
|
Fri |
Jul 25 |
Framing III (8) * |
|
|
Wed |
Aug 6 |
Verify Window & Roof Structure (0) |
|
|
Wed |
Aug 6 |
Install Stairs (0) |
|
|
Wed |
Aug 6 |

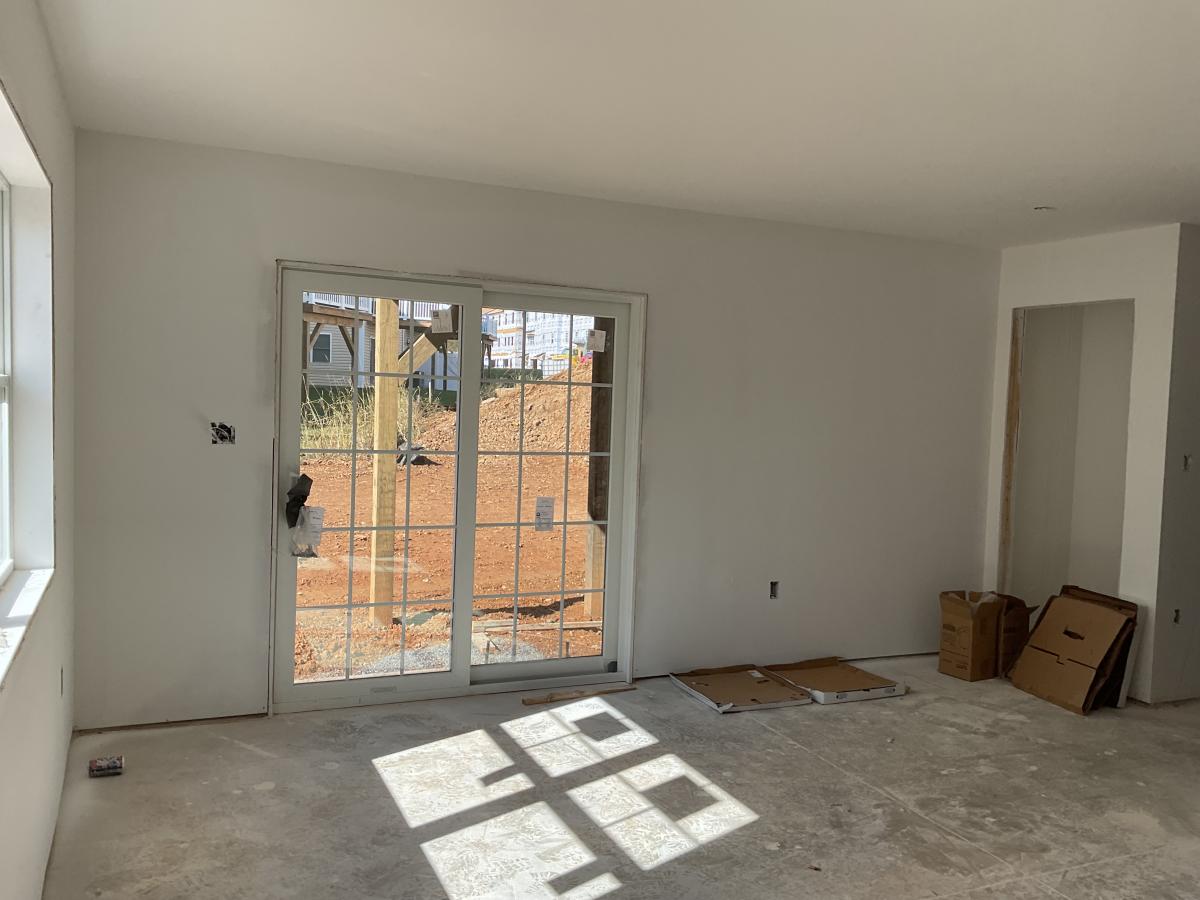

Windows & Doors (0) * |
|
|
Wed |
Aug 6 |
House Number and Status in Window (0) |
|
|
Wed |
Aug 6 |
Roofing (0) * |
|
|
Wed |
Aug 6 |
Order Cabinets (0) |
|
|
Wed |
Aug 6 |
Order Appliances (0) |
|
|
Wed |
Aug 6 |

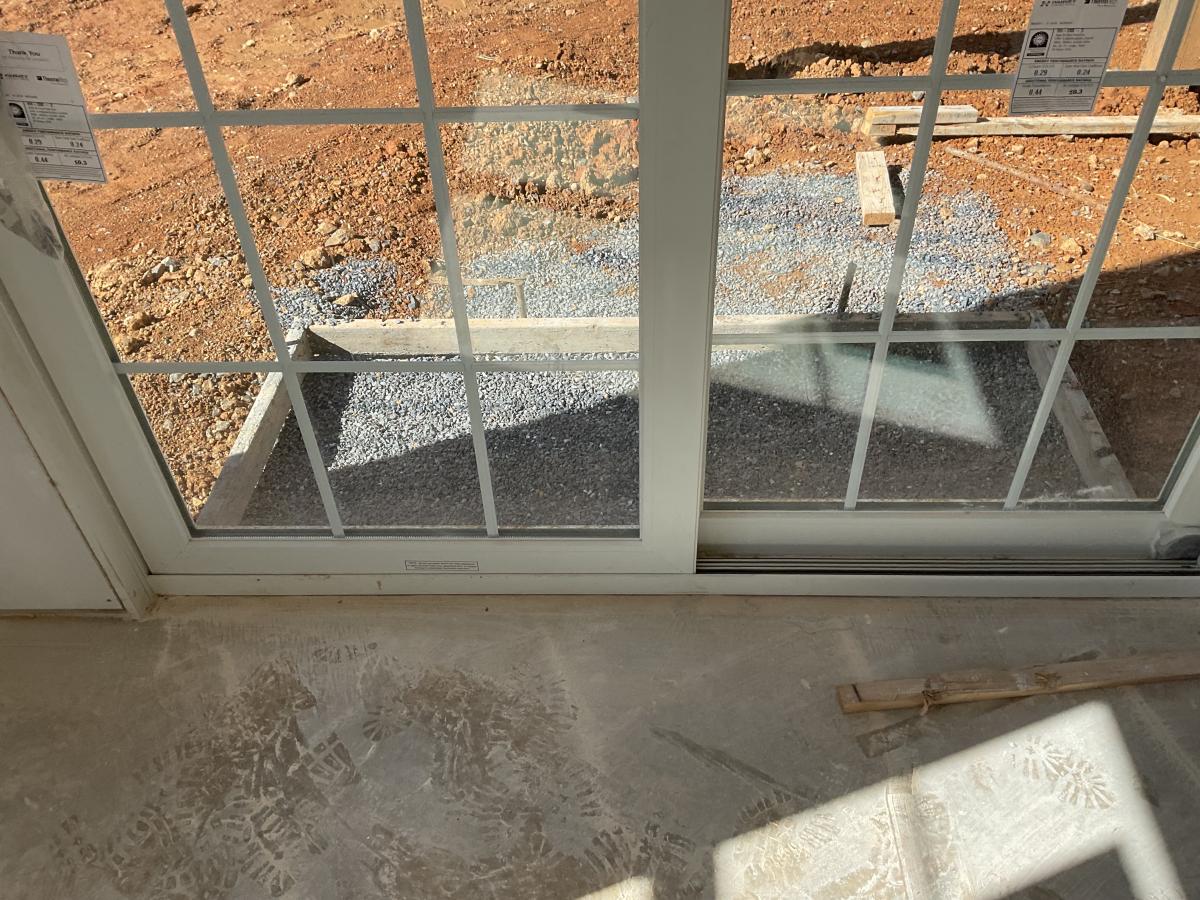

Deck (0) |
Expanded 10 x 18 |
|
Wed |
Aug 6 |
Gutters (0) |
|
|
Wed |
Aug 6 |
Driveway (0) * |
|
|
Wed |
Aug 6 |
Patio (0) |
Standard |
|
Wed |
Aug 6 |
Privacy Divider / Fence (0) |
|
|
Wed |
Aug 6 |
Sod / Seed / Landscaping (0) |
|
|
Wed |
Aug 6 |
HVAC Rough In (4) |
|
|
Tue |
Aug 12 |
Inspection (Rough In HVAC) (1) |
|
|
Wed |
Aug 13 |
Rough In Microwave Vent (0) |
|
|
Wed |
Aug 13 |
Plumbing Rough In (4) |
|
|
Tue |
Aug 19 |
Inspection (Rough In Plumbing) (1) |
|
|
Wed |
Aug 20 |
Electric Rough In (4) |
|
|
Tue |
Aug 26 |
Inspection (Rough In Electric) (1) |
|
|
Wed |
Aug 27 |
Inspection (Deck Piers) (0) |
|
|
Wed |
Aug 27 |
Inspection (Framing) (1) * |
|
|
Thu |
Aug 28 |

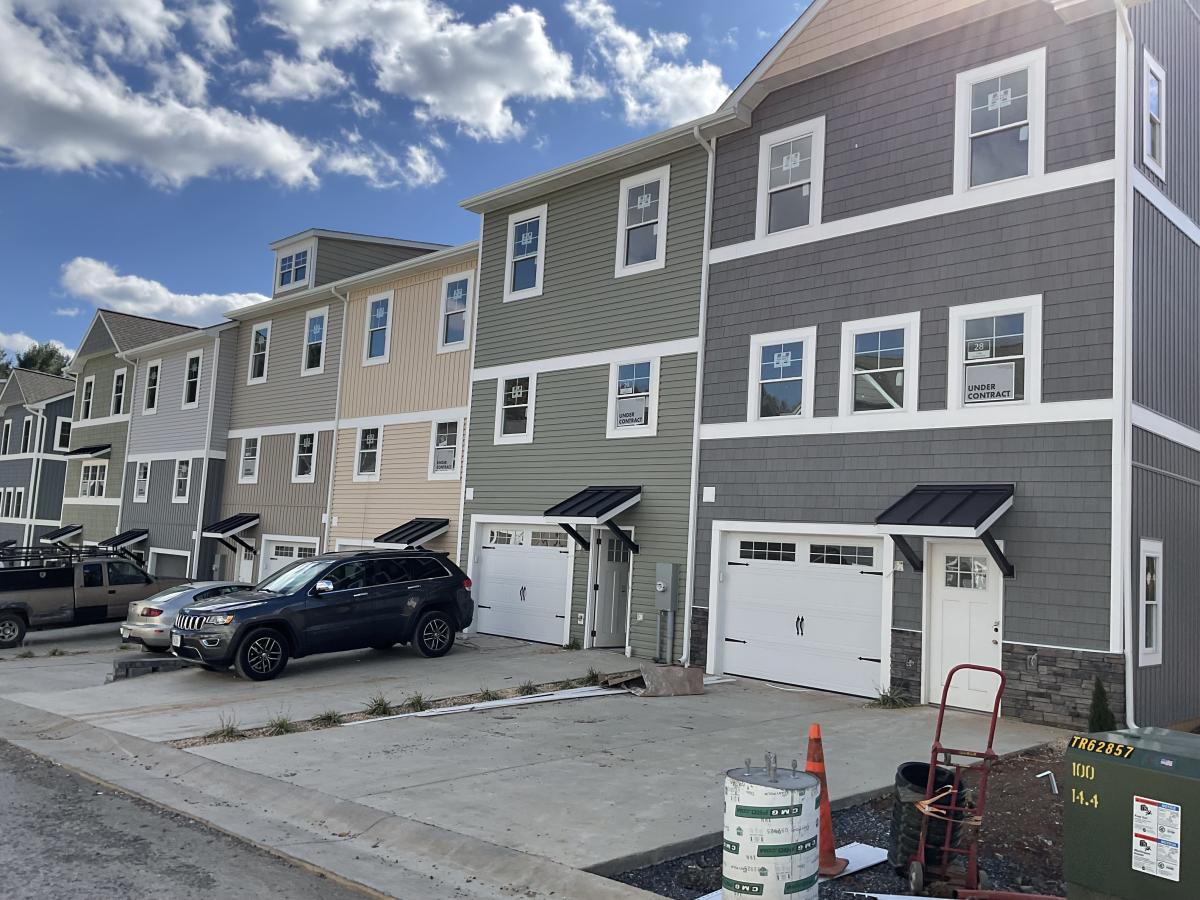

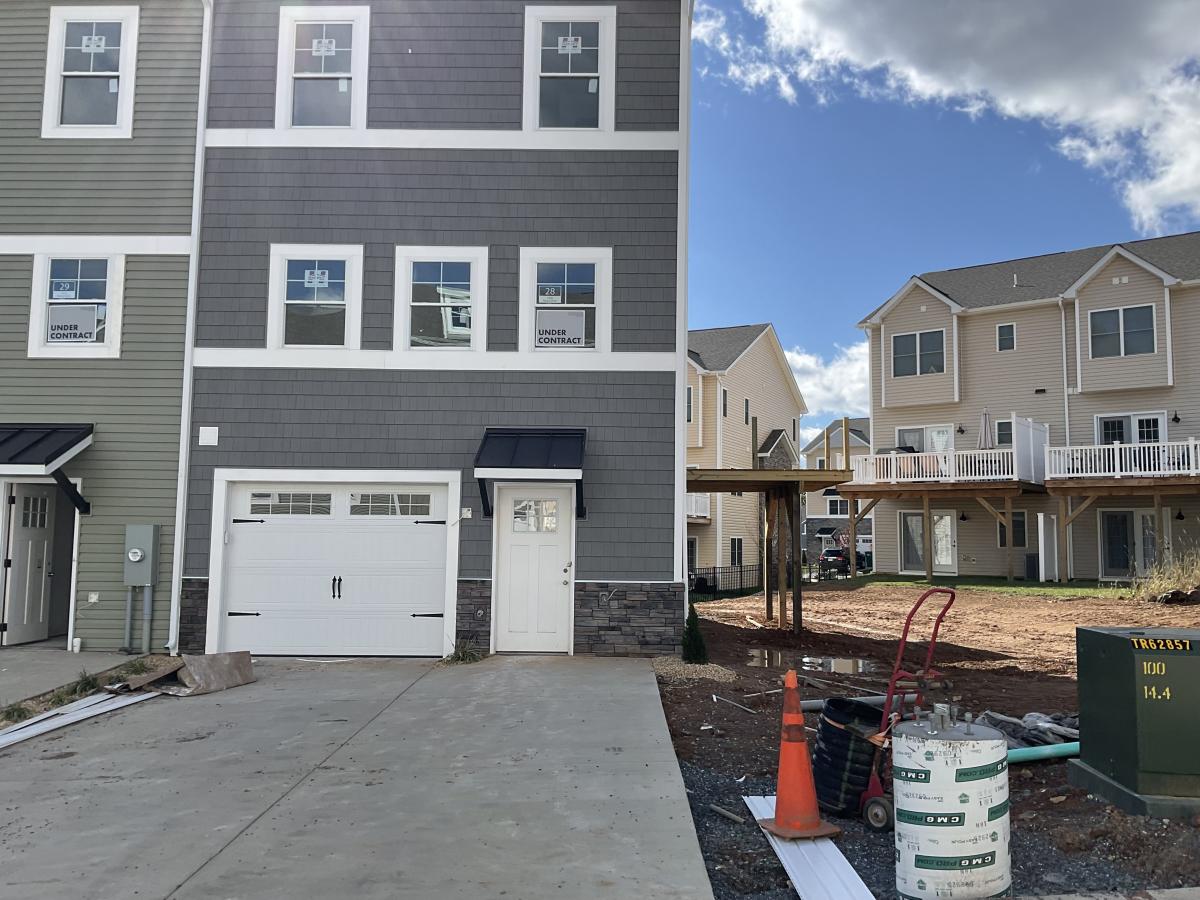

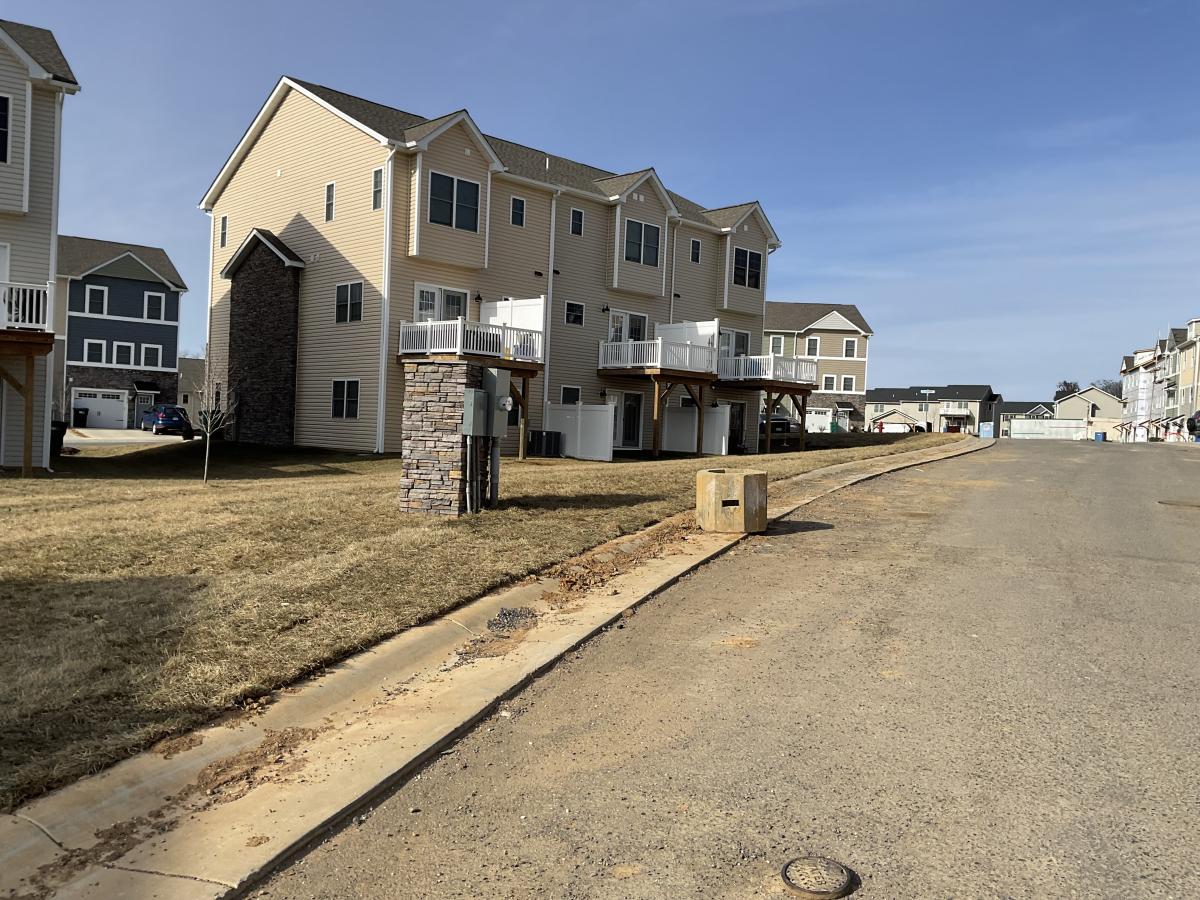

Exterior Vinyl (0) * |
|
|
Thu |
Aug 28 |

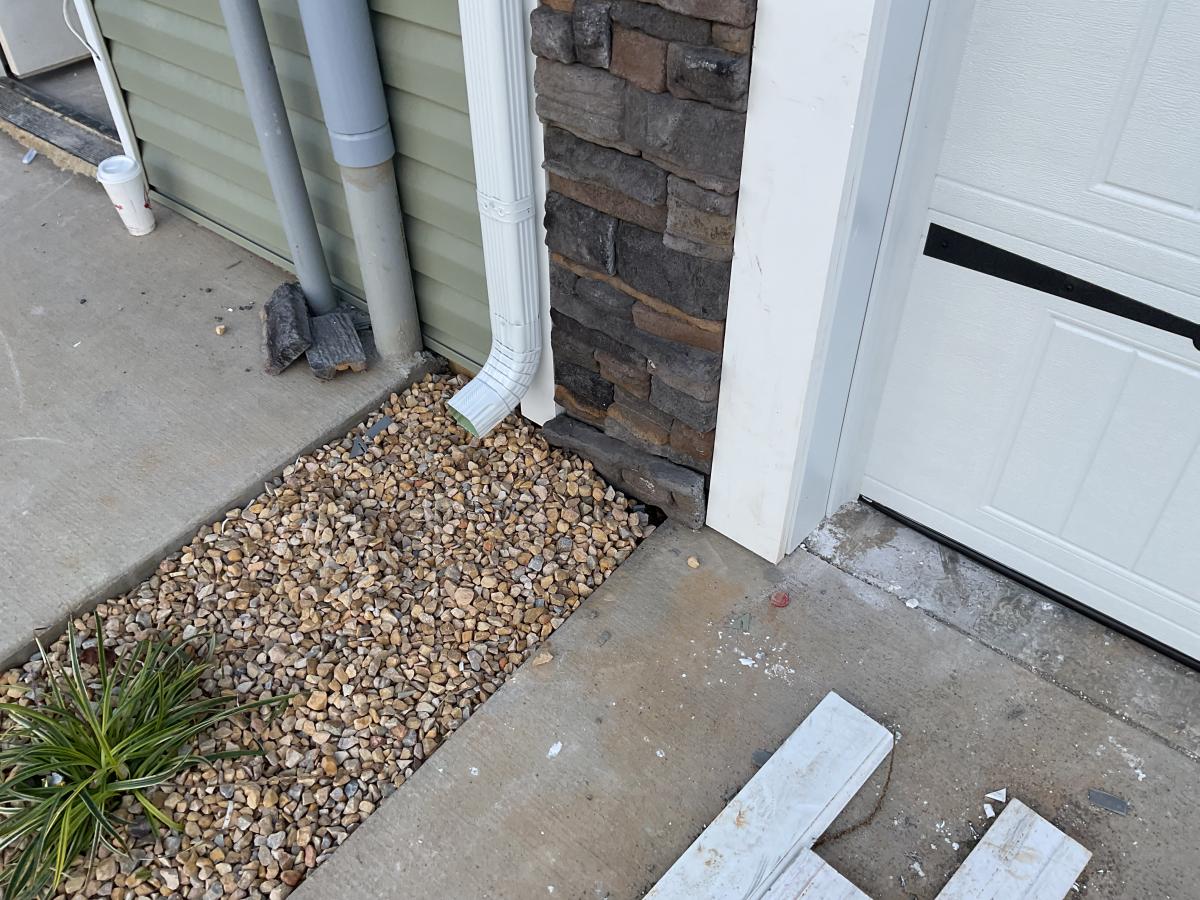

Exterior Stone (0) |
|
|
Thu |
Aug 28 |
Insulation (2) * |
|
|
Mon |
Sep 1 |
Inspection (Insulation) (1) |
|
|
Tue |
Sep 2 |
Inspection (Electric Service) (0) |
|
|
Tue |
Sep 2 |
Set Electric Meter (0) * |
|
|
Tue |
Sep 2 |
Inspection (Main Sewer Line) (0) |
|
|
Tue |
Sep 2 |
Inspection (Main Water Line) (0) |
|
|
Tue |
Sep 2 |
Order Interior Doors & Trim (0) |
|
|
Tue |
Sep 2 |

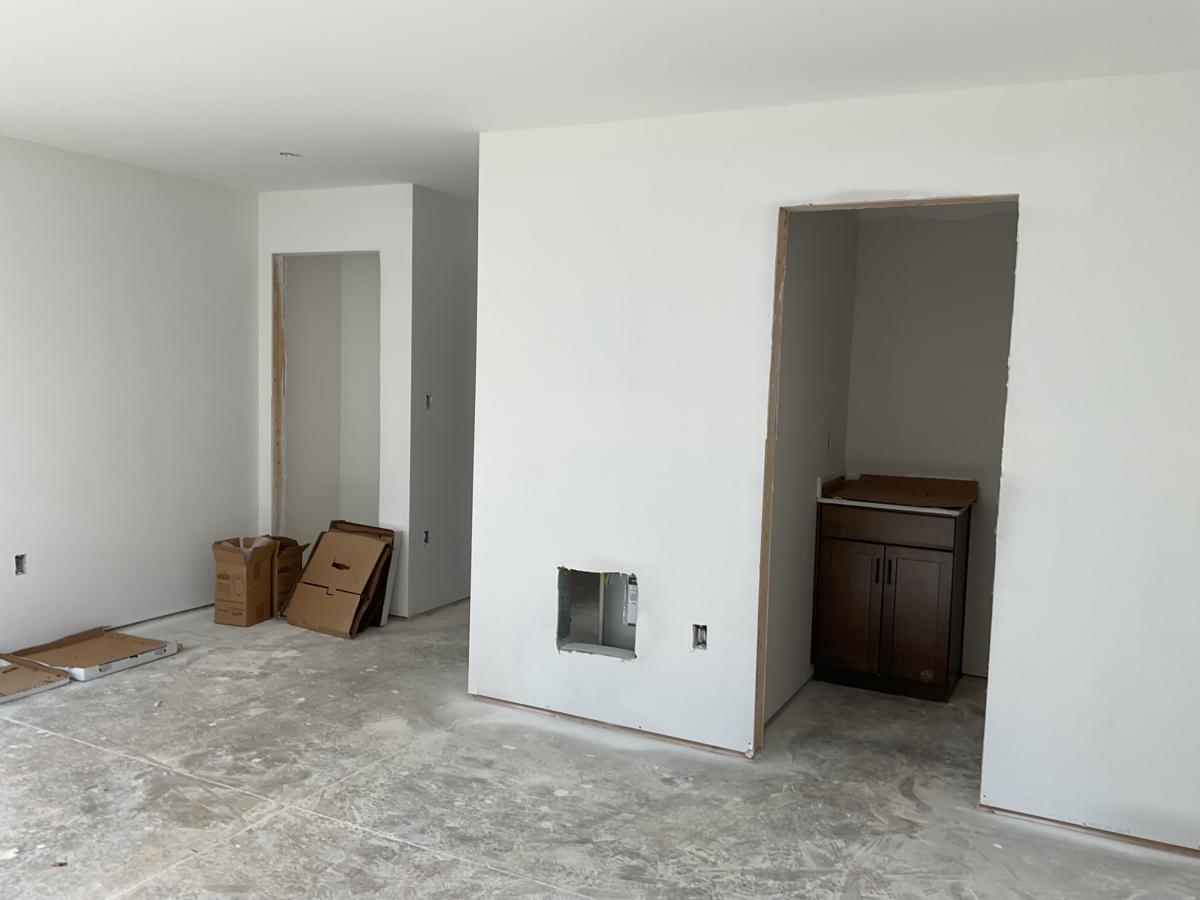

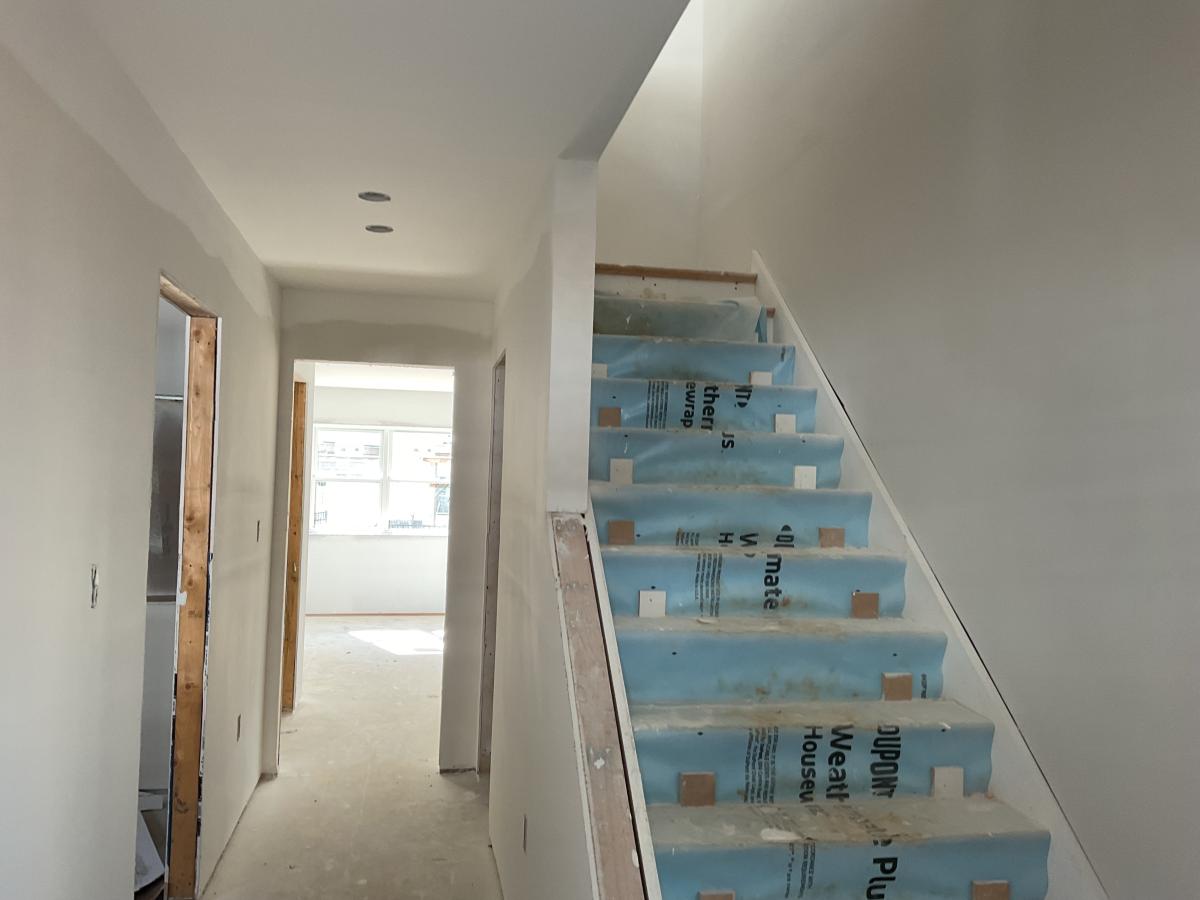

Drywall (Hang) (4) * |
|
|
Mon |
Sep 8 |
Loan Approval (0) |
JoDee @ United (97% Conventional) |
|
Mon |
Sep 8 |
Deed Preparation (0) |
|
|
Mon |
Sep 8 |

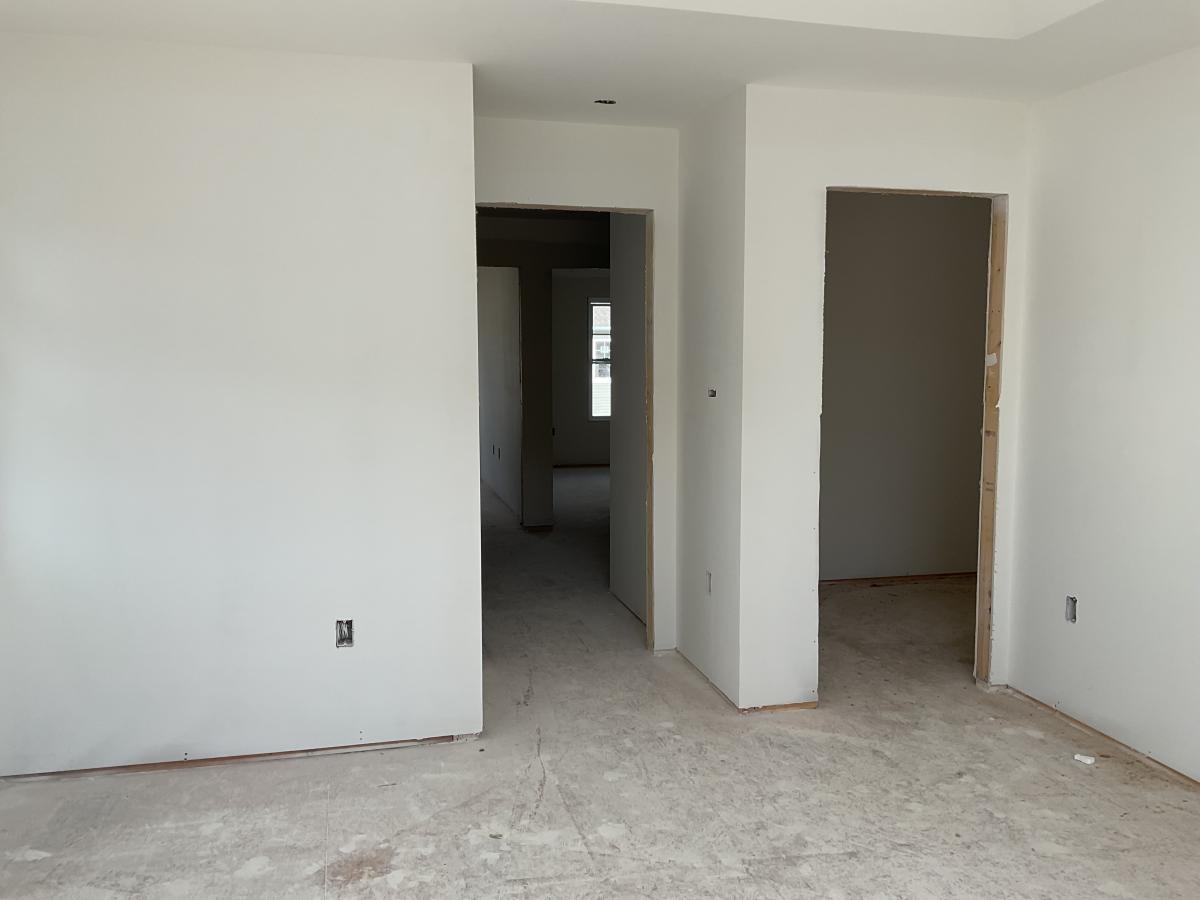

Drywall (Tape, Block, Skim, Sand) (6) * |
|
|
Tue |
Sep 16 |
Paint 1 (1) |
|
|
Wed |
Sep 17 |
Garage Door (0) * |
|
|
Wed |
Sep 17 |
House Numbers (0) |
|
|
Wed |
Sep 17 |
Mailbox (0) |
|
|
Wed |
Sep 17 |

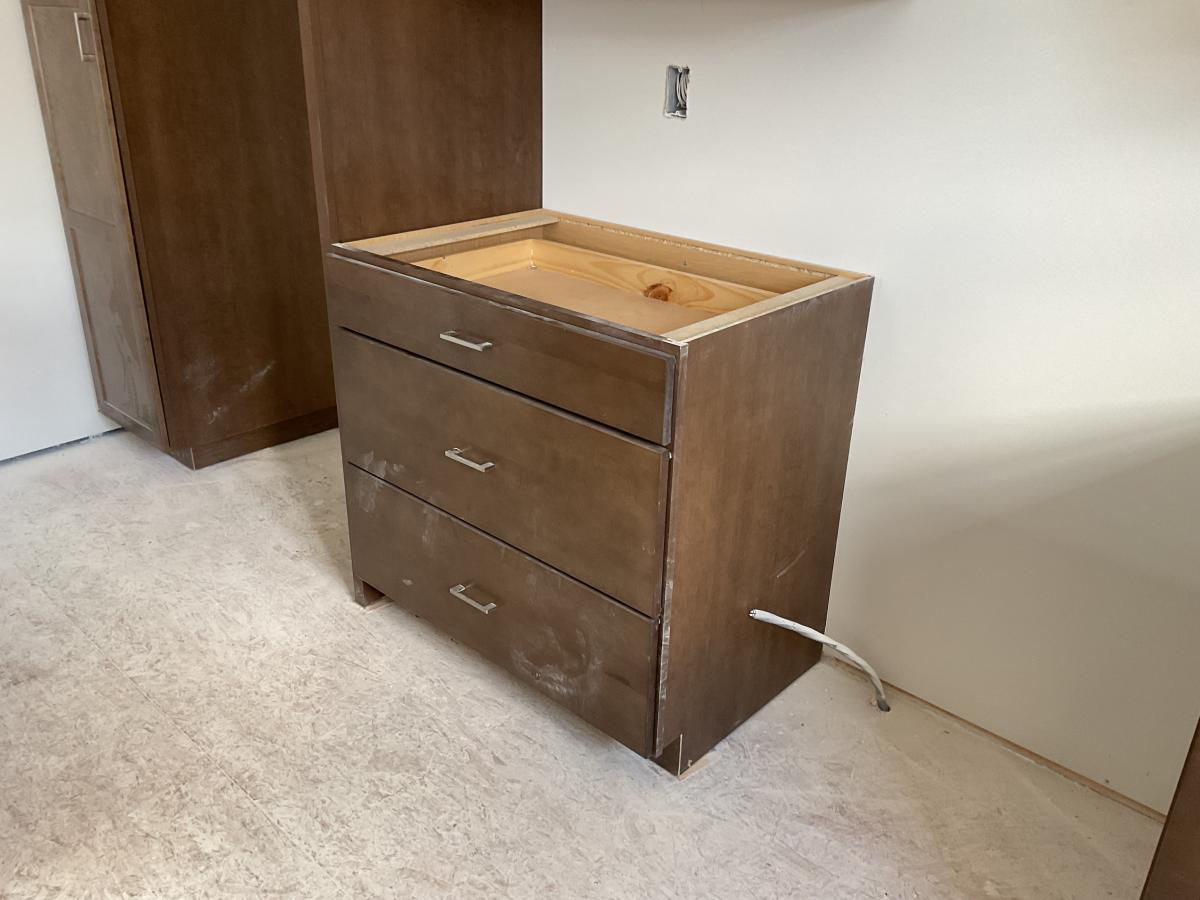

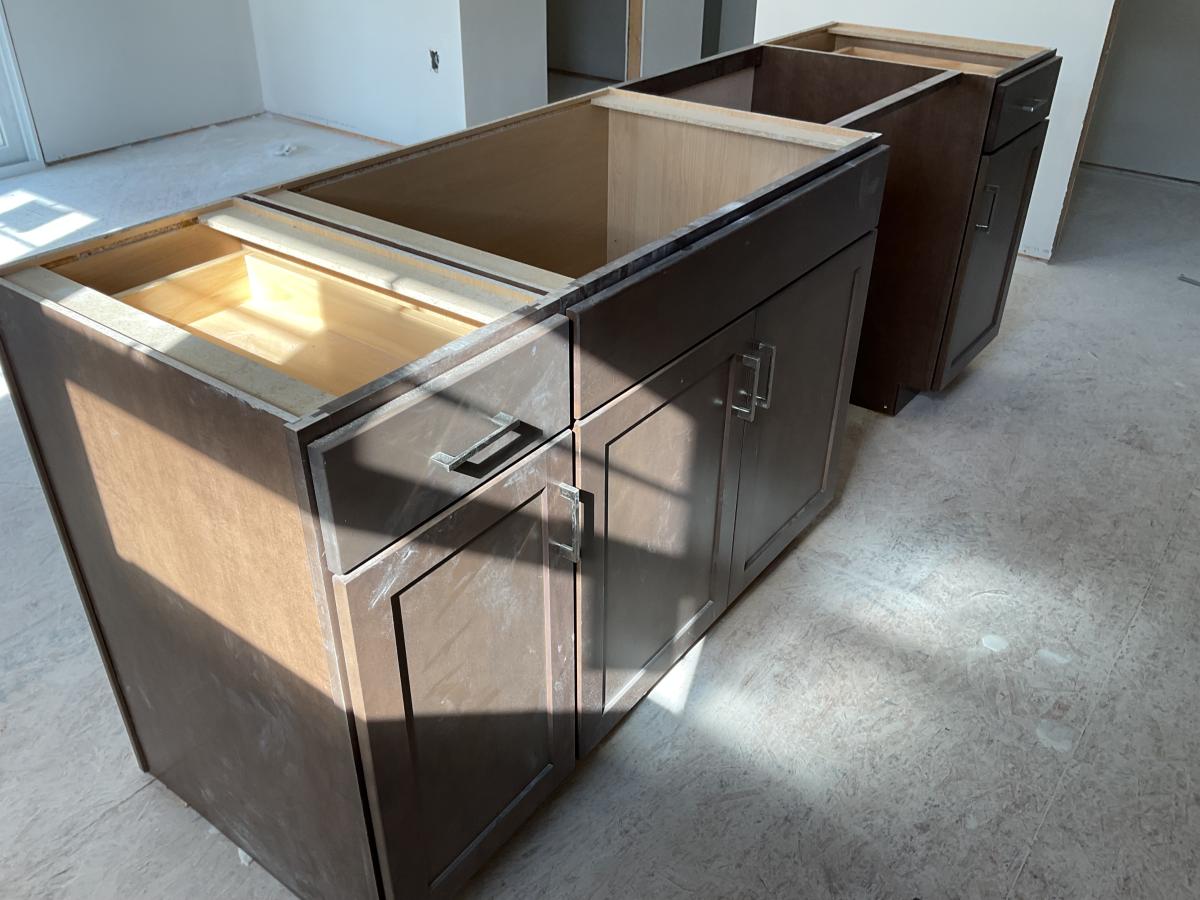

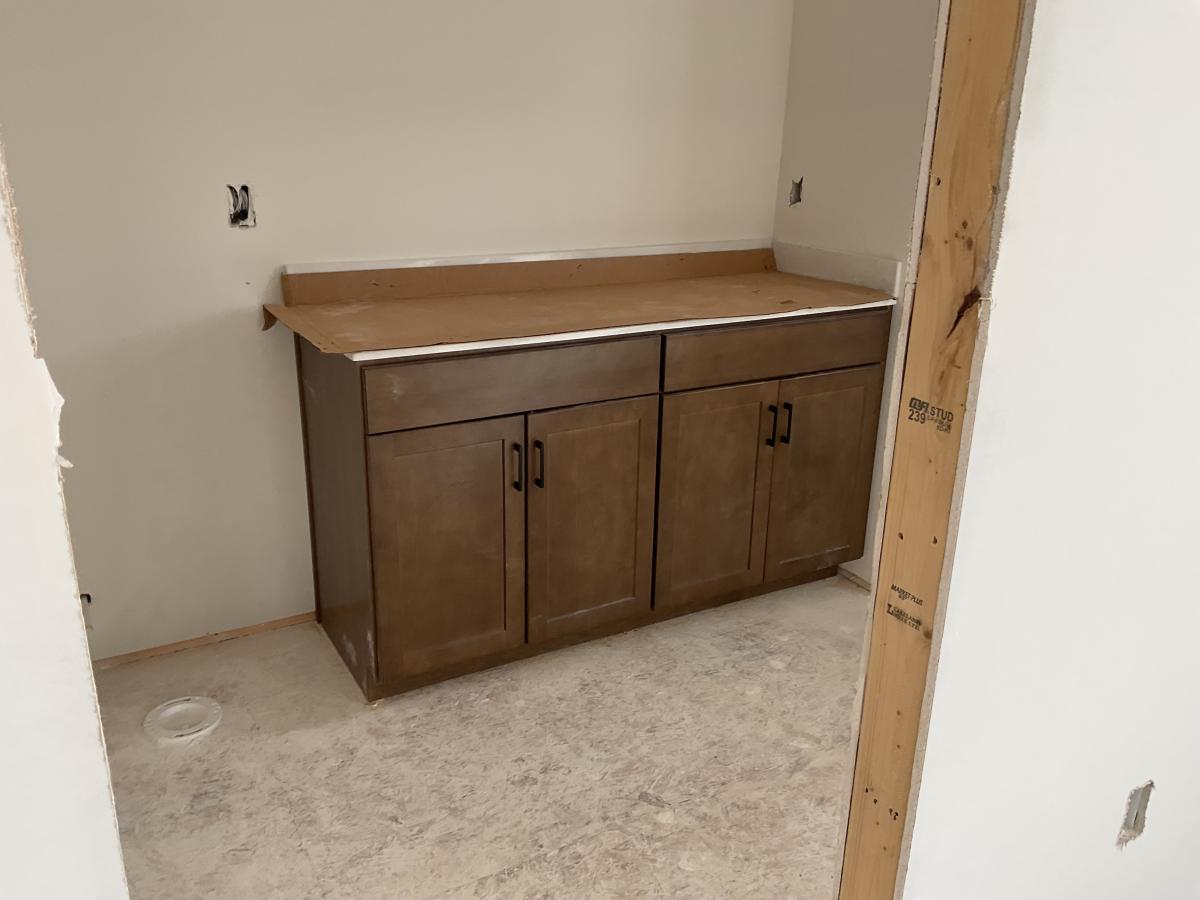

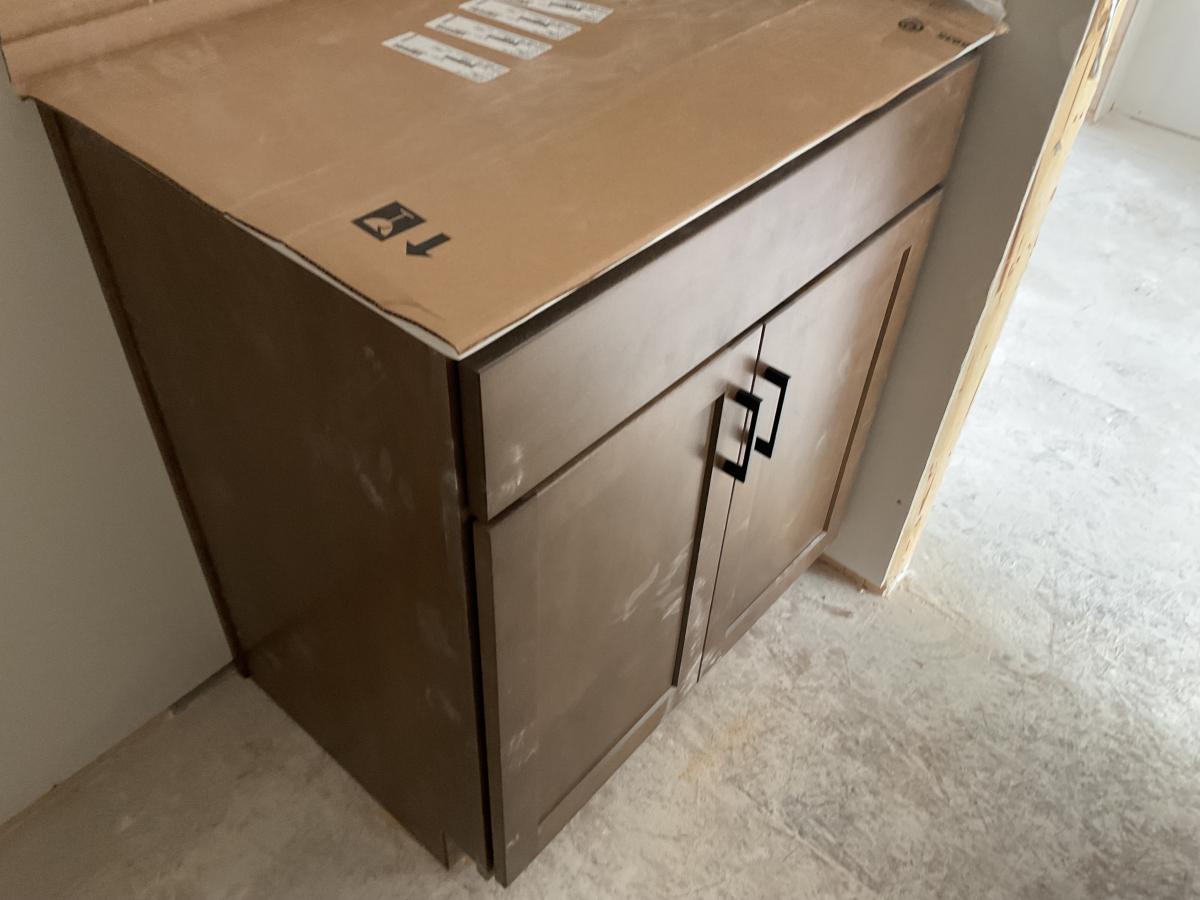

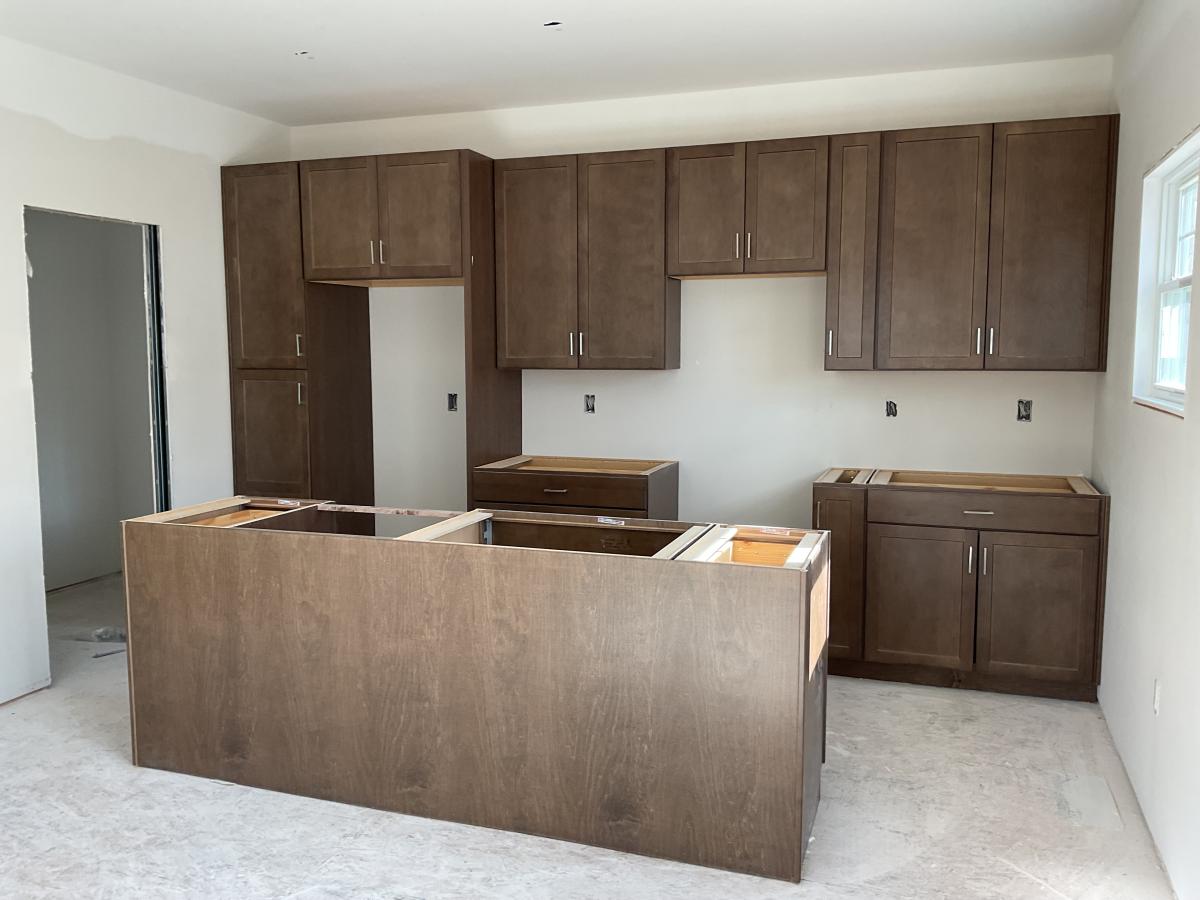

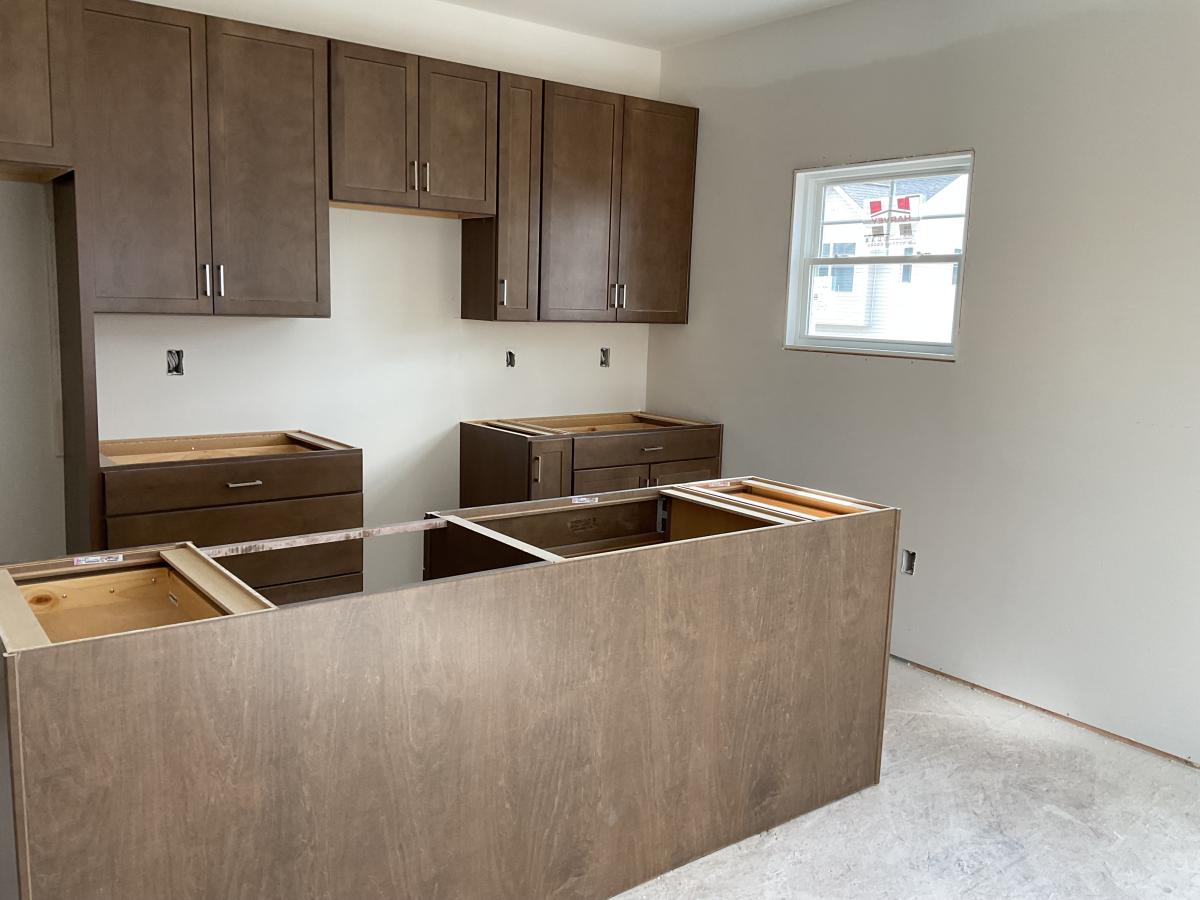

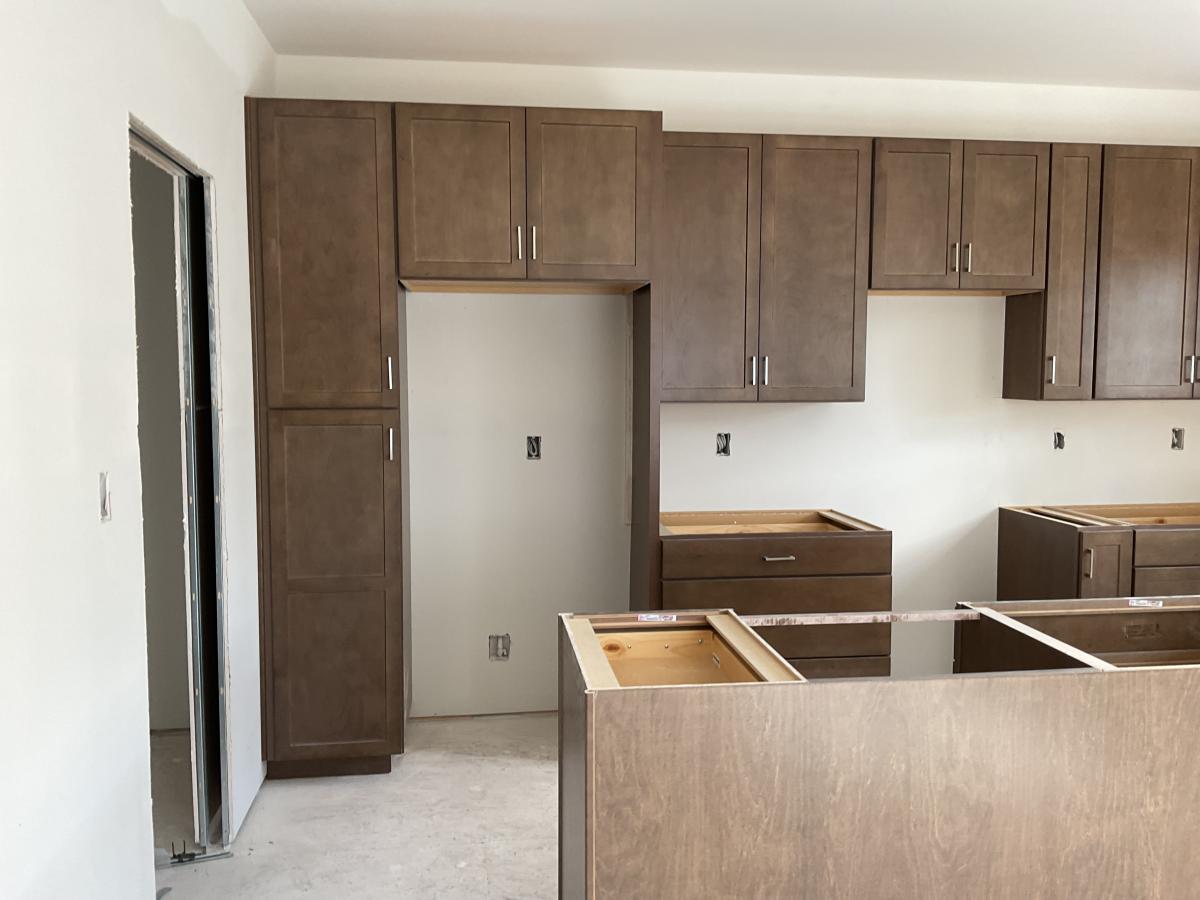

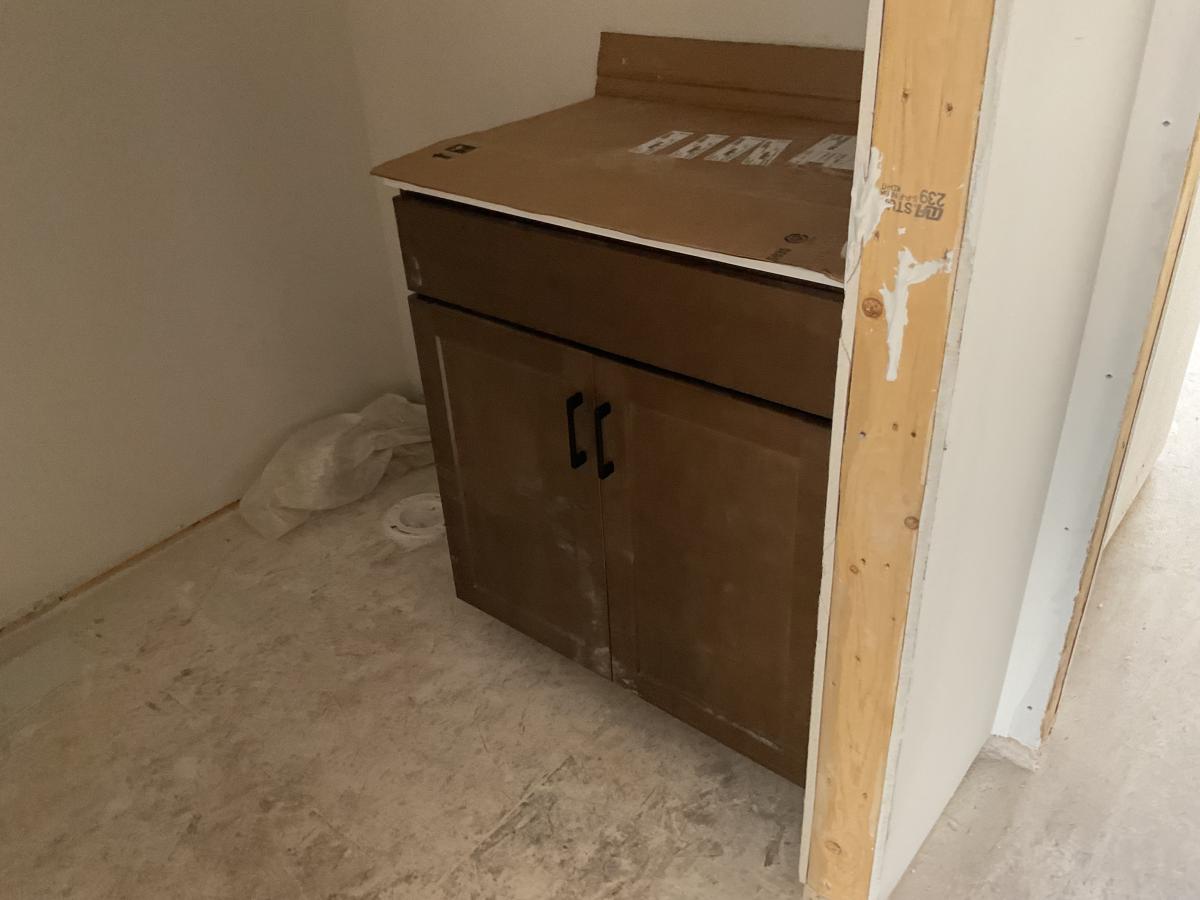

Cabinet Installation (2) * |
|
|
Fri |
Sep 19 |
Granite Installation (1) * |
|
|
Mon |
Sep 22 |
Interior Trim - Install (3) * |
|
|
Thu |
Sep 25 |
Order Plumbing / Lighting Fixtures (0) |
|
|
Thu |
Sep 25 |
Interior Trim - Paint (1) |
|
|
Fri |
Sep 26 |
Luxury Vinyl Plank (3) * |
|
|
Wed |
Oct 1 |
Luxury Vinyl Tile (0) |
|
|
Wed |
Oct 1 |
Paint 2 (3) |
|
|
Mon |
Oct 6 |
Cover Floors (1) |
|
|
Tue |
Oct 7 |
Deliver Plumbing / Lighting Fixtures (0) |
|
|
Tue |
Oct 7 |
Shoe Moulding (0) |
|
|
Tue |
Oct 7 |
Shelving, Door Knobs, Fire Extinguisher (0) * |
|
|
Tue |
Oct 7 |
Install Coded Lockbox (add extra keys) (0) |
|
|
Tue |
Oct 7 |
Pay Water / Sewer Taps (0) |
|
|
Tue |
Oct 7 |
Set Water Meter (0) * |
|
|
Tue |
Oct 7 |
Electric Trim Out (3) |
|
|
Fri |
Oct 10 |
Ceiling Fans (0) |
|
|
Fri |
Oct 10 |
HVAC Trim Out (1) |
|
|
Mon |
Oct 13 |
Blower Door Test (1) |
|
|
Tue |
Oct 14 |
Plumbing Trim Out (2) |
|
|
Thu |
Oct 16 |
Install Appliances (0) * |
|
|
Thu |
Oct 16 |
Paint 3 (2) * |
|
|
Mon |
Oct 20 |
Carpet (2) |
|
|
Wed |
Oct 22 |
Appraiser Confirms Construction Completion (0) |
|
|
Wed |
Oct 22 |
Inspection (Final HVAC) (1) |
|
|
Thu |
Oct 23 |
Inspection (Final Plumbing) (1) |
|
|
Fri |
Oct 24 |
Inspection (Final Electric) (1) |
|
|
Mon |
Oct 27 |
Inspection (Final Building) (2) * |
|
|
Wed |
Oct 29 |
Pre Walk Through (0) |
|
|
Wed |
Oct 29 |
Stain Hardwood Stairs (1) |
|
|
Thu |
Oct 30 |
Cleaning (1) |
|
|
Fri |
Oct 31 |
Certificate of Occupancy (1) * |
|
|
Mon |
Nov 3 |
C.O. to Lender (0) |
|
|
Mon |
Nov 3 |
Schedule Closing (0) |
|
|
Mon |
Nov 3 |
Buyer Walk Through (1) |
|
|
Tue |
Nov 4 |
Payment for Upgrades (0) |
|
|
Tue |
Nov 4 |
Keys to Settlement Agent (0) |
|
|
Tue |
Nov 4 |
Review Settlement Statement (0) |
|
|
Tue |
Nov 4 |
Jerry Signs Closing Documents (0) |
|
|
Tue |
Nov 4 |
Request Trash Tote From POA Manager (0) |
|
|
Tue |
Nov 4 |
Closing (1) |
|
|
Wed |
Nov 5 |
Remove Coded Lockbox (0) |
|
|
|
-- |
-- |
Ratified Contract? (0) 01.29.2025 |
|
|
|
|
Amendment to increase price by $22,260
|
|
-- |
-- |
$2500 Deposit Received (0) 04.29.2025 |
|
|
-- |
-- |
Association Packet Requested (0) 06.30.2025 |
|
|
-- |
-- |
Association Packet Received (0) 02.01.2025 |
|
|
-- |
-- |
Selections Meeting (0) 04.22.2025 |
|
|
-- |
-- |
Selections Sheet Signed (0) 04.29.2025 |
4/21: sent to Hemen |
|
-- |
-- |
Amendment for Upgrades (B,S,L,T,BCP) (0) 05.14.2025 |
4/29: sent to Ali |
|
-- |
-- |
Building Permit (30) 01.31.2025 |
|
|
-- |
-- |
Stake Out Home (1) 03.29.2025 |
|
|
-- |
-- |
Excavate (2) 03.29.2025 |
|
|
-- |
-- |
Inspection (Footers) (1) 04.07.2025 |
|
|
-- |
-- |
Inspection (Concrete Wall) (1) 06.05.2025 |
|
|
-- |
-- |
Pour Footers (1) * 04.07.2025 |
|
|
-- |
-- |
Set Forms (2) 05.15.2025 |
|
|
-- |
-- |
Pour Foundation Walls (1) 05.15.2025 |
|
|
-- |
-- |
Plumb Slab (2) 05.15.2025 |
|
|
-- |
-- |
Inspection (Plumbing Under Slab) (1) 06.05.2025 |
|
|
-- |
-- |
Inspection (Conduit Under Slab) (1) 06.05.2025 |
|
|
-- |
-- |
Prepare Slab (1) 06.05.2025 |
|
|
-- |
-- |
Inspection (Slab) (1) 06.05.2025 |
|
|
-- |
-- |

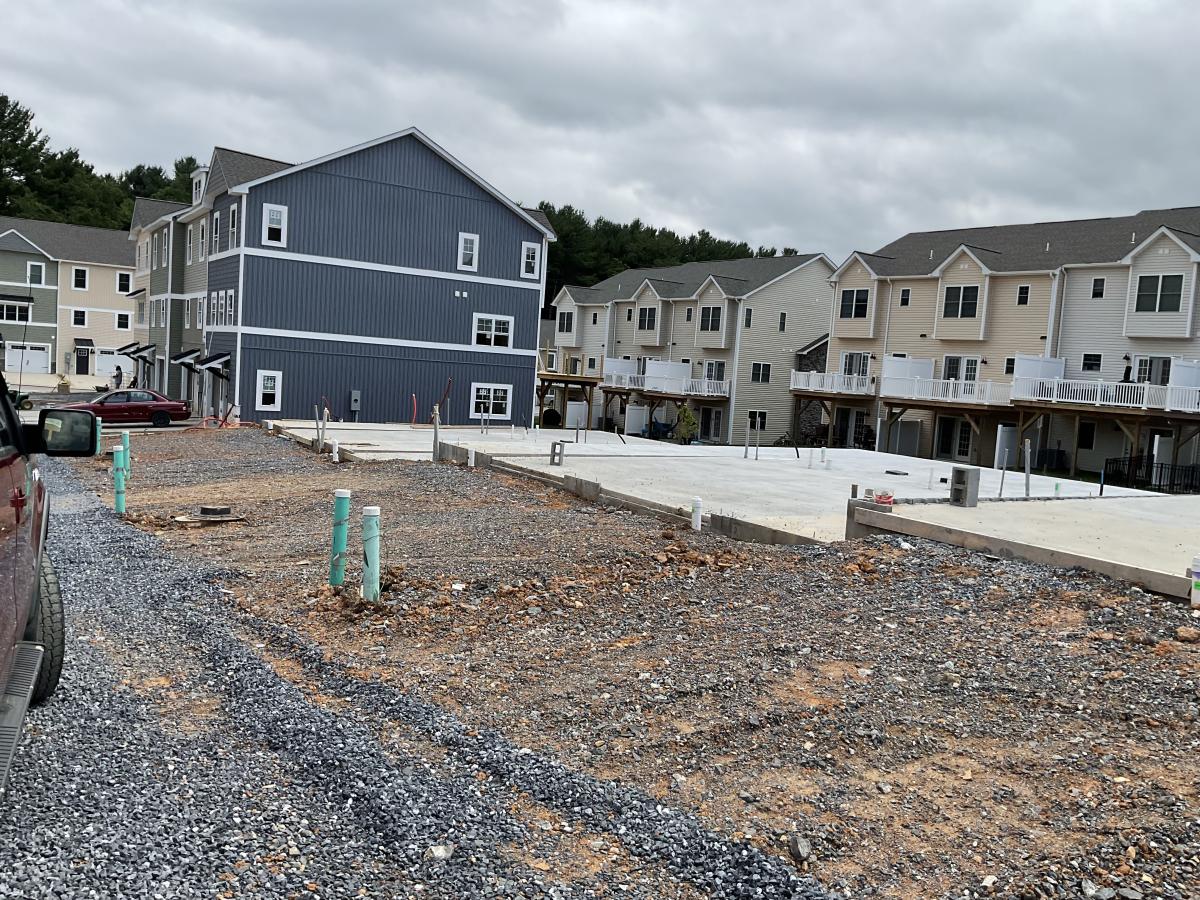

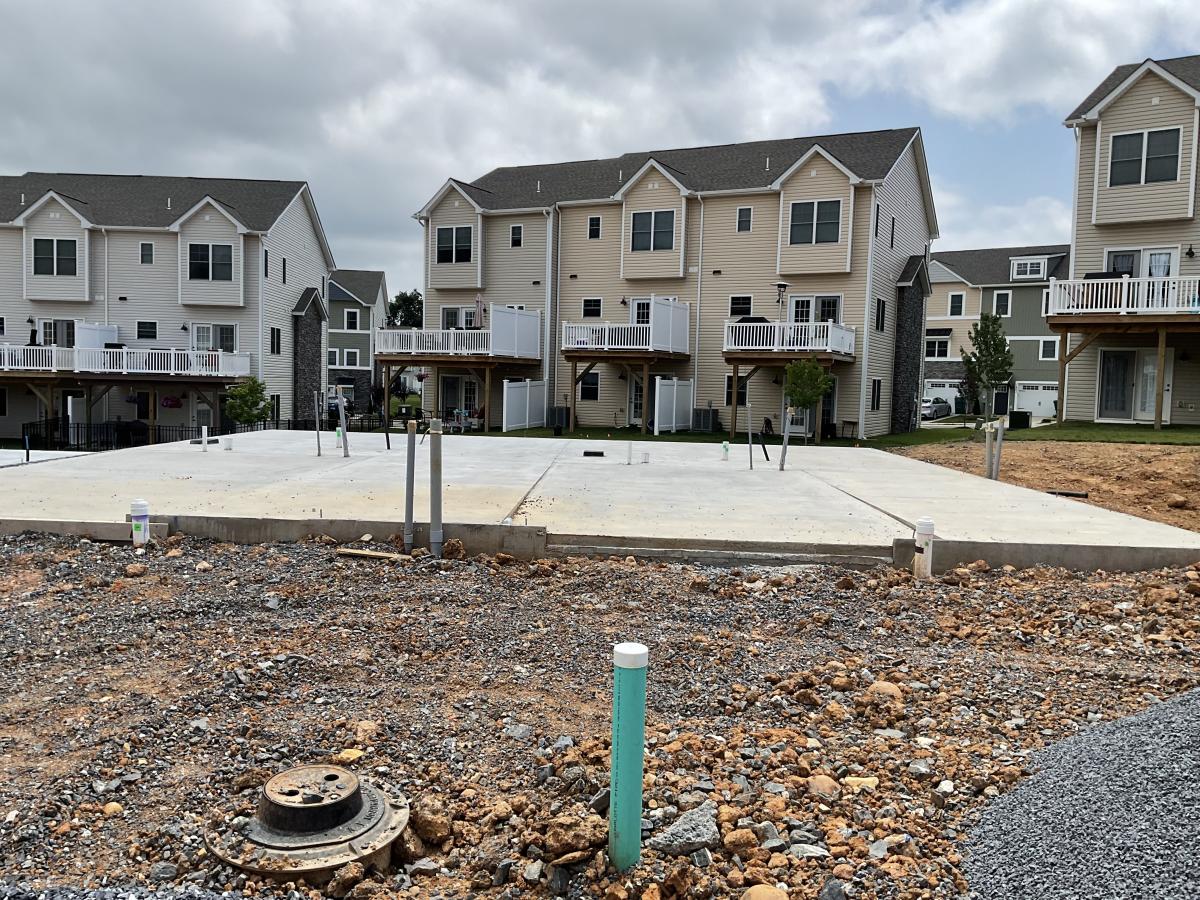

Pour Slab (1) * 06.05.2025 |
|
|
-- |
-- |
Settlement Agent Confirmed (0) 05.16.2025 |
5/13: sent to Brittany |
|
