CONGERS-3 - 13  ::  1381 Derby Drive
[ BUILD: 20250705 ]
CRITICAL PATH   |   INSPECTIONS   |   FLOOR PLANS   |   SELECTIONS   |   SPECS   |   CHANGES   |   NHS

Friday (Oct 31)    show all photos

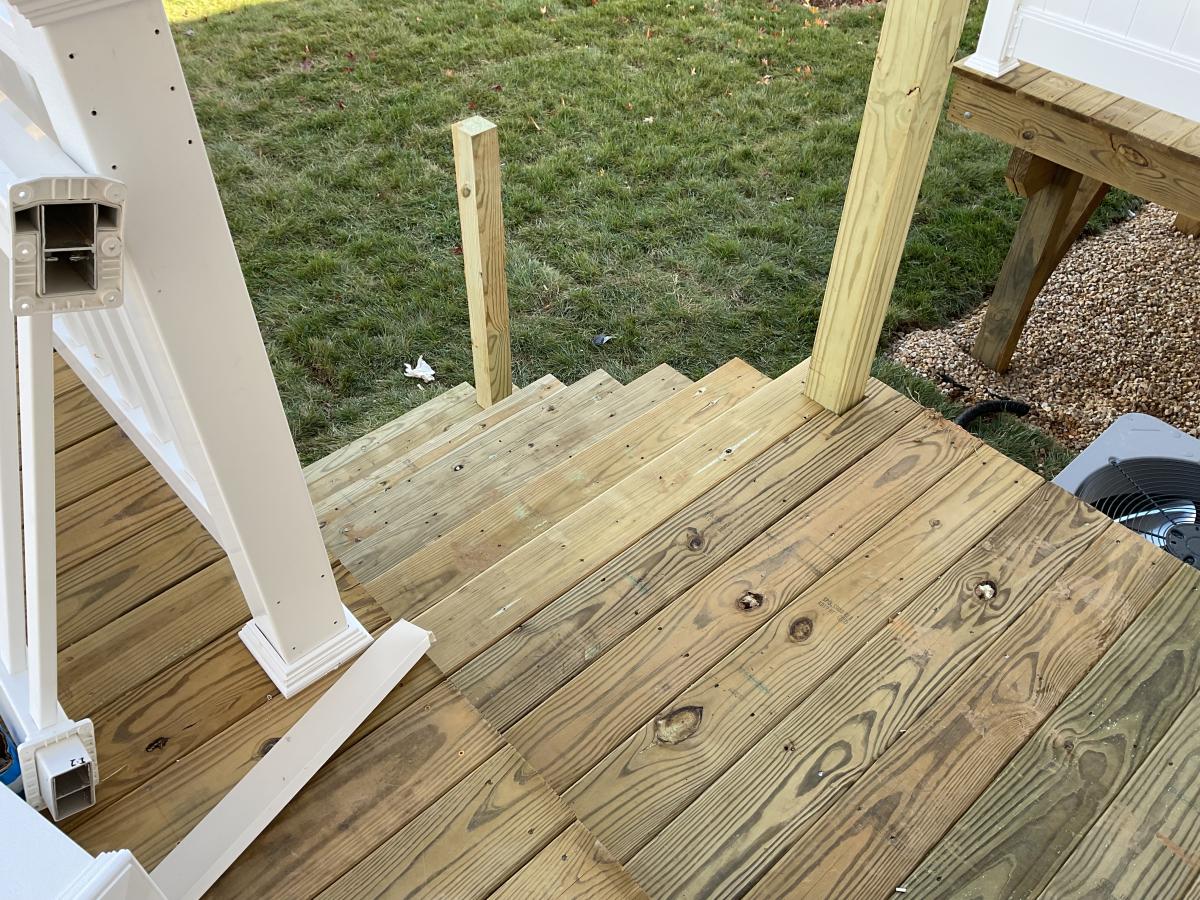

--   --   It does not look like steps are going to be built on the side of the deck Tom. In process 10/29. Needs railings.
--   --   Prefers to close in early December

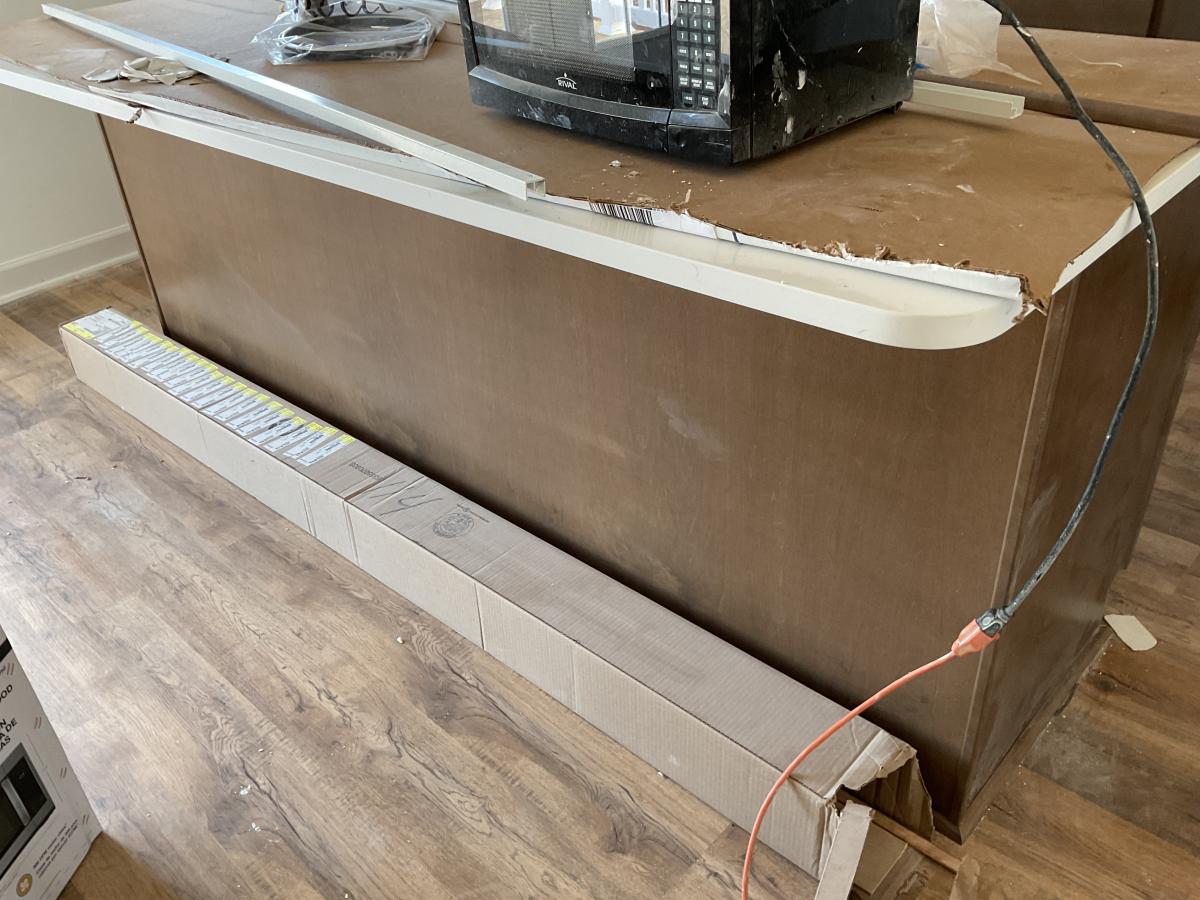

--   --   Replace back of kitchen island Fred
--   --   Trim is going to be needed around the farmhouse sink Arid

--   --   Cover carpet area

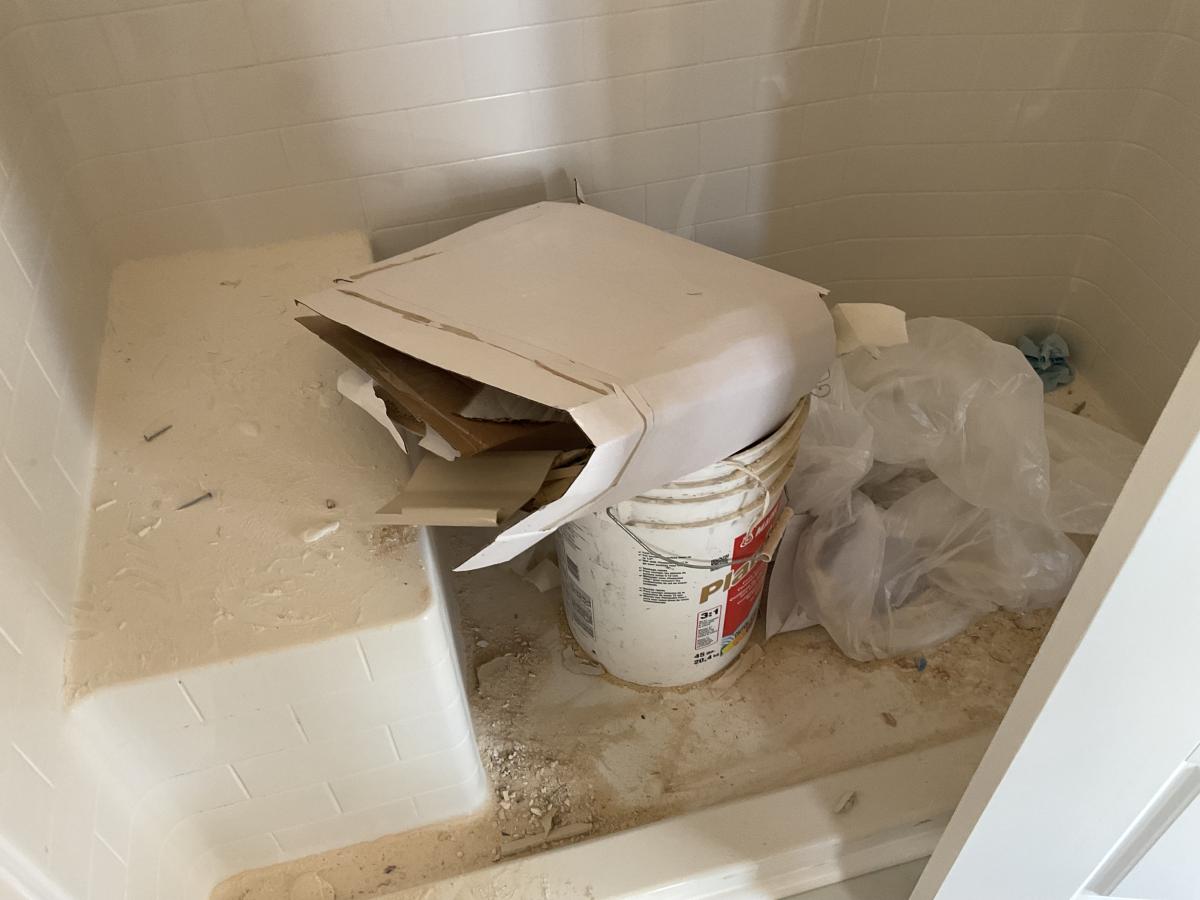

--   --   Shower is full of nails and trash. Can we tell subs to not do this to avoid damage?
    Added Ceiling Fan in Living Room
    Heavy Glass Shower Door with black trim
Sun    Nov 2      Sod / Seed / Landscaping (0)
Sun    Nov 2      Loan Approval (0)  03.27.2025     JoDee @ United (80% Conventional)
Sun    Nov 2      Garage Door (0)
Sun    Nov 2      House Numbers (0)
Sun    Nov 2      Mailbox (0)
Sun    Nov 2      Cover Floors (1)
Mon    Nov 3      Shelving, Door Knobs, Fire Extinguisher (0) *
Mon    Nov 3      Install Coded Lockbox (add extra keys) (0)
Mon    Nov 3      Electric Trim Out (3) *        In process 10/31
Thu    Nov 6      Ceiling Fans (0)
Thu    Nov 6      HVAC Trim Out (1) *
Fri    Nov 7      Blower Door Test (1)

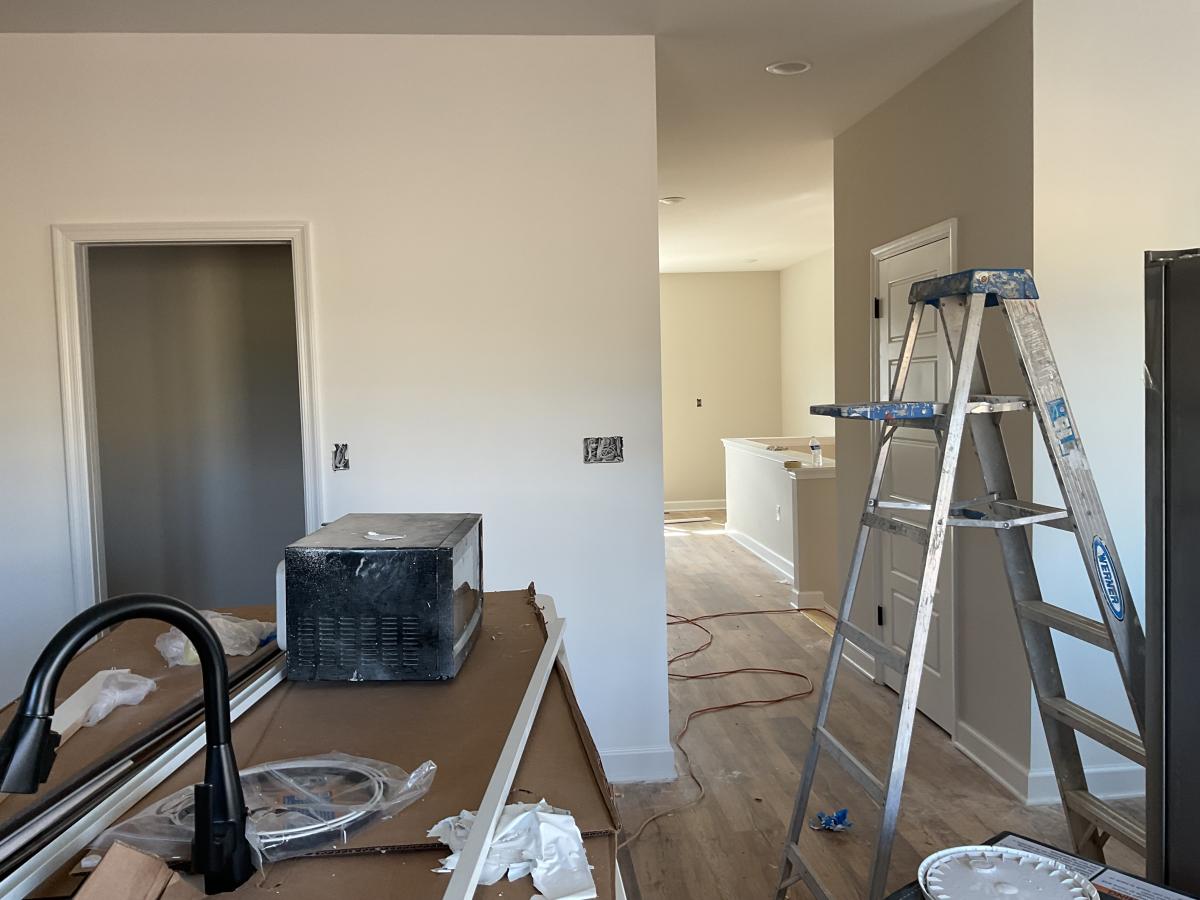

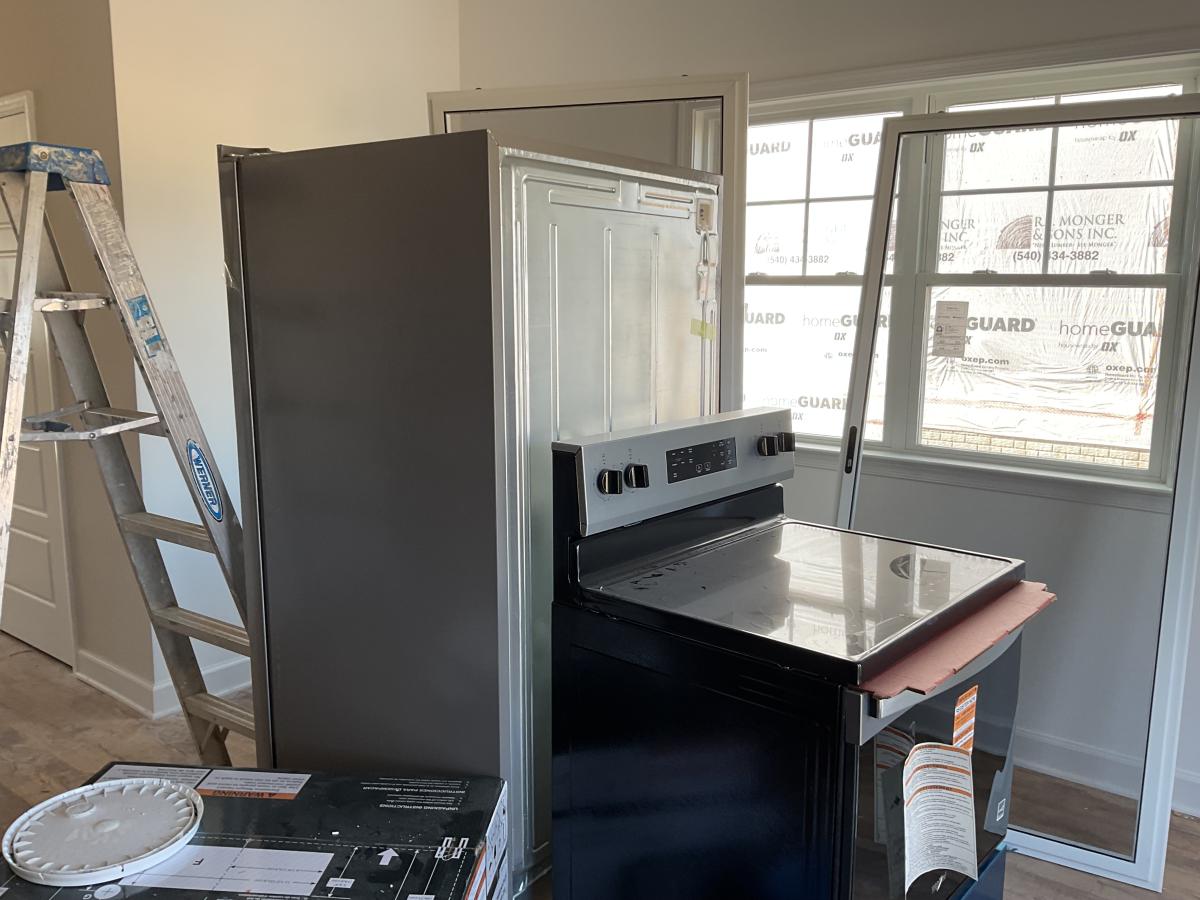

Mon    Nov 10      Install Appliances (0) *        Standard 9/10. On site not installed 10/29
Mon    Nov 10      Appraiser Confirms Construction Completion (0)
Mon    Nov 10      Inspection (Final HVAC) (1)
Tue    Nov 11      Inspection (Final Plumbing) (1)
Wed    Nov 12      Inspection (Final Electric) (1)
Thu    Nov 13      Inspection (Final Building) (2) *
Mon    Nov 17      Pre Walk Through (0)

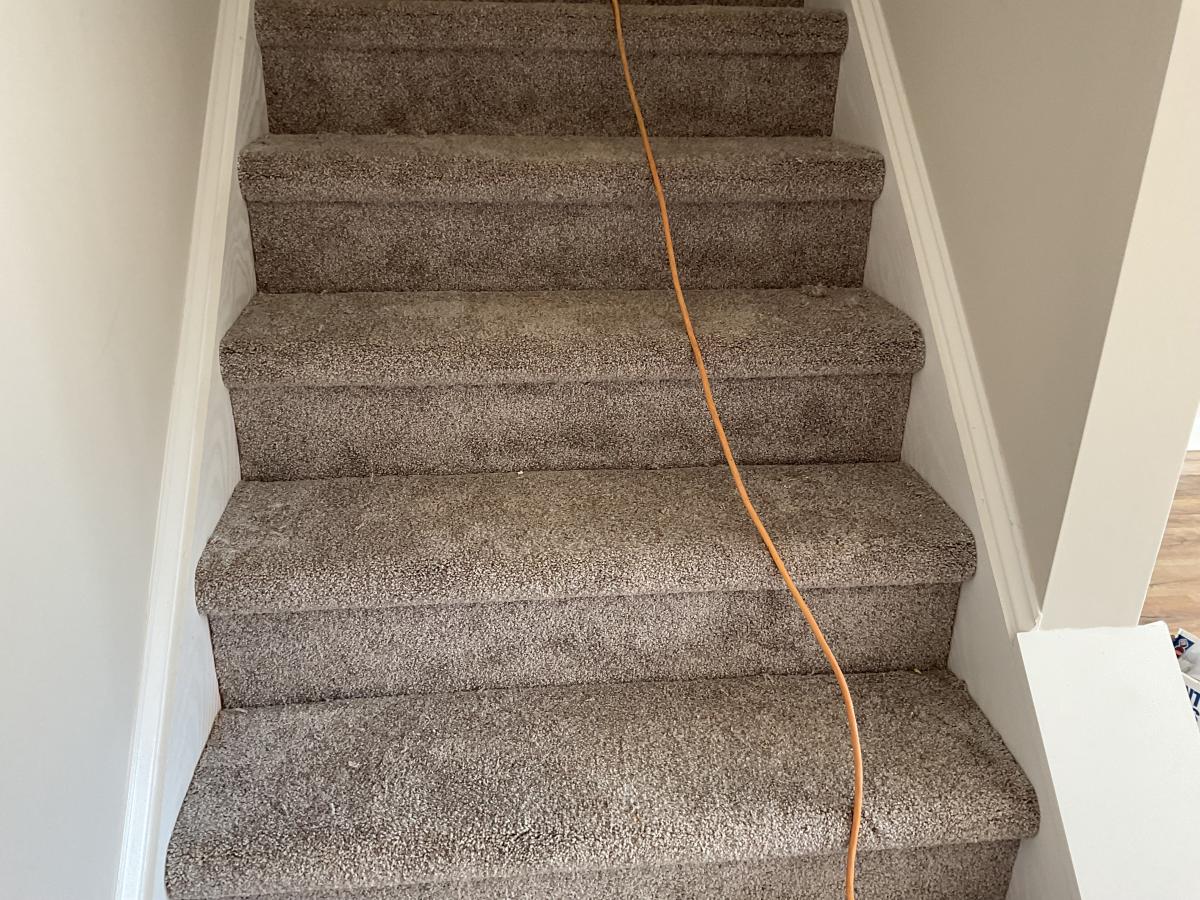

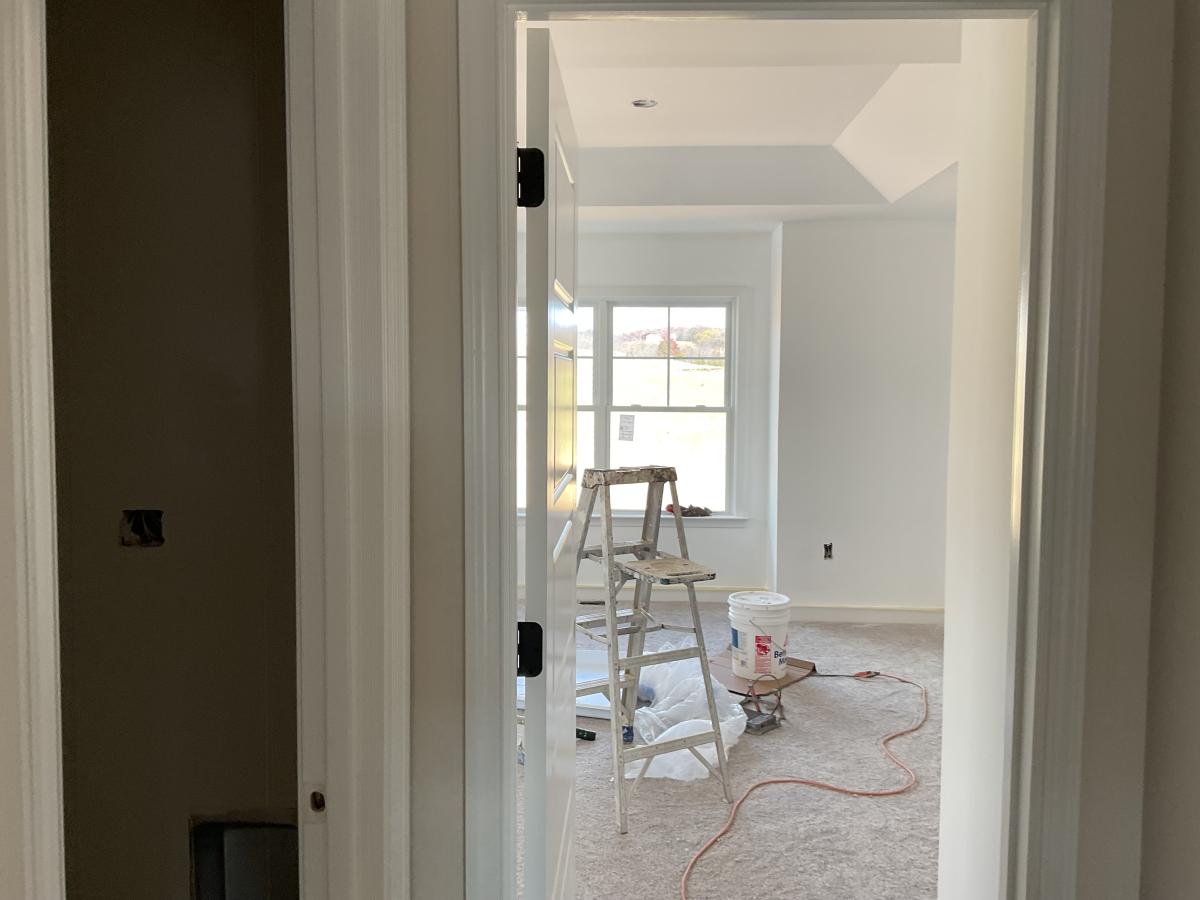

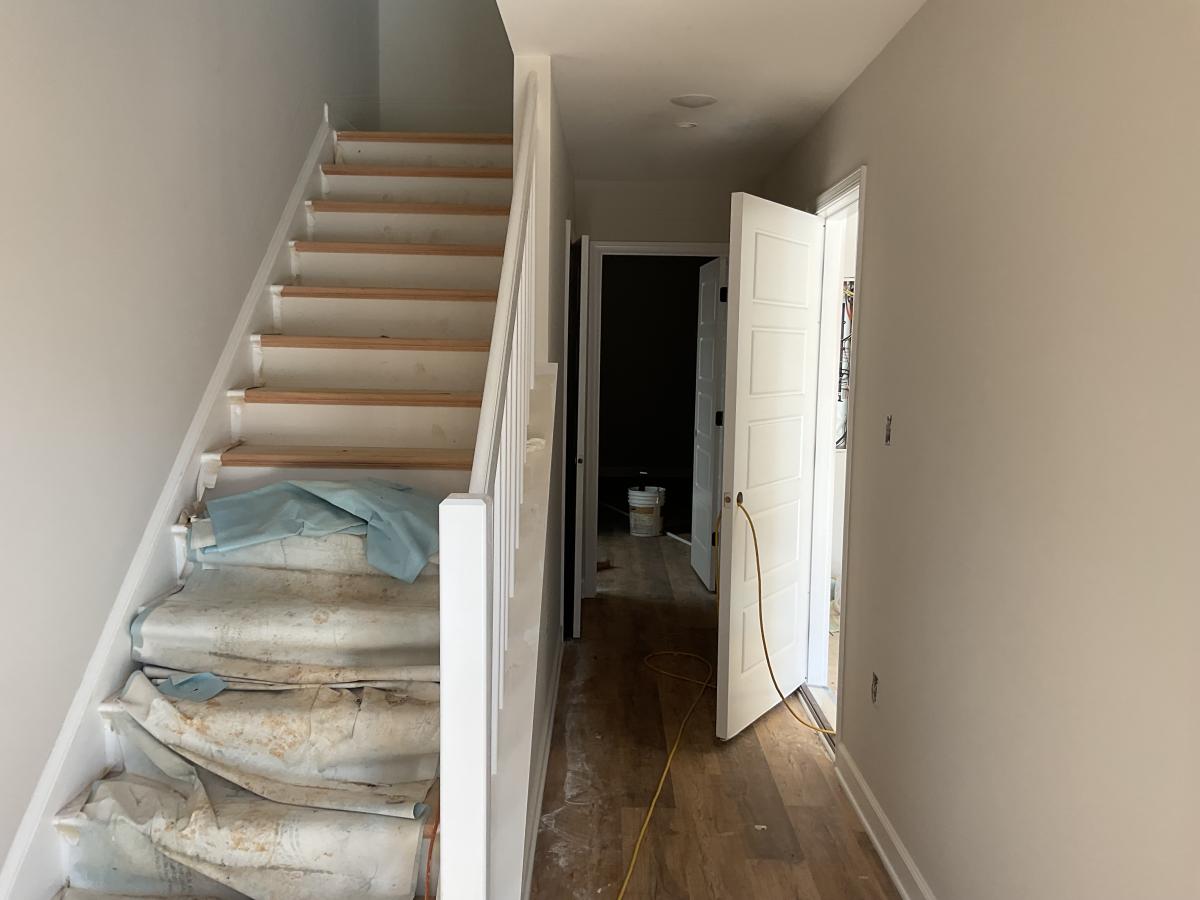

Mon    Nov 17      Stain Hardwood Stairs (1) *
Tue    Nov 18      Cleaning (1)
Wed    Nov 19      Certificate of Occupancy (1) *
Thu    Nov 20      C.O. to Lender (0)
Thu    Nov 20      Schedule Closing (0)
Thu    Nov 20      Buyer Walk Through (1) *
Fri    Nov 21      Payment for Upgrades (0)
Fri    Nov 21      Keys to Settlement Agent (0)
Fri    Nov 21      Review Settlement Statement (0)
Fri    Nov 21      Jerry Signs Closing Documents (0)
Fri    Nov 21      Request Trash Tote From POA Manager (0)
Fri    Nov 21      Closing (1)       Brittany @ West View Title
Mon    Nov 24      Remove Coded Lockbox (0)
--   --   Tom - egress window possible?
--   --   Tom - steps to yard possible?
--   --   Pre drywall inspection
--   --   Closet in bonus room? yes
--   --   Needs bonus room window
--   --   Closet needs to be framed before drywall comes in
--   --   Pre-drywall adjustments
--   --   Insulation needed in primary bathroom near closet. I have marked with blue tape.
--   --   Insulation needed in doorway to primary bathroom
--   --   Insulation needed at backyard bump out

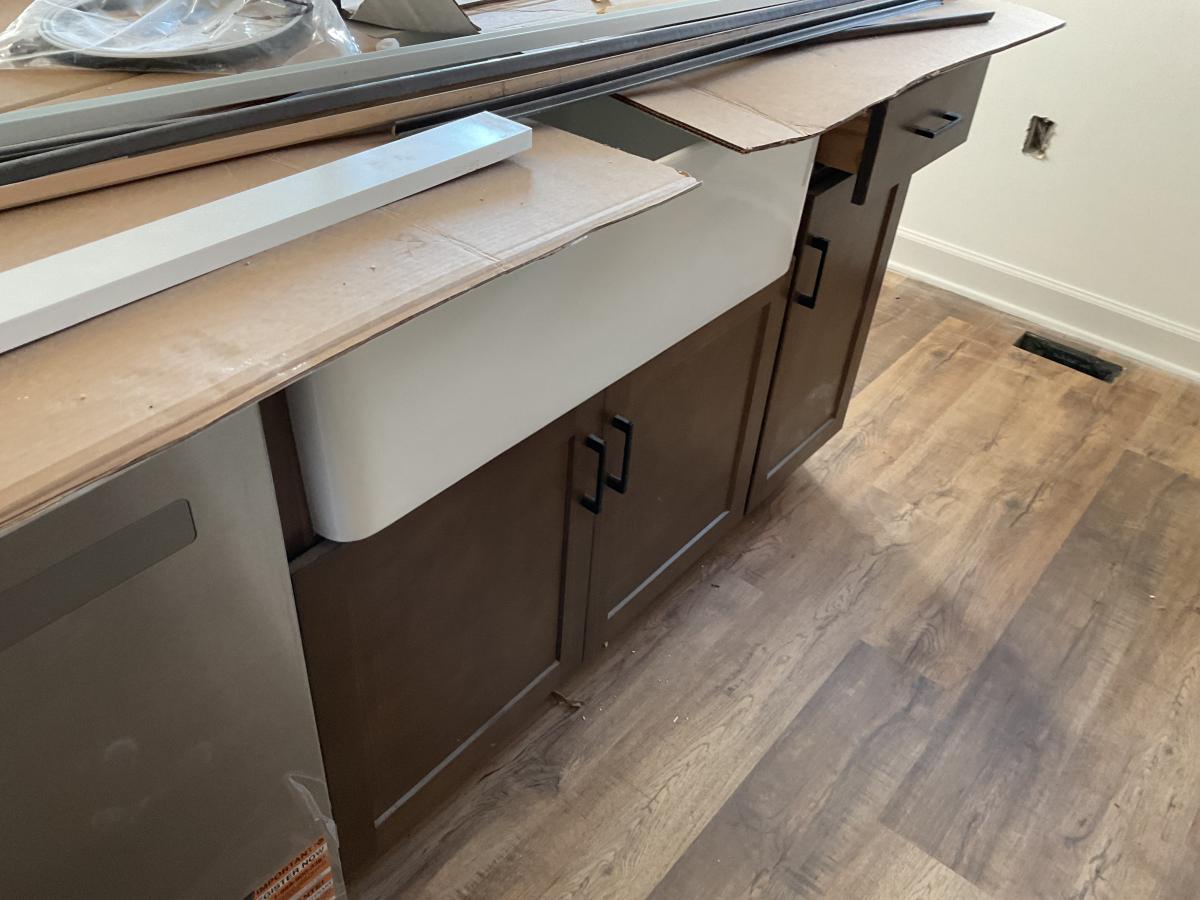

--   --   The farm sink is on the back deck
--   --   Drywall needed at closet on main level framing issue Drywaller
--   --   The back panel of the kitchen island looks blemished, perhaps it’s not though
--   --   The front panel of the primary bathroom vanity also looks a bit odd
--   --   The framing and the bonus room window. It seems a bit off, but I’m not sure that there’s anything that can really be done to fix it.
--   --   Few pieces of quarts are still needed for the kitchen Side splash - Fenco
--   --   Cupboard carpet
--   --   Cover carpet
-- -- Ratified Contract? (0)  02.15.2025
    Finished Bonus Room
    Egress Window in Bonus Room
    Steps from deck to yard (platform and seven steps)
    Level 0 Quartz Countertops Carrara Trigato
    Cabinet Crown Moulding
    Farmhouse Sink- white
    Upgraded Gardenia Tile in Master/Hall baths and Laundry Room
    Upgraded Carpet Pad in all carpeted areas
    Modern White Acrylic shower with imprinted tile
    Expanded Driveway
    Luxury Vinyl Plank in Bonus Room
    Amendment to increase price by $20,475
-- -- $2500 Deposit Received (0)  02.17.2025
-- -- Association Packet Requested (0)  06.30.2025
-- -- Association Packet Received (0)  02.21.2025
-- -- Selections Meeting (0)  03.27.2025
-- -- Selections Sheet Signed (0)  03.30.2025     3/26: sent to Luke
-- -- Amendment for Upgrades (B,S,L,T,BCP) (0)  04.09.2025     3/30: sent to Luke
-- -- Deposit For Upgrades Received (0)  04.08.2025
-- -- Building Permit (30) *   04.11.2025
-- -- Order Roof & Floor Trusses (1)  07.31.2025
-- -- Order Windows & Doors (0)  07.31.2025
-- -- Stake Out Home (1)  05.27.2025
-- -- Excavate (2)  05.27.2025
-- -- Inspection (Footers) (1)  05.27.2025
-- -- Inspection (Concrete Wall) (1)  07.31.2025
-- -- Pour Footers (1) *   05.27.2025
-- -- Set Forms (2)  05.27.2025
-- -- Pour Foundation Walls (1)  05.27.2025
-- -- Plumb Slab (2)  06.19.2025
-- -- Inspection (Plumbing Under Slab) (1)  07.31.2025
-- -- Inspection (Conduit Under Slab) (1)  07.31.2025
-- -- Prepare Slab (1)  06.23.2025
-- -- Inspection (Slab) (1)  07.31.2025
-- -- Inspection (Drain Tile) (0)  07.22.2025
-- -- Pour Slab (1) *   06.23.2025
-- -- Settlement Agent Confirmed (0)  04.16.2025     4/8: sent to Brittany
-- -- Framing I (9)  07.19.2025
-- -- Order Steps (0)  07.31.2025
-- -- Order Tubs / Showers (0)  08.03.2025
-- -- Framing II (8)  07.19.2025
-- -- Framing III (8) *   07.31.2025
-- -- Verify Window & Roof Structure (0)  07.31.2025
-- -- Install Stairs (0) *   08.03.2025
-- -- Windows & Doors (0) *   08.03.2025
-- -- House Number and Status in Window (0)  08.27.2025
-- -- Roofing (0) *   08.06.2025
-- -- Order Cabinets (0)  08.28.2025
-- -- Order Appliances (0)  10.02.2025
-- -- Deck (0)  10.29.2025     Standard with landing and 7 steps to yard
-- -- Gutters (0)  10.18.2025     In process 10/15
-- -- Driveway (0) *   10.25.2025     Expanded
-- -- Patio (0)  09.17.2025     Standard
-- -- Privacy Divider / Fence (0) *   09.17.2025
-- -- HVAC Rough In (4)  08.03.2025
-- -- Rough In Microwave Vent (0)  08.03.2025
-- -- Plumbing Rough In (4)  08.16.2025
-- -- Electric Rough In (4)  08.26.2025     In recess 8/23
-- -- Inspection (Rough In HVAC) (1)  08.26.2025
-- -- Inspection (Rough In Plumbing) (1)  08.26.2025
-- -- Inspection (Rough In Electric) (1)  08.26.2025
-- -- Inspection (Framing) (1) *   08.26.2025
-- -- Inspection (Deck Piers) (0)  09.11.2025
-- -- Exterior Vinyl (0) *   10.08.2025     In process 10/1
-- -- Exterior Stone (0)  10.15.2025
-- -- Insulation (2) *   09.01.2025
-- -- Inspection (Insulation) (1)  09.04.2025
-- -- Inspection (Electric Service) (0)  10.10.2025
-- -- Set Electric Meter (0) *   10.23.2025
-- -- Inspection (Main Sewer Line) (0)  08.14.2025
-- -- Inspection (Main Water Line) (0)  08.14.2025
-- -- Order Interior Doors & Trim (0)  09.11.2025
-- -- Drywall (Hang) (4) *   09.11.2025
-- -- Deed Preparation (0)  10.23.2025
-- -- Drywall (Tape, Block, Skim, Sand) (6) *   09.17.2025
-- -- Paint 1 (1)  09.17.2025
-- -- Cabinet Installation (2) *   09.28.2025     Deliver Sep 23, Install Sep 25
-- -- Granite Installation (1) *   10.18.2025     In process 10/15
-- -- Interior Trim - Install (3) *   10.08.2025     In process 10/1
-- -- Order Plumbing / Lighting Fixtures (0)  10.02.2025
-- -- Interior Trim - Paint (1)  10.11.2025
-- -- Luxury Vinyl Plank (3) *   10.22.2025
-- -- Luxury Vinyl Tile (0)  10.23.2025
-- -- Paint 2 (3)  10.31.2025     In process. 10/29
-- -- Deliver Plumbing / Lighting Fixtures (0)  10.13.2025
-- -- Shoe Moulding (0)  10.29.2025
-- -- Pay Water / Sewer Taps (0)  10.23.2025
-- -- Set Water Meter (0) *   10.30.2025
-- -- Plumbing Trim Out (2) *   10.29.2025
-- -- Paint 3 (2) *   10.31.2025
-- -- Carpet (2)  10.22.2025
