| -- | -- | Farmhouse trim is going to be needed around sink | Burlap - Jorge | |

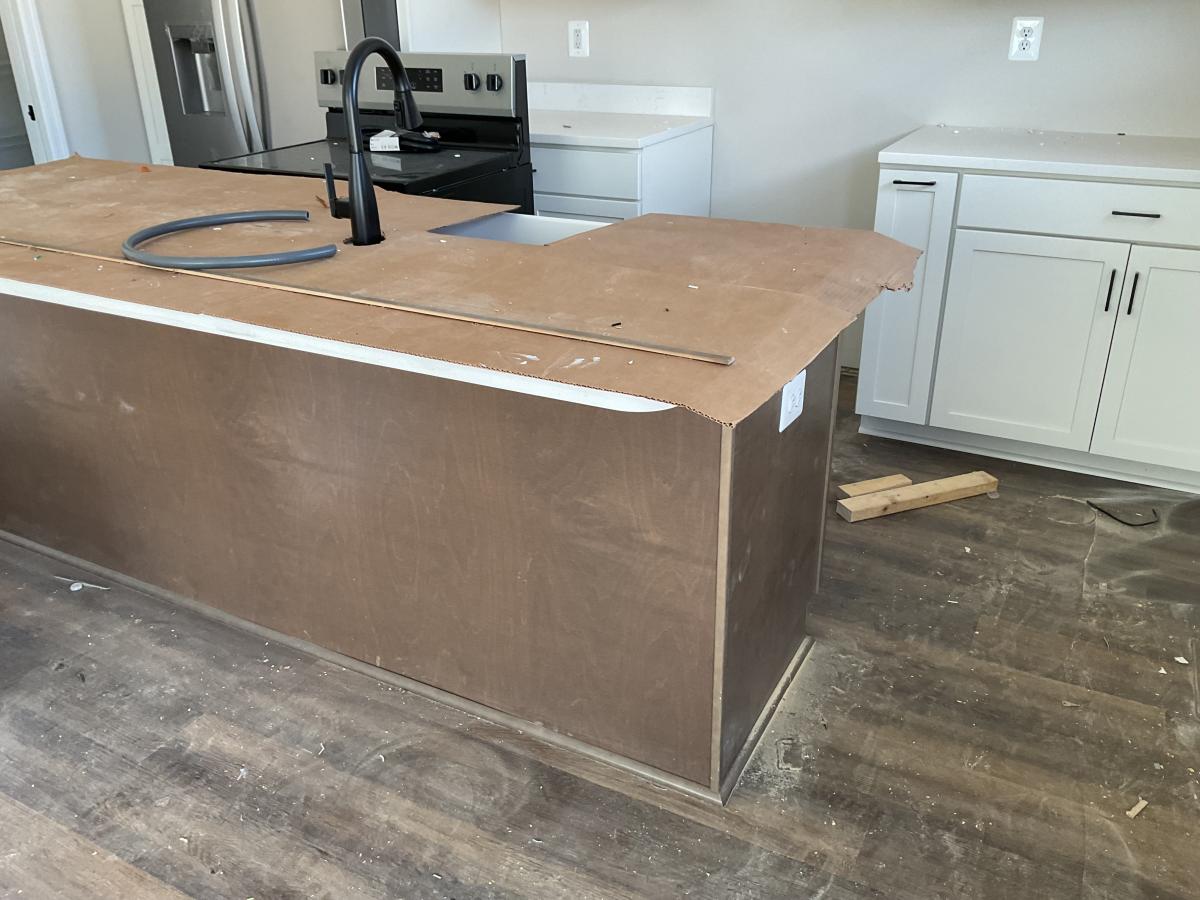

| -- | -- | Piece of backsplash is missing on kitchen countertops | Fenco | |

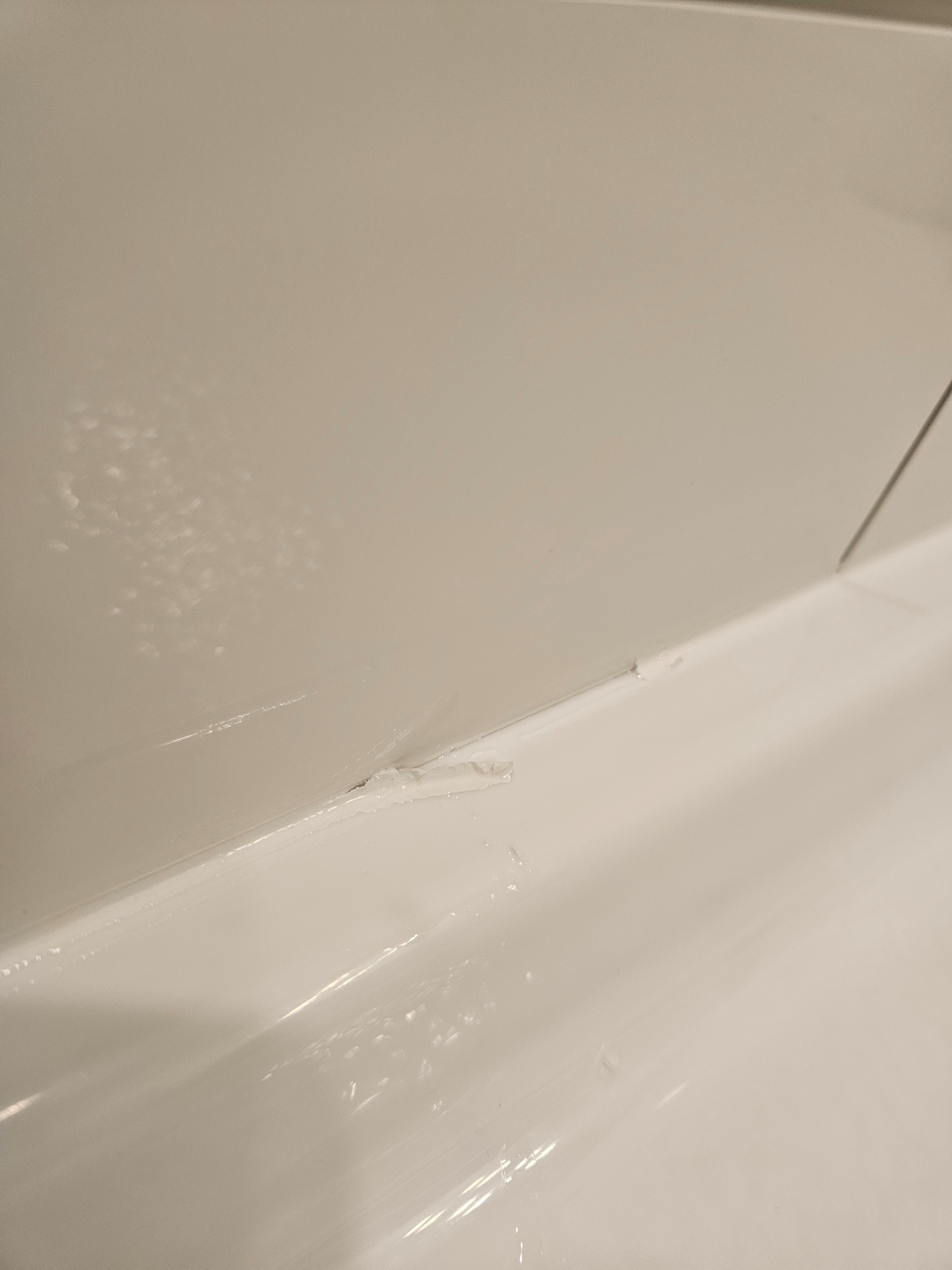

| -- | -- | Dent in the fridge door near the handle | Kate is working on a replacement | |

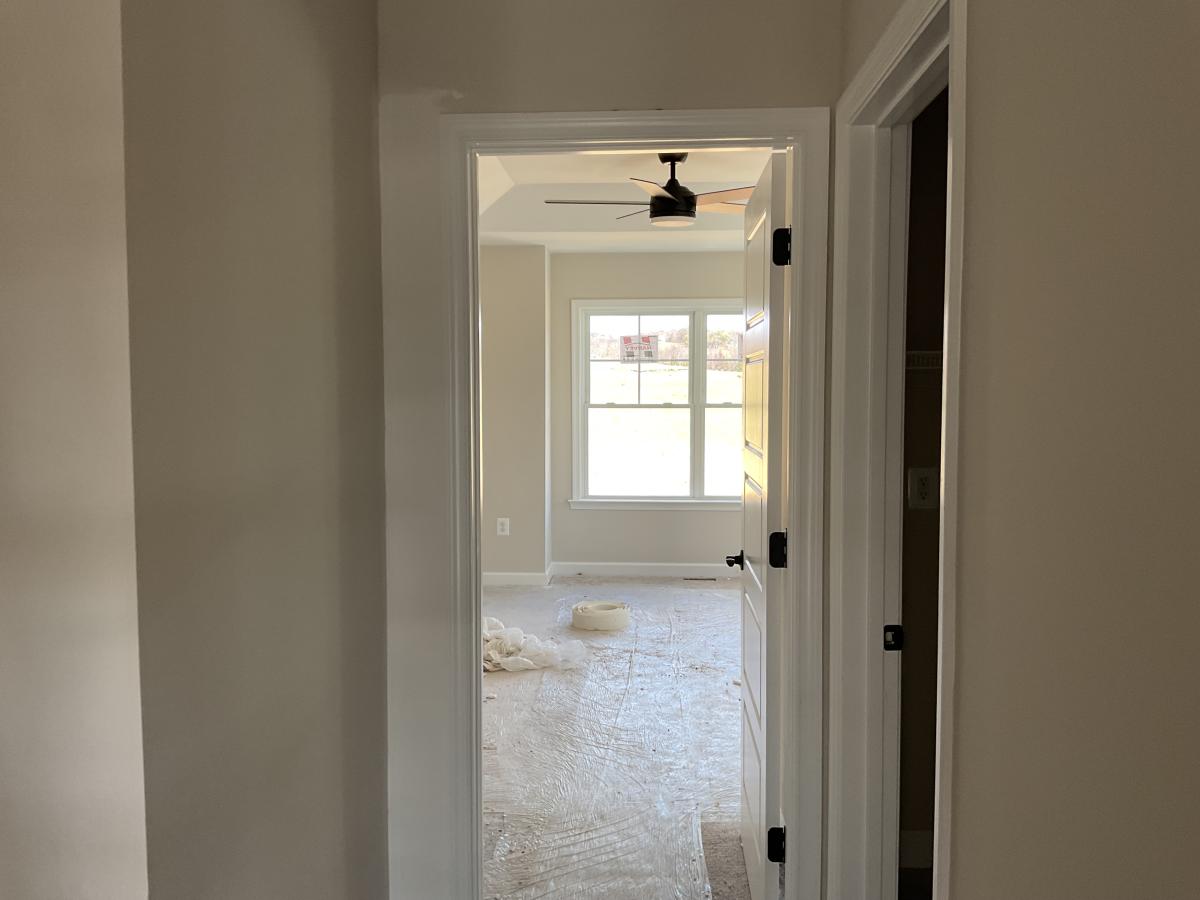

| -- | -- | Few painting repairs needed in back bonus room | ||

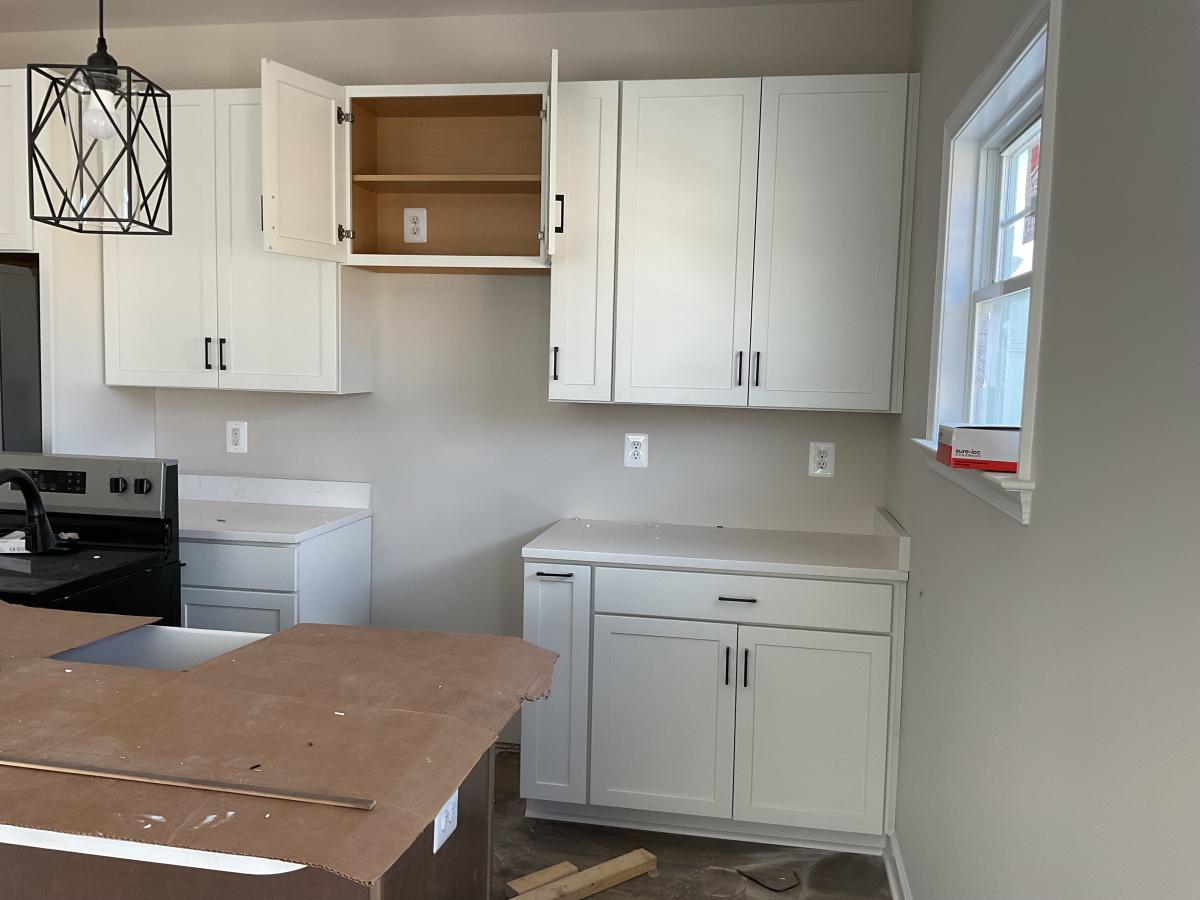

| -- | -- | Brown electrical outlets needed for kitchen is | Island | |
| -- | -- | Trim basement doors that rub carpet | ||
| -- | -- | Drywall in garage | ||
| -- | -- | Bonus bath light fixture still needed. Bonus room light is not working. | ||

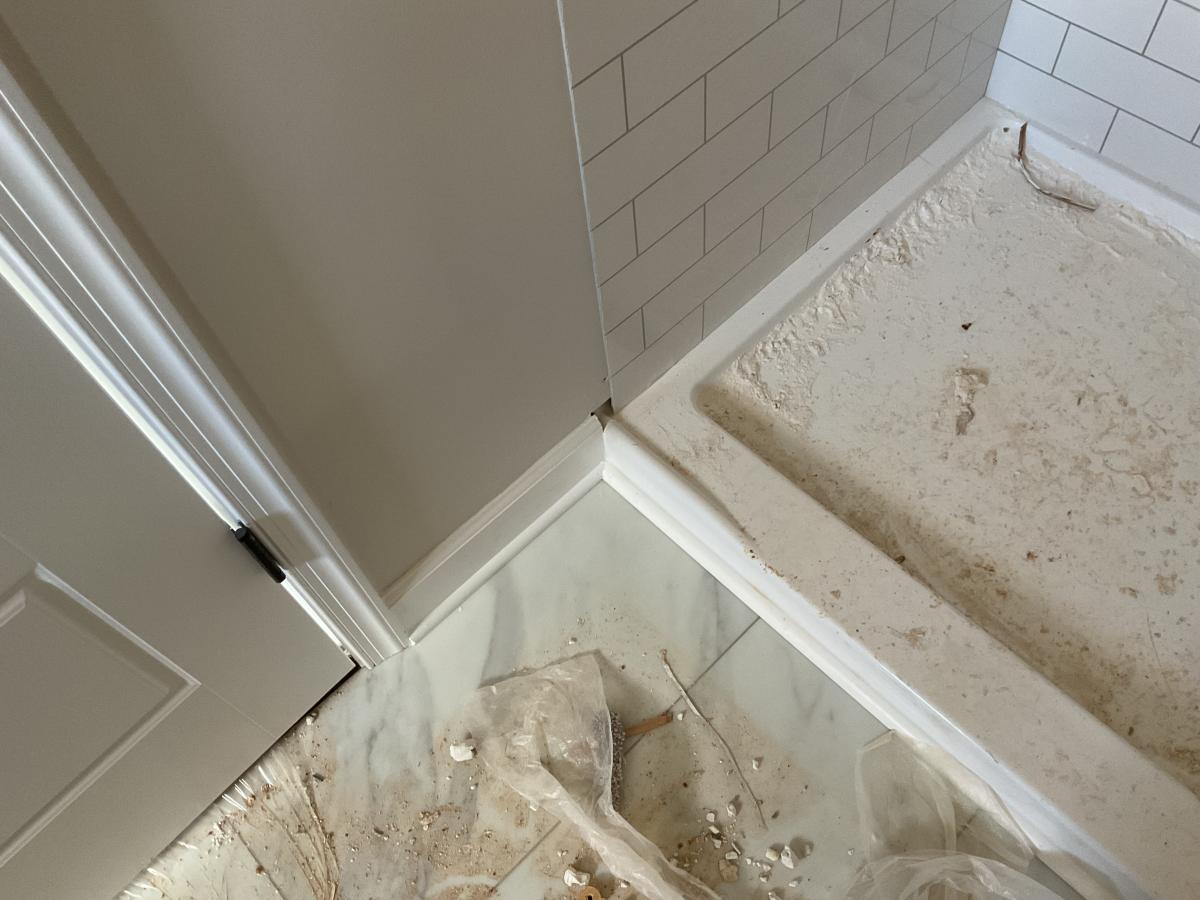

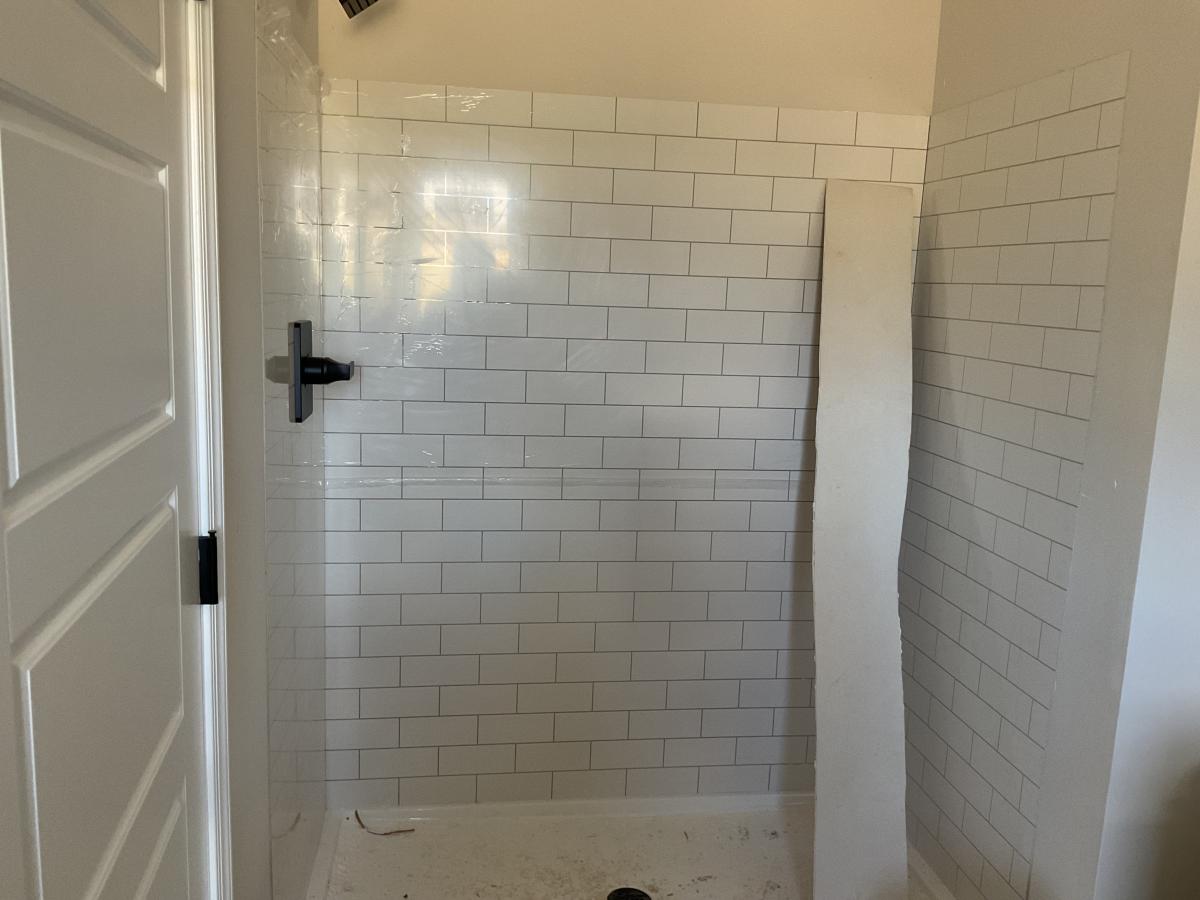

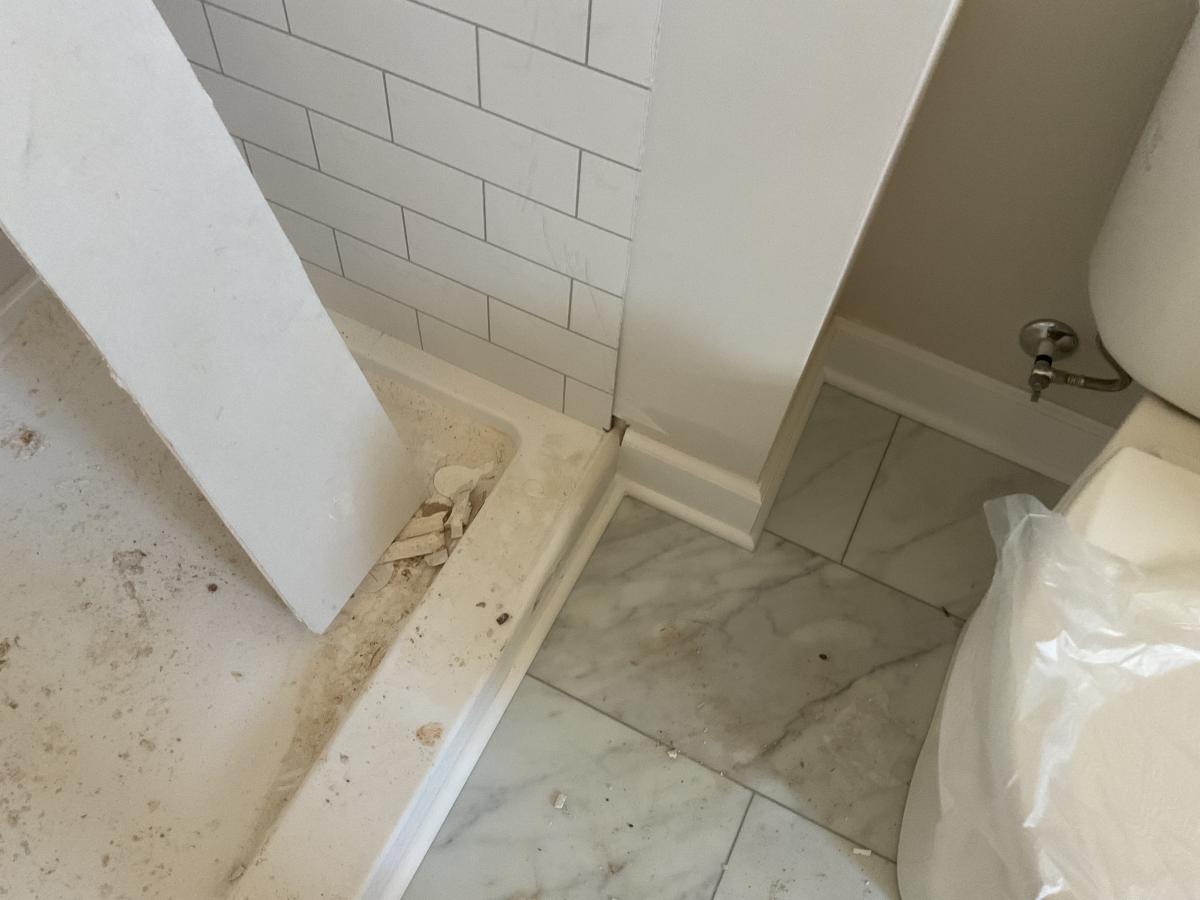

| -- | -- | Holes will need patched on the side of the shower walls where it meets the molding | ||
| -- | -- | CODED LOCKBOX 1515 | ||
| Microwave vented to Exterior | ||||
| Shower Door in Master Bathroom | ||||

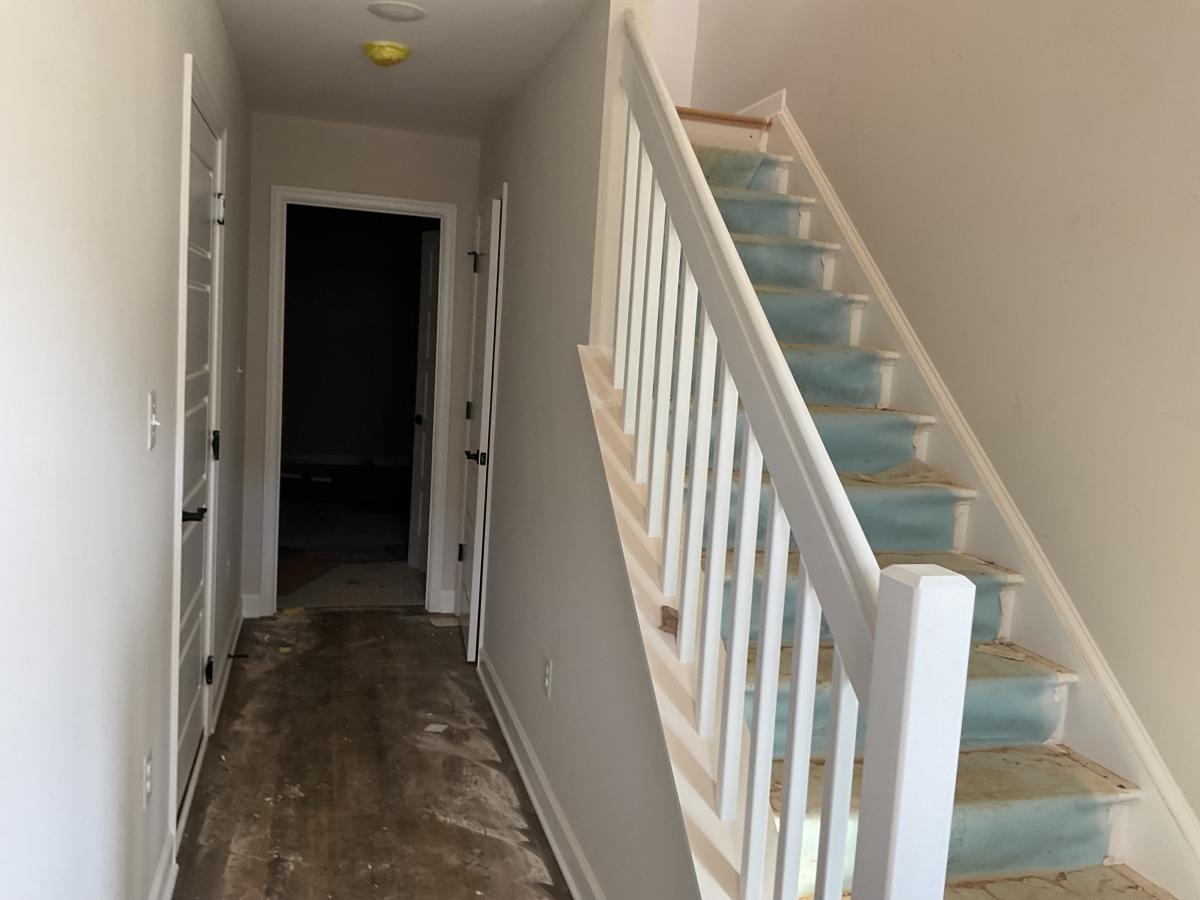

| Stained Hardwood Treads to Bedroom Level | ||||
| Sun | Nov 2 | Sod / Seed / Landscaping (0) | ||
| Sun | Nov 2 | Loan Approval (0) 02.27.2025 | JoDee @ United (95% Conventional) | |

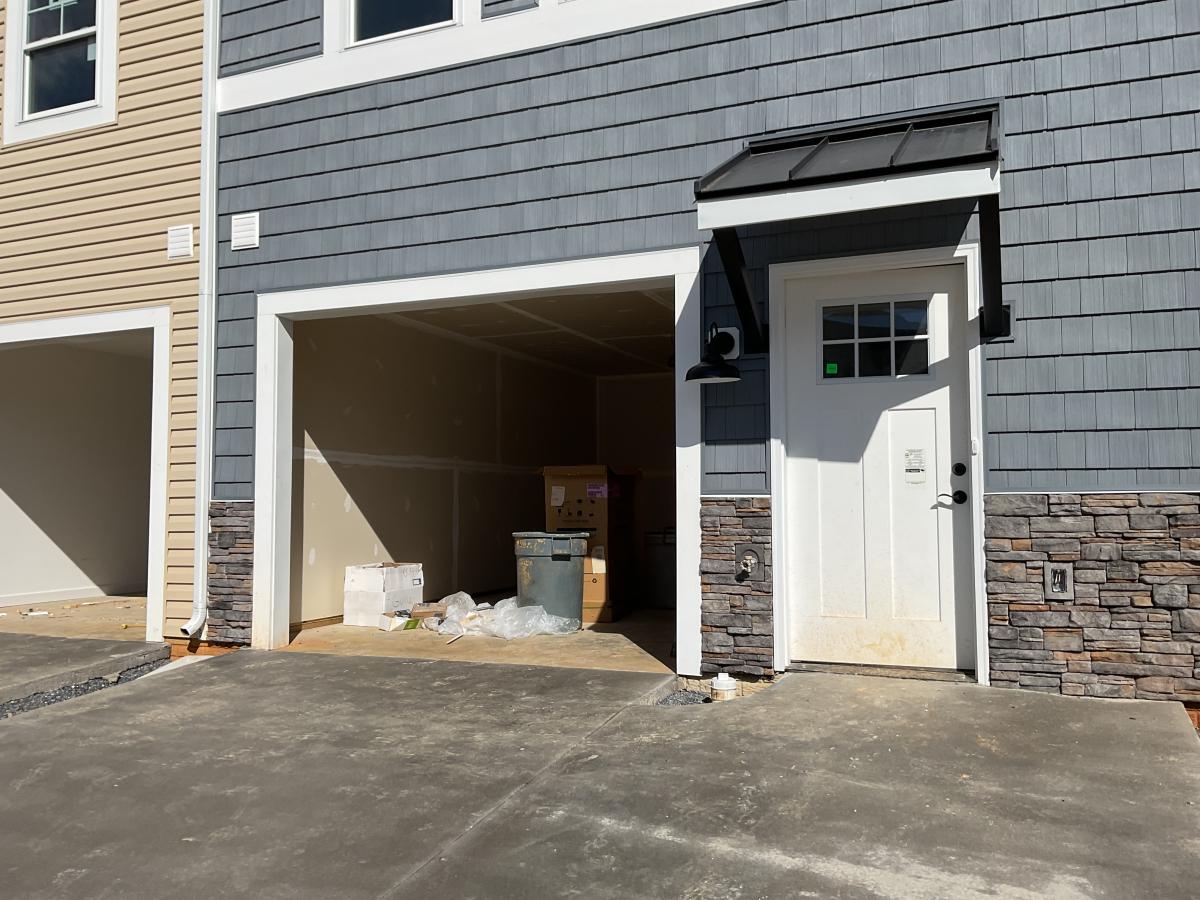

| Sun | Nov 2 | Garage Door (0) | ||
| Sun | Nov 2 | House Numbers (0) | ||
| Sun | Nov 2 | Mailbox (0) | ||
| Sun | Nov 2 | Cover Floors (1) | ||
| Mon | Nov 3 | Electric Trim Out (3) * | In process 10/31 | |
| Thu | Nov 6 | HVAC Trim Out (1) * | ||
| Fri | Nov 7 | Blower Door Test (1) | ||
| Mon | Nov 10 | Install Appliances (0) * | Appliances on site 10/22 | |
| Mon | Nov 10 | Appraiser Confirms Construction Completion (0) | ||
| Mon | Nov 10 | Inspection (Final HVAC) (1) | ||
| Tue | Nov 11 | Inspection (Final Plumbing) (1) | ||
| Wed | Nov 12 | Inspection (Final Electric) (1) | ||
| Thu | Nov 13 | Inspection (Final Building) (2) * | ||
| Mon | Nov 17 | Pre Walk Through (0) | ||
| Mon | Nov 17 | Stain Hardwood Stairs (1) * | ||
| Tue | Nov 18 | Cleaning (1) | ||
| Wed | Nov 19 | Certificate of Occupancy (1) * | ||
| Thu | Nov 20 | C.O. to Lender (0) | ||
| Thu | Nov 20 | Schedule Closing (0) | ||
| Thu | Nov 20 | Buyer Walk Through (1) * | ||
| Fri | Nov 21 | Payment for Upgrades (0) | ||
| Fri | Nov 21 | Keys to Settlement Agent (0) | ||
| Fri | Nov 21 | Review Settlement Statement (0) | ||
| Fri | Nov 21 | Jerry Signs Closing Documents (0) | ||
| Fri | Nov 21 | Request Trash Tote From POA Manager (0) | ||
| Fri | Nov 21 | Closing (1) | Brittany @ West View Title | |
| Mon | Nov 24 | Remove Coded Lockbox (0) | ||
| -- | -- | Pre drywall inspection | Friday, Aug 29 at 1PM, Benjamin Meredith | |
| -- | -- | 12x18 deck possible? | ||
| -- | -- | Make sure correct primary bathtub gets installed | Shower pan is in the bonus room. The bathtub in the master needs to be moved to the bonus bathroom. | |
| -- | -- | Add insulation at front first floor exterior wall | ||
| -- | -- | Add insulation at half bathroom wall | ||
| -- | -- | Add insulation at the wall adjacent to the front exterior door | ||
| -- | -- | Add insulation at the wall adjacent the 2nd floor stairwell | ||
| -- | -- | Install air barrier behind exterior tub wall | ||
| -- | -- | Install air barrier at exterior wall adjacent to primary bathroom shower stall | ||
| -- | -- | Repair damaged truss plates at left side gable end attic truss | ||
| -- | -- | Repair floor truss adjacent to top of basement stairs | ||
| -- | -- | Last bit of bonus room drywall needs to be installed. I think after the deck is built. | ||
| -- | -- | I do not see the panels for this primary shower on site | In primary bedroom, just need to be installed | |
| -- | -- | Garage drywall is going to need to be finished | Drywaller | |

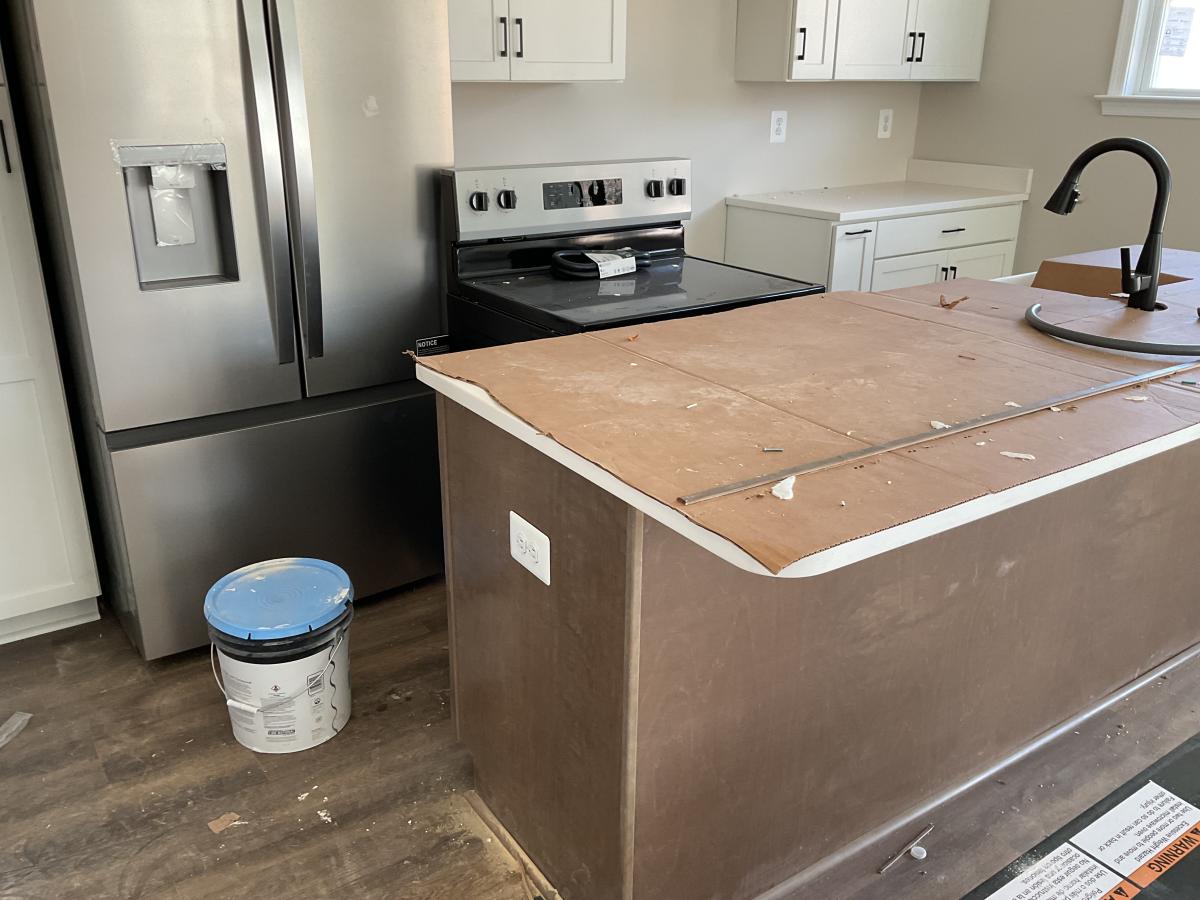

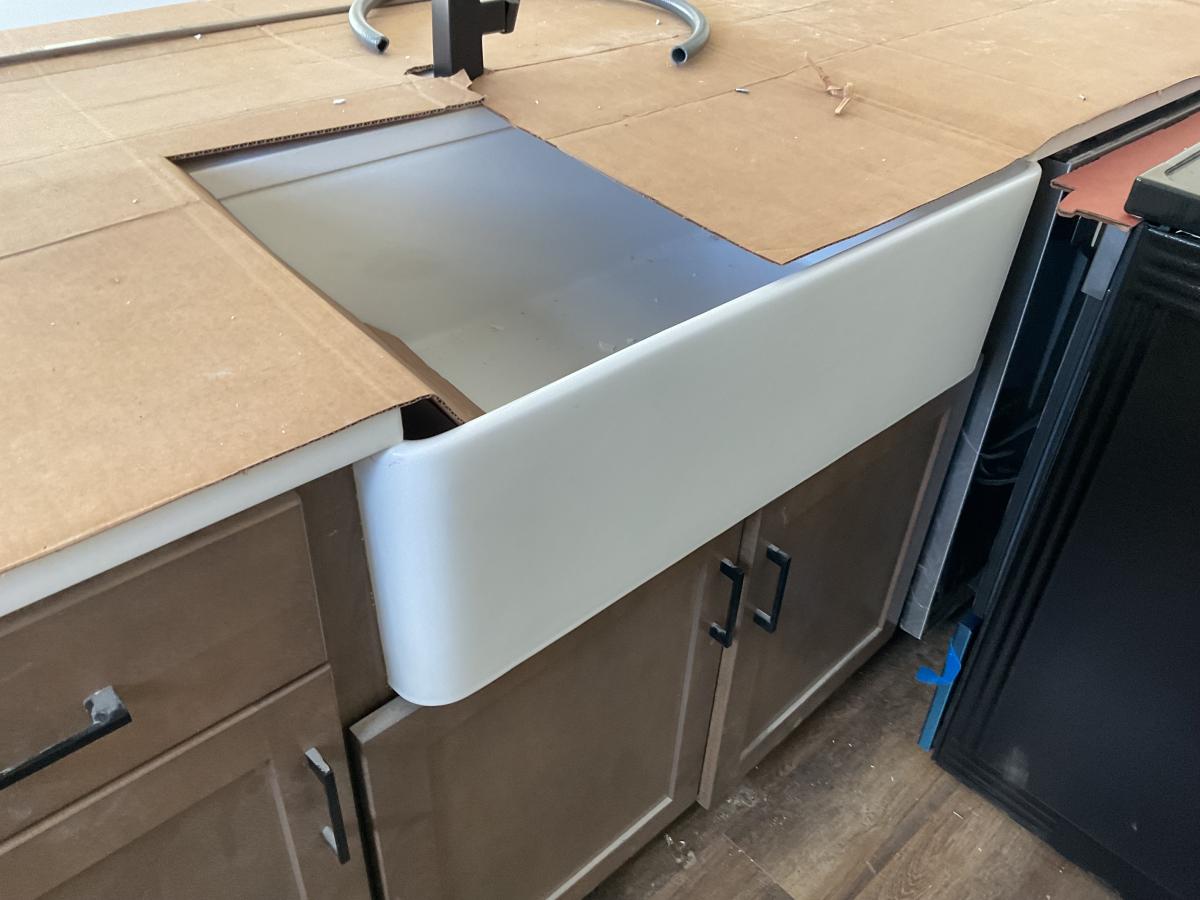

| -- | -- | Install farmhouse sink that is sitting on the floor of the kitchen | ||
| -- | -- | Repair drywall around primary bedroom door | Drywaller | |
| -- | -- | Wrong bathroom countertops? | Waiting on Fenco | |
| -- | -- | Remove culture marble countertops from primary bathroom and install quartz. I do not see a side splash on site for the quartz countertops. | ||
| -- | -- | Cover carpet in bonus room | ||
| -- | -- | Install countertop and bonus bathroom | Fenco | |
| -- | -- | Install countertop in primary bathroom | Fenco | |
| -- | -- | Ratified Contract? (0) 02.13.2025 | ||
| Finished Bonus Room | ||||
| Finished Bonus Bathroom | ||||
| Expanded Driveway | ||||
| White perimeter kitchen cabinets | ||||
| Level 0 Quartz Countertops Carrara Trigato | ||||
| Farmhouse Sink | ||||
| Double Pull Out Waste Basket in Island | ||||
| Spice Rack Cabinet | ||||
| French Style Refrigerator | ||||
| Level 0 quartz in all bathrooms | ||||
| LVP in Upstairs Hallway | ||||
| 8 lb pad upstairs carpet | ||||
| 8 lb pad in Bonus Room | ||||

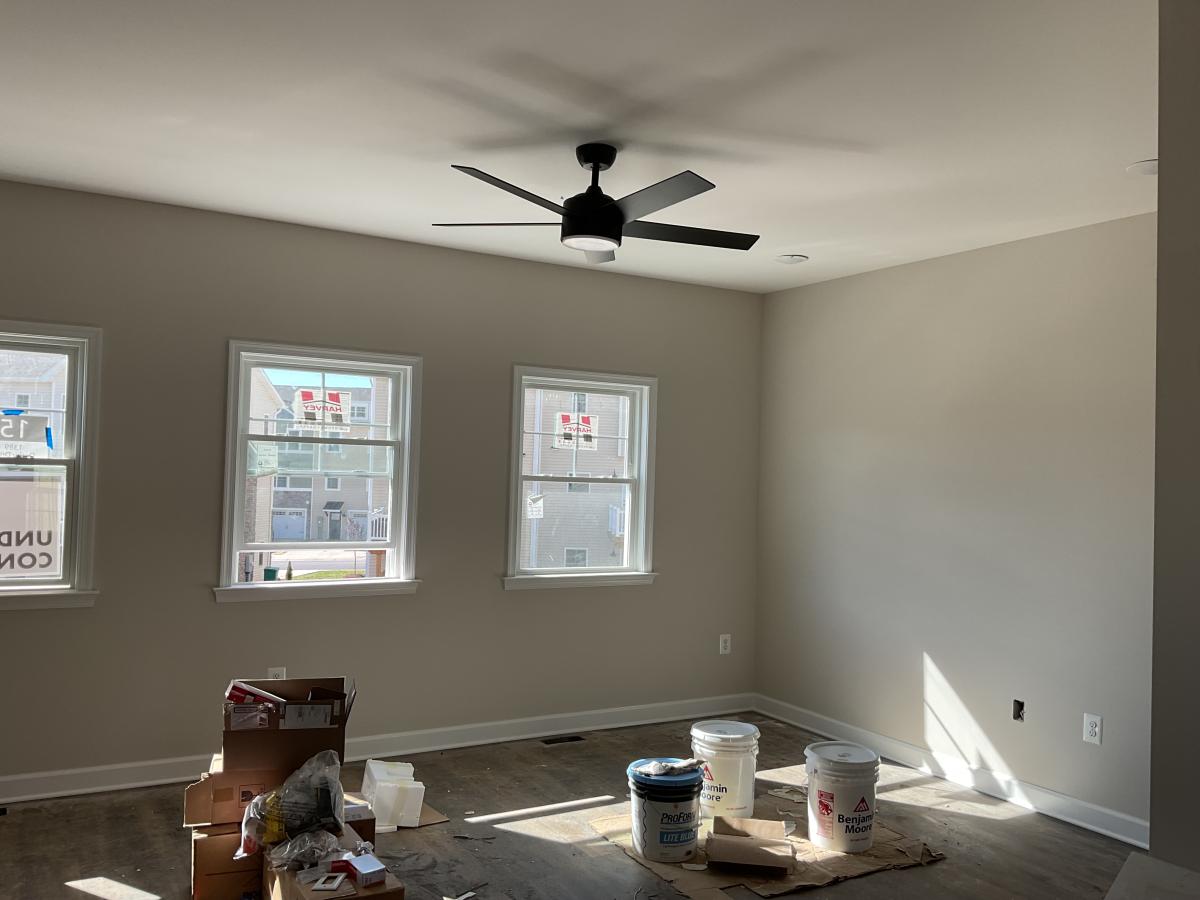

| Living Room ceiling fan | ||||
| Digital Deadbolt front door | ||||

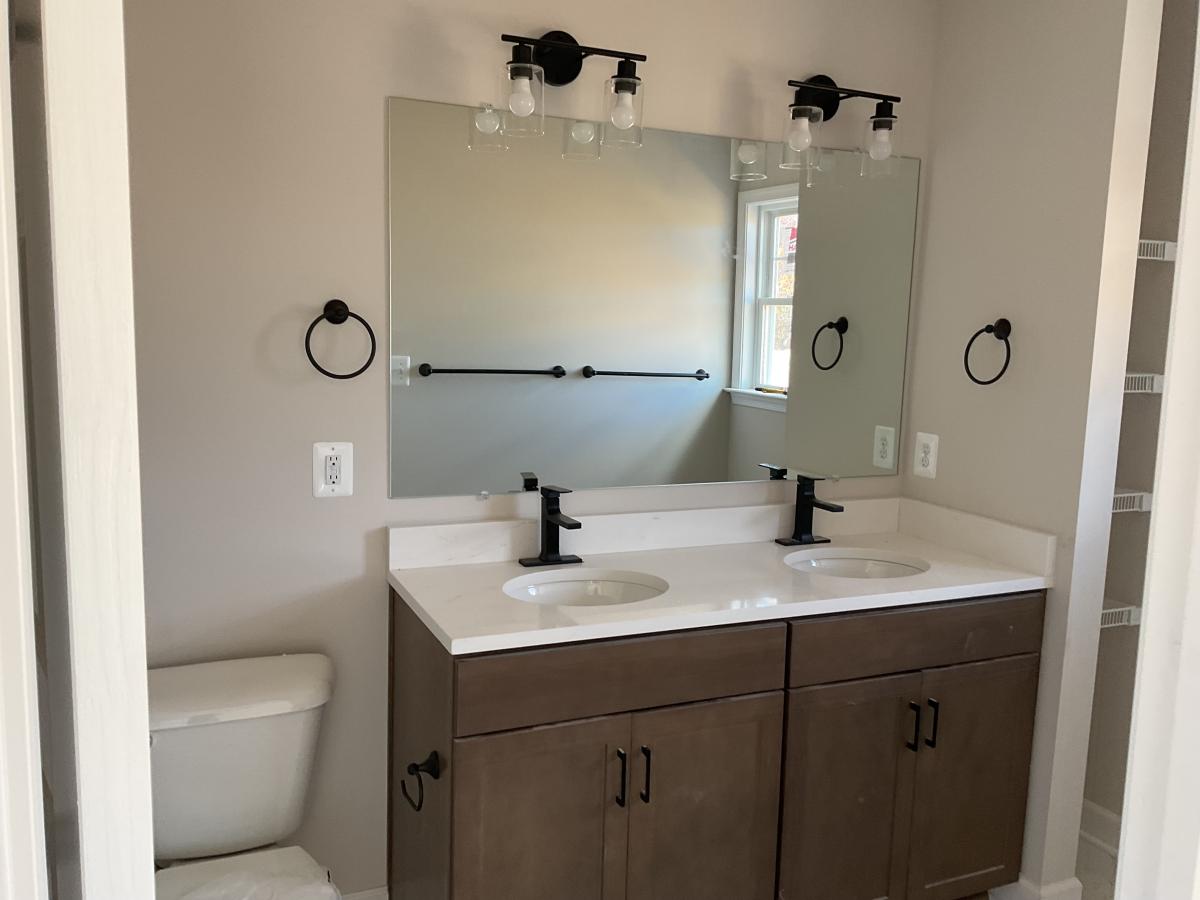

| White Subway Tile Shower Walls | ||||
| Expanded 10 x 18 Deck | ||||
| Amendment to increase price by $34,690 | ||||
| -- | -- | $2500 Deposit Received (0) 02.17.2025 | ||
| -- | -- | Association Packet Requested (0) 06.30.2025 | ||
| -- | -- | Association Packet Received (0) 02.15.2025 | ||
| -- | -- | Selections Meeting (0) 03.28.2025 | 11:00 AM 3/26 | |
| -- | -- | Selections Sheet Signed (0) 03.30.2025 | 3/27: sent to Luke | |
| -- | -- | Amendment for Upgrades (B,S,L,T,BCP) (0) 08.02.2025 | 7/29: sent to Luke | |
| -- | -- | Deposit For Upgrades Received (0) 04.08.2025 | ||
| -- | -- | Building Permit (30) * 04.11.2025 | ||
| -- | -- | Order Roof & Floor Trusses (1) 07.31.2025 | ||
| -- | -- | Order Windows & Doors (0) 07.31.2025 | ||
| -- | -- | Stake Out Home (1) 05.27.2025 | ||

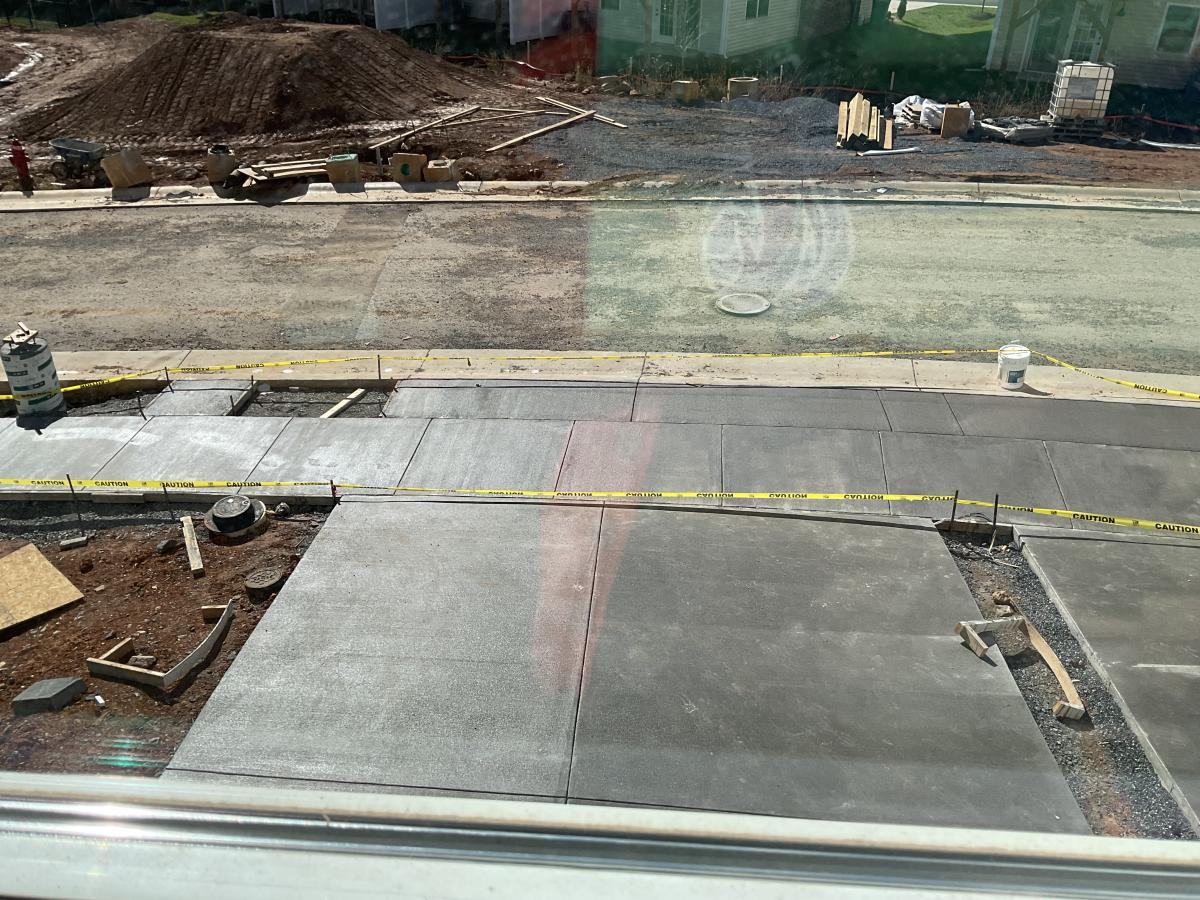

| -- | -- | Excavate (2) 05.27.2025 | ||
| -- | -- | Inspection (Footers) (1) 06.30.2025 | ||
| -- | -- | Inspection (Concrete Wall) (1) 05.27.2025 | ||
| -- | -- | Pour Footers (1) * 06.19.2025 | ||
| -- | -- | Set Forms (2) 05.27.2025 | ||
| -- | -- | Pour Foundation Walls (1) 05.27.2025 | ||
| -- | -- | Plumb Slab (2) 06.19.2025 | ||
| -- | -- | Inspection (Plumbing Under Slab) (1) 06.30.2025 | ||
| -- | -- | Inspection (Conduit Under Slab) (1) 06.30.2025 | ||
| -- | -- | Prepare Slab (1) 06.30.2025 | ||
| -- | -- | Inspection (Slab) (1) 07.19.2025 | ||
| -- | -- | Inspection (Drain Tile) (0) 07.19.2025 | ||
| -- | -- | Pour Slab (1) * 06.30.2025 | ||
| -- | -- | Settlement Agent Confirmed (0) 04.16.2025 | ||
| -- | -- | Framing I (9) 07.19.2025 | ||
| -- | -- | Order Steps (0) 07.31.2025 | ||
| -- | -- | Order Tubs / Showers (0) 08.03.2025 | ||
| -- | -- | Framing II (8) 07.19.2025 | ||
| -- | -- | Framing III (8) * 07.31.2025 | ||
| -- | -- | Verify Window & Roof Structure (0) 07.31.2025 | ||
| -- | -- | Install Stairs (0) * 08.03.2025 | ||
| -- | -- | Windows & Doors (0) * 08.03.2025 | ||
| -- | -- | House Number and Status in Window (0) 09.06.2025 | ||
| -- | -- | Roofing (0) * 08.06.2025 | ||
| -- | -- | Order Cabinets (0) 08.28.2025 | ||
| -- | -- | Order Appliances (0) 10.02.2025 | ||
| -- | -- | Deck (0) 09.17.2025 | Standard | |
| -- | -- | Gutters (0) 10.18.2025 | ||
| -- | -- | Driveway (0) * 10.31.2025 | ||
| -- | -- | Patio (0) 09.17.2025 | Standard | |
| -- | -- | Privacy Divider / Fence (0) * 09.17.2025 | ||
| -- | -- | HVAC Rough In (4) 08.03.2025 | ||
| -- | -- | Rough In Microwave Vent (0) 08.03.2025 | ||
| -- | -- | Plumbing Rough In (4) 08.18.2025 | In process 8/13 | |
| -- | -- | Electric Rough In (4) 08.26.2025 | ||
| -- | -- | Inspection (Rough In HVAC) (1) 08.26.2025 | ||
| -- | -- | Inspection (Rough In Plumbing) (1) 08.26.2025 | ||
| -- | -- | Inspection (Rough In Electric) (1) 08.26.2025 | ||
| -- | -- | Inspection (Framing) (1) * 08.26.2025 | ||
| -- | -- | Inspection (Deck Piers) (0) 09.11.2025 | ||
| -- | -- | Exterior Vinyl (0) * 10.08.2025 | In process 10/1 | |
| -- | -- | Exterior Stone (0) 10.15.2025 | ||
| -- | -- | Insulation (2) * 08.27.2025 | ||
| -- | -- | Inspection (Insulation) (1) 09.04.2025 | ||
| -- | -- | Inspection (Electric Service) (0) 10.10.2025 | ||
| -- | -- | Set Electric Meter (0) * 10.23.2025 | ||
| -- | -- | Inspection (Main Sewer Line) (0) 08.21.2025 | ||
| -- | -- | Inspection (Main Water Line) (0) 08.21.2025 | ||
| -- | -- | Order Interior Doors & Trim (0) 09.11.2025 | ||
| -- | -- | Drywall (Hang) (4) * 09.06.2025 | ||
| -- | -- | Deed Preparation (0) 10.23.2025 | ||

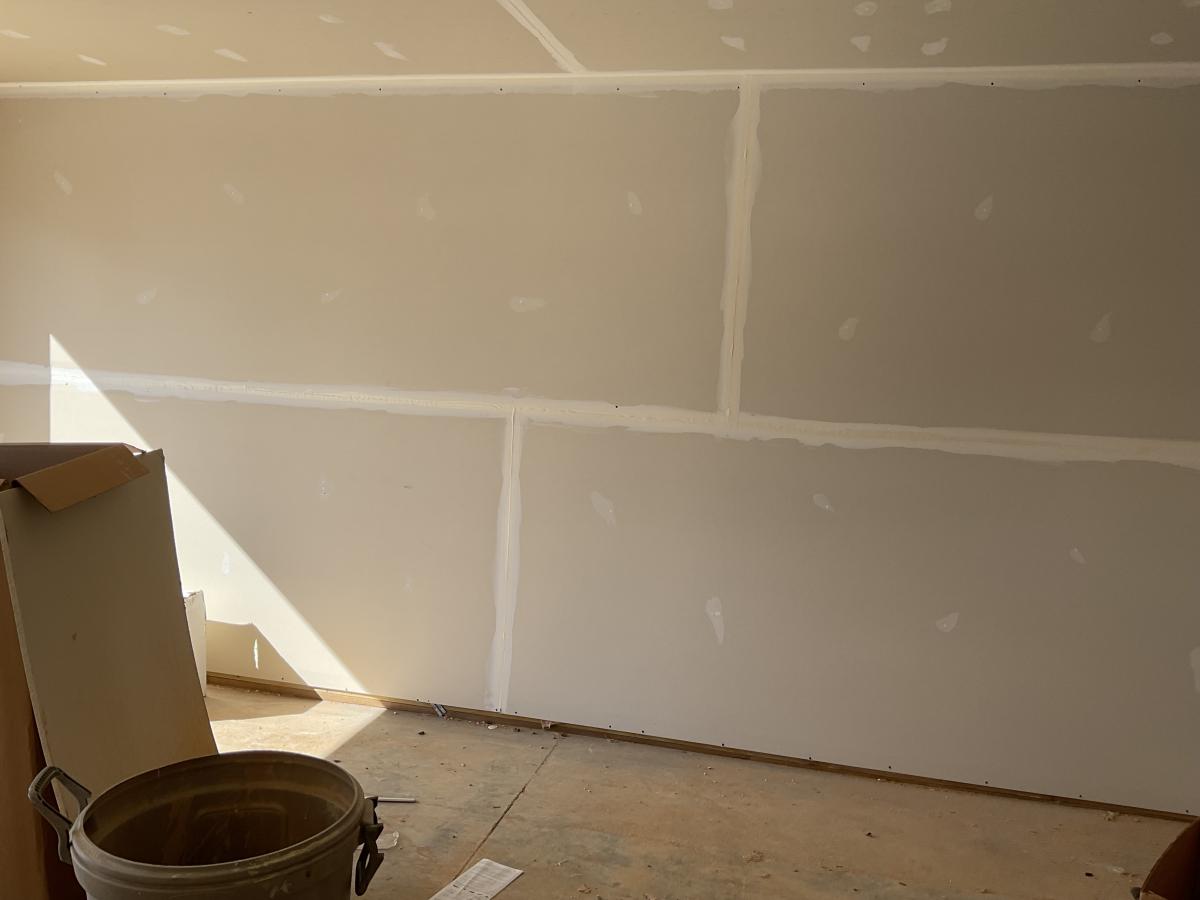

| -- | -- | Drywall (Tape, Block, Skim, Sand) (6) * 09.17.2025 | ||
| -- | -- | Paint 1 (1) 09.17.2025 | ||
| -- | -- | Cabinet Installation (2) * 09.22.2025 | Delivered Sep 17, Installed Sep 18 | |
| -- | -- | Granite Installation (1) * 10.18.2025 | ||
| -- | -- | Interior Trim - Install (3) * 10.01.2025 | In process 9/24 | |
| -- | -- | Order Plumbing / Lighting Fixtures (0) 10.02.2025 | ||
| -- | -- | Interior Trim - Paint (1) 10.01.2025 | ||
| -- | -- | Luxury Vinyl Plank (3) * 10.11.2025 | In process 10/8 | |
| -- | -- | Luxury Vinyl Tile (0) 10.11.2025 | In process 10/8 | |
| -- | -- | Paint 2 (3) 10.15.2025 | ||
| -- | -- | Deliver Plumbing / Lighting Fixtures (0) 10.13.2025 | ||
| -- | -- | Shoe Moulding (0) 10.25.2025 | In process 10/11 | |
| -- | -- | Shelving, Door Knobs, Fire Extinguisher (0) * 10.29.2025 | ||
| -- | -- | Install Coded Lockbox (add extra keys) (0) 10.31.2025 | ||
| -- | -- | Pay Water / Sewer Taps (0) 10.23.2025 | ||
| -- | -- | Set Water Meter (0) * 10.30.2025 | ||
| -- | -- | Ceiling Fans (0) 10.29.2025 | ||
| -- | -- | Plumbing Trim Out (2) * 10.29.2025 | Plumbing in process | |
| -- | -- | Paint 3 (2) * 10.22.2025 | ||
| -- | -- | Carpet (2) 10.11.2025 | ||
