| TO DO |
| CL |
Jan 19 (15) |
CODED LOCKBOX 1111 |
|
|
| SR |
Feb 2 (1) |
Lauren 609-577-7164 |
|
|
| SR |
Jan 30 (4) |
Replace split 2x4 in bonus room |
Tom |
|
| SR |
Feb 2 (1) |
Add hinge restrictor to upper kitchen cabinet door and hall bathroom cabinet door |
Fred |
|
| SR |
Jan 27 (7) |

Add white PVC sill support at door to patio |
Tom |
|
| SR |
Jan 27 (7) |
Secure loose siding at rear of house under eave |
Davenport |
|
|
| UPGRADES |
| --- |
|
| CRITICAL PATH |
|
|
|
Privacy Divider / Fence (0) * |
|
|
|
|
|
Mailbox (0) |
|
|
|
Tue
|
Feb 3
|
Closing (1) |
Brittany @ West View Title (Fri, Jan 30) |
|
|
|
|
Remove Coded Lockbox (0) |
|
|
|
| TO DO - COMPLETED OR DELETED |
|
|
Drywall stocked 1031 |
|
|
|
|
Another free 3-drawer stack? |
|
|
|
|
Drywall is going to need to be finished in this garage |
|
|
|
|
This kitchen also has a free spice rack? |
|
|
|
|
Countertops are missing on these vanities |
Countertop is in small bedroom for hall, vanity and primary bathroom. Vanity is on top of the vanity, but needs to be glued. |
|
|
|
Bonus room vanity is not here |
|
|
|
|
Cabinet installation is still in process. |
|
|
|
|
Trim needed in garage |
|
|
|
|
Cover all carpet |
|
|
|
|
Primary bathroom countertop needs to be secured |
Plumber |
|
| CL |
Jan 7 (27) |
Free 3 stack here also |
|
|
| SR |
Jan 12 (22) |
Home Inspection - Monday, Jan 26 |
|
|
| SR |
Jan 27 (7) |
Add white PVC sill support at door to patio |
|
|
| CL |
Jan 28 (6) |
Whiteboard needed above back patio |
|
|
| CL |
Jan 10 (24) |
A few lightbulbs are needed throughout the home |
Jill |
|
| SR |
Jan 12 (22) |
Register covers |
Mast & Brunk |
|
| SR |
Jan 27 (7) |
Install door stops throughout home |
? |
|
| CL |
Jan 28 (6) |
Final touch up in process 1/28 |
|
|
| SR |
Jan 30 (4) |
Final paint touch up |
Jesus |
|
| CL |
Jan 31 (3) |
Screens |
Jill |
|
| CL |
Jan 14 (20) |

This garage interior door does not close on its own |
Jorge, Needs self-closing hinges. |
|
| CL |
Jan 17 (17) |
Trim in garage and shoe molding need touchup painting throughout |
Jesus - in progress 1/24 |
|
| LR |
Jan 20 (14) |
patch and paint damaged first floor handrail |
Jesus |
|
| CL |
Jan 24 (10) |
Lots of paint on the hinges to the garage door |
Jesus |
|
| CL |
Jan 24 (10) |
Paint the front door |
Jesus |
|
| SR |
Jan 27 (7) |
Front door exterior deadbolt does not latch properly |
Paul, Joe |
|
| SR |
Jan 27 (7) |

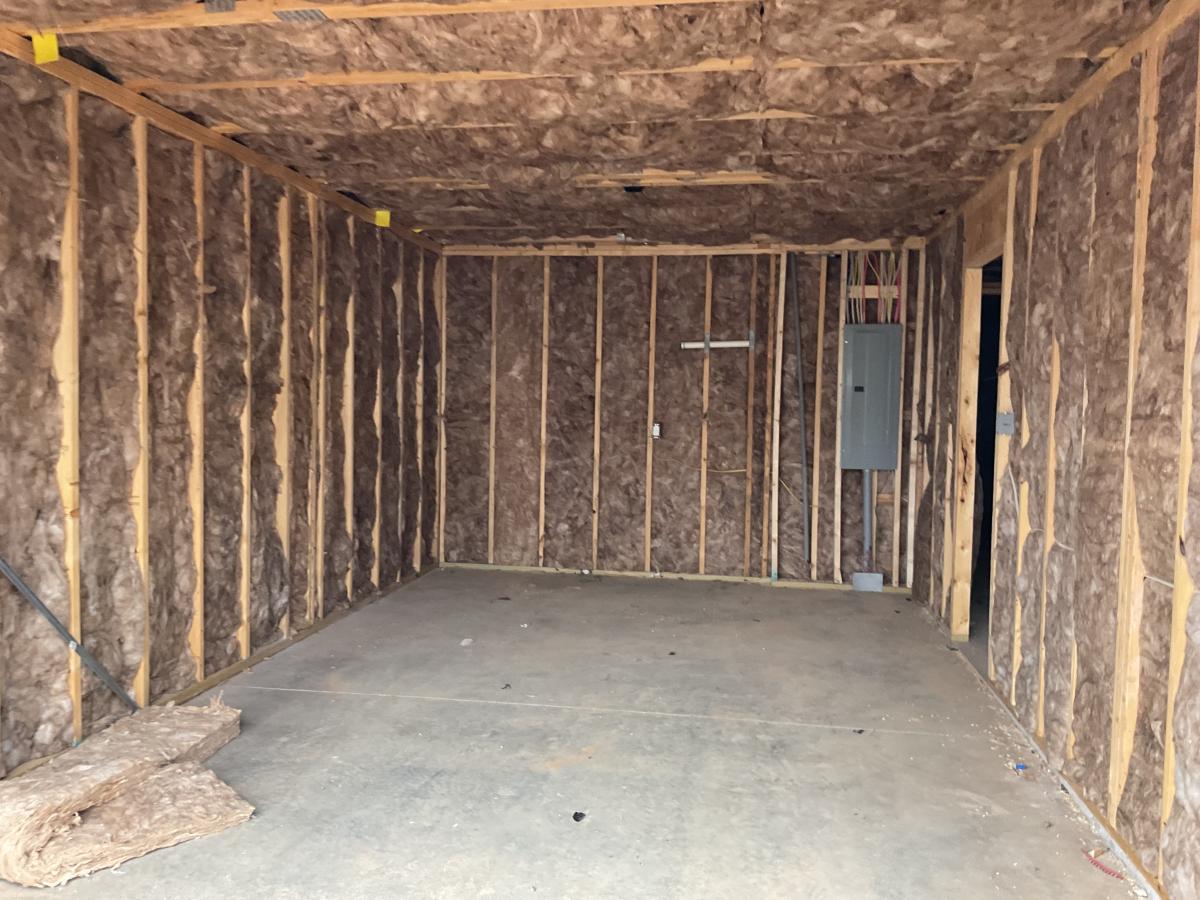

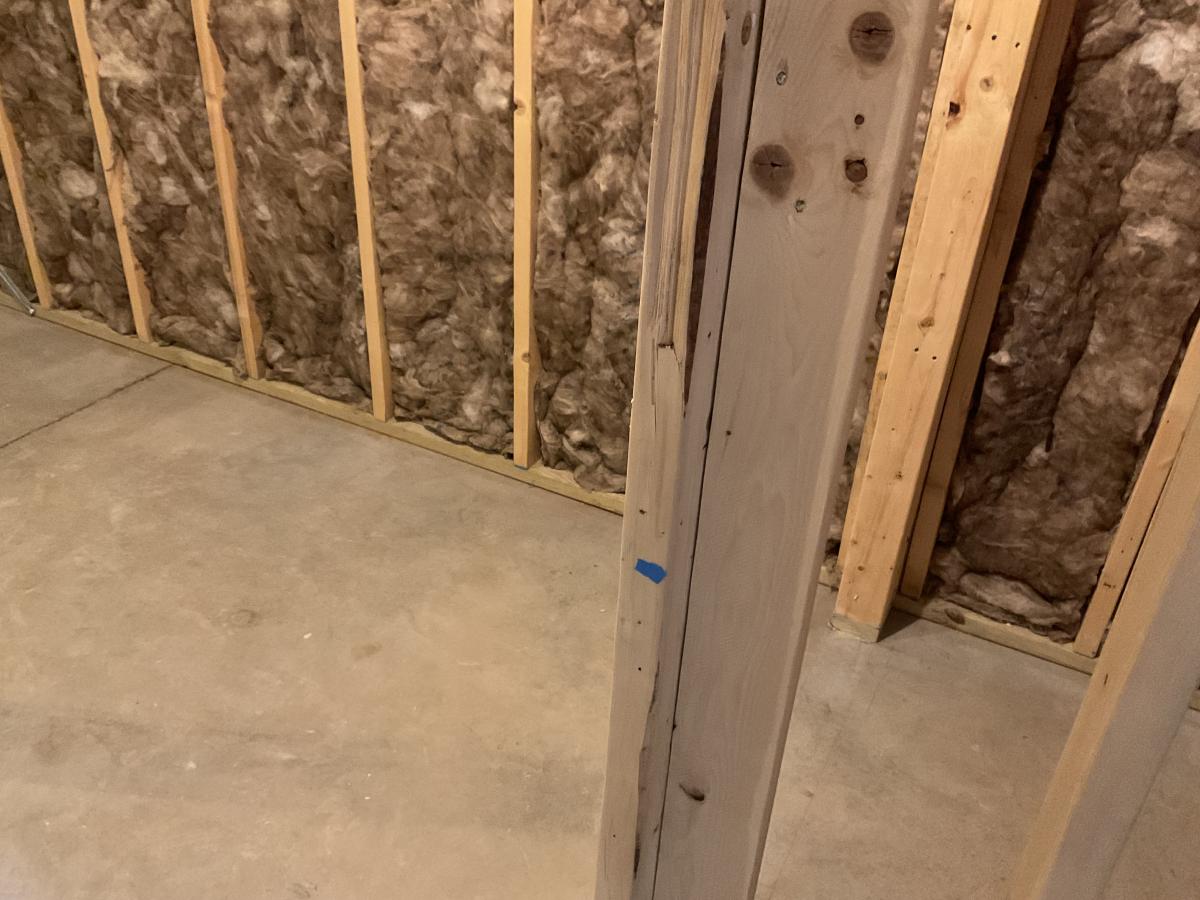

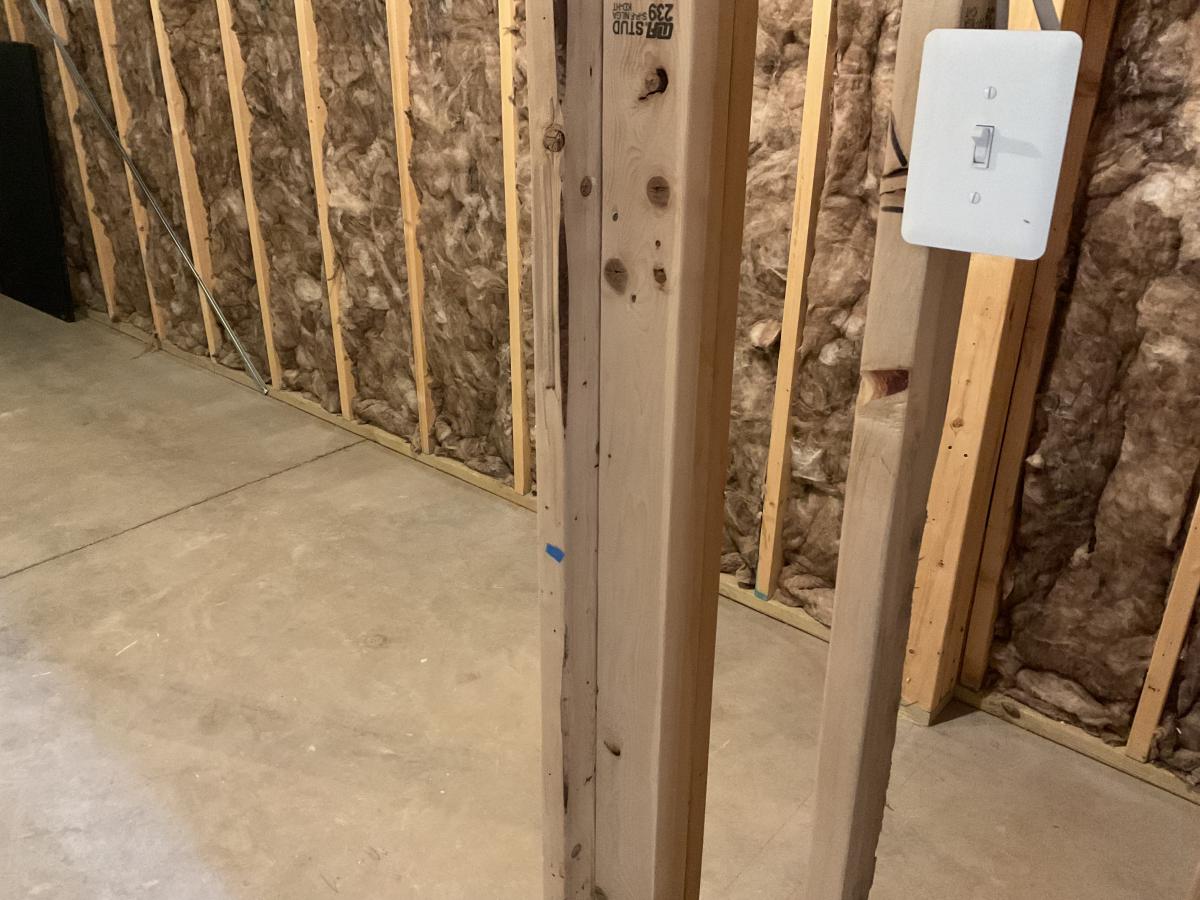

Add insulation where it is missing at backside of garage wall as viewed from bonus room |
Jill |
|
| CL |
Jan 28 (6) |
Clean out the back bonus room |
Jill |
|
| CL |
Jan 28 (6) |
Clean out the garage |
Jill |
|
| KK |
Feb 2 (1) |
Replace cracked 2 x 4 in bonus room |
|
|
| SR |
Jan 12 (22) |
Bathroom fans |
Mast & Brunk |
|
| LR |
Jan 20 (14) |
Paint touchup needed throughout |
Jesus - in progress 1/28 |
|
| SR |
Jan 30 (4) |

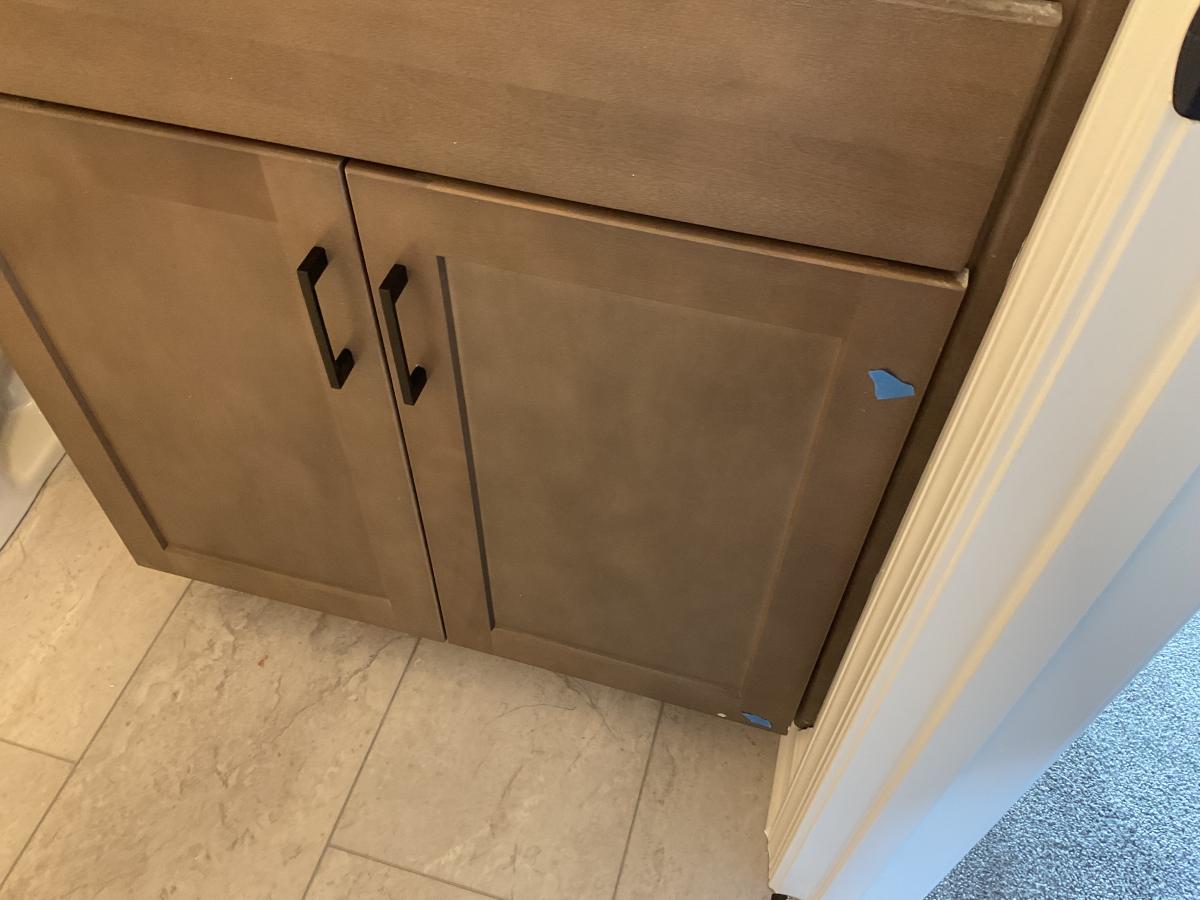

Add bumpers so cabinet doors do not hit wall in kitchen and bathroom |
|
|
| SR |
Jan 30 (4) |
Adjust cabinets so that doors do not hit wall in kitchen and bathroom |
Fred |
|
| CL |
Jan 31 (3) |
Clean paint off floor |
Jesus |
|
| CL |
Jan 31 (3) |
Few cabinet touchups appear to be marked? |
Jill |
|
| CL |
Jan 31 (3) |
If you touchup cleaning items appear to be marked with blue tape |
Jill |
|
| CL |
Jan 10 (24) |
Brown electrical outlets are needed at the kitchen island |
Electrician |
|
| CL |
Jan 17 (17) |

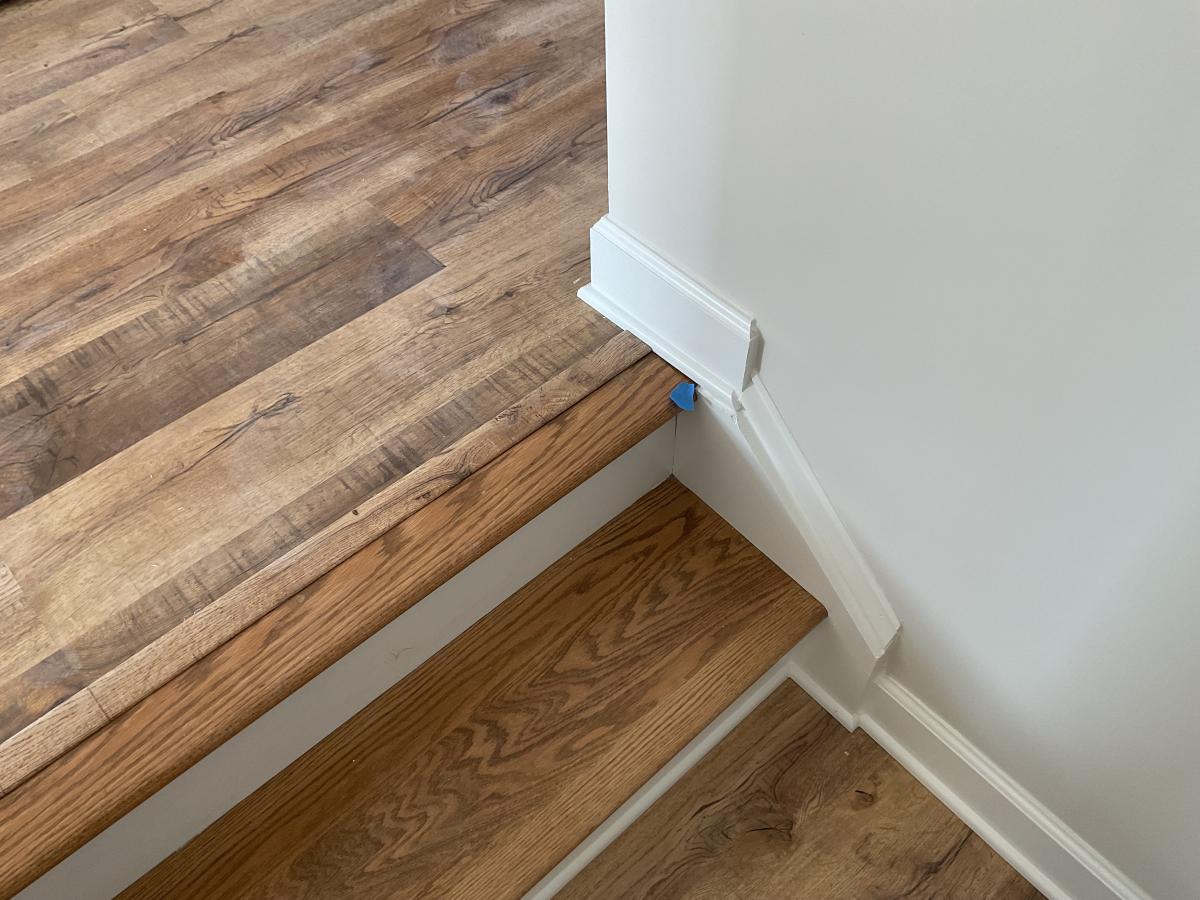

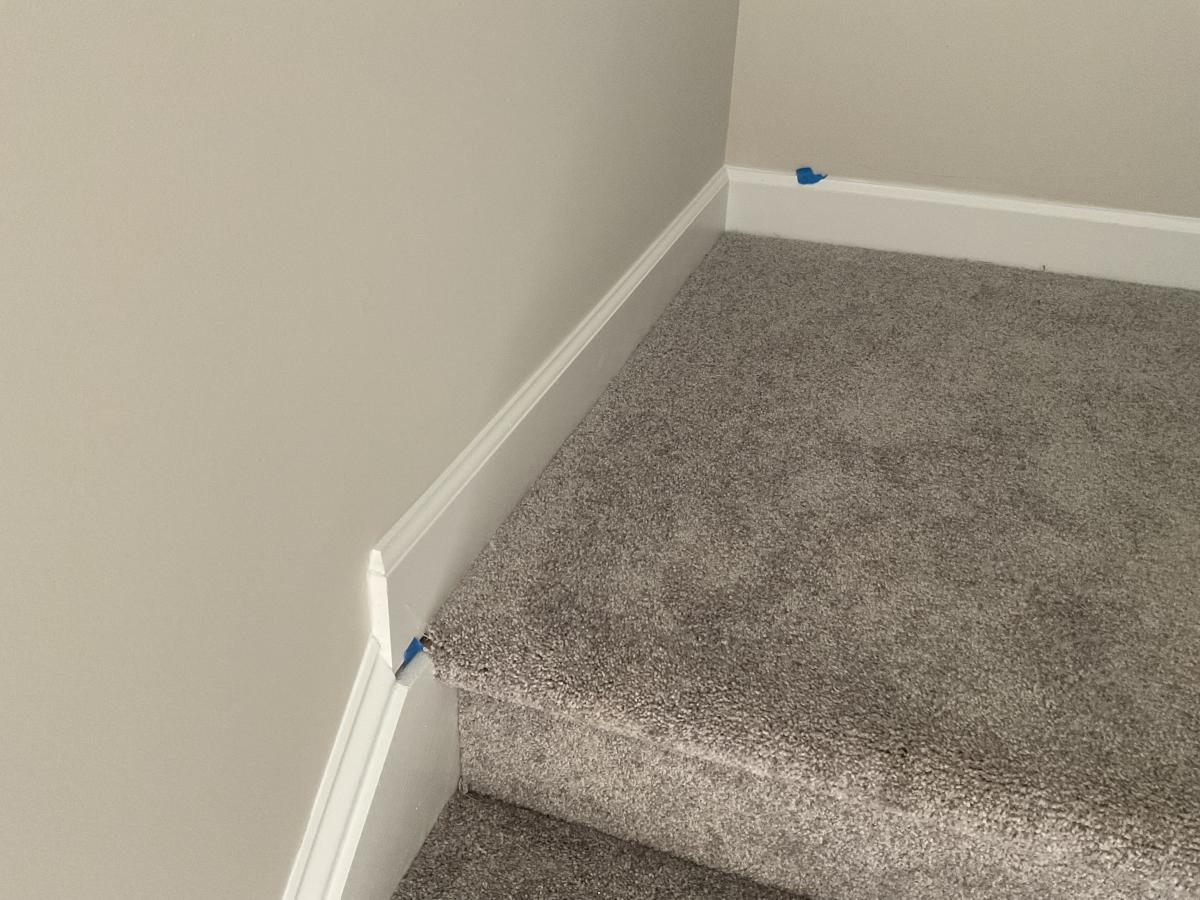

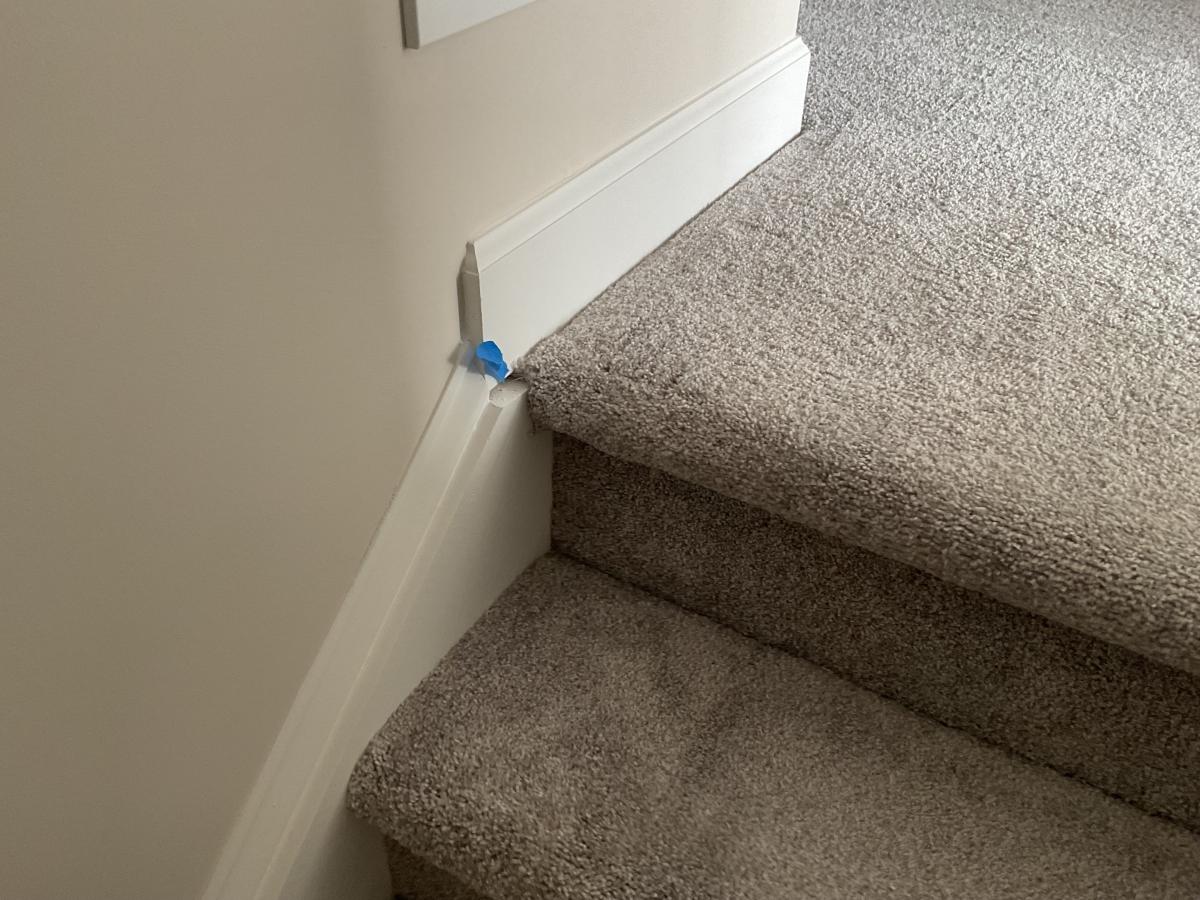

Relatively large gap at the bottom of the staircase leading to the living room |
Jesus |
|
| LR |
Jan 20 (14) |
Low voltage box needs cover |
Tom, Jill |
|
| LR |
Jan 20 (14) |

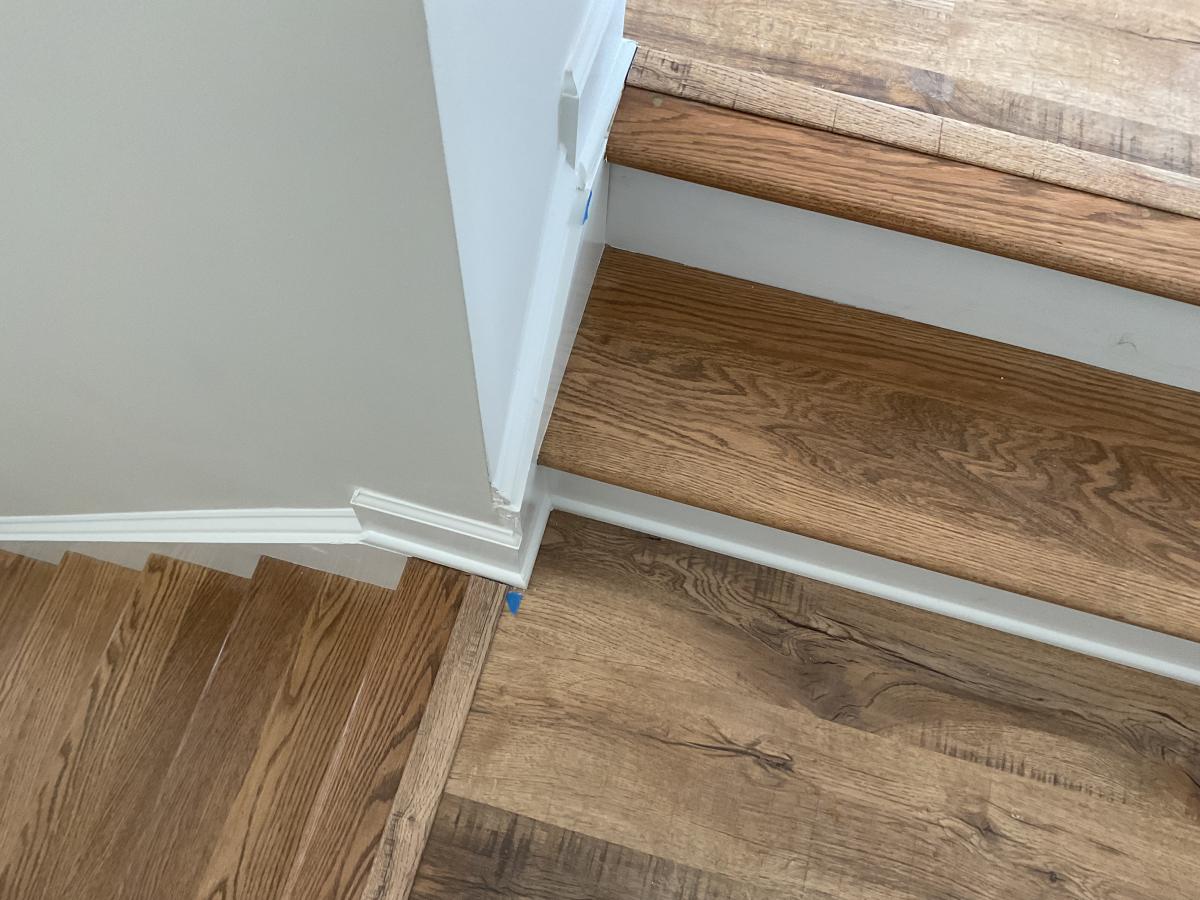

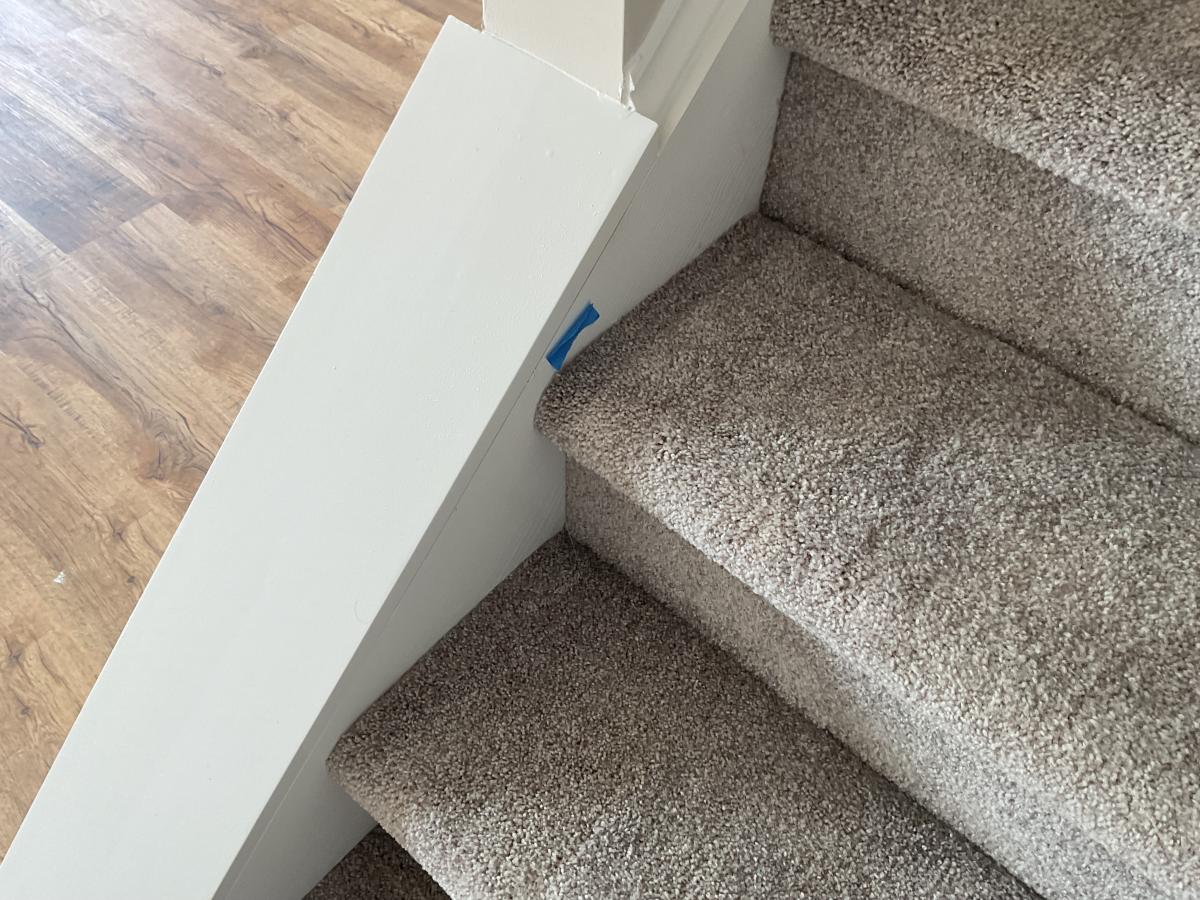

Fix gaps where trim meets carpet stairs |
Jorge, Jesus |
|
| SR |
Jan 27 (7) |
Adjust pantry pocket door that rubs |
Jorge |
|
| SR |
Jan 27 (7) |
Adjust oven door hinge that does operate correctly - left side hinge drags |
Tom |
|
| SR |
Jan 27 (7) |
Turn on water to refrigerator to allow ice maker and water dispenser to work |
Jill |
|
| KK |
Feb 2 (1) |
Add hinge support to upper and lower kitchen cabinet next to wall |
|
|
|
|

Side splash needed primary bathroom |
On site, painter to secure to wall, Jesus - in progress 1/21 |
|
|
|

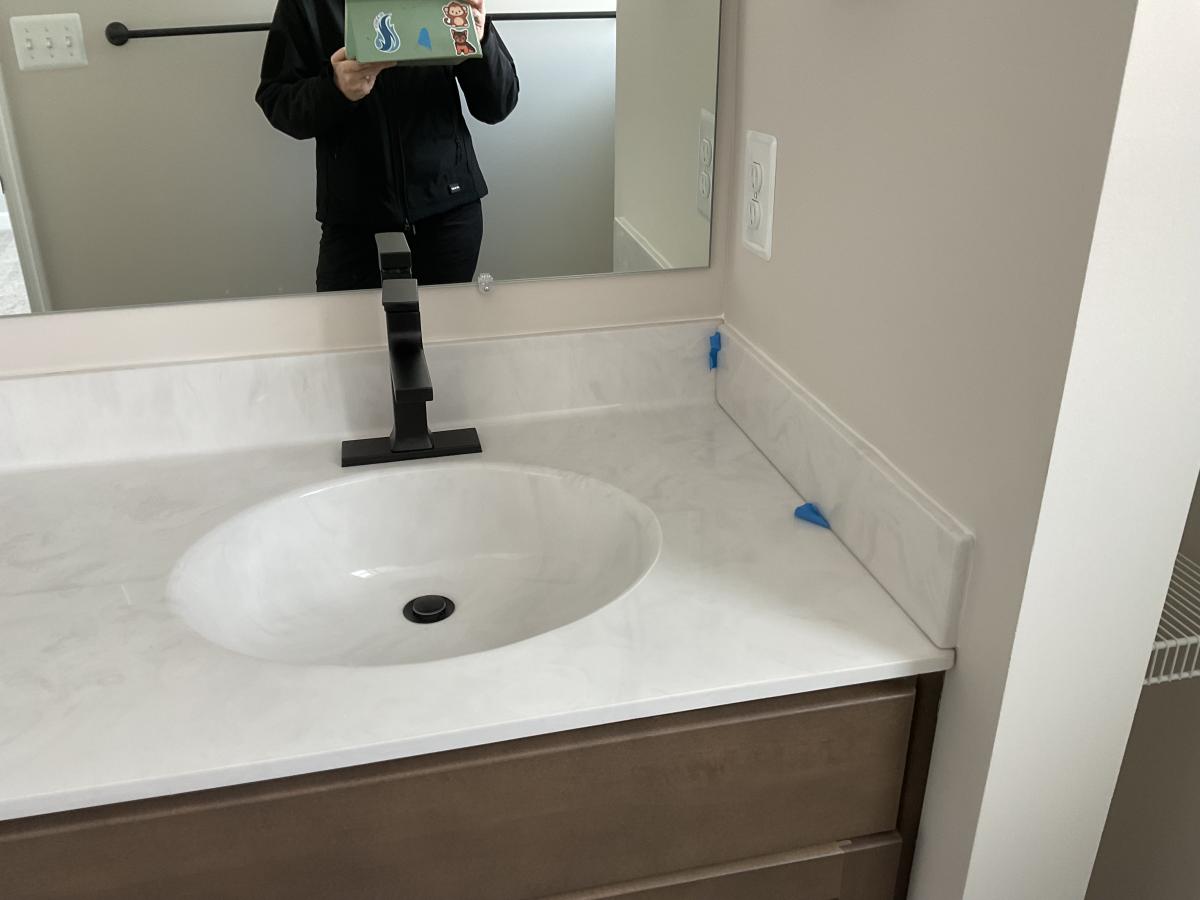

Install hall bathroom countertop |
Plumber |
|
| CL |
Jan 10 (24) |

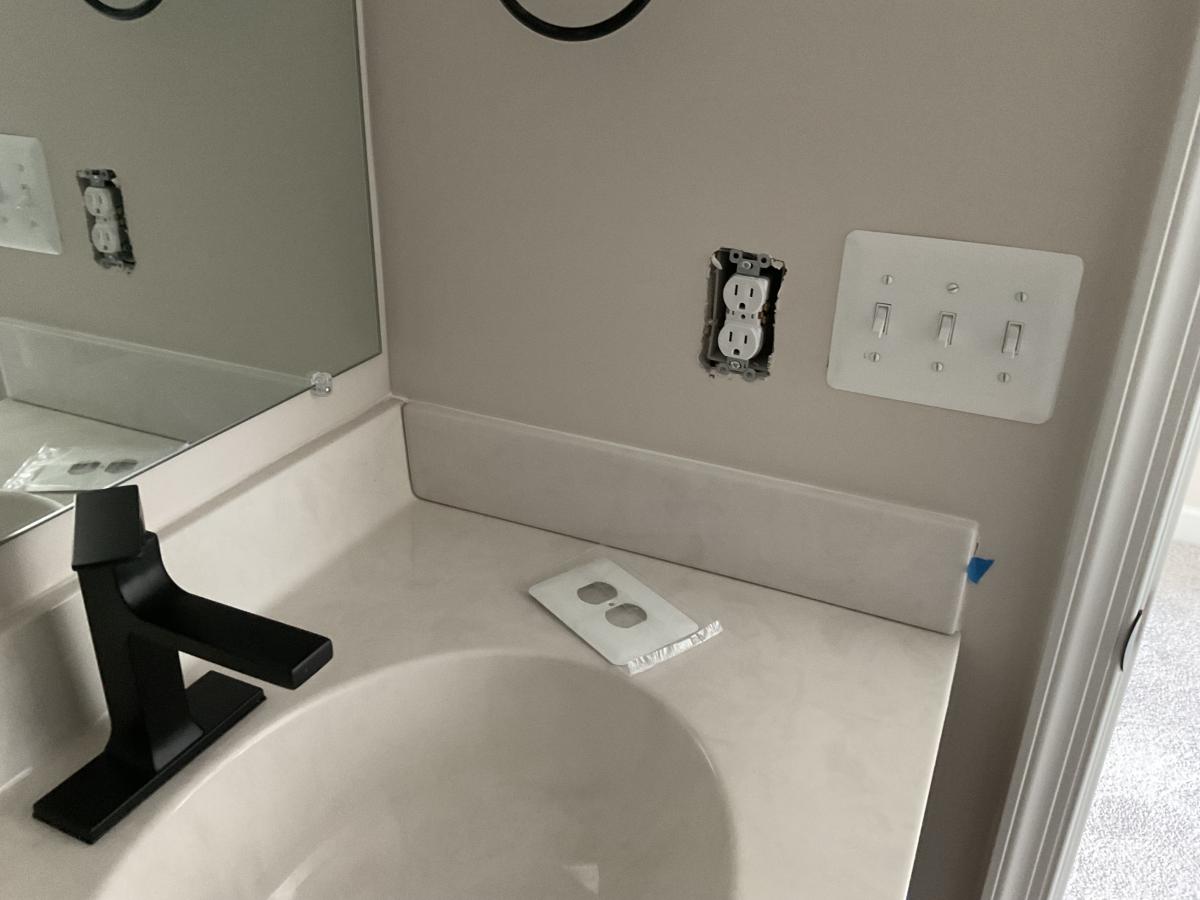

Switch plate cover is needed in hall bathroom |
Jesus, Jill |
|
| CL |
Jan 17 (17) |
Side, splash in hall bathroom needs to be installed |
Jesus - in progress 1/21 |
|
| CL |
Jan 17 (17) |

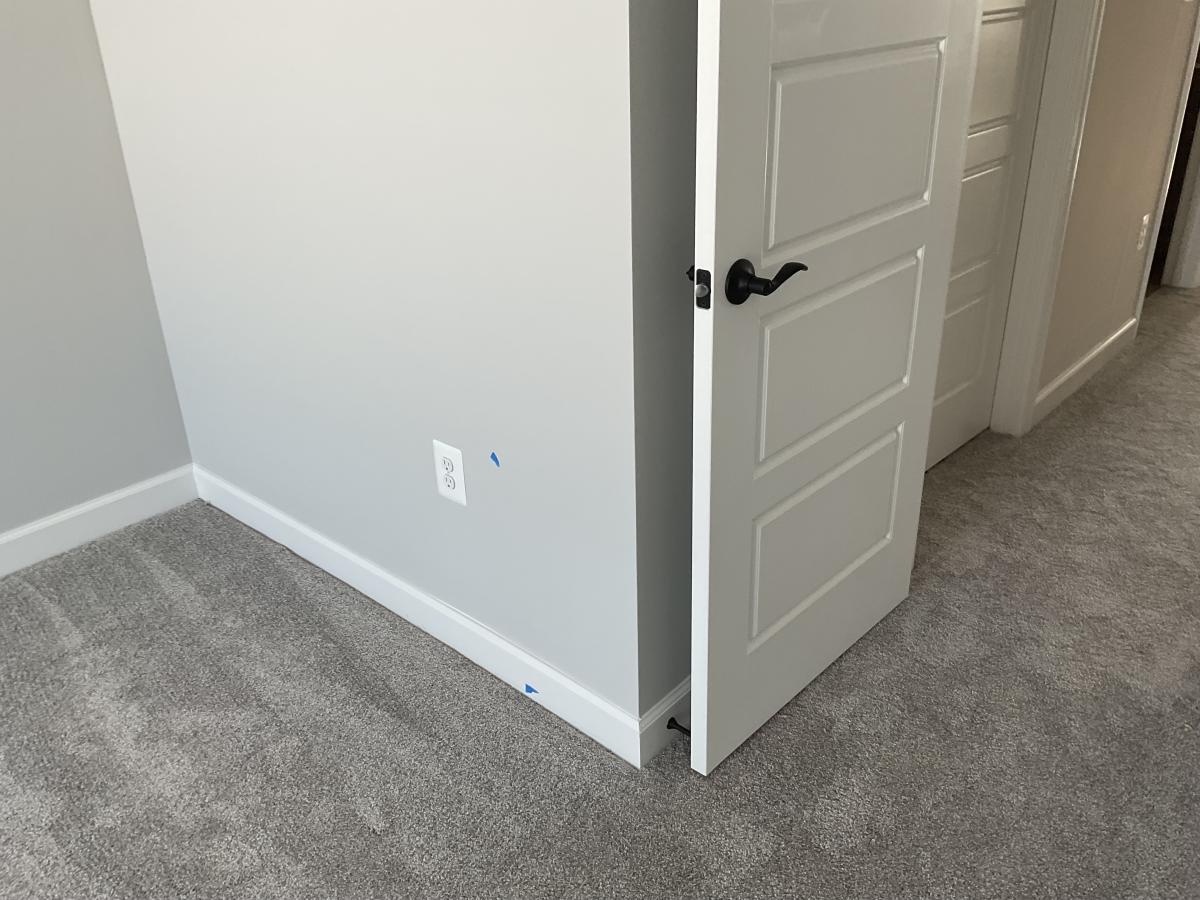

Hinge missing on smallest bedroom door |
Jesus |
|
| CL |
Jan 17 (17) |
Paint trim around the attic cover. |
Jesus |
|
| CL |
Jan 17 (17) |
Plumbing trim out needed in hall bathroom |
Plumber - in progress 1/21 |
|
| CL |
Jan 21 (13) |
Lightbulb needed in hall bathroom |
Jill |
|
| SR |
Jan 27 (7) |
Patch and paint at drywall cracks at primary bedroom ceiling |
Jesus. In process 1/28 |
|
| SR |
Jan 27 (7) |
Replace cracked window at primary bathroom window |
Tom |
|
| SR |
Jan 27 (7) |
Repair broken roof truss component in attic |
Tom |
|
| SR |
Jan 30 (4) |
Add missing hinge on small bedroom |
Jesus |
|
| SR |
Jan 30 (4) |

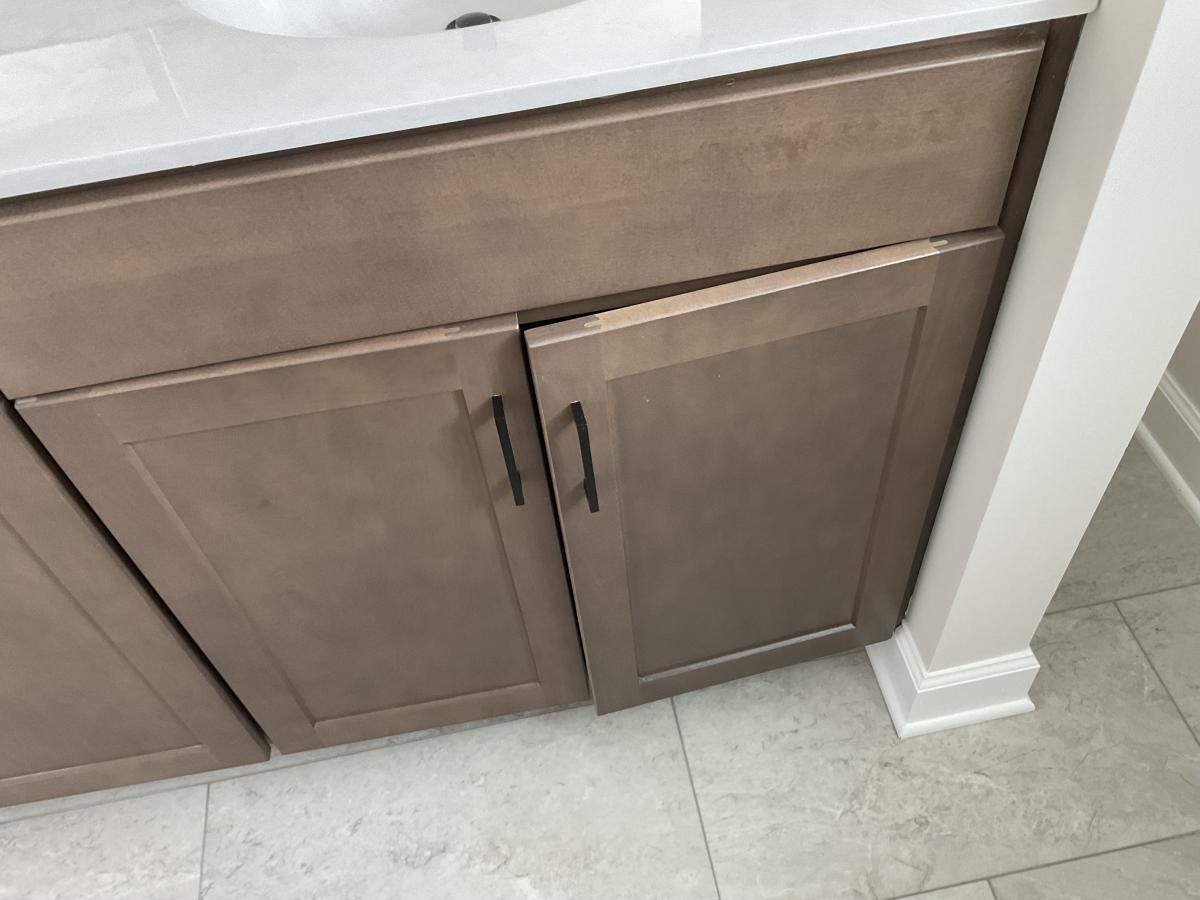

Adjust middle cabinet doors in primary bathroom so they do not collide |
Fred |
|
| CL |
Jan 31 (3) |
Caulk primary bath side splash |
Jesus |
|
| KK |
Feb 2 (1) |
Add hinge support to upstairs hall vanity |
|
|
| KK |
Feb 2 (1) |
Add hinge support primary vanity |
|
|
|
| UPGRADES - COMPLETED |
| |
|
Expanded Driveway
|
|
| |
|
Microwave vented to exterior
|
|
| |
|
Double Pull Out Waste basket
|
|
| |
|
Ceiling Fan with Light in Living Room
|
|
| |
|
Garage Door Opener Keypad
|
|
| |
|
Digital Deadbolt
|
|
| |
|
Amendment to increase price by $2,960
|
|
|
| CRITICAL PATH - COMPLETED |
| -- |
-- |
Ratified Contract? (0) 03.23.2025 |
|
|
| -- |
-- |
$2500 Deposit Received (0) 03.28.2025 |
|
|
| -- |
-- |
Association Packet Requested (0) 06.30.2025 |
|
|
| -- |
-- |
Association Packet Received (0) 04.01.2025 |
|
|
| -- |
-- |
Selections Meeting (0) 04.08.2025 |
|
|
| -- |
-- |
Selections Sheet Signed (0) 04.11.2025 |
4/8: sent to Andrea |
|
| -- |
-- |
Amendment for Upgrades (B,S,L,T,BCP) (0) 04.13.2025 |
4/10: sent to Andrea |
|
| -- |
-- |
Deposit For Upgrades Received (0) 04.11.2025 |
|
|
| -- |
-- |
Building Permit (30) * 04.11.2025 |
|
|
| -- |
-- |
Order Roof & Floor Trusses (1) 08.04.2025 |
|
|
| -- |
-- |
Order Windows & Doors (0) 09.15.2025 |
|
|
| -- |
-- |
Stake Out Home (1) 05.27.2025 |
|
|
| -- |
-- |
Excavate (2) 05.27.2025 |
|
|
| -- |
-- |
Inspection (Footers) (1) 07.31.2025 |
|
|
| -- |
-- |
Inspection (Concrete Wall) (1) 07.31.2025 |
|
|
| -- |
-- |
Pour Footers (1) * 05.27.2025 |
|
|
| -- |
-- |
Set Forms (2) 05.27.2025 |
|
|
| -- |
-- |
Pour Foundation Walls (1) 05.27.2025 |
|
|
| -- |
-- |
Plumb Slab (2) 07.31.2025 |
|
|
| -- |
-- |
Inspection (Plumbing Under Slab) (1) 07.31.2025 |
|
|
| -- |
-- |
Inspection (Conduit Under Slab) (1) 07.31.2025 |
|
|
| -- |
-- |
Prepare Slab (1) 07.31.2025 |
|
|
| -- |
-- |
Inspection (Slab) (1) 07.31.2025 |
|
|
| -- |
-- |
Inspection (Drain Tile) (0) 09.28.2025 |
|
|
| -- |
-- |
Pour Slab (1) * 07.31.2025 |
|
|
| -- |
-- |
Settlement Agent Confirmed (0) 04.18.2025 |
4/13: sent to Brittany |
|
| -- |
-- |

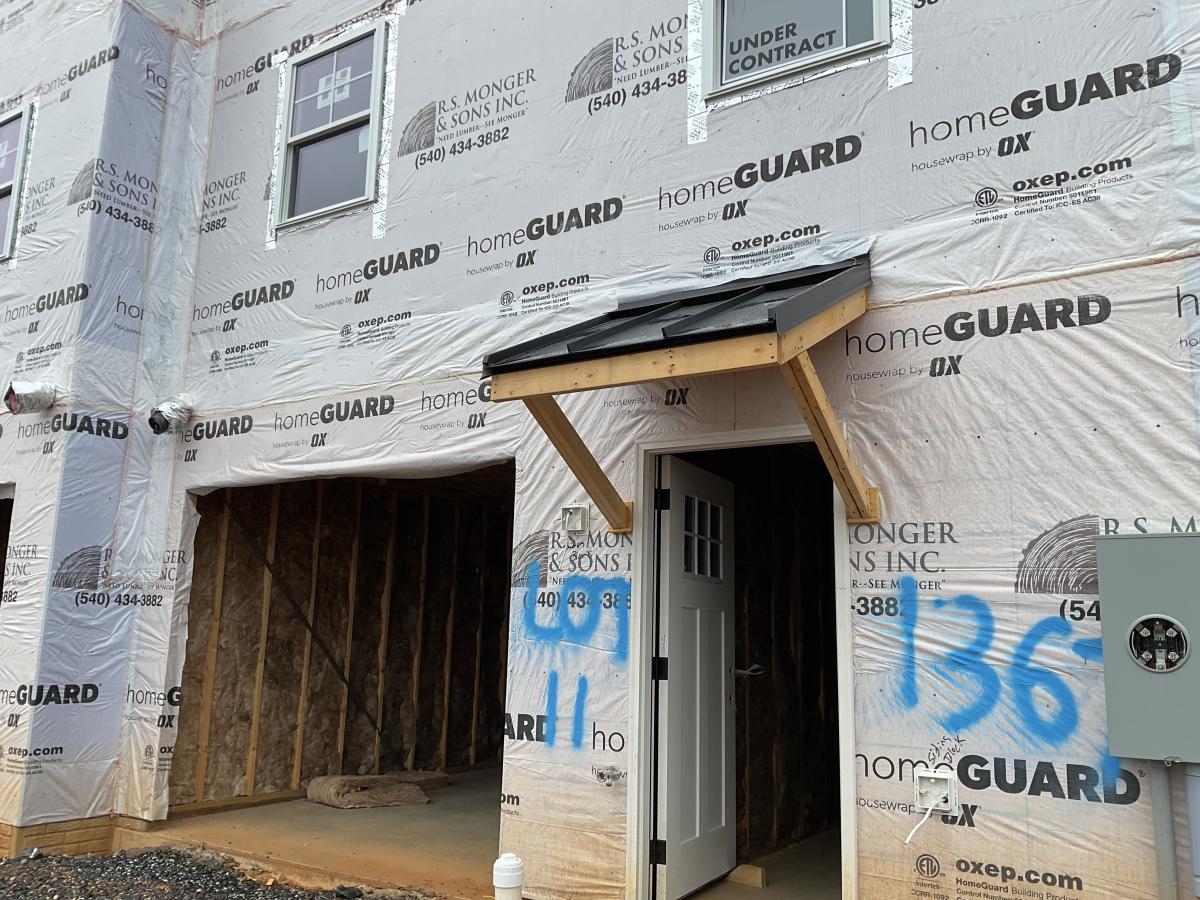

Framing I (9) 09.04.2025 |
|
|
| -- |
-- |
Order Steps (0) 09.15.2025 |
|
|
| -- |
-- |
Order Tubs / Showers (0) 09.28.2025 |
|
|
| -- |
-- |
Framing II (8) 09.17.2025 |
|
|
| -- |
-- |
Framing III (8) * 09.25.2025 |
|
|
| -- |
-- |
Verify Window & Roof Structure (0) 09.28.2025 |
|
|
| -- |
-- |
Install Stairs (0) * 09.28.2025 |
|
|
| -- |
-- |
Windows & Doors (0) * 09.28.2025 |
|
|
| -- |
-- |
House Number and Status in Window (0) 10.15.2025 |
|
|
| -- |
-- |
Roofing (0) * 09.28.2025 |
|
|
| -- |
-- |
Order Cabinets (0) 10.16.2025 |
|
|
| -- |
-- |
Order Appliances (0) 10.24.2025 |
Kate will order 11/15 for 12/15 install |
|
| -- |
-- |
Deck (0) 10.29.2025 |
None |
|
| -- |
-- |
Gutters (0) 12.06.2025 |
|
|
| -- |
-- |
Driveway (0) * 11.22.2025 |
|
|
| -- |
-- |
Patio (0) 01.10.2026 |
Standard |
|
| -- |
-- |
Sod / Seed / Landscaping (0) 01.17.2026 |
|
|
| -- |
-- |
HVAC Rough In (4) 10.04.2025 |
|
|
| -- |
-- |
Rough In Microwave Vent (0) 10.01.2025 |
|
|
| -- |
-- |
Plumbing Rough In (4) 10.08.2025 |
In process 10/4 |
|
| -- |
-- |
Electric Rough In (4) 10.15.2025 |
In process 10/11 |
|
| -- |
-- |
Inspection (Rough In HVAC) (1) 10.21.2025 |
|
|
| -- |
-- |
Inspection (Rough In Plumbing) (1) 10.21.2025 |
|
|
| -- |
-- |
Inspection (Rough In Electric) (1) 10.21.2025 |
|
|
| -- |
-- |
Inspection (Framing) (1) * 10.21.2025 |
|
|
| -- |
-- |
Inspection (Deck Piers) (0) 12.22.2025 |
|
|
| -- |
-- |
Exterior Vinyl (0) * 12.03.2025 |
|
|
| -- |
-- |
Exterior Stone (0) 12.03.2025 |
|
|
| -- |
-- |
Insulation (2) * 10.22.2025 |
|
|
| -- |
-- |
Inspection (Insulation) (1) 10.30.2025 |
|
|
| -- |
-- |
Inspection (Electric Service) (0) 10.30.2025 |
|
|
| -- |
-- |
Set Electric Meter (0) * 12.01.2025 |
|
|
| -- |
-- |
Inspection (Main Sewer Line) (0) 10.30.2025 |
|
|
| -- |
-- |
Inspection (Main Water Line) (0) 10.30.2025 |
|
|
| -- |
-- |
Order Interior Doors & Trim (0) 12.01.2025 |
|
|
| -- |
-- |
Drywall (Hang) (4) * 11.03.2025 |
|
|
| -- |
-- |
Loan Approval (0) 01.10.2026 |
JoDee @ United (96.5% FHA) |
|
| -- |
-- |
Deed Preparation (0) 01.08.2026 |
|
|
| -- |
-- |
Drywall (Tape, Block, Skim, Sand) (6) * 11.22.2025 |
In process 11/19 |
|
| -- |
-- |
Paint 1 (1) 11.28.2025 |
|
|
| -- |
-- |
Garage Door (0) 01.02.2026 |
|
|
| -- |
-- |
House Numbers (0) 01.23.2026 |
|
|
| -- |
-- |
Cabinet Installation (2) * 12.06.2025 |
In process 12/3 |
|
| -- |
-- |
Granite Installation (1) * 12.20.2025 |
|
|
| -- |
-- |
Interior Trim - Install (3) * 12.13.2025 |
In process 12/10- prepping to paint |
|
| -- |
-- |
Order Plumbing / Lighting Fixtures (0) 12.22.2025 |
|
|
| -- |
-- |
Interior Trim - Paint (1) 12.13.2025 |
|
|
| -- |
-- |

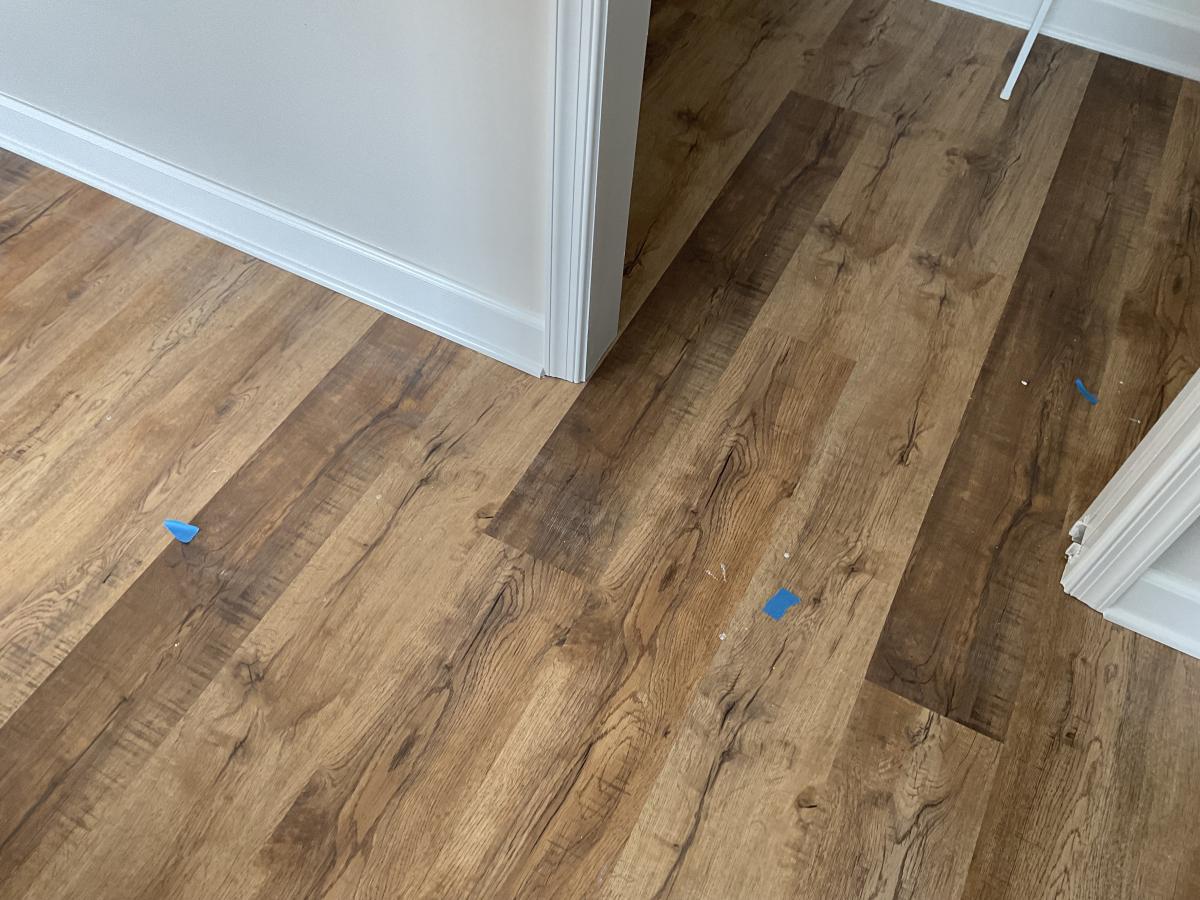

Luxury Vinyl Plank (3) * 12.20.2025 |
In process 12/17 |
|
| -- |
-- |
Luxury Vinyl Tile (0) 12.17.2025 |
|
|
| -- |
-- |
Paint 2 (3) 01.07.2026 |
|
|
| -- |
-- |
Cover Floors (0) 01.07.2026 |
|
|
| -- |
-- |
Deliver Plumbing / Lighting Fixtures (0) 12.22.2025 |
|
|
| -- |
-- |
Shoe Moulding (0) 01.07.2026 |
|
|
| -- |
-- |
Shelving, Door Knobs, Fire Extinguisher (1) * 01.21.2026 |
In process 1/17. Mirrors and shelving still needed. |
|
| -- |
-- |
Install Coded Lockbox (add extra keys) (0) 01.19.2026 |
|
|
| -- |
-- |
Pay Water / Sewer Taps (0) 01.11.2026 |
|
|
| -- |
-- |
Set Water Meter (1) * 01.12.2026 |
|
|
| -- |
-- |
Electric Trim Out (3) * 01.10.2026 |
|
|
| -- |
-- |
Ceiling Fans (0) 01.10.2026 |
|
|
| -- |
-- |
HVAC Trim Out (1) * 01.12.2026 |
All registers are needed, but heat pump and thermostat are installed |
|
| -- |
-- |
Blower Door Test (1) 01.19.2026 |
|
|
| -- |
-- |
Plumbing Trim Out (2) * 01.17.2026 |
In process 1/10 |
|
| -- |
-- |
Install Appliances (0) * 01.20.2026 |
Appliances on site January 10 |
|
| -- |
-- |
Paint 3 (2) * 01.10.2026 |
|
|
| -- |
-- |
Carpet (2) 12.20.2025 |
|
|
| -- |
-- |
Appraiser Confirms Construction Completion (0) 01.29.2026 |
Johnny Hensley - Thu, Jan 29 |
|
| -- |
-- |
Inspection (Final HVAC) (0) 01.24.2026 |
|
|
| -- |
-- |
Inspection (Final Plumbing) (0) 01.24.2026 |
|
|
| -- |
-- |
Inspection (Final Electric) (0) 01.24.2026 |
|
|
| -- |
-- |
Inspection (Final Building) (4) * 01.24.2026 |
Friday, Jan 23 |
|
| -- |
-- |
Pre Walk Through (0) 01.27.2026 |
|
|
| -- |
-- |
Stain Hardwood Stairs (1) * 01.30.2026 |
|
|
| -- |
-- |
Cleaning (1) 01.31.2026 |
|
|
| -- |
-- |
Certificate of Occupancy (1) * 01.29.2026 |
|
|
| -- |
-- |
C.O. to Lender (0) 01.29.2026 |
|
|
| -- |
-- |
Schedule Closing (0) 01.27.2026 |
|
|
| -- |
-- |
Buyer Walk Through (1) * 01.30.2026 |
Friday, Jan 30, 2:00 PM |
|
| -- |
-- |
Payment for Upgrades (0) 01.20.2026 |
|
|
| -- |
-- |
Keys to Settlement Agent (0) 01.27.2026 |
|
|
| -- |
-- |
Review Settlement Statement (0) 01.27.2026 |
|
|
| -- |
-- |
Jerry Signs Closing Documents (0) 01.09.2026 |
|
|
| -- |
-- |
Request Trash Tote From POA Manager (0) 01.27.2026 |
|
|
