| TO DO |
| SR |
Feb 14 (39) |
April 13 - rate lock expires |
|
|
| CL |
Mar 18 (7) |

Garage pad needed for garage door |
|
|
| CL |
Mar 25 (0) |

Trim bonus room doors so they can be installed and hardware put on |
|
|
| SR |
Mar 16 (9) |

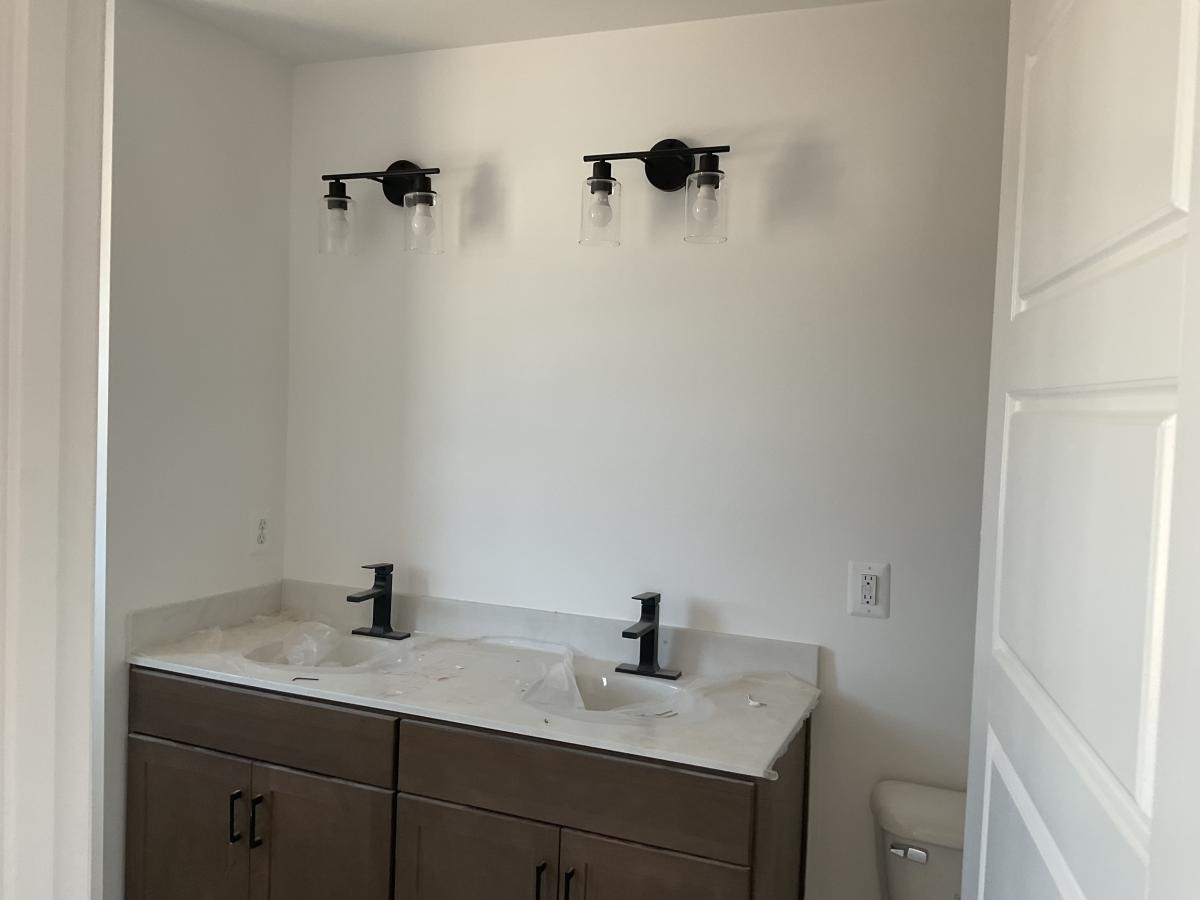

Install scribe at sides of farmhouse sink |
Jorge |
|
| CL |
Mar 21 (4) |

Make sure that the hallway lights end up both facing the same direction |
Electrician |
|
| CL |
Mar 25 (0) |

Ceiling blemish near light fixture in kitchen |
|
|
|
| UPGRADES |
| |
|

Shower door, heavy glass bypass in primary bathroom
|
|
| |
|
Stained hardwood treads to the bedroom level
|
|
| |
|
Expanded driveway
|
|
| |
|
Garage door opener with keypad
|
|
| |
|
Microwave vent into the exterior
|
|
|
| CRITICAL PATH |
|
|
|
Gutters (0) |
|
|
|
|
|

Driveway (0) * |
|
|
|
|
|
Privacy Divider / Fence (0) * |
|
|
|
|
|
Sod / Seed / Landscaping (0) |
|
|
|
|
|
Exterior Stone (0) |
In process 3/25 |
|
|
|
|
Deed Preparation (0) |
|
|
|
|
|
House Numbers (0) |
|
|
|
|
|
Mailbox (0) |
|
|
|
Wed
|
Mar 25
|
Shelving, Door Knobs, Fire Extinguisher (1) * |
In process 3/25 |
|
|
|
|
Install Coded Lockbox (add extra keys) (0) |
|
|
|
|
|
Pay Water / Sewer Taps (0) |
|
|
|
Thu
|
Mar 26
|
Set Water Meter (1) * |
|
|
|
Fri
|
Mar 27
|
Electric Trim Out (3) * |
In process 3/25. Few things need completed. |
|
|
|
|
Ceiling Fans (0) |
|
|
|
Wed
|
Apr 1
|
HVAC Trim Out (1) * |
|
|
|
Thu
|
Apr 2
|
Blower Door Test (1) |
|
|
|
Fri
|
Apr 3
|
Plumbing Trim Out (2) * |
In process 3/21 |
|
|
|
|
Install Appliances (0) * |
On site 3/14 |
|
|
Tue
|
Apr 7
|
Paint 3 (2) * |
|
|
|
|
|
Appraiser Confirms Construction Completion (0) |
|
|
|
|
|
Inspection (Final HVAC) (0) |
|
|
|
|
|
Inspection (Final Plumbing) (0) |
|
|
|
|
|
Inspection (Final Electric) (0) |
|
|
|
Thu
|
Apr 9
|
Inspection (Final Building) (4) * |
|
|
|
|
|
Pre Walk Through (0) |
|
|
|
Wed
|
Apr 15
|
Stain Hardwood Stairs (1) * |
|
|
|
Thu
|
Apr 16
|
Cleaning (1) |
|
|
|
Fri
|
Apr 17
|
Certificate of Occupancy (1) * |
|
|
|
|
|
C.O. to Lender (0) |
|
|
|
|
|
Schedule Closing (0) |
|
|
|
Mon
|
Apr 20
|
Buyer Walk Through (1) * |
|
|
|
|
|
Payment for Upgrades (0) |
|
|
|
|
|
Keys to Settlement Agent (0) |
|
|
|
|
|
Review Settlement Statement (0) |
|
|
|
|
|
Jerry Signs Closing Documents (0) |
|
|
|
|
|
Request Trash Tote From POA Manager (0) |
|
|
|
Tue
|
Apr 21
|
Closing (1) |
Brittany @ West View Title |
|
|
|
|
Remove Coded Lockbox (0) |
|
|
|
| TO DO - COMPLETED OR DELETED |
|
|
No window in bonus room |
|
|
|
|
Hardwood treads are not installed going up to the bedroom level |
On site 11/19 |
|
|
|
Back kitchen window is missing |
On site 11/19 |
|
|
|
I’m assuming this one got a dormer window |
|
|
|
|
This townhouse needs a bathtub in the bonus bathroom |
In garage |
|
| SR |
Jan 6 (78) |
We need cabinet specs from Kate for BCP |
|
|
| LR |
Mar 10 (15) |

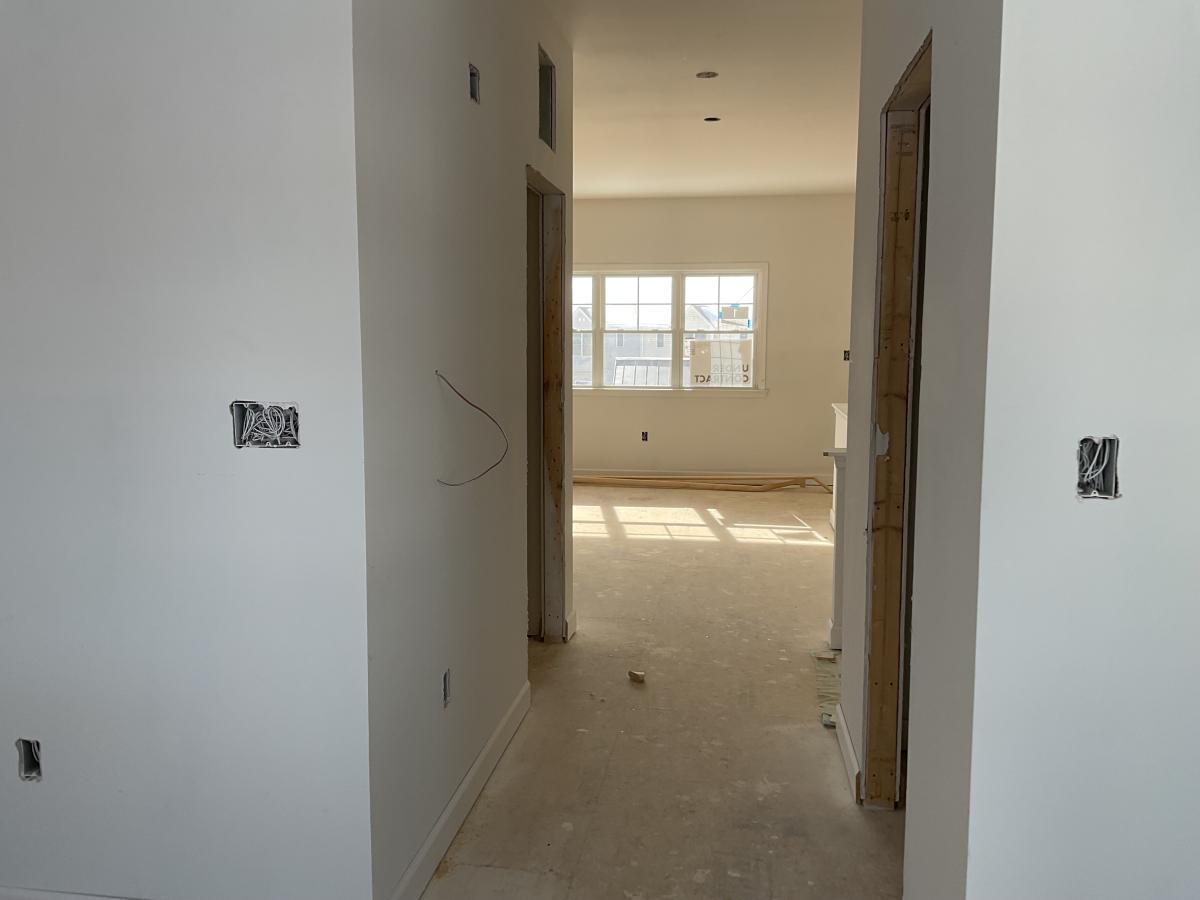

Consult drywaller about mud in electrical boxes |
Jill. They seem to have repaired the walls, but the ceilings need to also be addressed. |
|
| SR |
Mar 19 (6) |
Sand and paint patched drywall cracks |
Jesus |
|
| SR |
Mar 19 (6) |
Add dryer vent cover on side of townhouse |
Davenport |
|
| CL |
Feb 7 (46) |
Lots of ceiling drywall cracking |
Mostly in bonus room |
|
| LR |
Mar 10 (15) |
Repair cracked drywall on ceiling of bonus room |
Jesus |
|
| SR |
Mar 16 (9) |
Paint ceiling of bonus room at patched drywall patches |
Jesus |
|
| CL |
Mar 14 (11) |
Paint 2 needed in bonus room. |
Jesus |
|
|
|
Remove extra set of stairs in the living room |
Tom |
|
| CL |
Jan 17 (67) |
Is this framed for a 12x18 patio? |
not yet 1/24 |
|
| CL |
Jan 17 (67) |
Is there a farmhouse sink on site? |
Kate ordered 1/19, arriving Thursday, Jan 22 |
|
| SR |
Feb 2 (51) |
Missing kitchen window sash |
Tom |
|
| CL |
Feb 18 (35) |
Side pieces are going to need to be ordered for the farmhouse sink |
Scribe - Jorge |
|
| CL |
Mar 18 (7) |
Cracked siding on side of house |
|
|
| CL |
Jan 17 (67) |

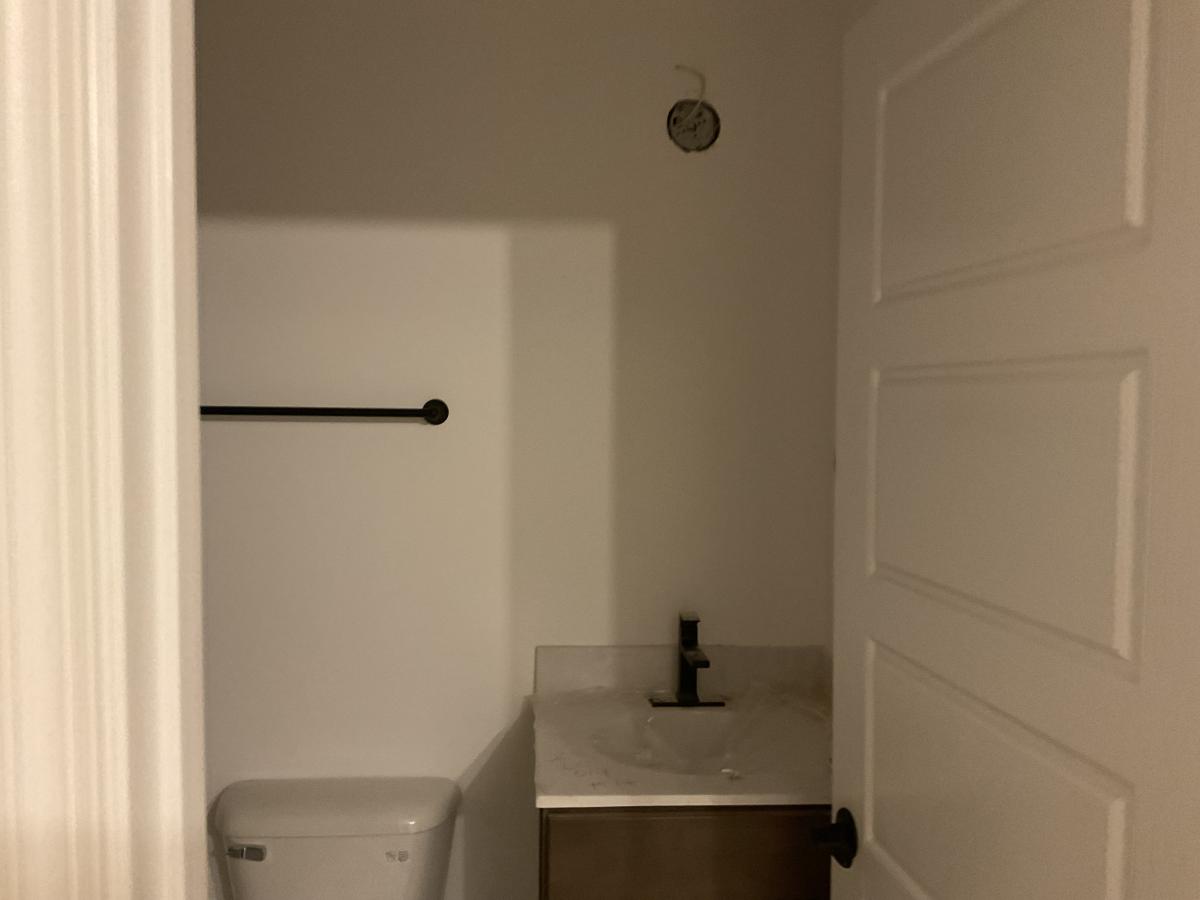

Side splash Missing in hall bathroom |
Tom, left hand |
|
| CL |
Mar 4 (21) |
These folks had upgraded lvt. Right? |
|
|
| CL |
Mar 7 (18) |
Drywaller has made it very difficult for the electrician to come in and do their work on a few electrical boxes. I think it’s reasonable to have them come back and fix it to make it easier. |
|
|
| CL |
Mar 11 (14) |
Cover carpets |
|
|
|
| UPGRADES - COMPLETED |
| |
|
Gray subway tile shower walls
|
|
| |
|
Luxury vinyl plank in upstairs hallway
|
|
| |
|
Upgraded Carpet Upstairs Bedrooms
|
|
| |
|
Upgraded carpet pad, bedrooms
|
|
| |
|
Upgraded Carpet bonus room
|
|
| |
|
Upgraded carpet pad, bonus room
|
|
| |
|
Digital deadbolt
|
|
| |
|
Finished bonus room in ground
|
|
| |
|
Finished bonus bathroom
|
|
| |
|
Extended 12 x 18 patio
|
|
| |
|
White kitchen cabinetry
|
|
| |
|
Coffee bar with glass shelving crown molding and Level 3 Quartz
|
|
| |
|
Farmhouse sink
|
|
| |
|
Three drawer base 36
|
|
| |
|
Double pull out trash cans
|
|
| |
|
French model refrigerator
|
|
| |
|
Level 3 Quartz- Kitchen
|
|
| |
|
Amendment to increase price by $38,973
|
|
|
| CRITICAL PATH - COMPLETED |
| -- |
-- |
Ratified Contract? (0) 08.05.2025 |
|
|
| -- |
-- |
$2500 Deposit Received (0) 08.10.2025 |
|
|
| -- |
-- |
Association Packet Requested (0) 08.05.2025 |
|
|
| -- |
-- |
Association Packet Received (0) 08.10.2025 |
|
|
| -- |
-- |
Selections Meeting (0) 09.05.2025 |
|
|
| -- |
-- |
Selections Sheet Signed (0) 09.06.2025 |
9/4: sent to Luke |
|
| -- |
-- |
Amendment for Upgrades (B,S,L,T,BCP) (0) 09.12.2025 |
9/6: Sent to Luke |
|
| -- |
-- |
Deposit For Upgrades Received (0) 09.12.2025 |
|
|
| -- |
-- |

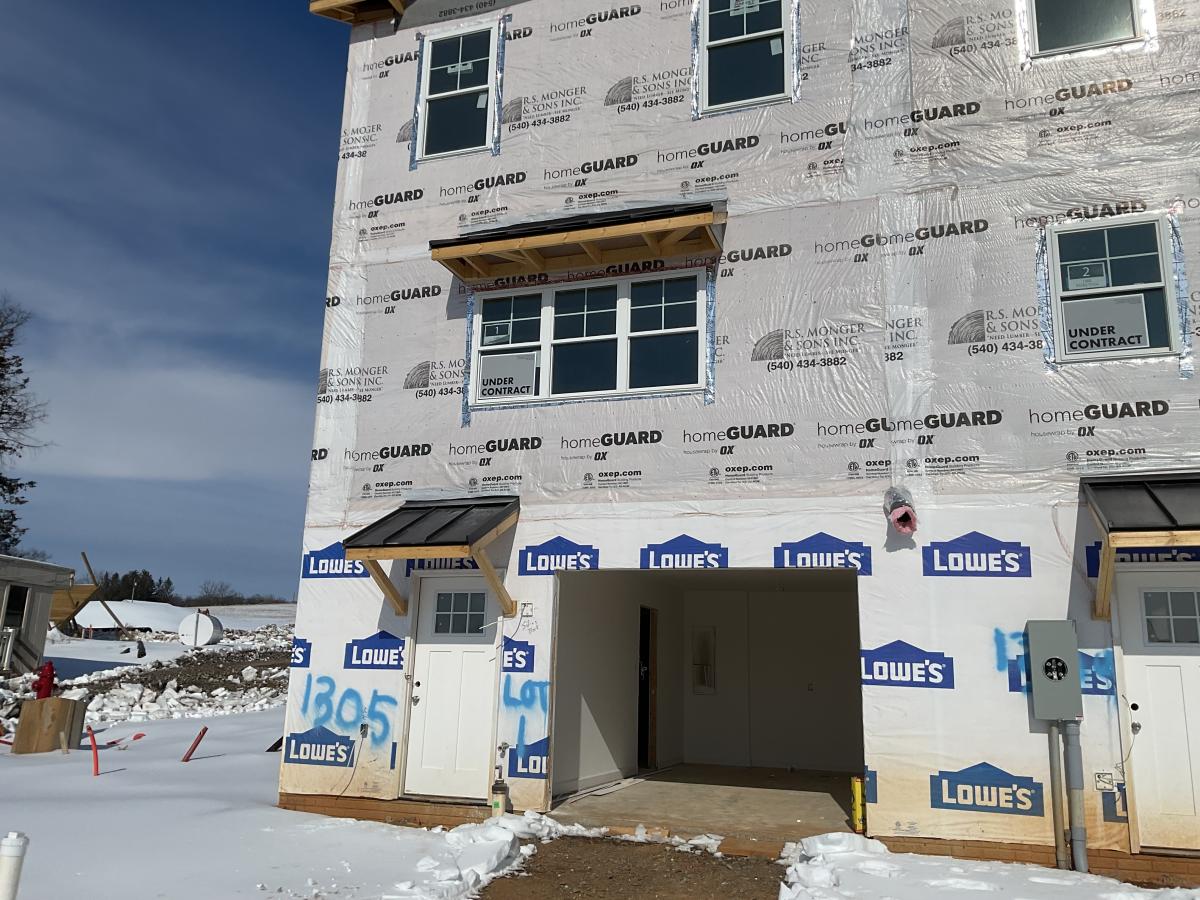

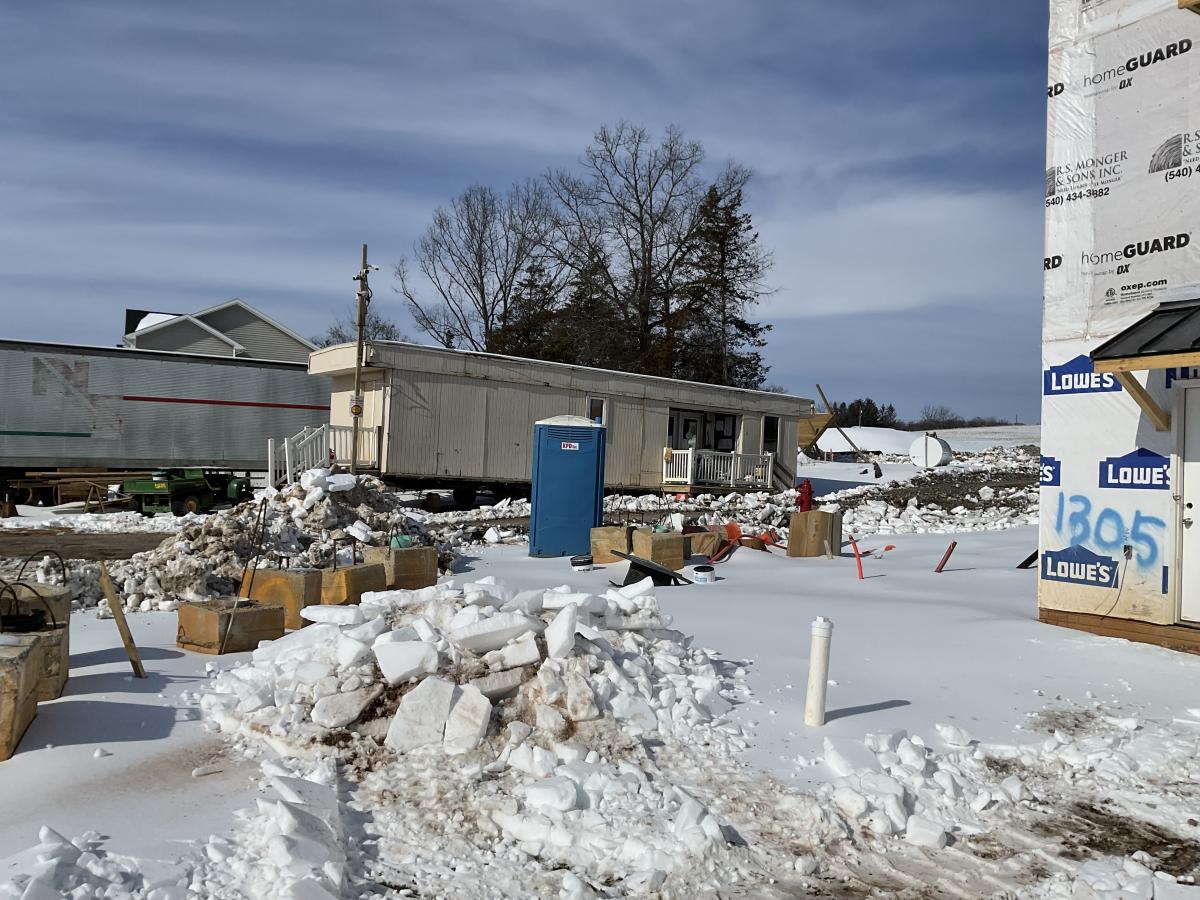

Building Permit (30) * 05.24.2025 |
|
|
| -- |
-- |
Order Roof & Floor Trusses (1) 09.25.2025 |
|
|
| -- |
-- |
Order Windows & Doors (0) 10.23.2025 |
|
|
| -- |
-- |
Stake Out Home (1) 05.29.2025 |
|
|
| -- |
-- |

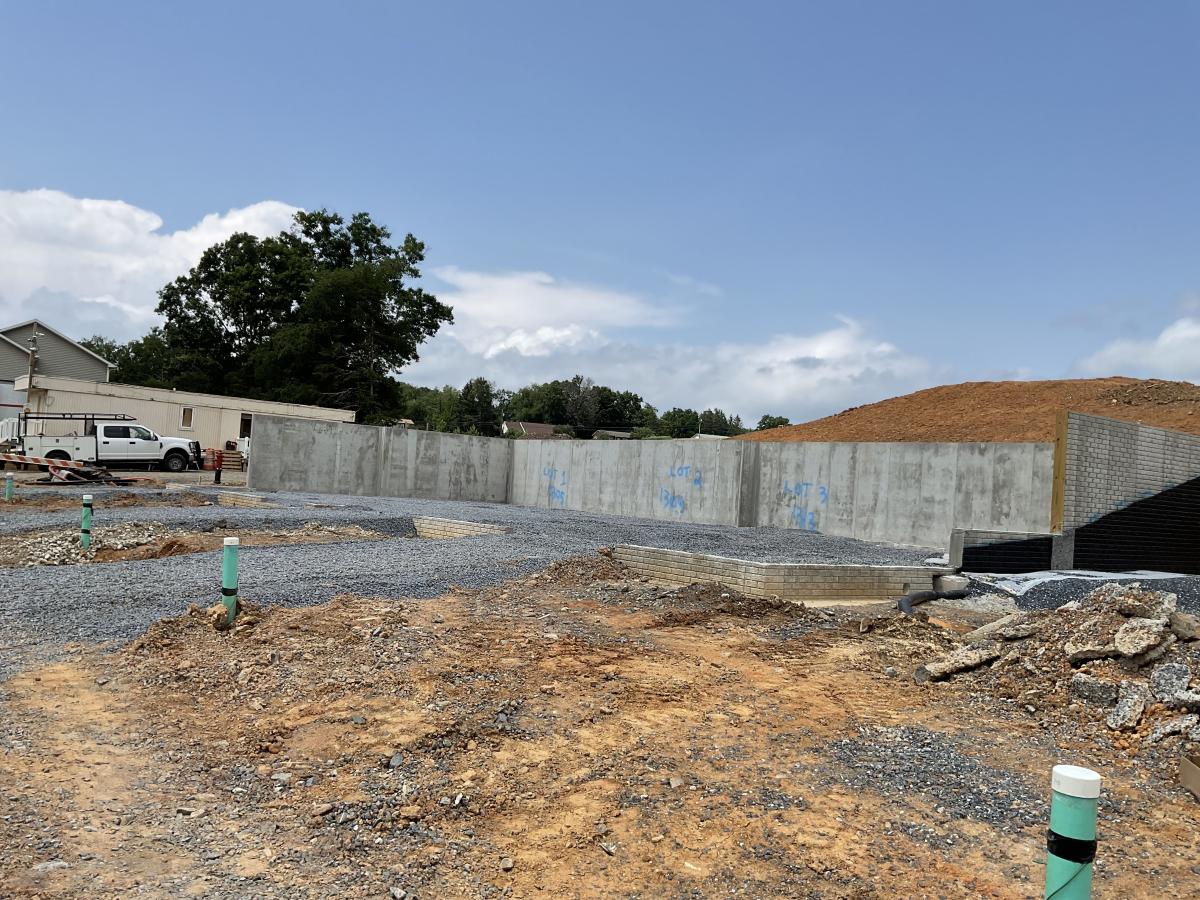

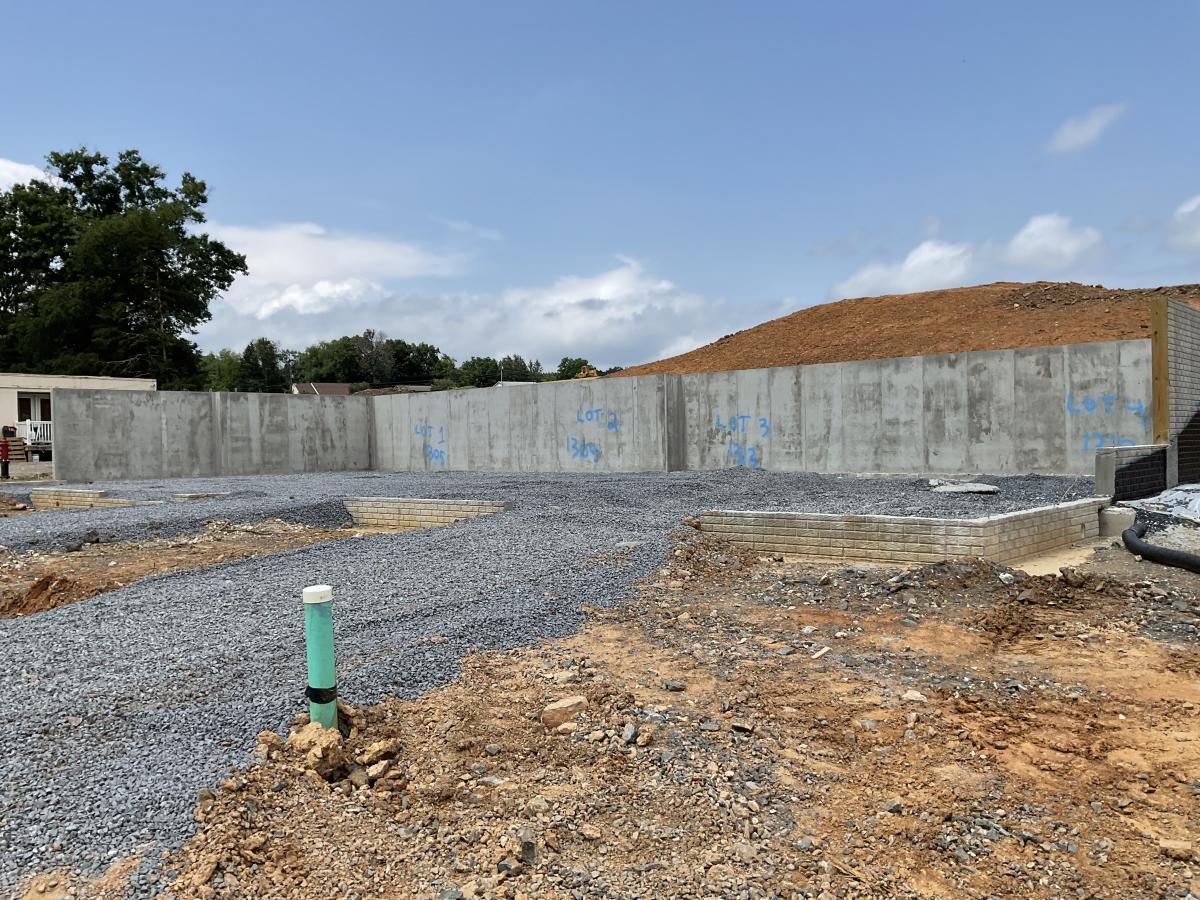

Excavate (2) 05.29.2025 |
|
|
| -- |
-- |
Inspection (Footers) (1) 06.02.2025 |
|
|
| -- |
-- |
Inspection (Concrete Wall) (1) 07.31.2025 |
|
|
| -- |
-- |
Pour Footers (1) * 06.02.2025 |
|
|
| -- |
-- |
Set Forms (2) 06.05.2025 |
|
|
| -- |
-- |
Pour Foundation Walls (1) 07.31.2025 |
|
|
| -- |
-- |
Plumb Slab (2) 07.31.2025 |
|
|
| -- |
-- |
Inspection (Plumbing Under Slab) (1) 09.28.2025 |
|
|
| -- |
-- |
Inspection (Conduit Under Slab) (1) 09.28.2025 |
|
|
| -- |
-- |
Prepare Slab (1) 09.04.2025 |
|
|
| -- |
-- |
Inspection (Slab) (1) 09.28.2025 |
|
|
| -- |
-- |
Inspection (Drain Tile) (0) 09.28.2025 |
|
|
| -- |
-- |
Pour Slab (1) * 09.28.2025 |
|
|
| -- |
-- |
Settlement Agent Confirmed (0) 09.20.2025 |
|
|
| -- |
-- |

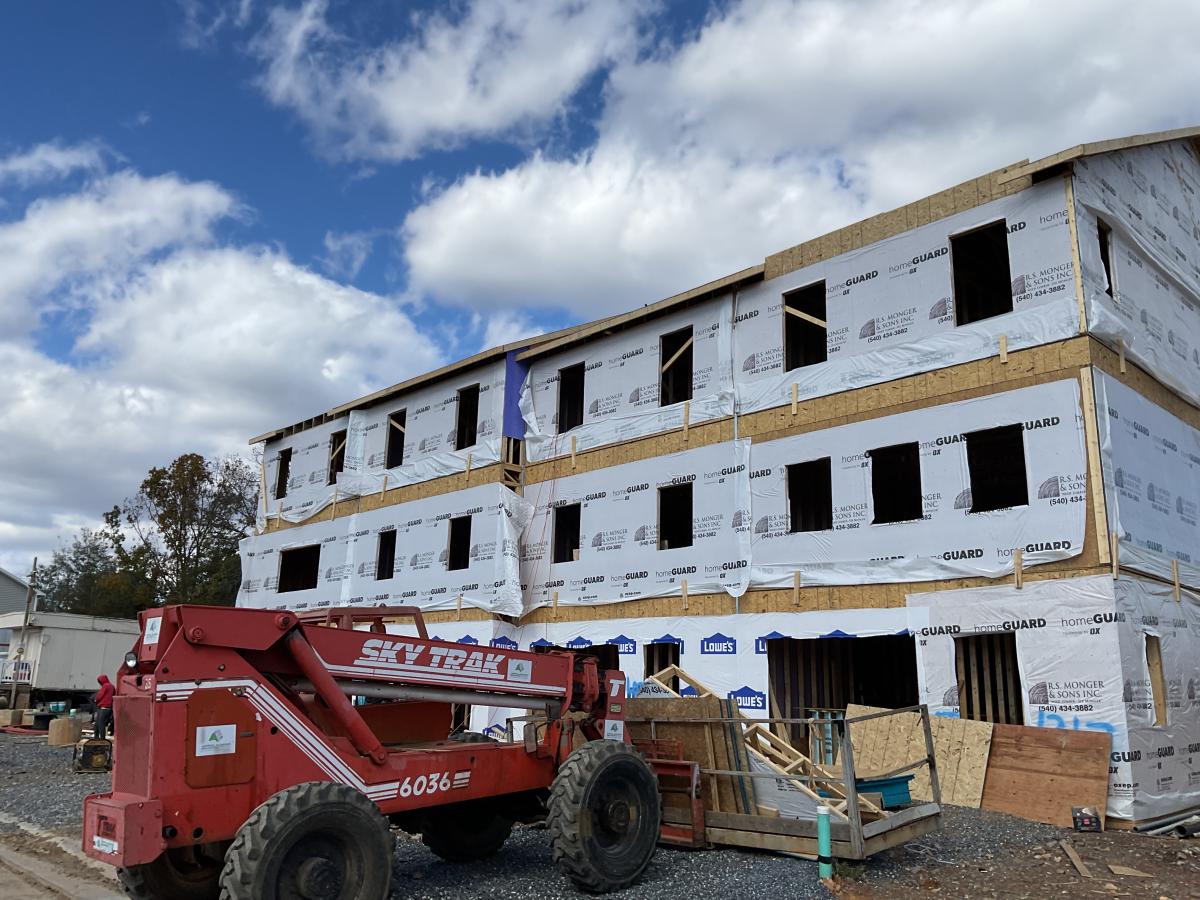

Framing I (9) 10.09.2025 |
|
|
| -- |
-- |
Order Steps (0) 10.23.2025 |
|
|
| -- |
-- |
Order Tubs / Showers (0) 11.12.2025 |
|
|
| -- |
-- |
Framing II (8) 10.31.2025 |
|
|
| -- |
-- |
Framing III (8) * 11.12.2025 |
|
|
| -- |
-- |
Verify Window & Roof Structure (0) 11.12.2025 |
|
|
| -- |
-- |
Install Stairs (0) * 11.12.2025 |
|
|
| -- |
-- |
Windows & Doors (0) * 11.12.2025 |
|
|
| -- |
-- |
House Number and Status in Window (0) 12.03.2025 |
|
|
| -- |
-- |
Roofing (0) * 11.22.2025 |
|
|
| -- |
-- |
Order Cabinets (0) 01.07.2026 |
|
|
| -- |
-- |
Order Appliances (0) 03.14.2026 |
|
|
| -- |
-- |
Deck (0) 01.04.2026 |
|
|
| -- |
-- |
Patio (0) 03.10.2026 |
|
|
| -- |
-- |

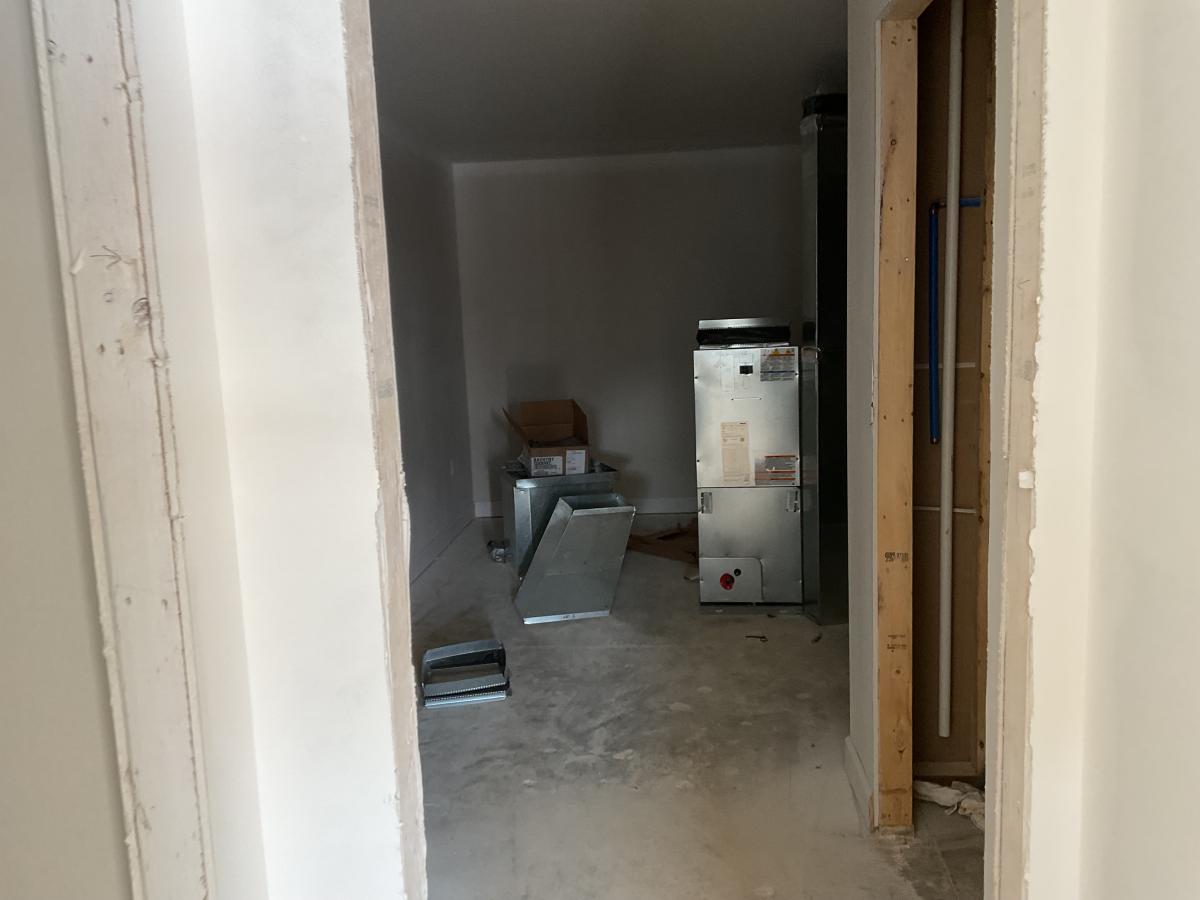

HVAC Rough In (4) 11.12.2025 |
|
|
| -- |
-- |
Rough In Microwave Vent (0) 11.12.2025 |
|
|
| -- |
-- |
Plumbing Rough In (4) 11.19.2025 |
In process 11/12 |
|
| -- |
-- |
Electric Rough In (4) 12.03.2025 |
In process 11/28 |
|
| -- |
-- |
Inspection (Rough In HVAC) (1) 12.08.2025 |
|
|
| -- |
-- |
Inspection (Rough In Plumbing) (1) 12.08.2025 |
|
|
| -- |
-- |
Inspection (Rough In Electric) (1) 12.08.2025 |
|
|
| -- |
-- |
Inspection (Framing) (1) * 12.08.2025 |
|
|
| -- |
-- |
Inspection (Deck Piers) (0) 01.04.2026 |
|
|
| -- |
-- |

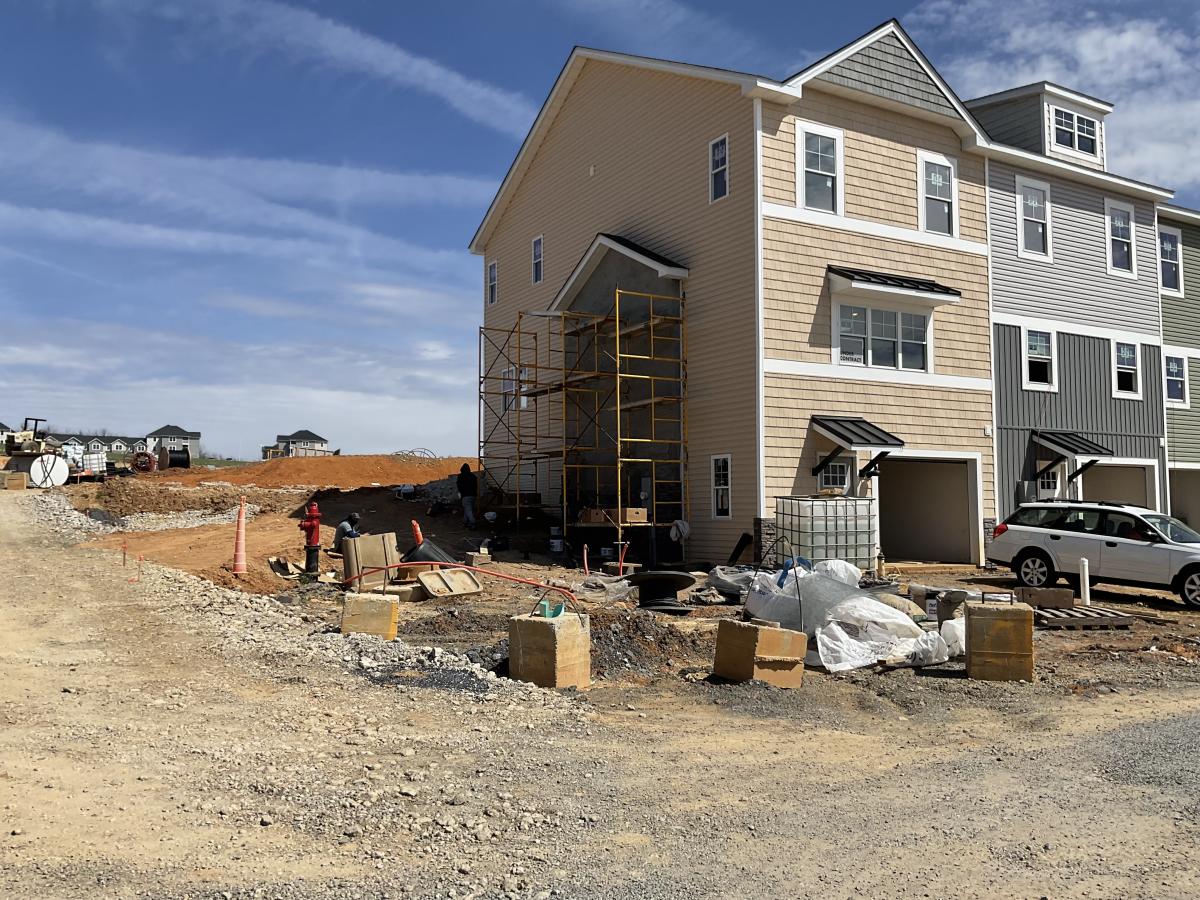

Exterior Vinyl (0) * 03.18.2026 |
Side of house missing a section 3/11 |
|
| -- |
-- |
Insulation (2) * 12.15.2025 |
|
|
| -- |
-- |
Inspection (Insulation) (1) 12.15.2025 |
|
|
| -- |
-- |
Inspection (Electric Service) (0) 01.12.2026 |
|
|
| -- |
-- |
Set Electric Meter (0) * 03.05.2026 |
|
|
| -- |
-- |
Inspection (Main Sewer Line) (0) 01.05.2026 |
|
|
| -- |
-- |
Inspection (Main Water Line) (0) 01.05.2026 |
|
|
| -- |
-- |
Order Interior Doors & Trim (0) 01.12.2026 |
|
|
| -- |
-- |

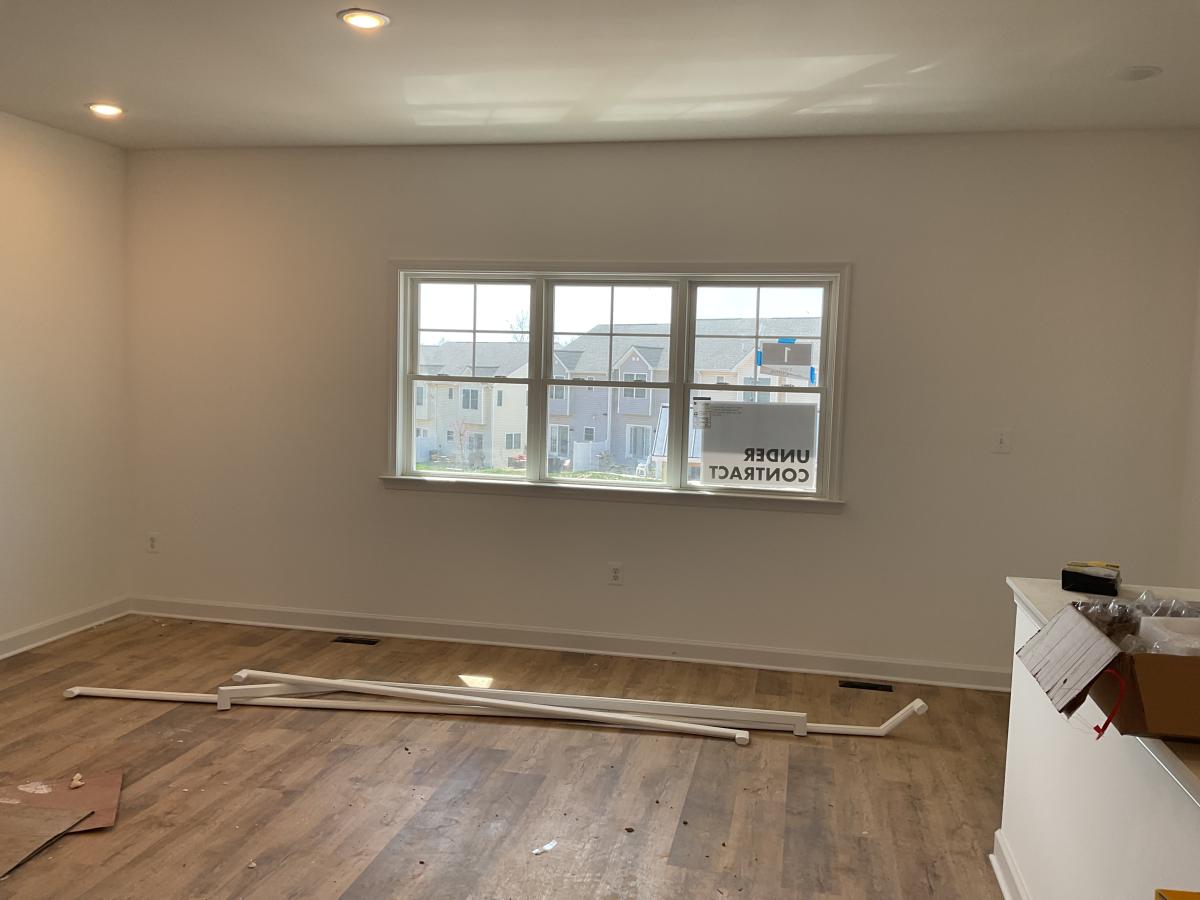

Drywall (Hang) (4) * 12.20.2025 |
|
|
| -- |
-- |
Loan Approval (0) 01.10.2026 |
JoDee @ United (96.5% FHA) |
|
| -- |
-- |
Drywall (Tape, Block, Skim, Sand) (6) * 01.10.2026 |
In process 1/7 |
|
| -- |
-- |
Paint 1 (1) 01.14.2026 |
|
|
| -- |
-- |
Garage Door (0) 03.18.2026 |
|
|
| -- |
-- |

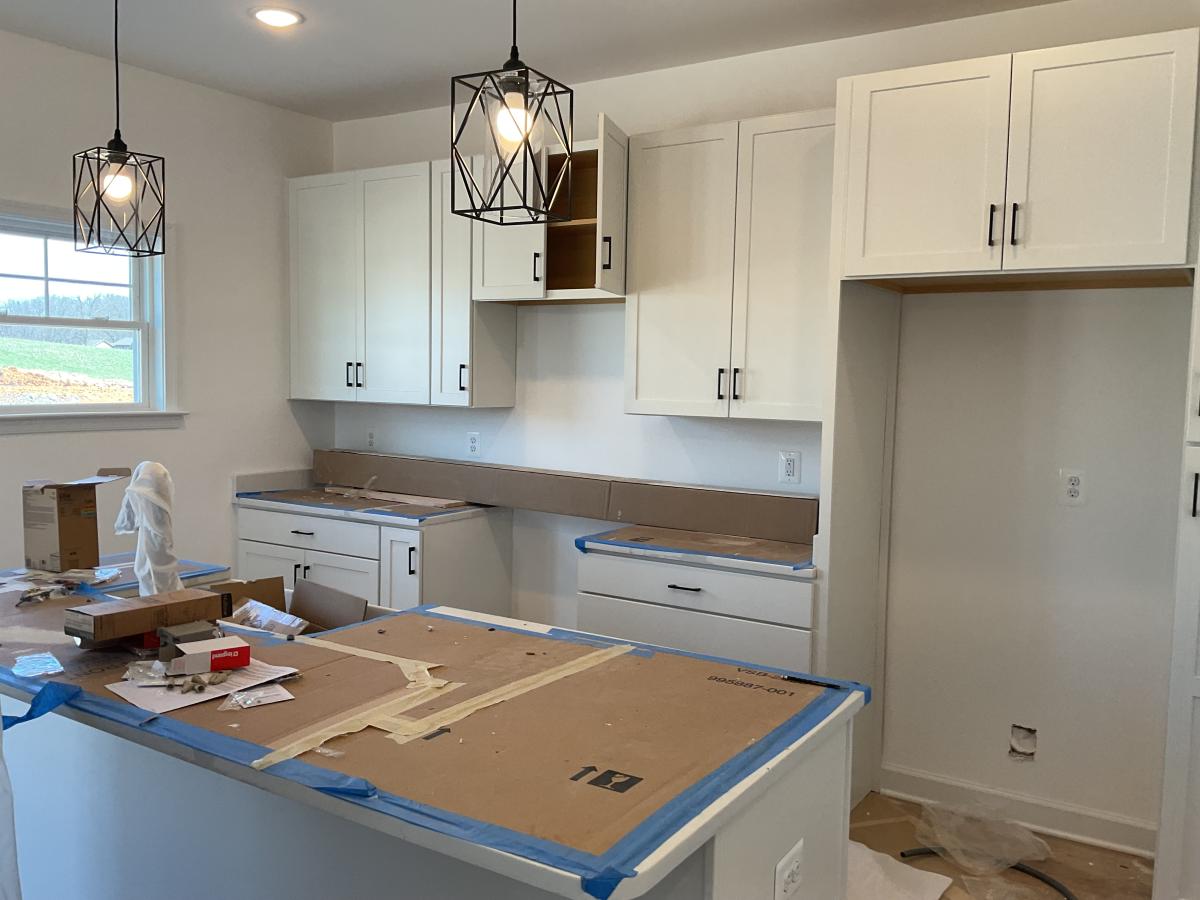

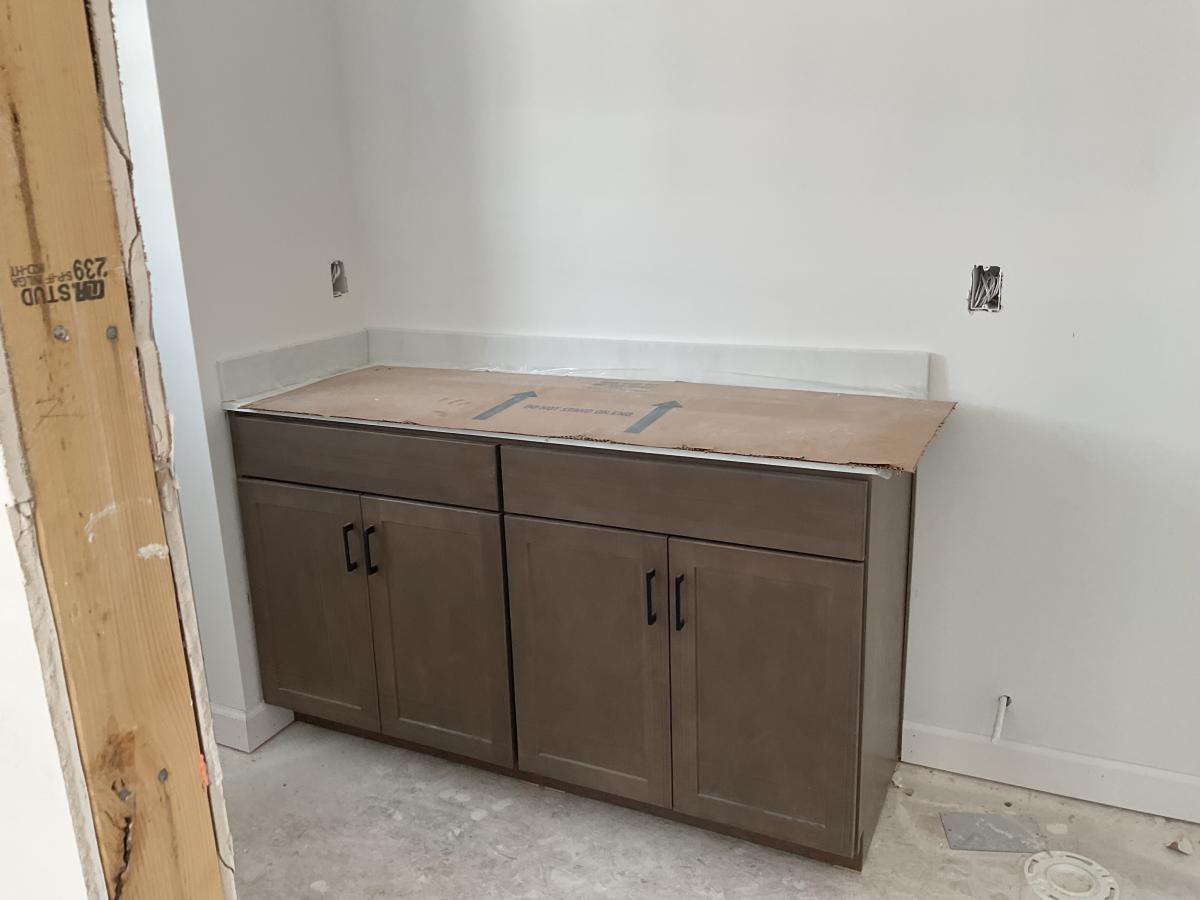

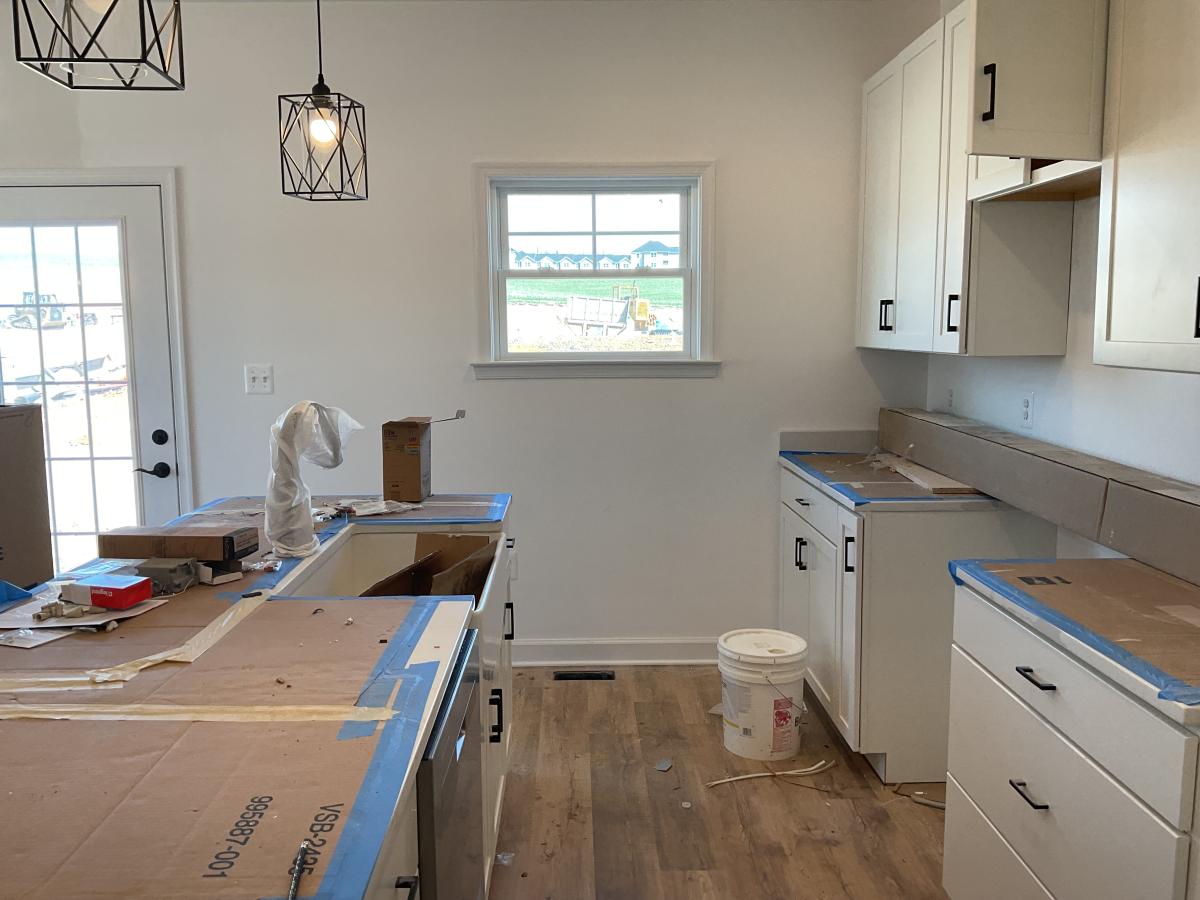

Cabinet Installation (2) * 01.17.2026 |
|
|
| -- |
-- |
Granite Installation (1) * 02.18.2026 |
|
|
| -- |
-- |
Interior Trim - Install (3) * 02.14.2026 |
Floor and window trim has been installed, just need doors |
|
| -- |
-- |
Order Plumbing / Lighting Fixtures (0) 02.16.2026 |
|
|
| -- |
-- |
Interior Trim - Paint (1) 02.25.2026 |
|
|
| -- |
-- |
Luxury Vinyl Plank (3) * 03.07.2026 |
|
|
| -- |
-- |
Luxury Vinyl Tile (0) 03.04.2026 |
|
|
| -- |
-- |
Paint 2 (3) 03.14.2026 |
|
|
| -- |
-- |
Cover Floors (0) 03.25.2026 |
|
|
| -- |
-- |
Deliver Plumbing / Lighting Fixtures (0) 03.23.2026 |
|
|
| -- |
-- |
Shoe Moulding (0) 03.14.2026 |
|
|
| -- |
-- |
Carpet (2) 03.11.2026 |
In process 3/7 |
|
