| TO DO |
| SR |
Jan 19 (15) |
Owner is Alexis Gomez Ramirez at 540-214-7230 |
|
|
|
| UPGRADES |
| --- |
|
| CRITICAL PATH |
|
|
|
Remove Coded Lockbox (0) |
|
|
|
| TO DO - COMPLETED OR DELETED |
|
|
|
|
|
|
|
Frame out concrete block that’s at the bottom of the staircase |
|
|
|
|

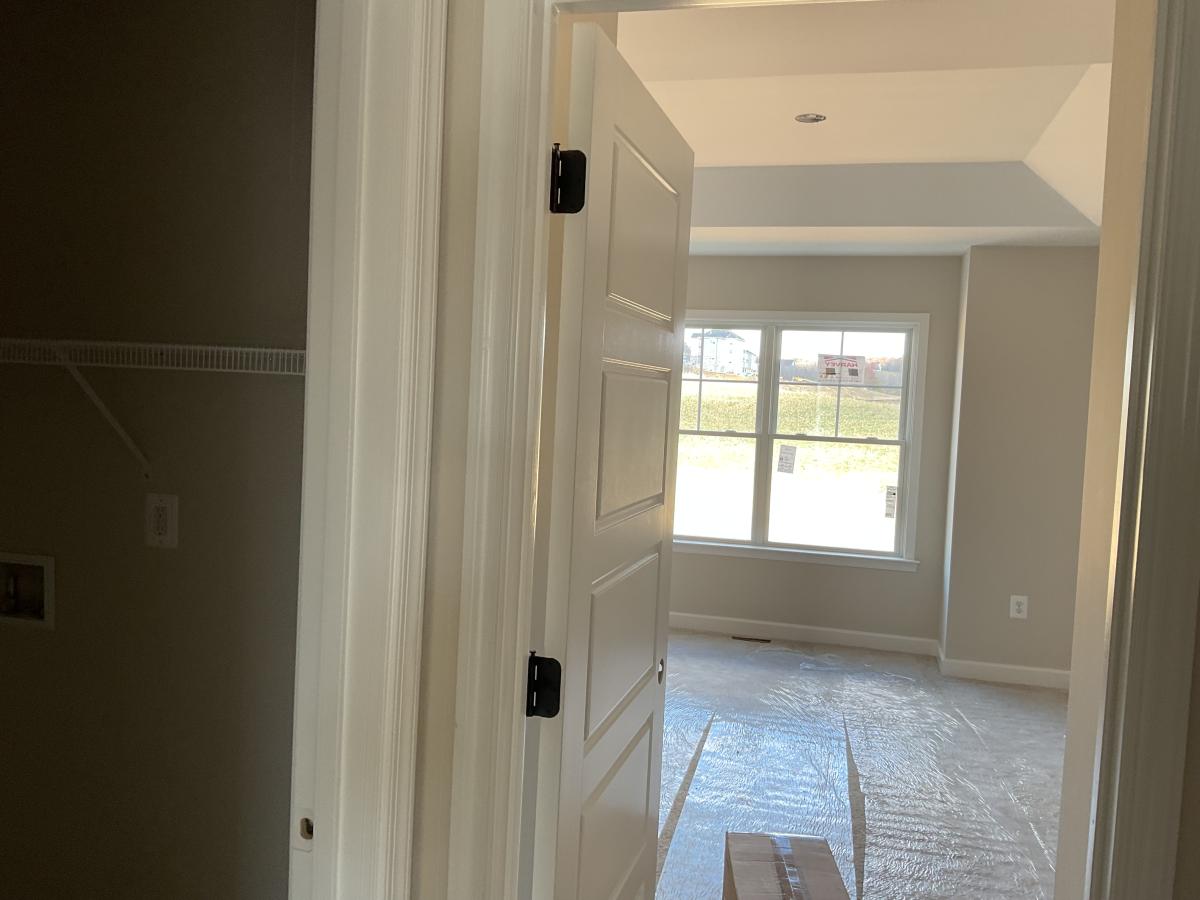

Door needs installed in bonus room |
|
|
|
|
Cover carpet 10/15 |
|
|
|
|
Side and backsplash is missing on kitchen countertop |
Fenco |
|
|
|

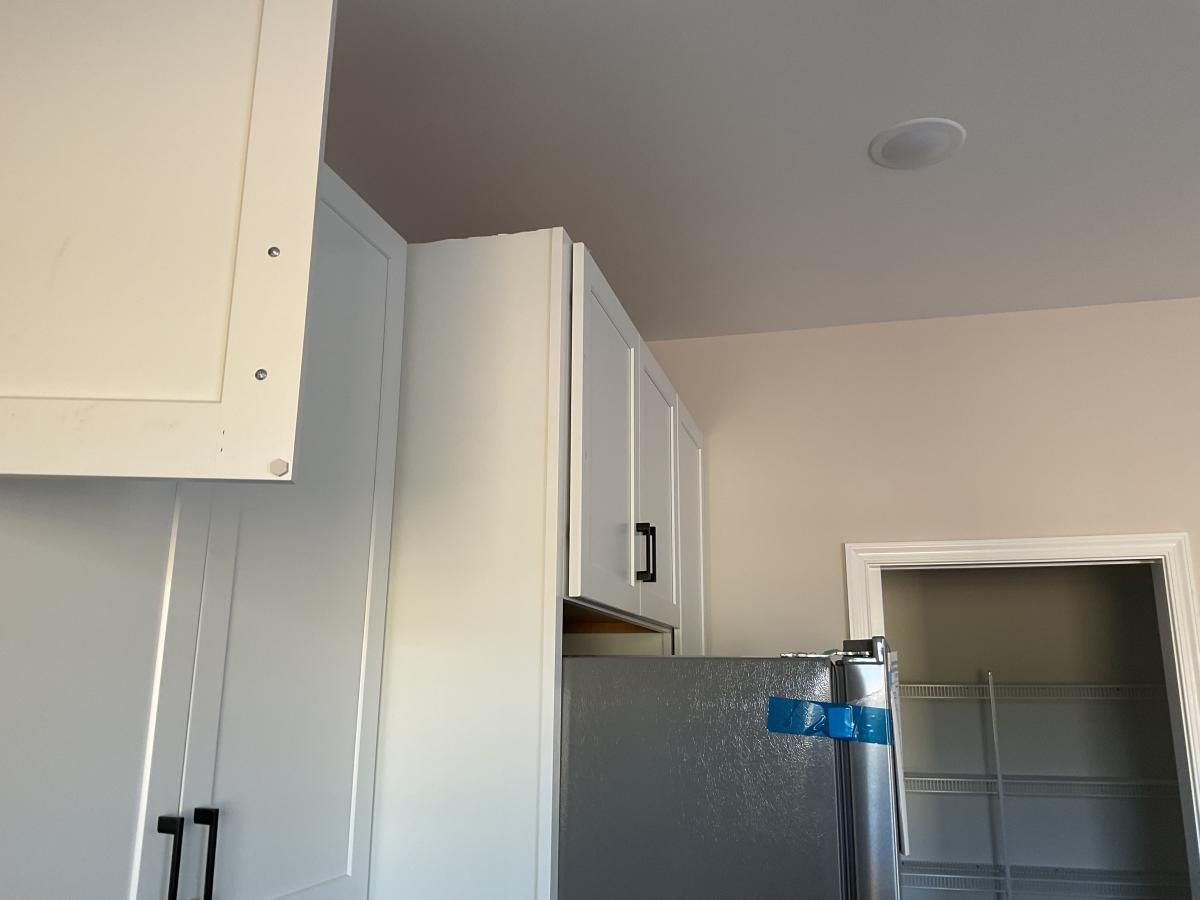

Top corner of the cabinet above the refrigerator appears to look unfinished. |
Fred - on order. Fixing 12/3 |
|
|
|

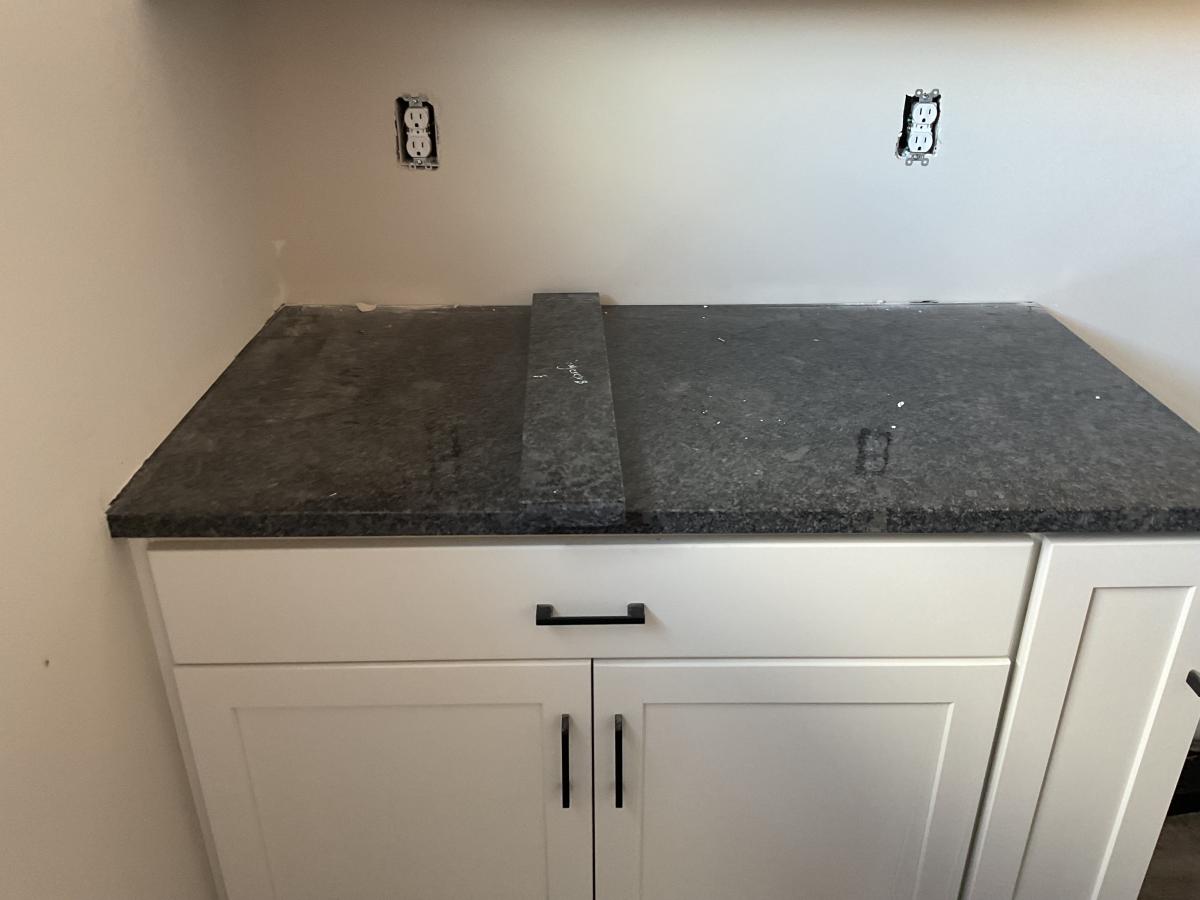

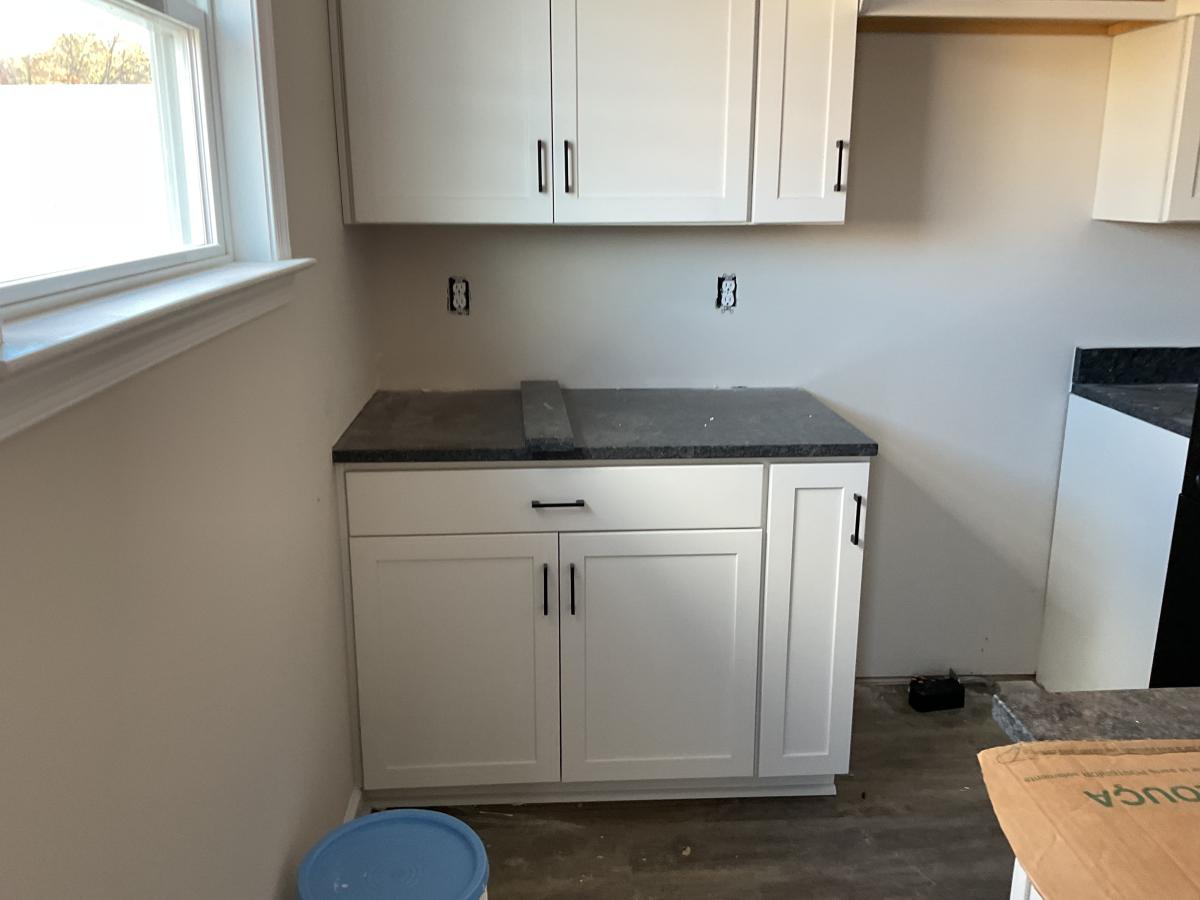

Backsplash is missing on granite countertop |
|
|
|
|
Fan needs to be installed in powder bath |
Jason, Mast & Brunk |
|
|
|
Paint touchup needed in powder bathroom |
Painter |
|
|
|
It appears that someone has already blue taped, paint, touchup areas? |
Painter |
|
|
|
Vent needed in primary bathroom as well |
Jason, Mast & Brunk |
|
|
|

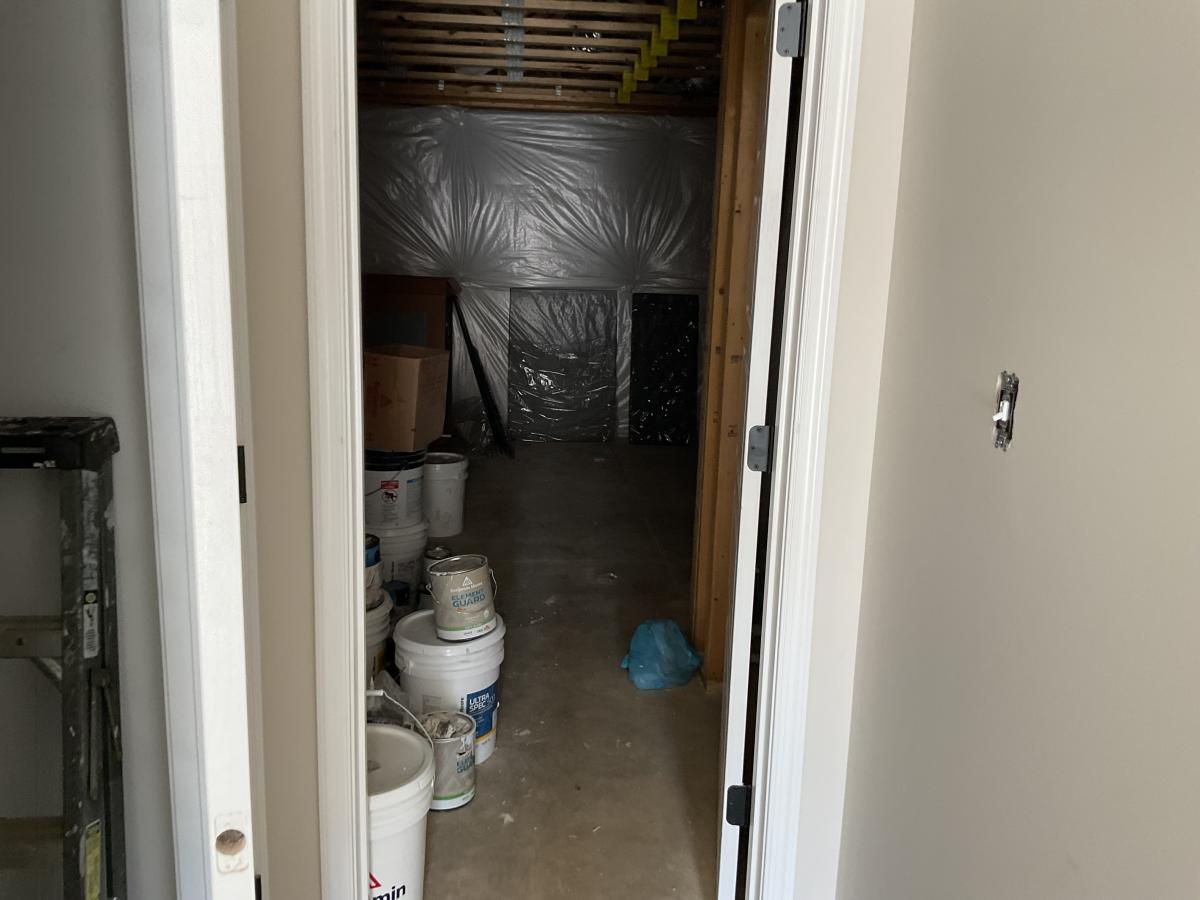

Attic cover will be needed |
Drywaller. Needs to be painted 11/12 |
|
|
|
CODED LOCKBOX 1414 |
|
|
|
|
Bonus room will need to be cleaned out |
Jill |
|
|
|
Drawers seem sticky when closing |
In process 12/3 |
|
|
|
White board needed under patio doors leading to deck |
|
|
|
|
Can we paint the dirty little patch of bricks to the left of the front door? |
Jesus |
|
|
|
Small touchup spot near powder bath light fixture |
Jesus |
|
|
|
There is an extra dining room chandelier in this unit |
|
|
|
|
Install screens |
Jill |
|
|
|
Caulk side of white cabinet |
Jesus |
|
|
|

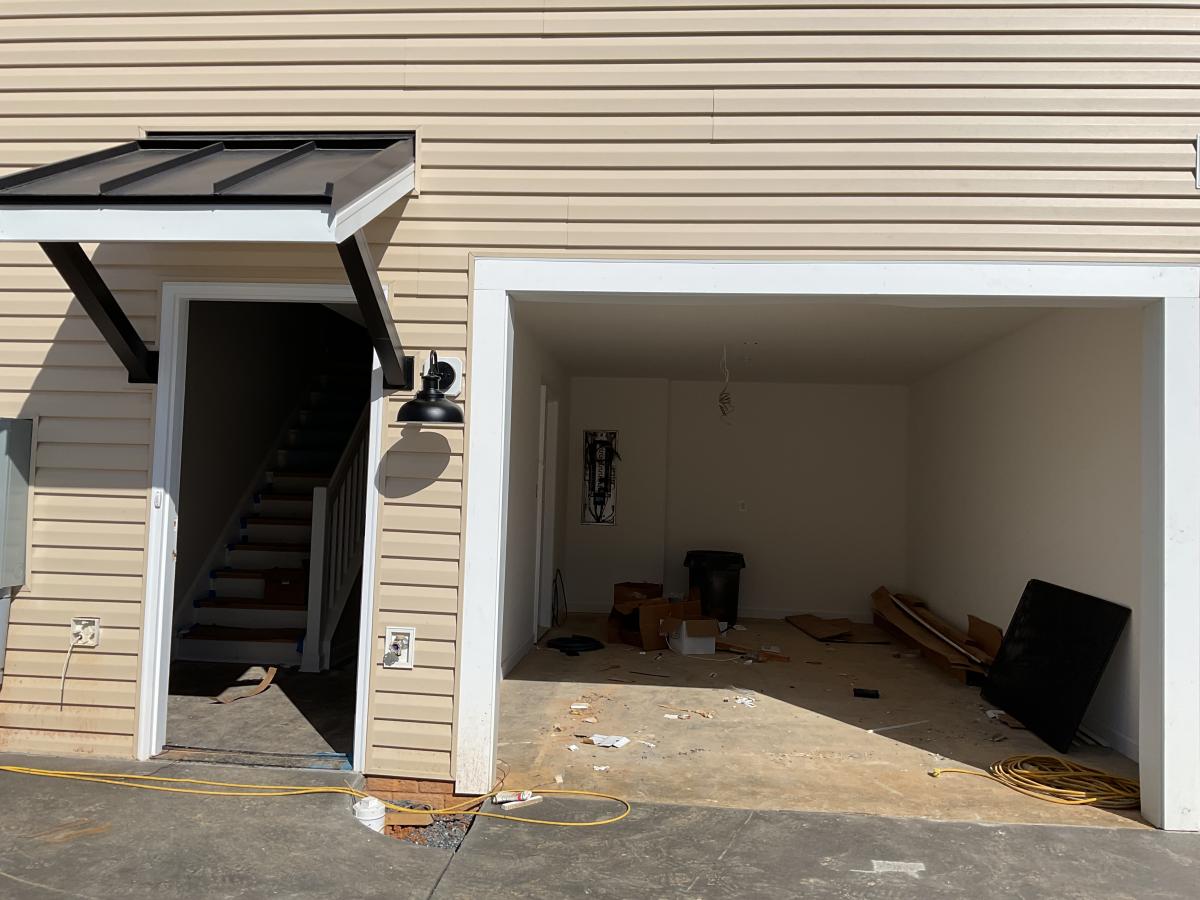

Remove just a few items from the garage and probably scrape the floor |
Jill |
|
|
|
Remove screens from unfinished bonus room |
|
|
|
|
Remove screens from bonus room |
Jill |
|
|
|
Bit of paint remains on the plank flooring, have painters remove |
Jesus |
|
|
|
Pressure wash the front of the house |
Tom |
|
|
|
Upstairs screens left to install |
Jill |
|
|
|

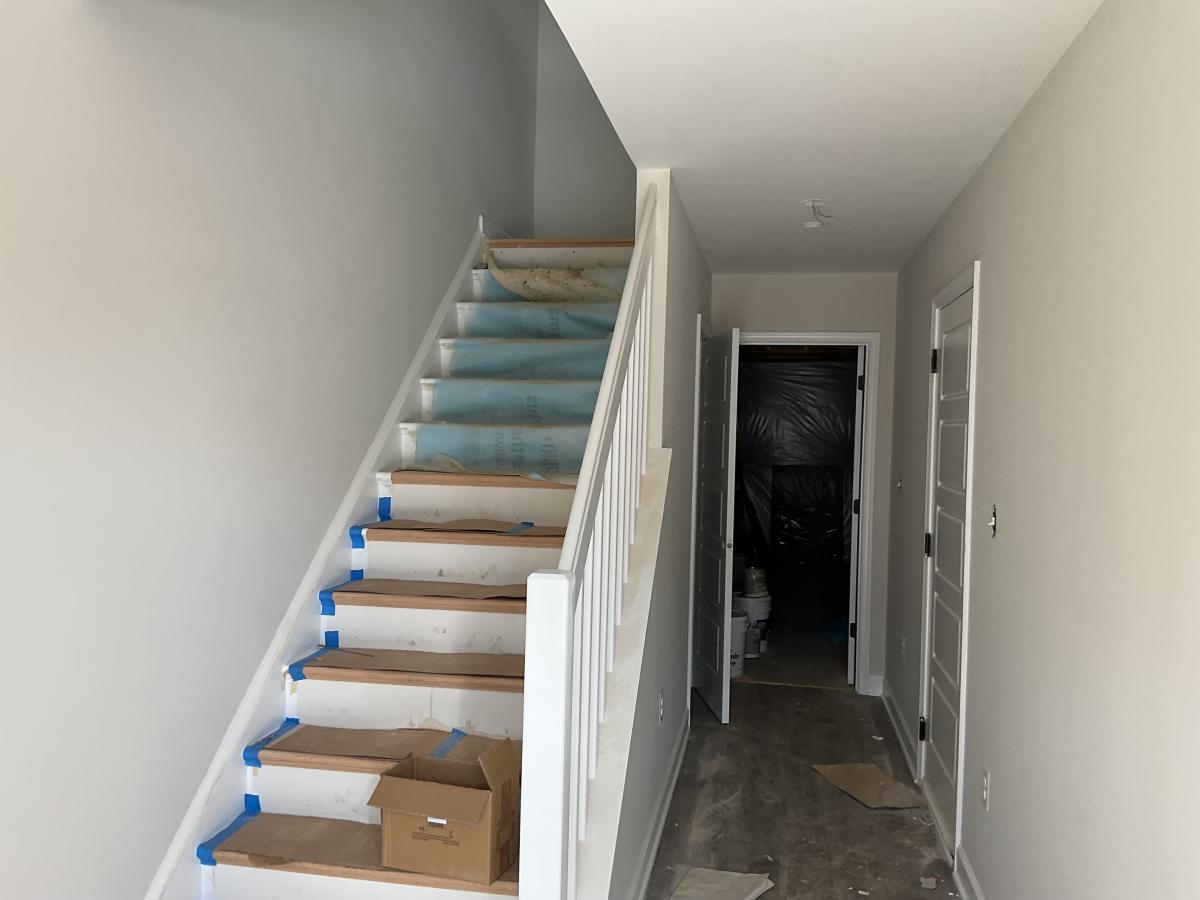

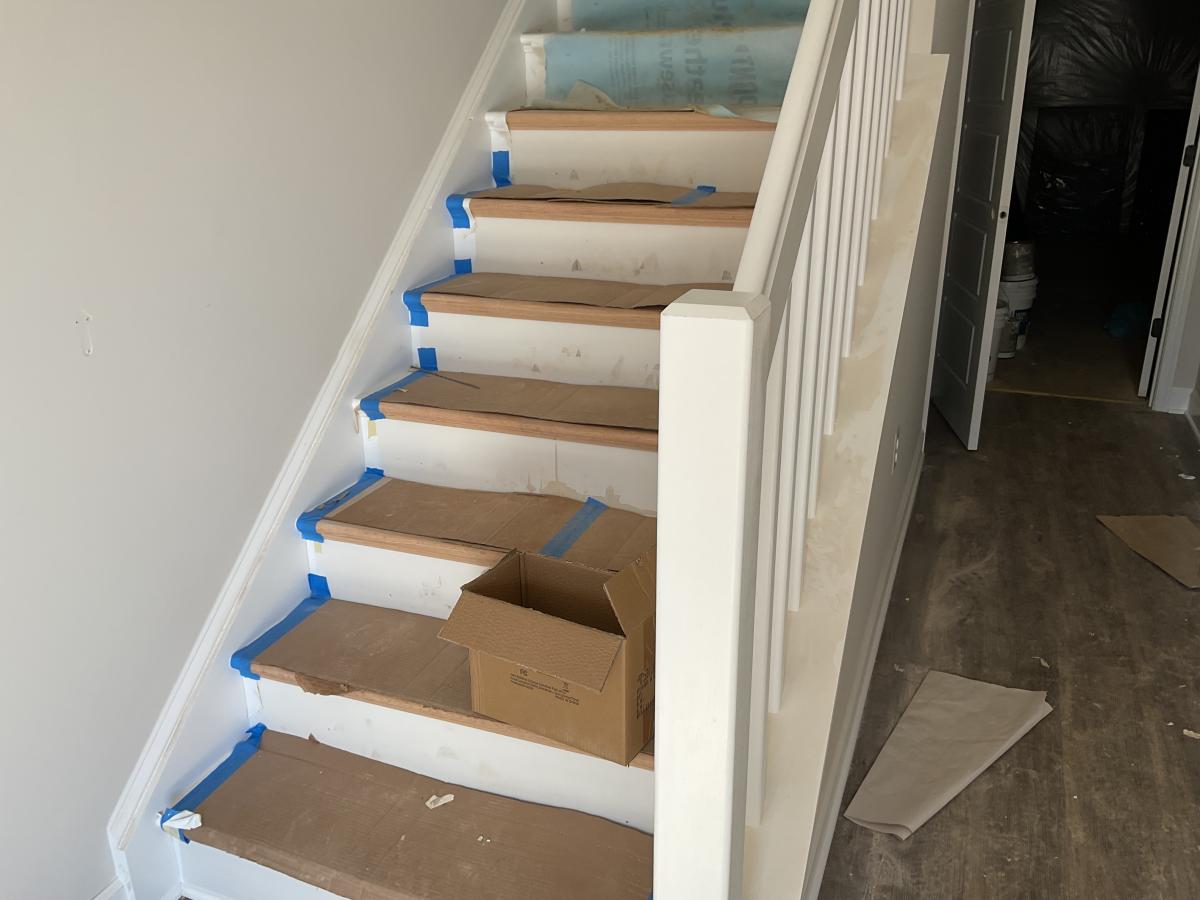

Scratches on stepsd |
Jesus |
|
|
|
Install screens |
|
|
|
|
Replace landing transition strip |
First one - Denny |
|
|
|
paint touchup thorughout |
Jesus |
|
|
|
reattach island shoe or caulk |
Jorge |
|
|
|
move dining chandelier up 2 bars |
Electrician. It’s really high - what they wanted? |
|
|
|
adjust upstairs closet doors |
|
|
|
|
clean mud off carpet in primary |
Jill |
|
|
|

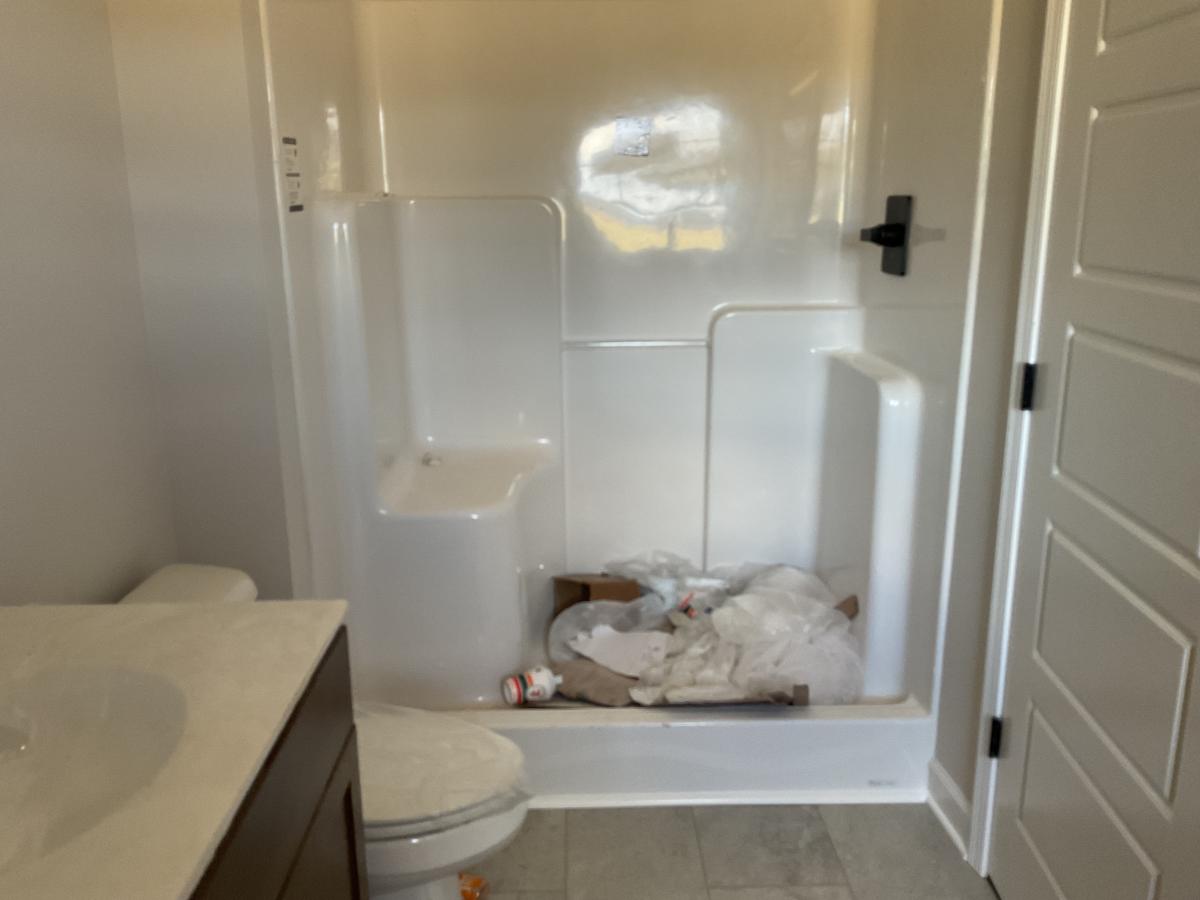

clean primary shower |
Jill |
|
|
|
remove yellow cover from smoke detector |
Luke |
|
| CL |
Jan 17 (17) |
Did this close? Maybe kitchen items in pantry. |
|
|
| CL |
Jan 15 (19) |
Caulk needed at sides of staircase |
|
|
| CL |
Jan 10 (24) |
There’s a transition strip on the main level, is one being replaced? |
|
|
| SR |
Jan 16 (18) |
Replace side panel of kitchen island |
Fred will coordinate (has owner info as of 1/19) |
|
|
|
House likely needs to be vacuumed and re-swept before closing |
|
|
|
| UPGRADES - COMPLETED |
| |
|
Expanded Driveway
|
|
| |
|
Upgraded White cabinets
|
|
| |
|
Amendment to increase price by $2,210
|
|
|
| CRITICAL PATH - COMPLETED |
| -- |
-- |
Ratified Contract? (0) 02.28.2025 |
|
|
| -- |
-- |
$2500 Deposit Received (0) 03.11.2025 |
|
|
| -- |
-- |
Association Packet Requested (0) 06.30.2025 |
|
|
| -- |
-- |
Association Packet Received (0) 03.01.2025 |
|
|
| -- |
-- |
Selections Meeting (0) 04.22.2025 |
|
|
| -- |
-- |
Selections Sheet Signed (0) 05.01.2025 |
4/21: sent to Carlos |
|
| -- |
-- |
Amendment for Upgrades (B,S,L,T,BCP) (0) 05.05.2025 |
5/1: sent to Carlos |
|
| -- |
-- |
Deposit For Upgrades Received (0) 05.01.2025 |
|
|
| -- |
-- |
Building Permit (30) * 04.11.2025 |
|
|
| -- |
-- |
Order Roof & Floor Trusses (1) 07.31.2025 |
|
|
| -- |
-- |
Order Windows & Doors (0) 07.31.2025 |
|
|
| -- |
-- |
Stake Out Home (1) 05.27.2025 |
|
|
| -- |
-- |
Excavate (2) 05.27.2025 |
|
|
| -- |
-- |
Inspection (Footers) (1) 06.30.2025 |
|
|
| -- |
-- |
Inspection (Concrete Wall) (1) 05.27.2025 |
|
|
| -- |
-- |
Pour Footers (1) * 05.27.2025 |
|
|
| -- |
-- |
Set Forms (2) 05.27.2025 |
|
|
| -- |
-- |
Pour Foundation Walls (1) 05.27.2025 |
|
|
| -- |
-- |
Plumb Slab (2) 06.19.2025 |
|
|
| -- |
-- |
Inspection (Plumbing Under Slab) (1) 06.30.2025 |
|
|
| -- |
-- |
Inspection (Conduit Under Slab) (1) 06.30.2025 |
|
|
| -- |
-- |
Prepare Slab (1) 06.30.2025 |
|
|
| -- |
-- |
Inspection (Slab) (1) 07.19.2025 |
|
|
| -- |
-- |
Inspection (Drain Tile) (0) 07.19.2025 |
|
|
| -- |
-- |
Pour Slab (1) * 06.30.2025 |
|
|
| -- |
-- |
Settlement Agent Confirmed (0) 05.07.2025 |
|
|
| -- |
-- |
Framing I (9) 07.19.2025 |
|
|
| -- |
-- |
Order Steps (0) 07.31.2025 |
|
|
| -- |
-- |
Order Tubs / Showers (0) 08.04.2025 |
|
|
| -- |
-- |
Framing II (8) 07.19.2025 |
|
|
| -- |
-- |
Framing III (8) * 07.31.2025 |
|
|
| -- |
-- |
Verify Window & Roof Structure (0) 07.31.2025 |
|
|
| -- |
-- |
Install Stairs (0) * 08.03.2025 |
|
|
| -- |
-- |
Windows & Doors (0) * 08.03.2025 |
|
|
| -- |
-- |
House Number and Status in Window (0) 09.20.2025 |
|
|
| -- |
-- |
Roofing (0) * 08.06.2025 |
|
|
| -- |
-- |
Order Cabinets (0) 08.28.2025 |
|
|
| -- |
-- |
Order Appliances (0) 10.02.2025 |
|
|
| -- |
-- |
Deck (0) 09.17.2025 |
|
|
| -- |
-- |
Gutters (0) 10.18.2025 |
|
|
| -- |
-- |
Driveway (0) * 10.22.2025 |
|
|
| -- |
-- |
Patio (0) 09.17.2025 |
|
|
| -- |
-- |
Privacy Divider / Fence (0) * 09.17.2025 |
|
|
| -- |
-- |
Sod / Seed / Landscaping (0) 11.12.2025 |
|
|
| -- |
-- |
HVAC Rough In (4) 08.03.2025 |
|
|
| -- |
-- |
Rough In Microwave Vent (0) 08.03.2025 |
|
|
| -- |
-- |
Plumbing Rough In (4) 08.16.2025 |
In process 8/9 |
|
| -- |
-- |
Electric Rough In (4) 08.23.2025 |
|
|
| -- |
-- |
Inspection (Rough In HVAC) (1) 08.26.2025 |
|
|
| -- |
-- |
Inspection (Rough In Plumbing) (1) 08.26.2025 |
|
|
| -- |
-- |
Inspection (Rough In Electric) (1) 08.26.2025 |
|
|
| -- |
-- |
Inspection (Framing) (1) * 08.26.2025 |
|
|
| -- |
-- |
Inspection (Deck Piers) (0) 09.11.2025 |
|
|
| -- |
-- |
Exterior Vinyl (0) * 10.15.2025 |
|
|
| -- |
-- |
Exterior Stone (0) 09.08.2025 |
|
|
| -- |
-- |
Insulation (2) * 09.01.2025 |
In process 8/27 |
|
| -- |
-- |
Inspection (Insulation) (1) 09.04.2025 |
|
|
| -- |
-- |
Inspection (Electric Service) (0) 10.10.2025 |
|
|
| -- |
-- |
Set Electric Meter (0) * 10.23.2025 |
|
|
| -- |
-- |
Inspection (Main Sewer Line) (0) 08.21.2025 |
|
|
| -- |
-- |
Inspection (Main Water Line) (0) 08.21.2025 |
|
|
| -- |
-- |
Order Interior Doors & Trim (0) 09.11.2025 |
|
|
| -- |
-- |
Drywall (Hang) (4) * 09.15.2025 |
In process 9/6 |
|
| -- |
-- |
Loan Approval (0) 12.08.2025 |
Chris & RateCloud (96.5% FHA) |
|
| -- |
-- |
Deed Preparation (0) 10.23.2025 |
|
|
| -- |
-- |
Drywall (Tape, Block, Skim, Sand) (6) * 09.17.2025 |
|
|
| -- |
-- |
Paint 1 (1) 09.17.2025 |
|
|
| -- |
-- |
Garage Door (0) 11.19.2025 |
|
|
| -- |
-- |
House Numbers (0) 11.06.2025 |
|
|
| -- |
-- |
Mailbox (0) 11.19.2025 |
|
|
| -- |
-- |

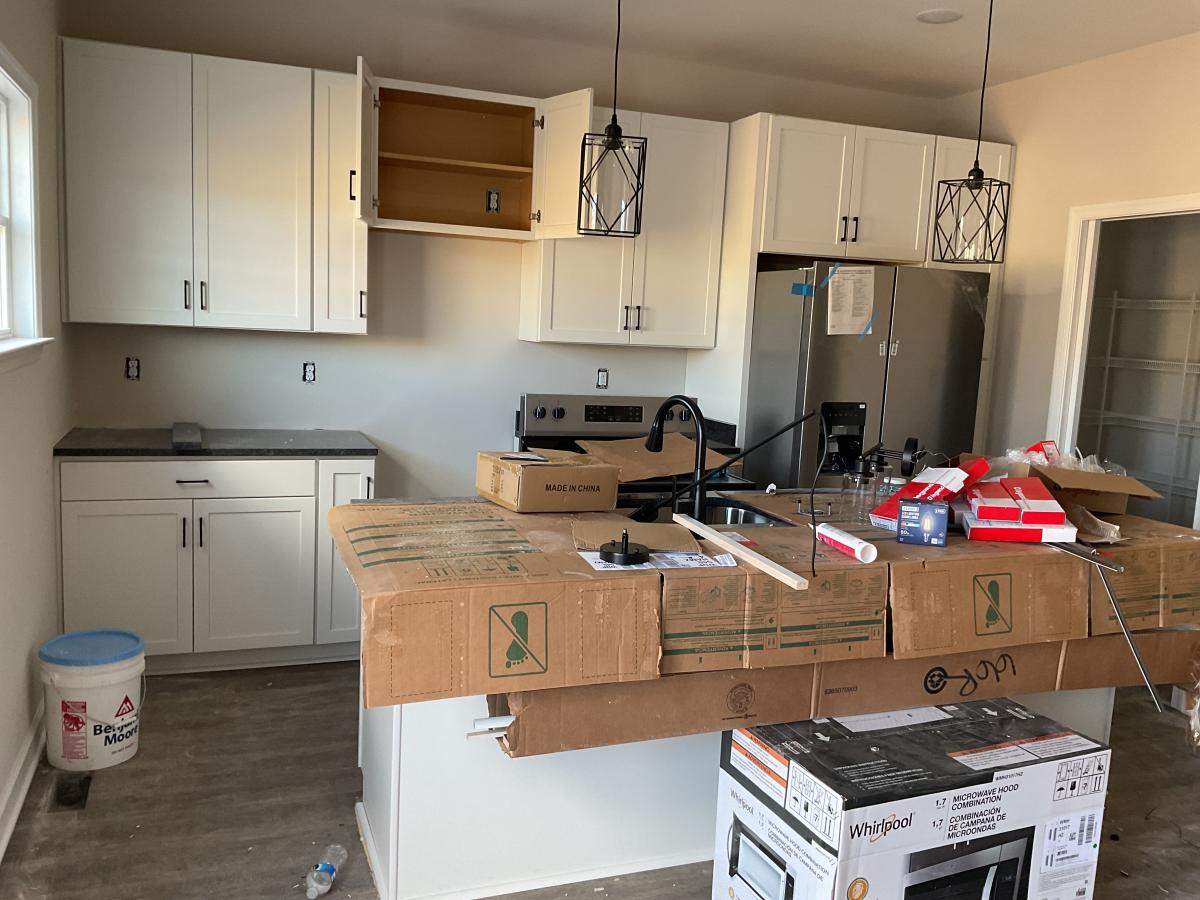

Cabinet Installation (2) * 09.28.2025 |
Deliver Sep 19, Install Sep 25. On site 9/24 |
|
| -- |
-- |
Granite Installation (1) * 10.18.2025 |
In process 10/15 |
|
| -- |
-- |
Interior Trim - Install (3) * 10.01.2025 |
In process 9/26 |
|
| -- |
-- |
Order Plumbing / Lighting Fixtures (0) 10.02.2025 |
|
|
| -- |
-- |
Interior Trim - Paint (1) 10.04.2025 |
|
|
| -- |
-- |
Luxury Vinyl Plank (3) * 10.15.2025 |
In process 10/11 |
|
| -- |
-- |
Luxury Vinyl Tile (0) 10.15.2025 |
|
|
| -- |
-- |
Paint 2 (3) 10.22.2025 |
|
|
| -- |
-- |
Cover Floors (0) 10.22.2025 |
|
|
| -- |
-- |
Deliver Plumbing / Lighting Fixtures (0) 10.13.2025 |
|
|
| -- |
-- |
Shoe Moulding (0) 10.22.2025 |
|
|
| -- |
-- |
Shelving, Door Knobs, Fire Extinguisher (1) * 11.05.2025 |
Most seems to be completed, except for the door knobs and locks |
|
| -- |
-- |
Install Coded Lockbox (add extra keys) (0) 11.10.2025 |
|
|
| -- |
-- |
Pay Water / Sewer Taps (0) 10.23.2025 |
|
|
| -- |
-- |
Set Water Meter (1) * 10.30.2025 |
|
|
| -- |
-- |
Electric Trim Out (3) * 11.05.2025 |
In process 10/31 |
|
| -- |
-- |
Ceiling Fans (0) 11.05.2025 |
|
|
| -- |
-- |
HVAC Trim Out (1) * 11.05.2025 |
|
|
| -- |
-- |
Blower Door Test (1) 11.17.2025 |
|
|
| -- |
-- |
Plumbing Trim Out (2) * 10.25.2025 |
|
|
| -- |
-- |
Install Appliances (0) * 11.05.2025 |
On site 10/22 |
|
| -- |
-- |
Paint 3 (2) * 10.29.2025 |
|
|
| -- |
-- |
Carpet (2) 10.22.2025 |
|
|
| -- |
-- |
Appraiser Confirms Construction Completion (0) 12.11.2025 |
|
|
| -- |
-- |
Inspection (Final HVAC) (0) 11.24.2025 |
|
|
| -- |
-- |
Inspection (Final Plumbing) (0) 11.24.2025 |
|
|
| -- |
-- |
Inspection (Final Electric) (0) 11.24.2025 |
|
|
| -- |
-- |
Inspection (Final Building) (4) * 11.24.2025 |
|
|
| -- |
-- |
Pre Walk Through (0) 12.01.2025 |
|
|
| -- |
-- |
Stain Hardwood Stairs (1) * 11.23.2025 |
In process 11/19 |
|
| -- |
-- |
Cleaning (1) 12.06.2025 |
In process 12/3 |
|
| -- |
-- |
Certificate of Occupancy (1) * 12.02.2025 |
|
|
| -- |
-- |
C.O. to Lender (0) 12.02.2025 |
|
|
| -- |
-- |
Schedule Closing (0) 01.15.2026 |
|
|
| -- |
-- |
Buyer Walk Through (1) * 12.11.2025 |
Mon, Dec 8 at 11 AM |
|
| -- |
-- |
Payment for Upgrades (0) 11.18.2025 |
|
|
| -- |
-- |
Keys to Settlement Agent (0) 11.24.2025 |
|
|
| -- |
-- |
Review Settlement Statement (0) 01.15.2026 |
|
|
| -- |
-- |
Jerry Signs Closing Documents (0) 01.09.2026 |
|
|
| -- |
-- |
Request Trash Tote From POA Manager (0) 12.16.2025 |
|
|
| -- |
-- |
Closing (1) 01.19.2026 |
Brittany @ West View Title |
|
