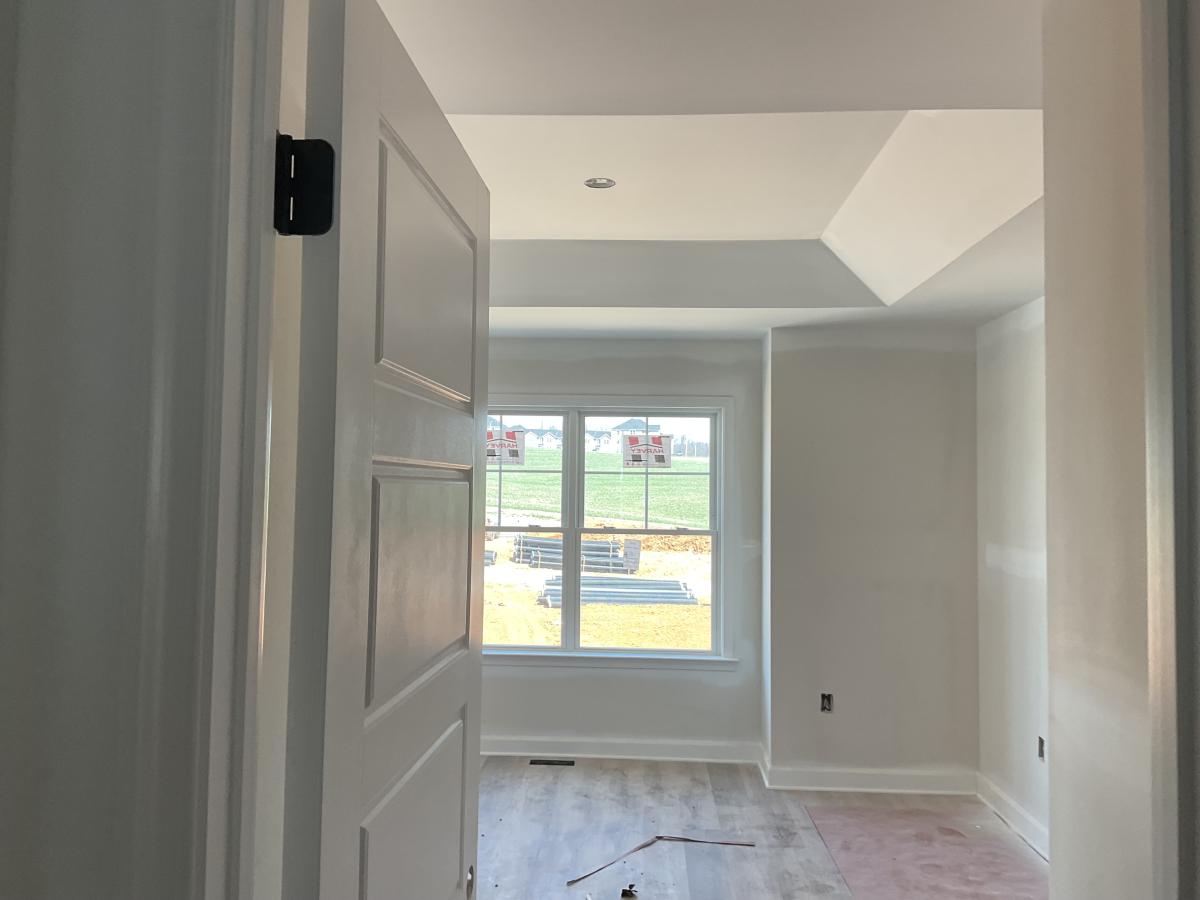

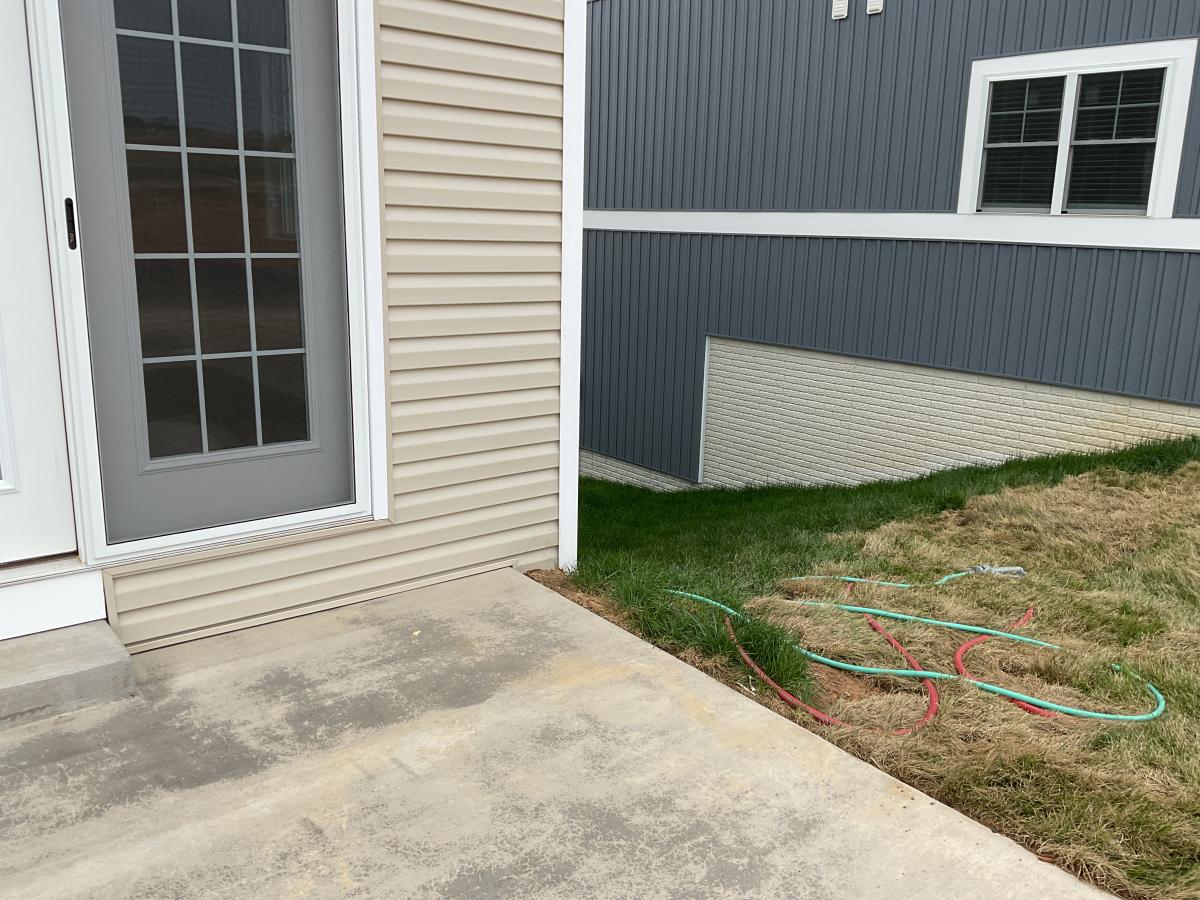

| Expanded Driveway | ||||
| LVP in Upstairs Hallway and Bedrooms | ||||
| Painted Steps to Bedroom Level | ||||
| Eggshell Paint | ||||
| Sun | Nov 2 | Order Appliances (0) | ||
| Sun | Nov 2 | Deck (0) | ||
| Sun | Nov 2 | Gutters (0) | ||
| Sun | Nov 2 | Driveway (0) * | ||
| Sun | Nov 2 | Patio (0) | ||
| Sun | Nov 2 | Privacy Divider / Fence (0) * | ||

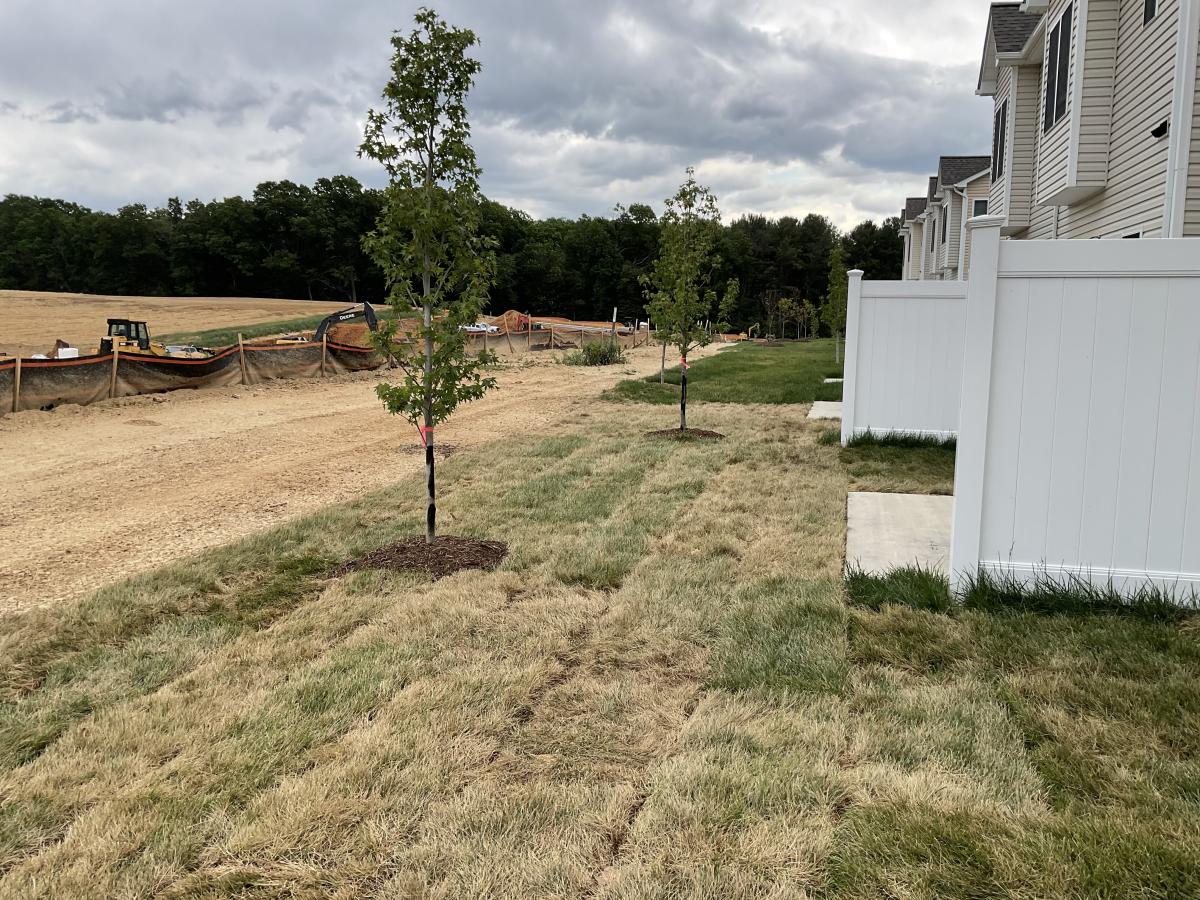

| Sun | Nov 2 | Sod / Seed / Landscaping (0) | ||
| Sun | Nov 2 | Plumbing Rough In (4) | In process 10/29 | |
| Thu | Nov 6 | Electric Rough In (4) | ||
| Wed | Nov 12 | Inspection (Rough In HVAC) (1) | ||
| Thu | Nov 13 | Inspection (Rough In Plumbing) (1) | ||
| Fri | Nov 14 | Inspection (Rough In Electric) (1) | ||
| Mon | Nov 17 | Inspection (Framing) (1) * | ||
| Tue | Nov 18 | Inspection (Deck Piers) (0) | ||

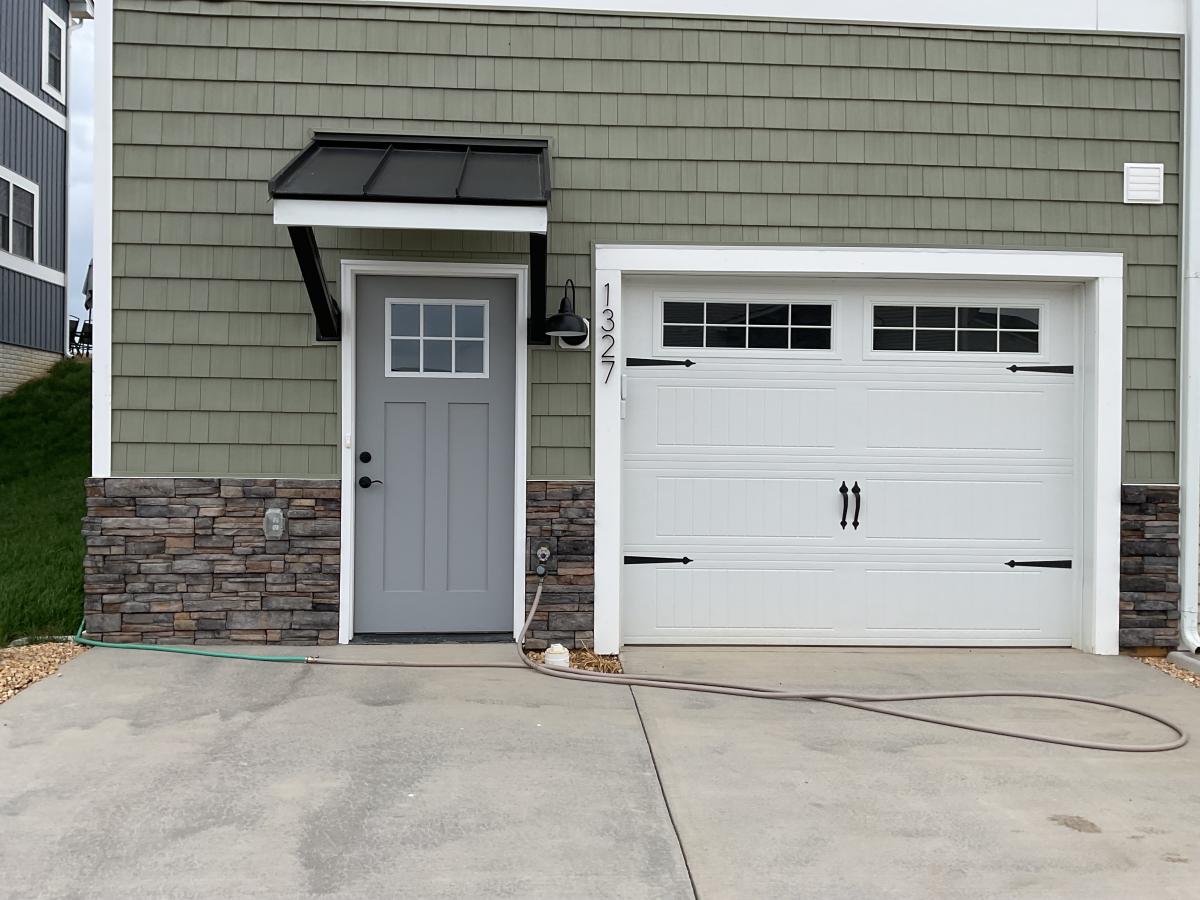

| Tue | Nov 18 | Exterior Vinyl (0) * | ||

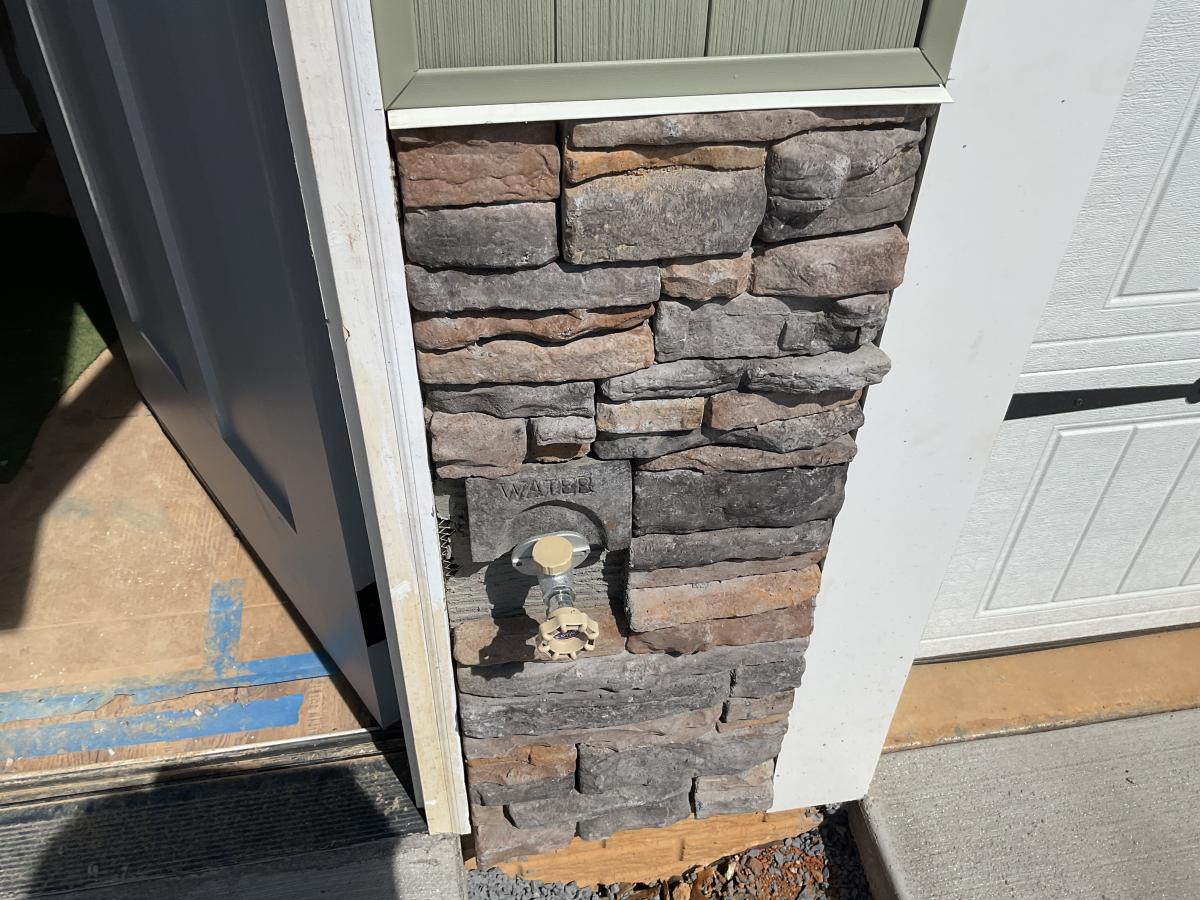

| Tue | Nov 18 | Exterior Stone (0) | ||

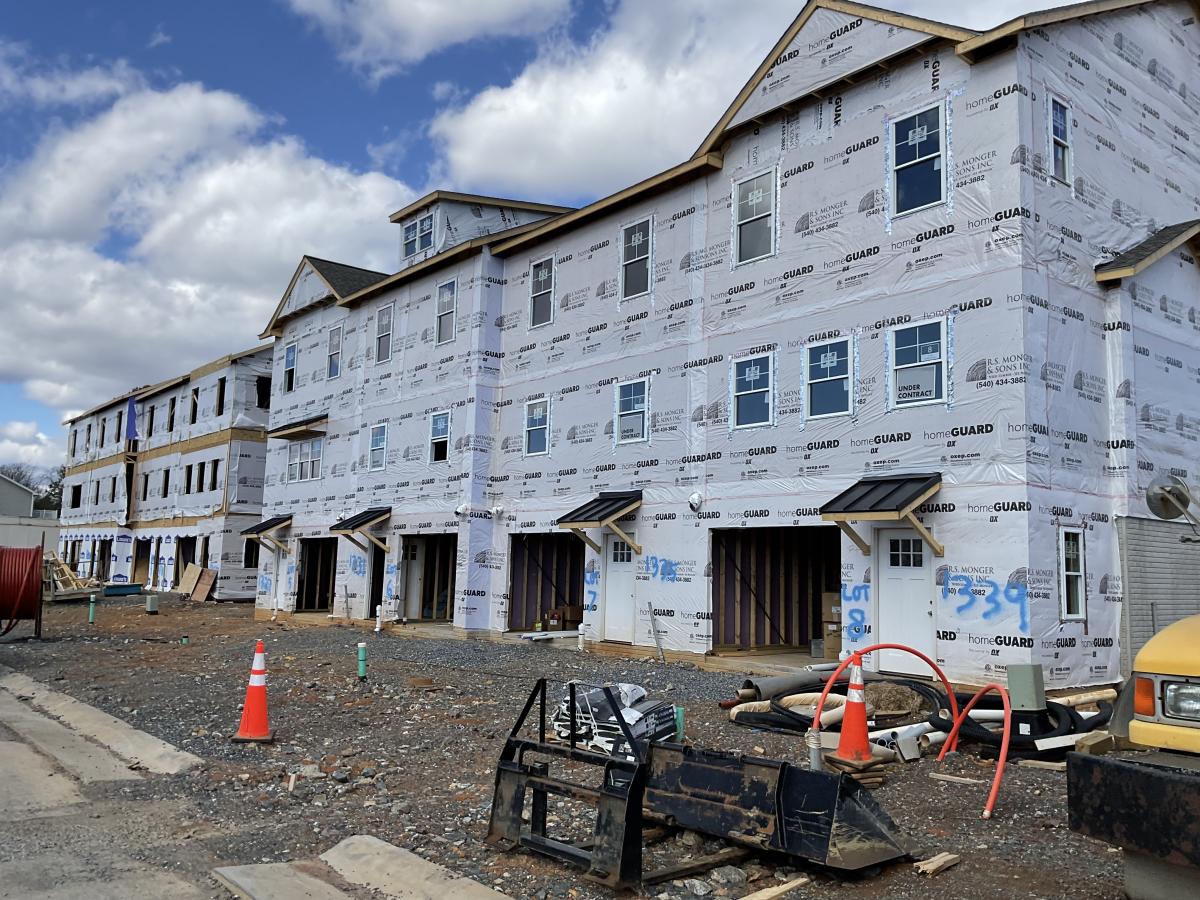

| Tue | Nov 18 | Insulation (2) * | ||
| Thu | Nov 20 | Inspection (Insulation) (1) | ||
| Fri | Nov 21 | Inspection (Electric Service) (0) | ||
| Fri | Nov 21 | Set Electric Meter (0) * | ||
| Fri | Nov 21 | Order Interior Doors & Trim (0) | ||

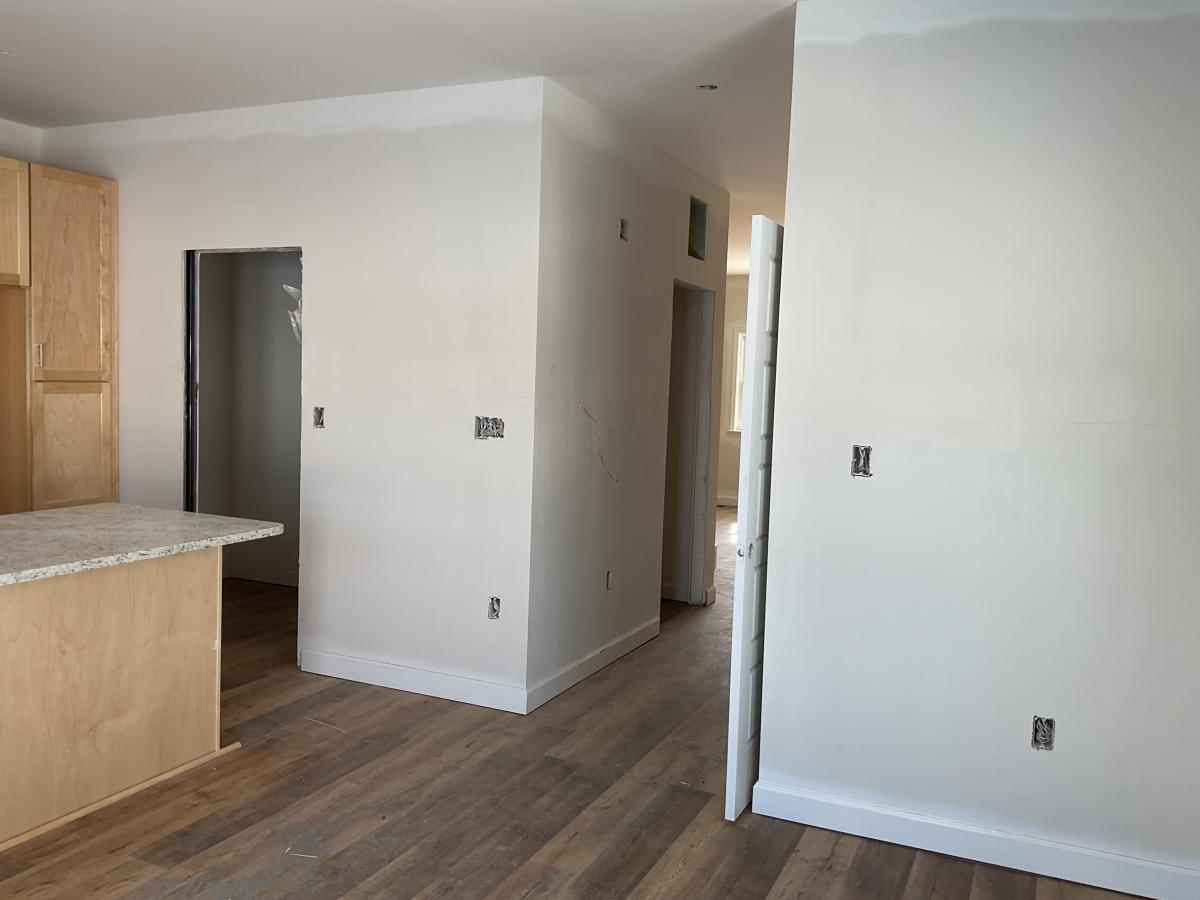

| Fri | Nov 21 | Drywall (Hang) (4) * | ||
| Thu | Nov 27 | Loan Approval (0) | Cash | |
| Thu | Nov 27 | Deed Preparation (0) | ||

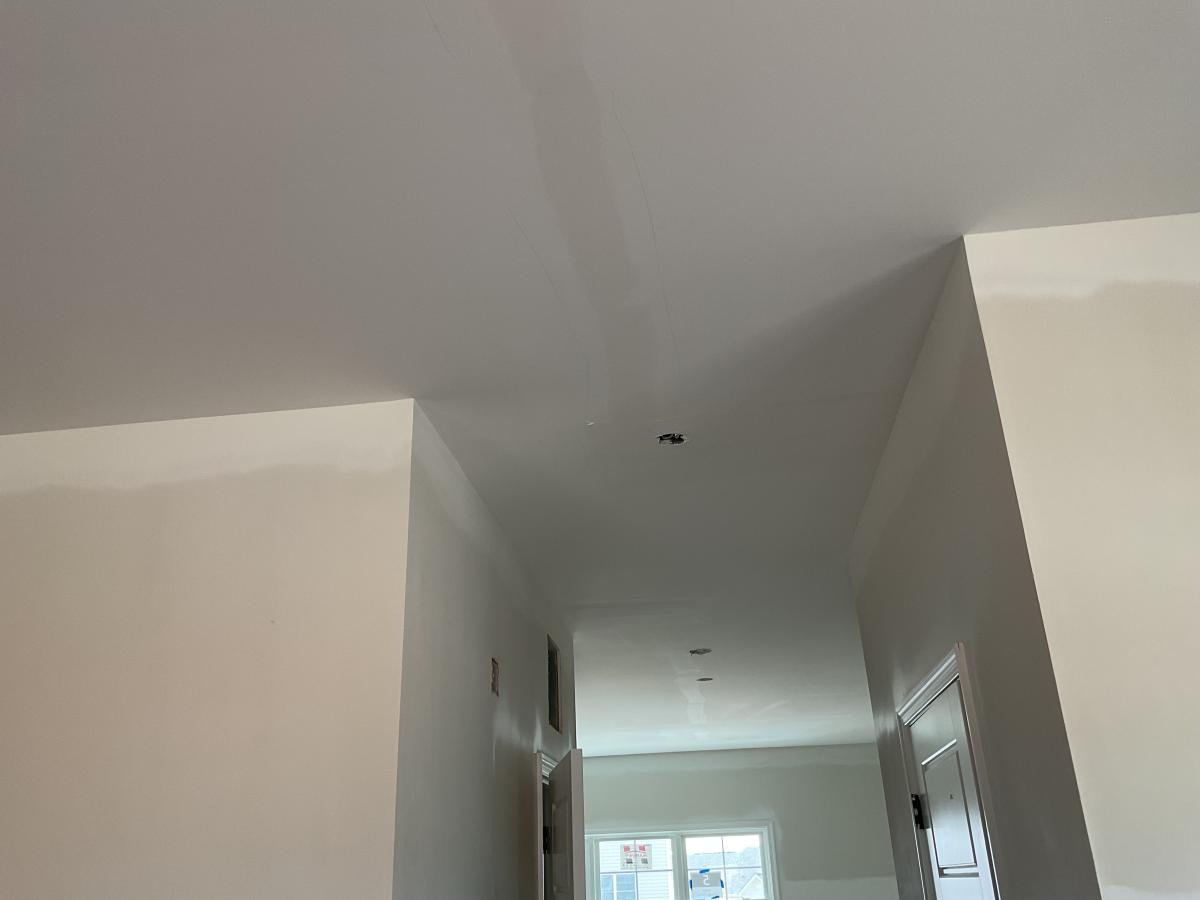

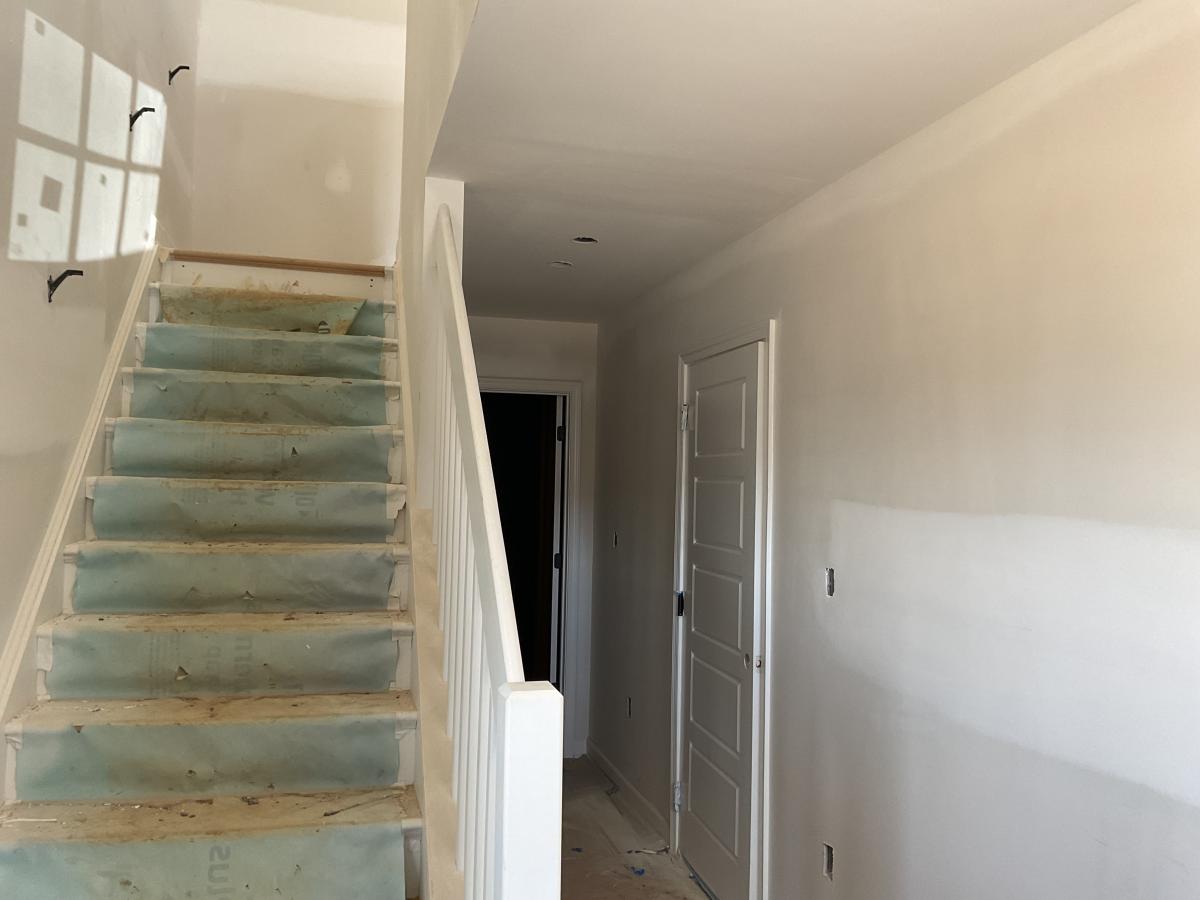

| Thu | Nov 27 | Drywall (Tape, Block, Skim, Sand) (6) * | ||

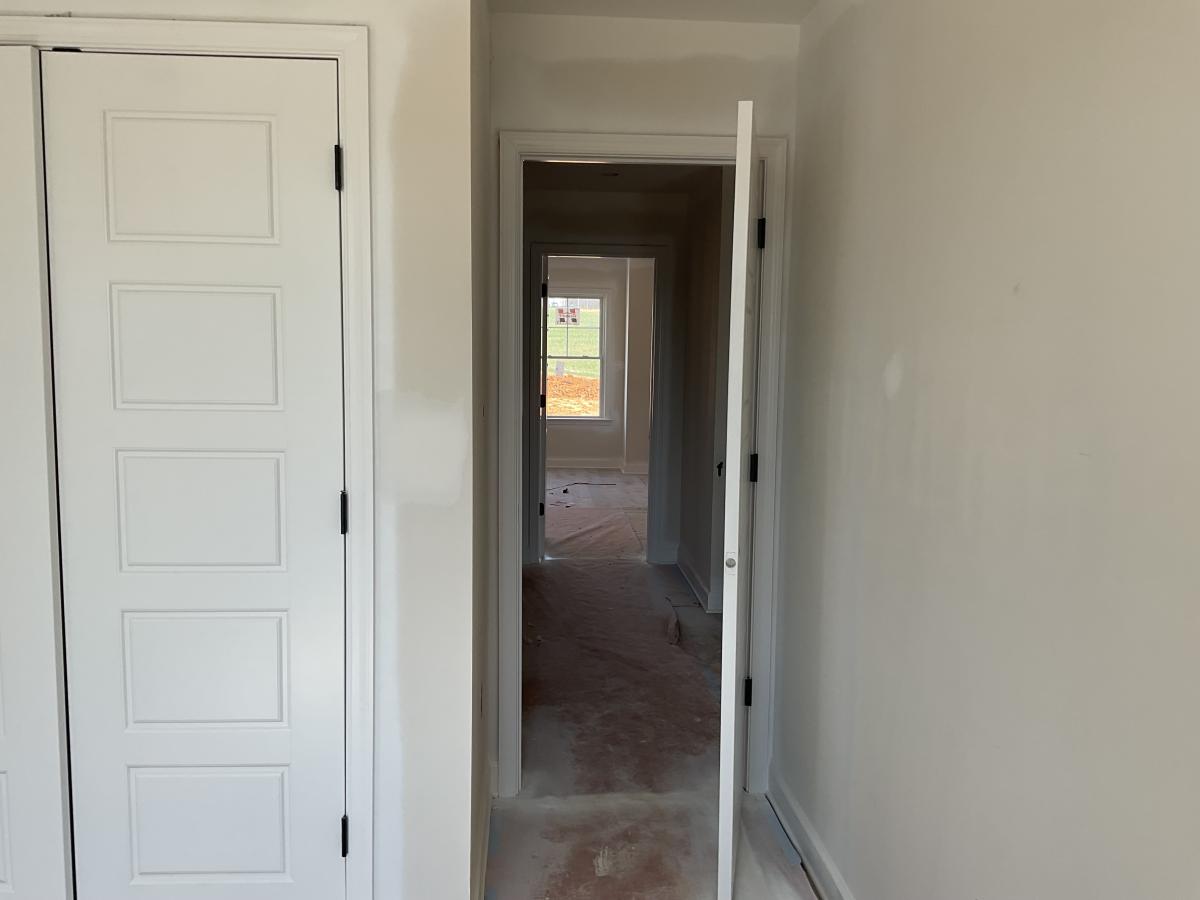

| Fri | Dec 5 | Paint 1 (1) | ||
| Mon | Dec 8 | Garage Door (0) | ||
| Mon | Dec 8 | House Numbers (0) | ||
| Mon | Dec 8 | Mailbox (0) | ||

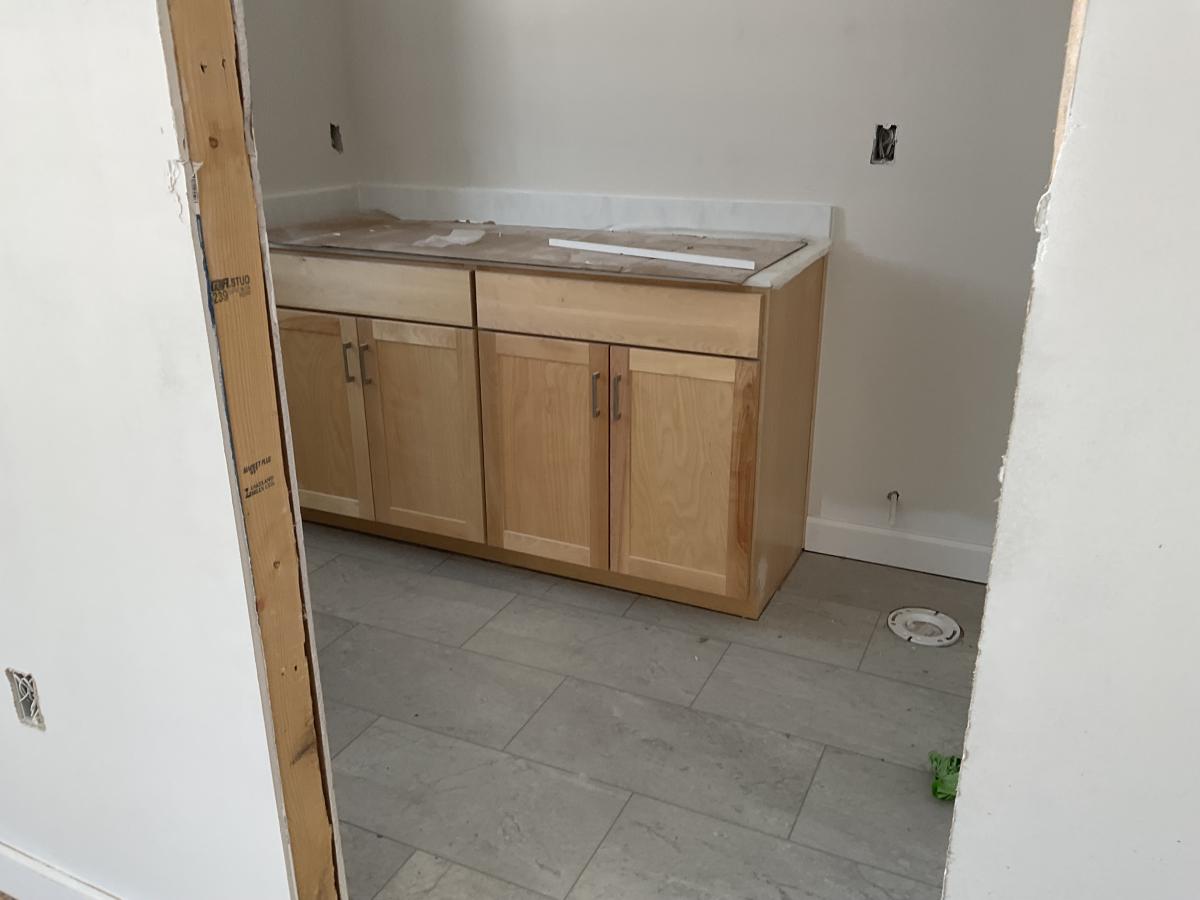

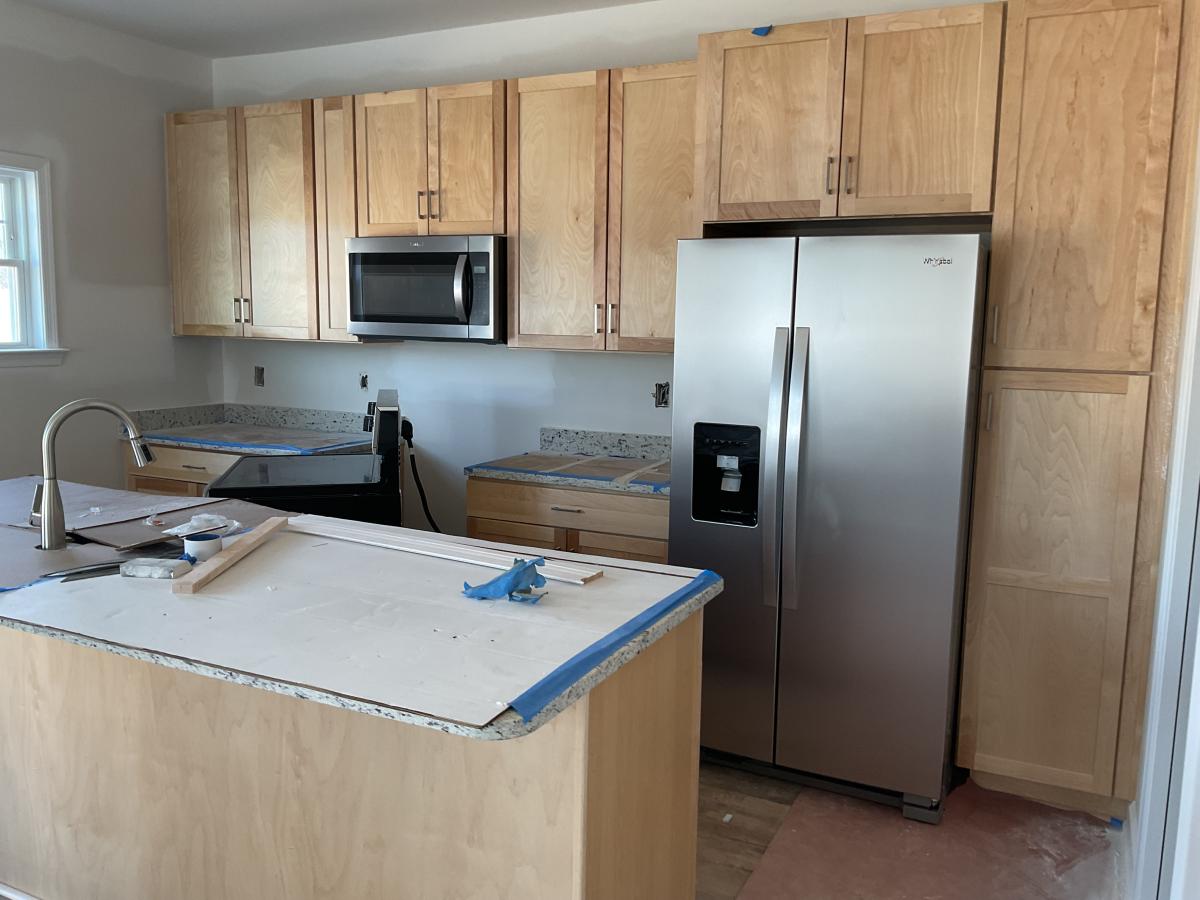

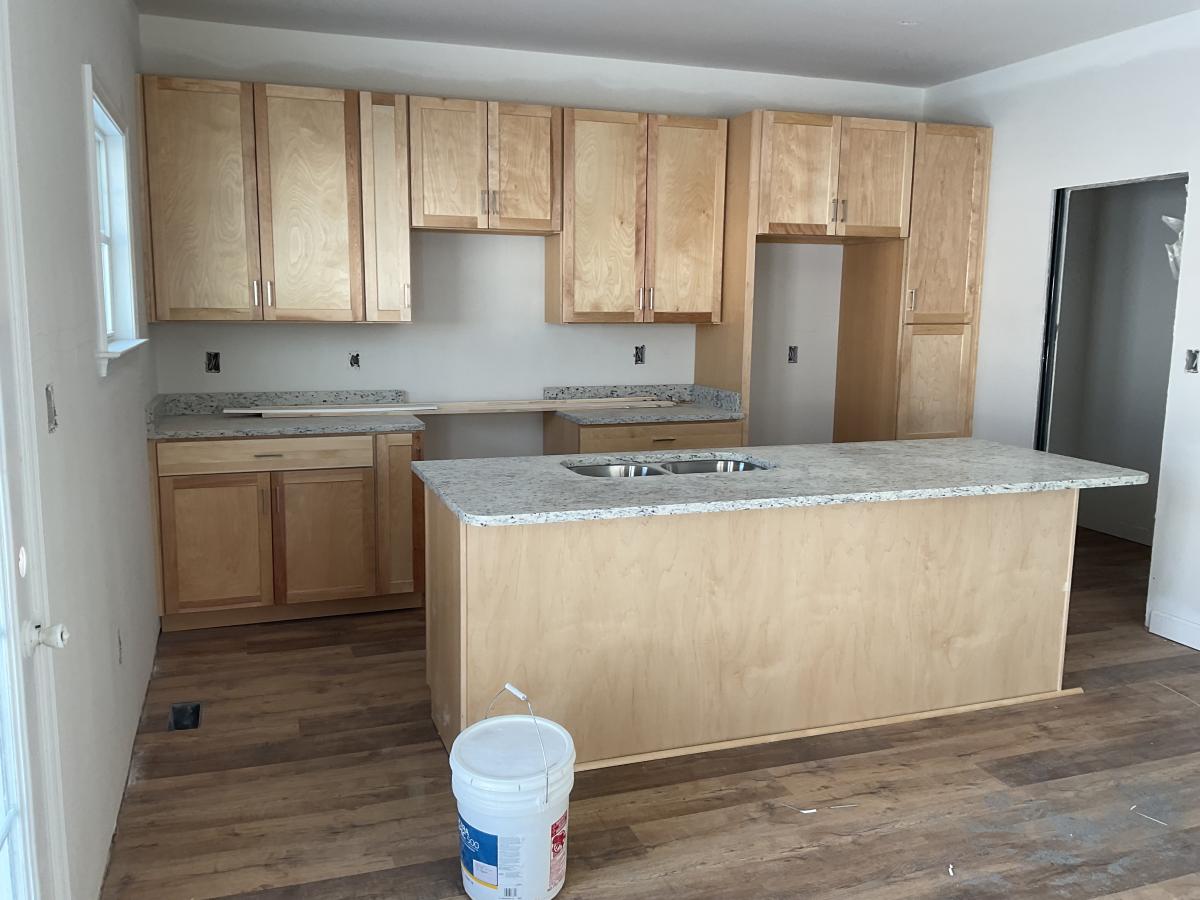

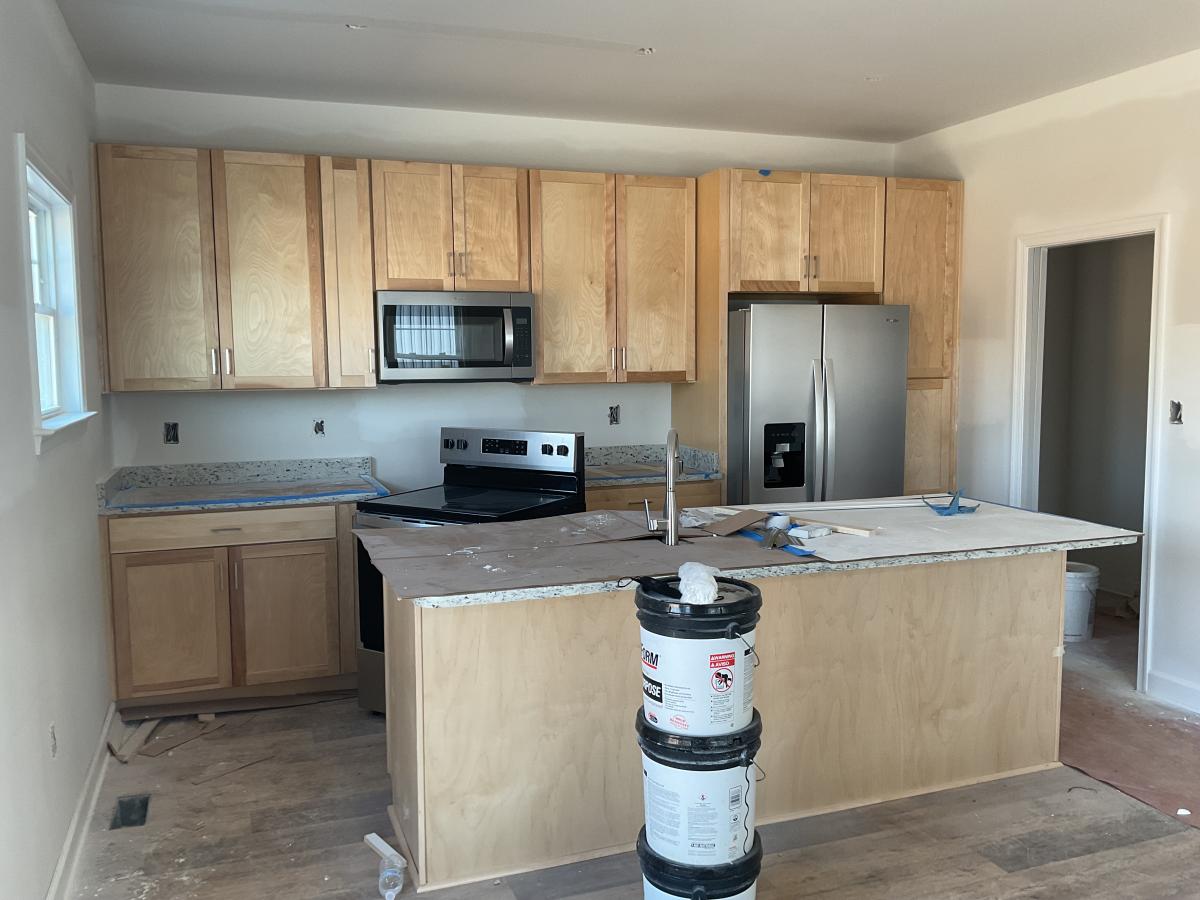

| Mon | Dec 8 | Cabinet Installation (2) * | ||
| Wed | Dec 10 | Granite Installation (1) * | ||

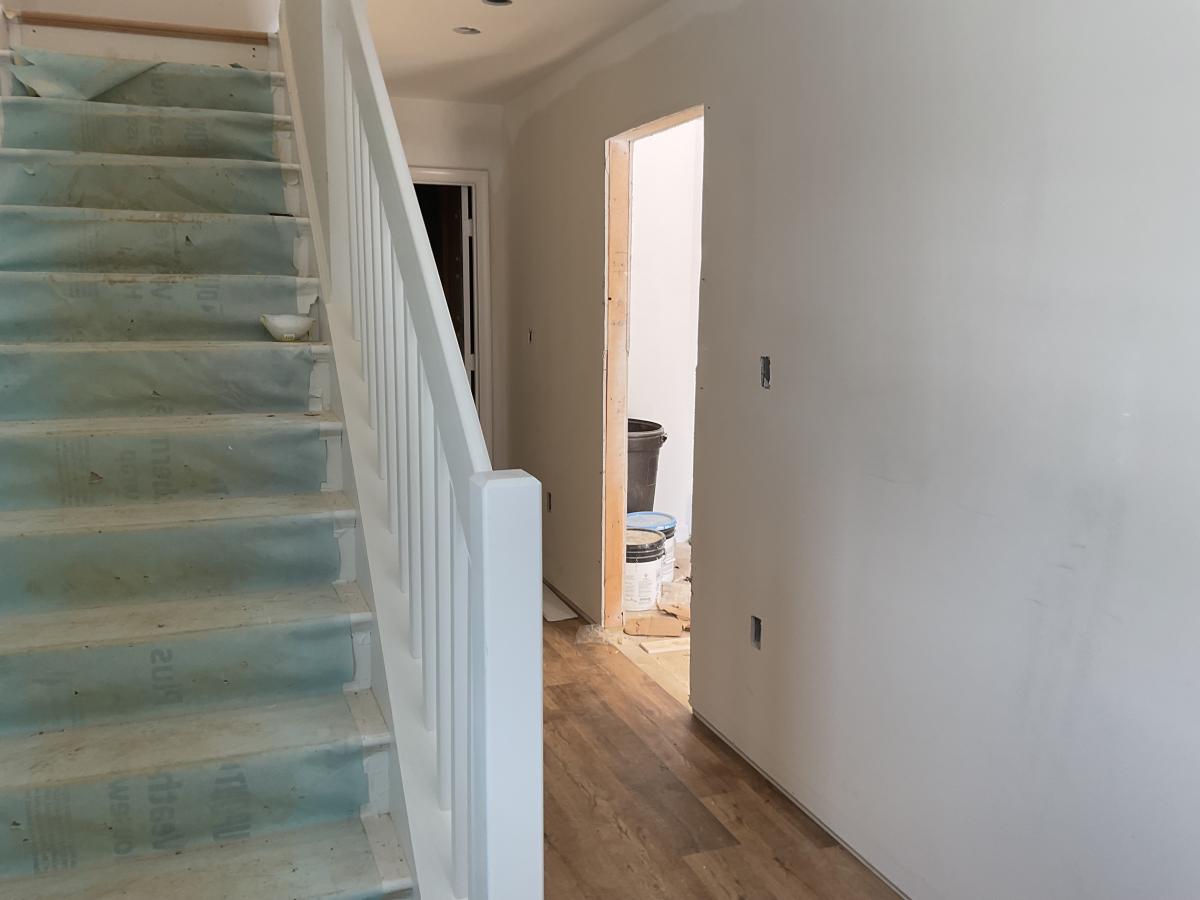

| Thu | Dec 11 | Interior Trim - Install (3) * | ||
| Tue | Dec 16 | Order Plumbing / Lighting Fixtures (0) | ||
| Tue | Dec 16 | Interior Trim - Paint (1) | ||

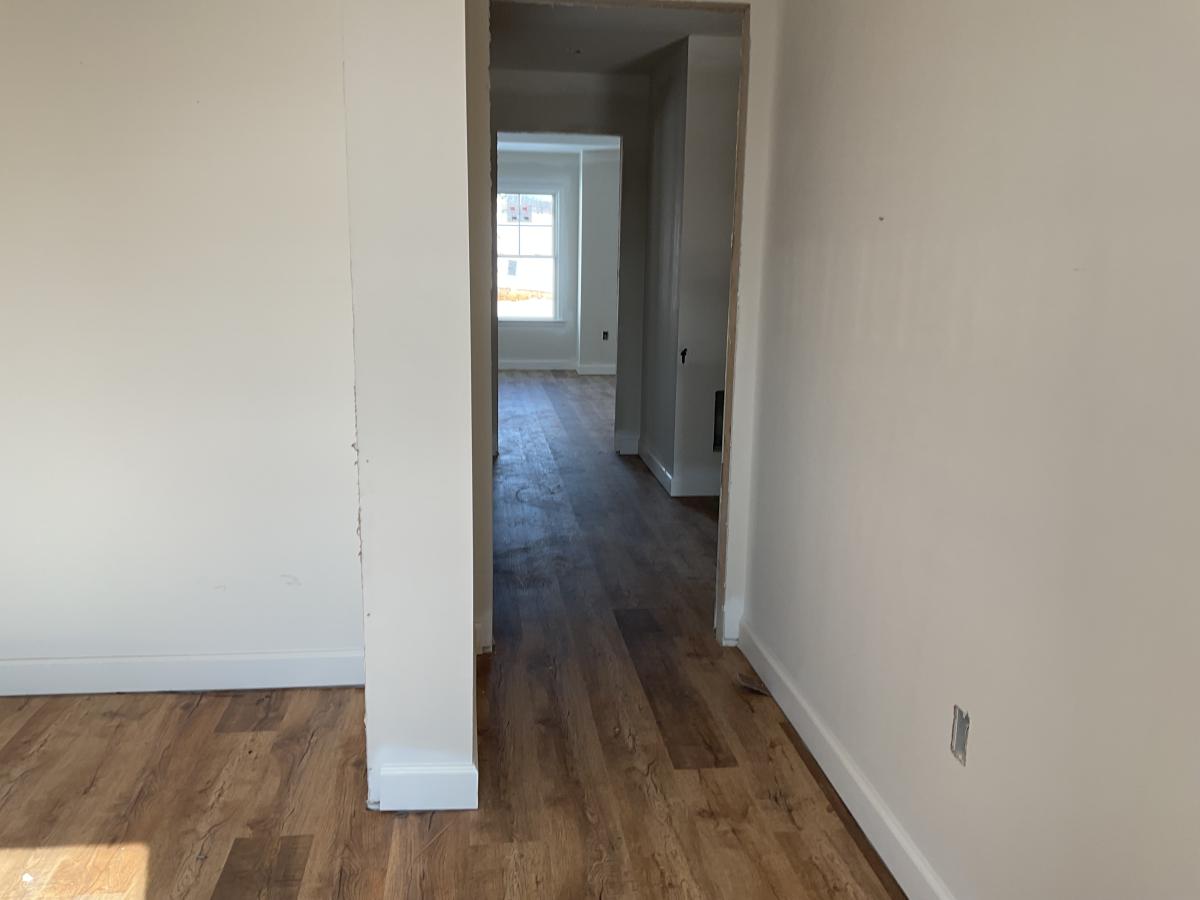

| Wed | Dec 17 | Luxury Vinyl Plank (3) * | ||
| Mon | Dec 22 | Luxury Vinyl Tile (0) | ||

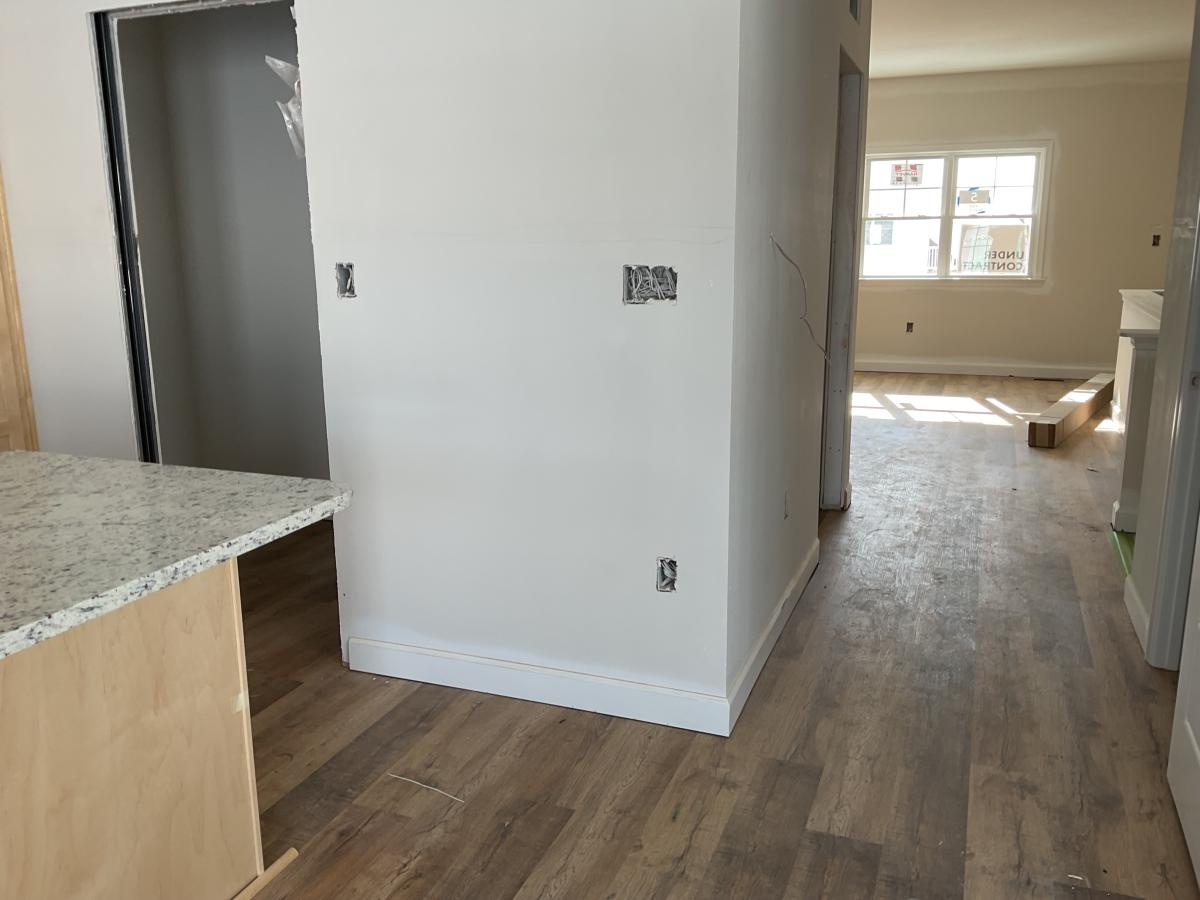

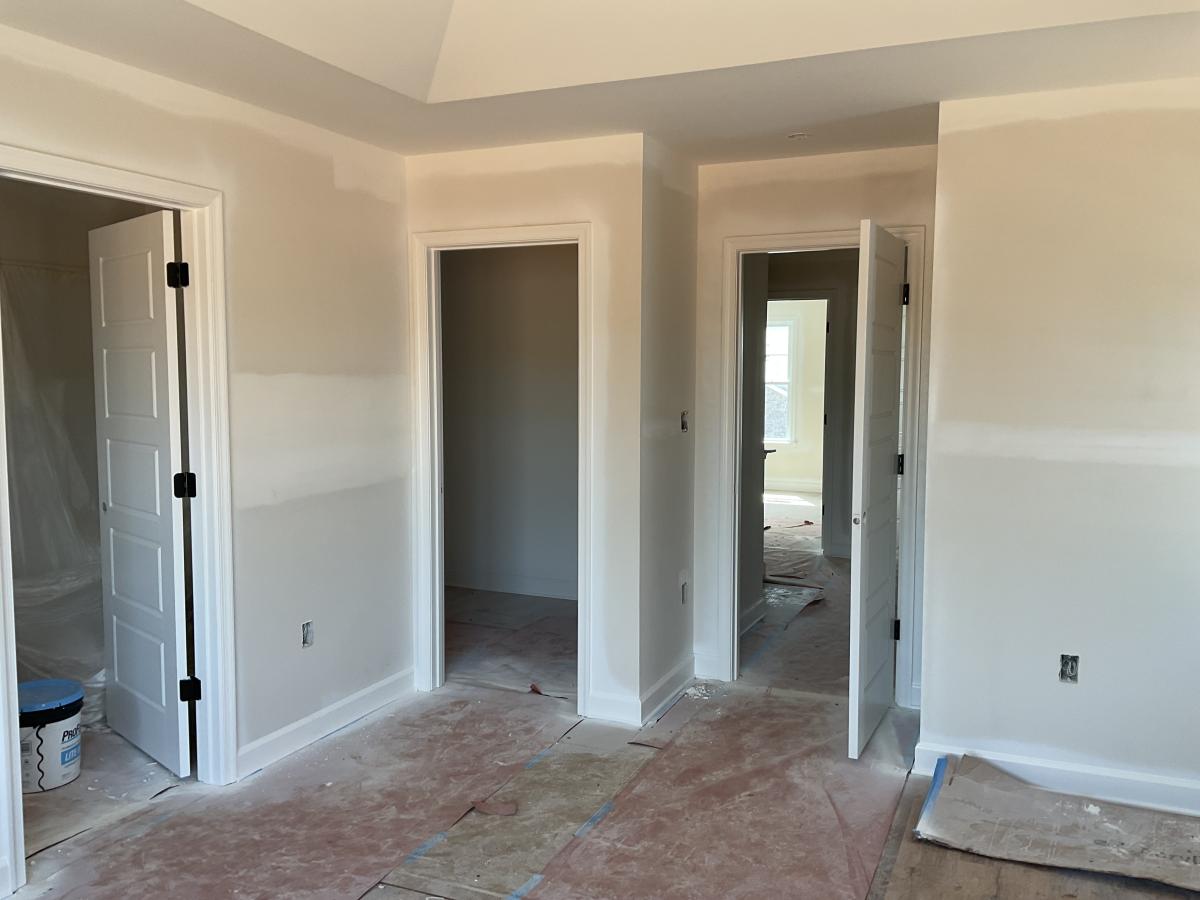

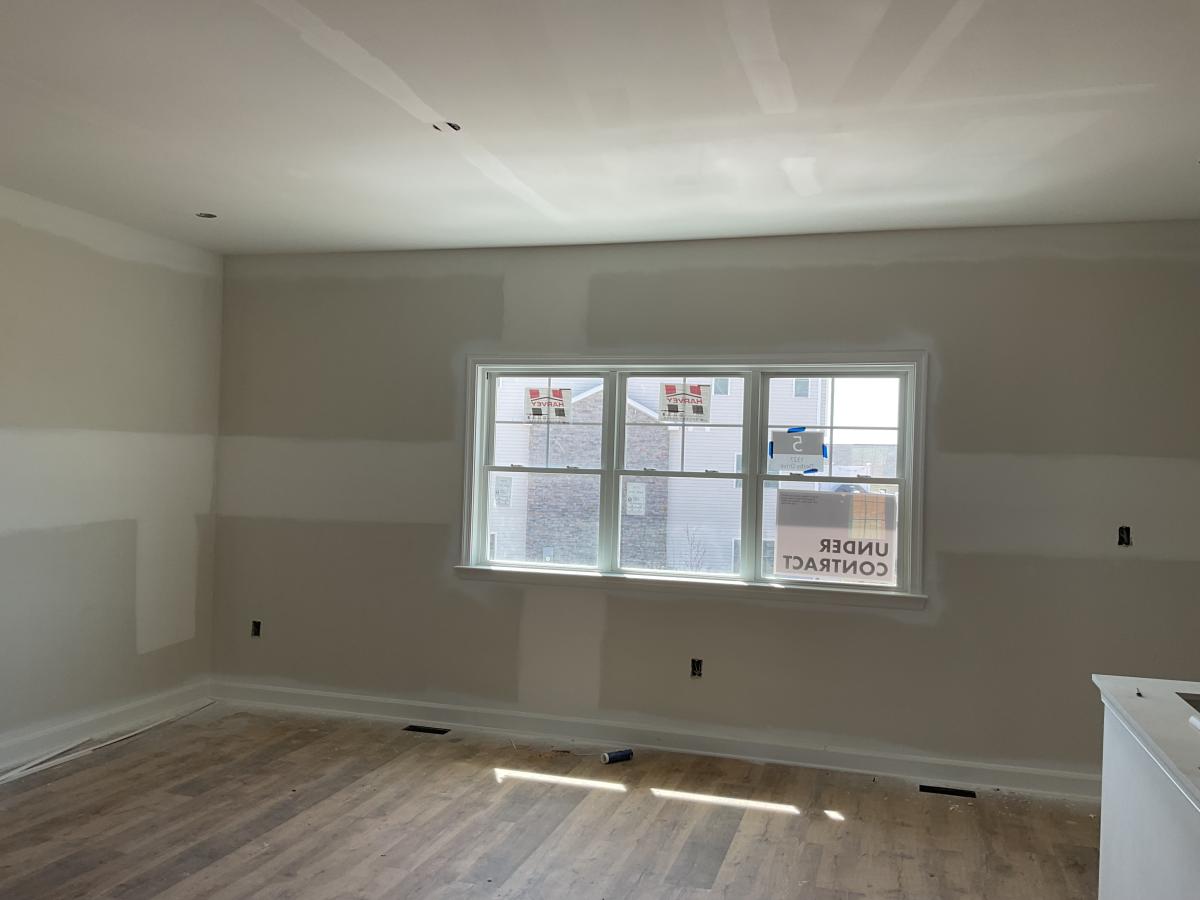

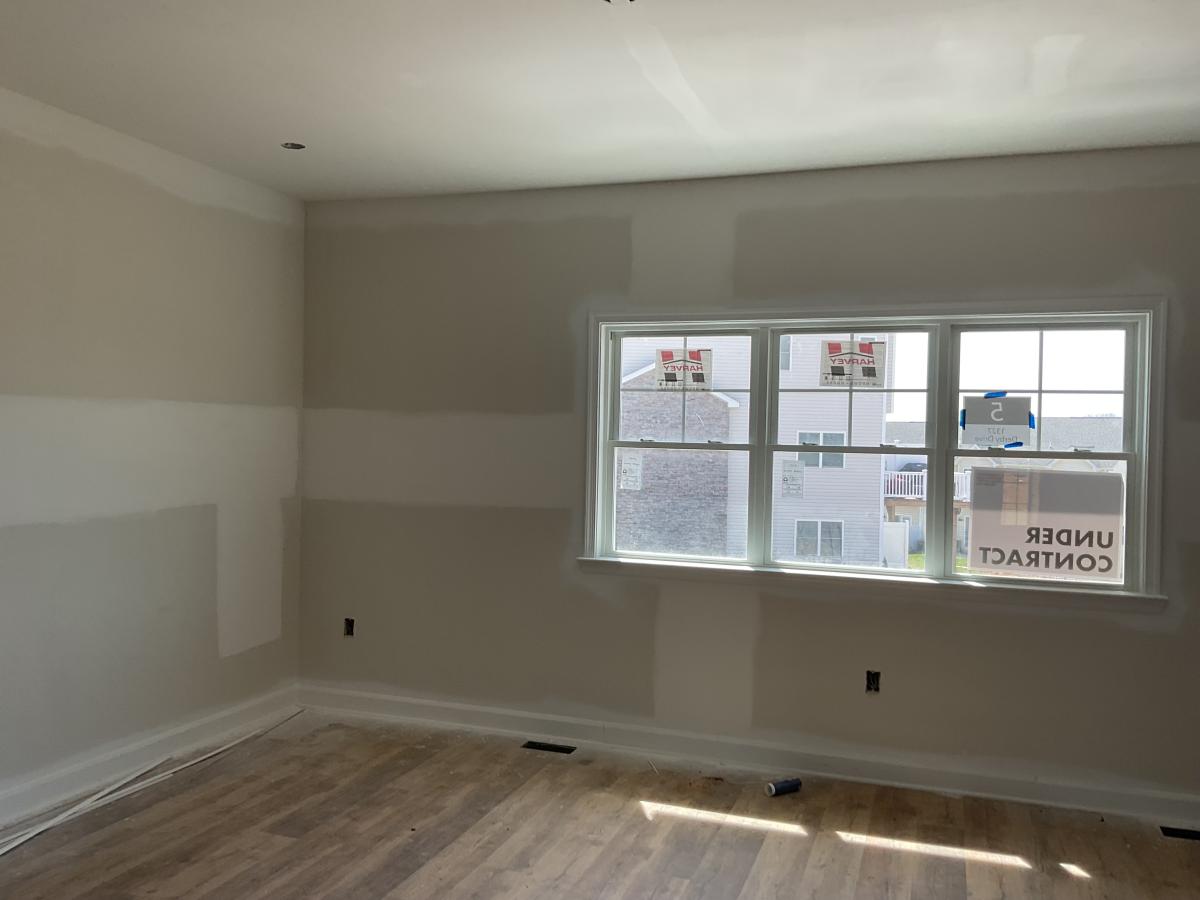

| Mon | Dec 22 | Paint 2 (3) | ||
| Thu | Dec 25 | Cover Floors (1) | ||
| Fri | Dec 26 | Deliver Plumbing / Lighting Fixtures (0) | ||
| Fri | Dec 26 | Shoe Moulding (0) | ||
| Fri | Dec 26 | Shelving, Door Knobs, Fire Extinguisher (0) * | ||
| Fri | Dec 26 | Install Coded Lockbox (add extra keys) (0) | ||
| Fri | Dec 26 | Pay Water / Sewer Taps (0) | ||
| Fri | Dec 26 | Set Water Meter (0) * | ||
| Fri | Dec 26 | Electric Trim Out (3) * | ||
| Wed | Dec 31 | Ceiling Fans (0) | ||

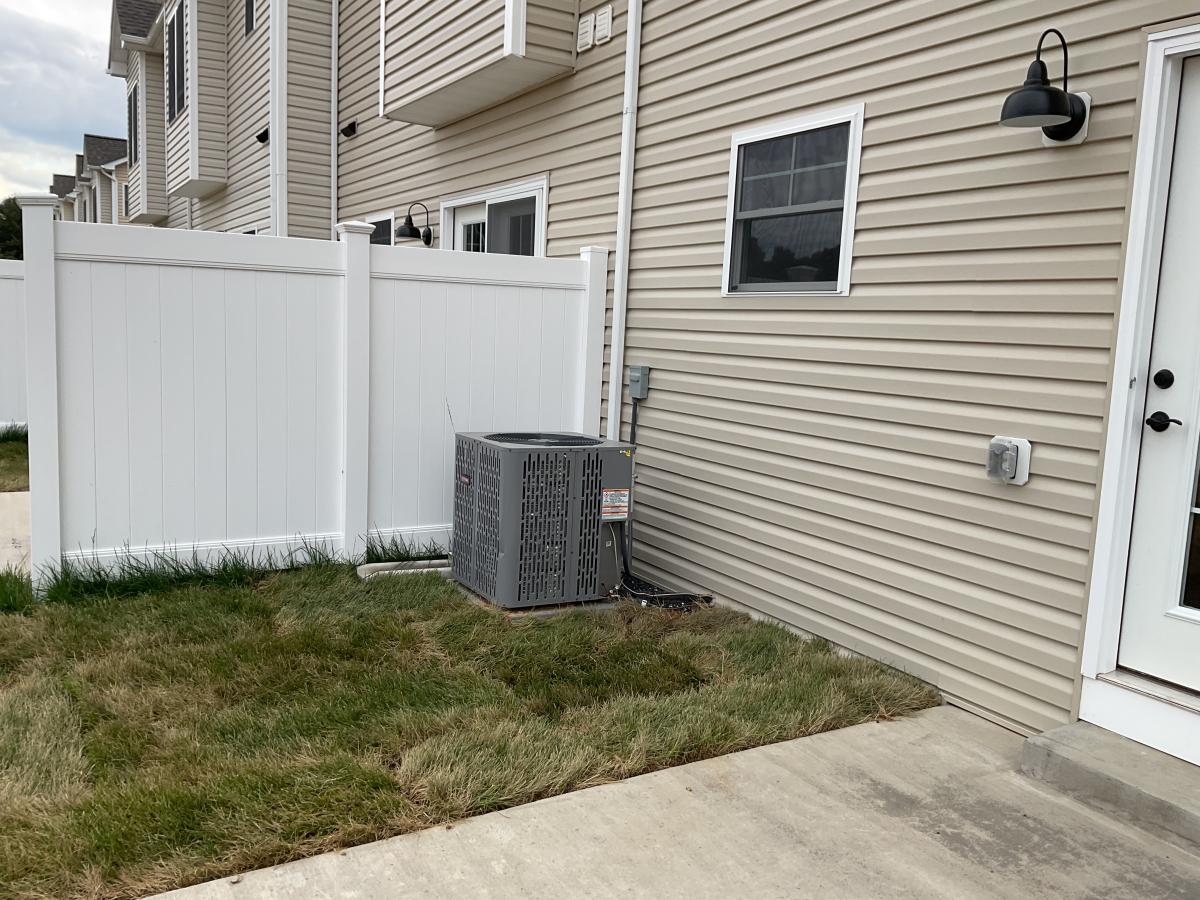

| Wed | Dec 31 | HVAC Trim Out (1) * | ||
| Thu | Jan 1 | Blower Door Test (1) | ||

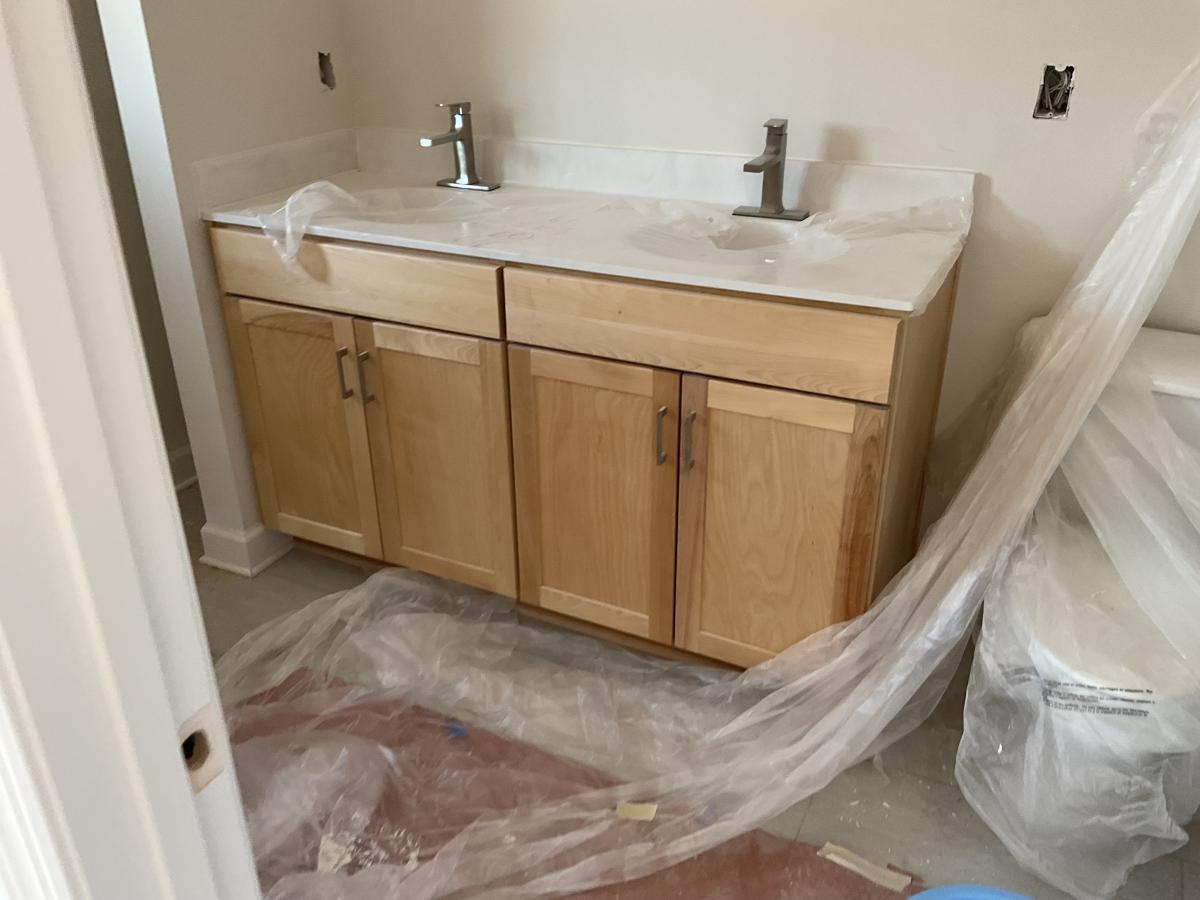

| Fri | Jan 2 | Plumbing Trim Out (2) * | ||

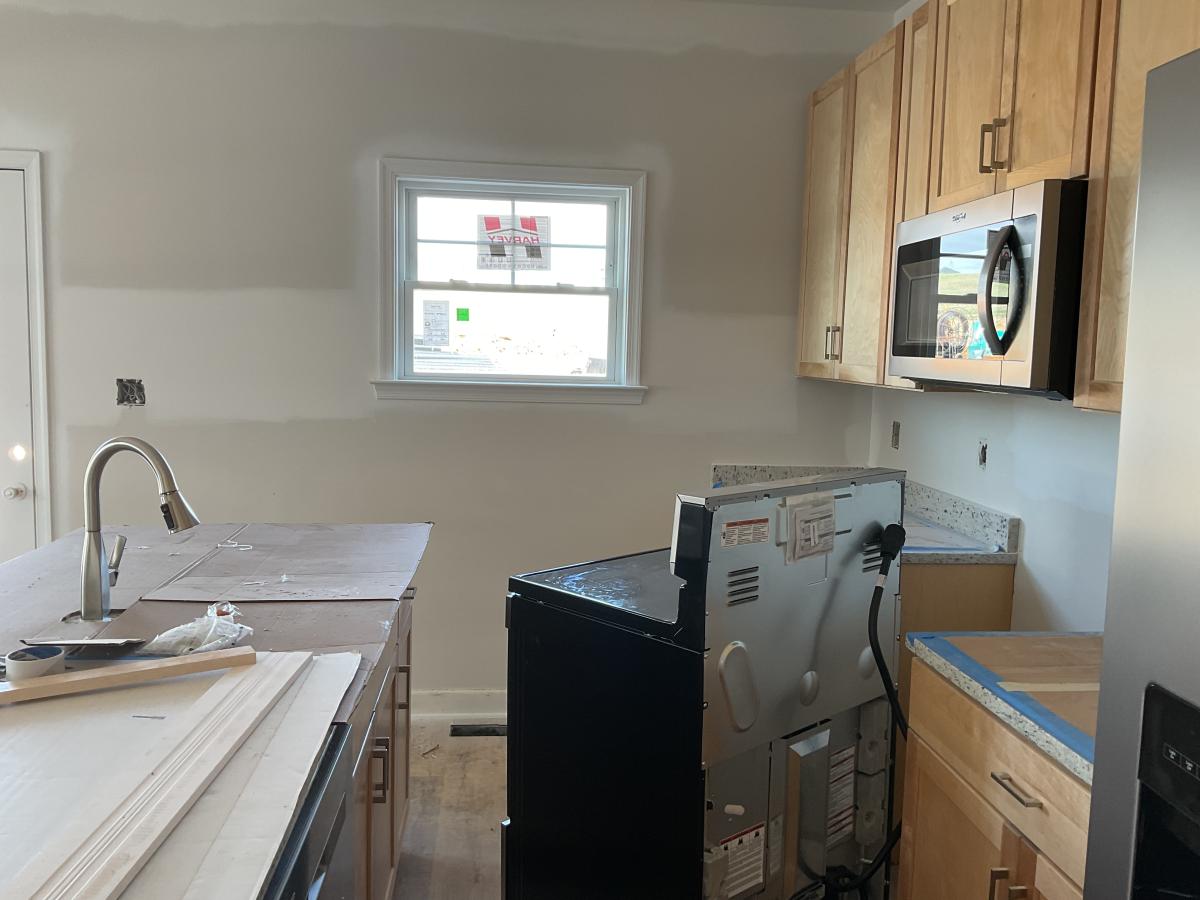

| Tue | Jan 6 | Install Appliances (0) * | ||
| Tue | Jan 6 | Paint 3 (2) * | ||
| Thu | Jan 8 | Carpet (2) | ||
| Mon | Jan 12 | Appraiser Confirms Construction Completion (0) | ||
| Mon | Jan 12 | Inspection (Final HVAC) (1) | ||
| Tue | Jan 13 | Inspection (Final Plumbing) (1) | ||
| Wed | Jan 14 | Inspection (Final Electric) (1) | ||
| Thu | Jan 15 | Inspection (Final Building) (2) * | ||
| Mon | Jan 19 | Pre Walk Through (0) | ||

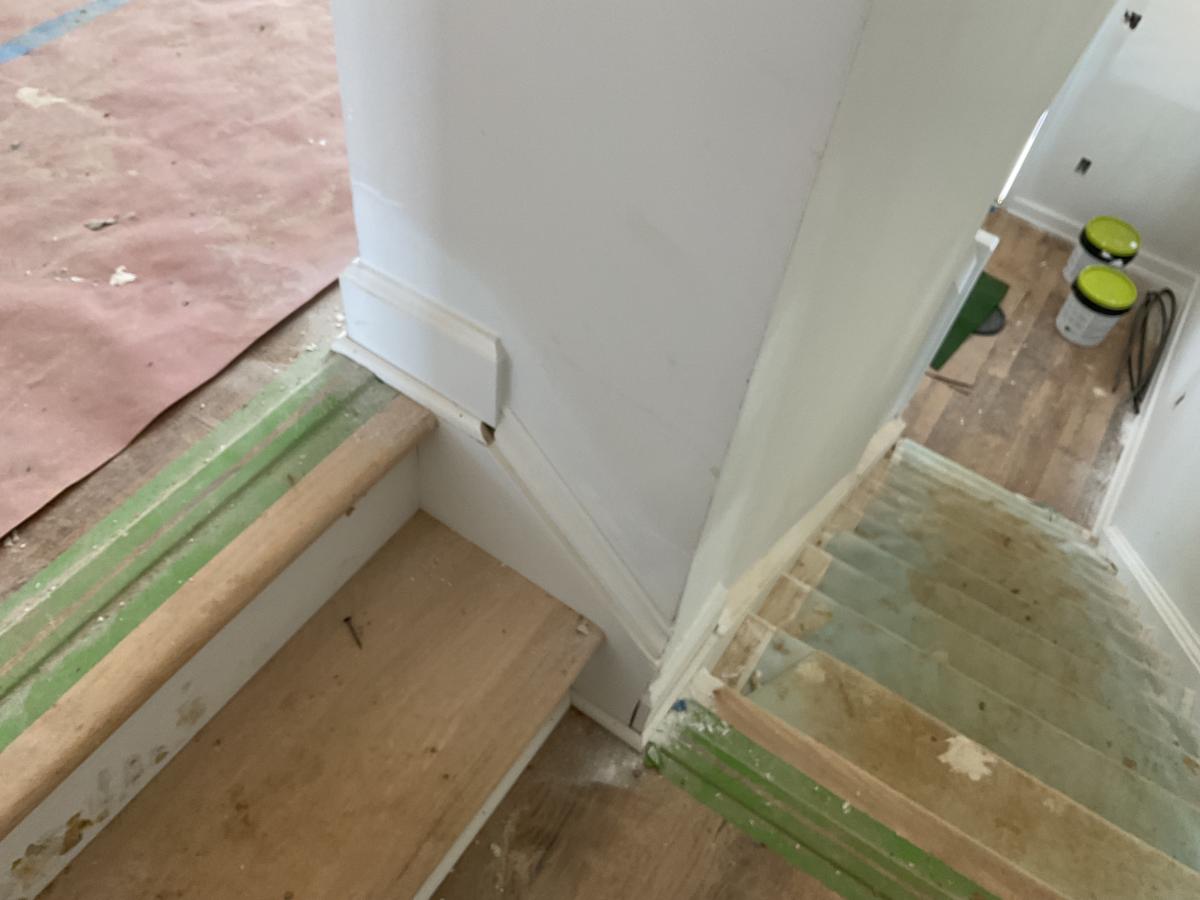

| Mon | Jan 19 | Stain Hardwood Stairs (1) * | ||
| Tue | Jan 20 | Cleaning (1) | ||
| Wed | Jan 21 | Certificate of Occupancy (1) * | ||
| Thu | Jan 22 | C.O. to Lender (0) | ||
| Thu | Jan 22 | Schedule Closing (0) | ||
| Thu | Jan 22 | Buyer Walk Through (1) * | ||
| Fri | Jan 23 | Payment for Upgrades (0) | ||
| Fri | Jan 23 | Keys to Settlement Agent (0) | ||
| Fri | Jan 23 | Review Settlement Statement (0) | ||
| Fri | Jan 23 | Jerry Signs Closing Documents (0) | ||
| Fri | Jan 23 | Request Trash Tote From POA Manager (0) | ||
| Fri | Jan 23 | Closing (1) | Brittany @ West View Title | |
| Mon | Jan 26 | Remove Coded Lockbox (0) | ||
| -- | -- | No window in bonus room | ||

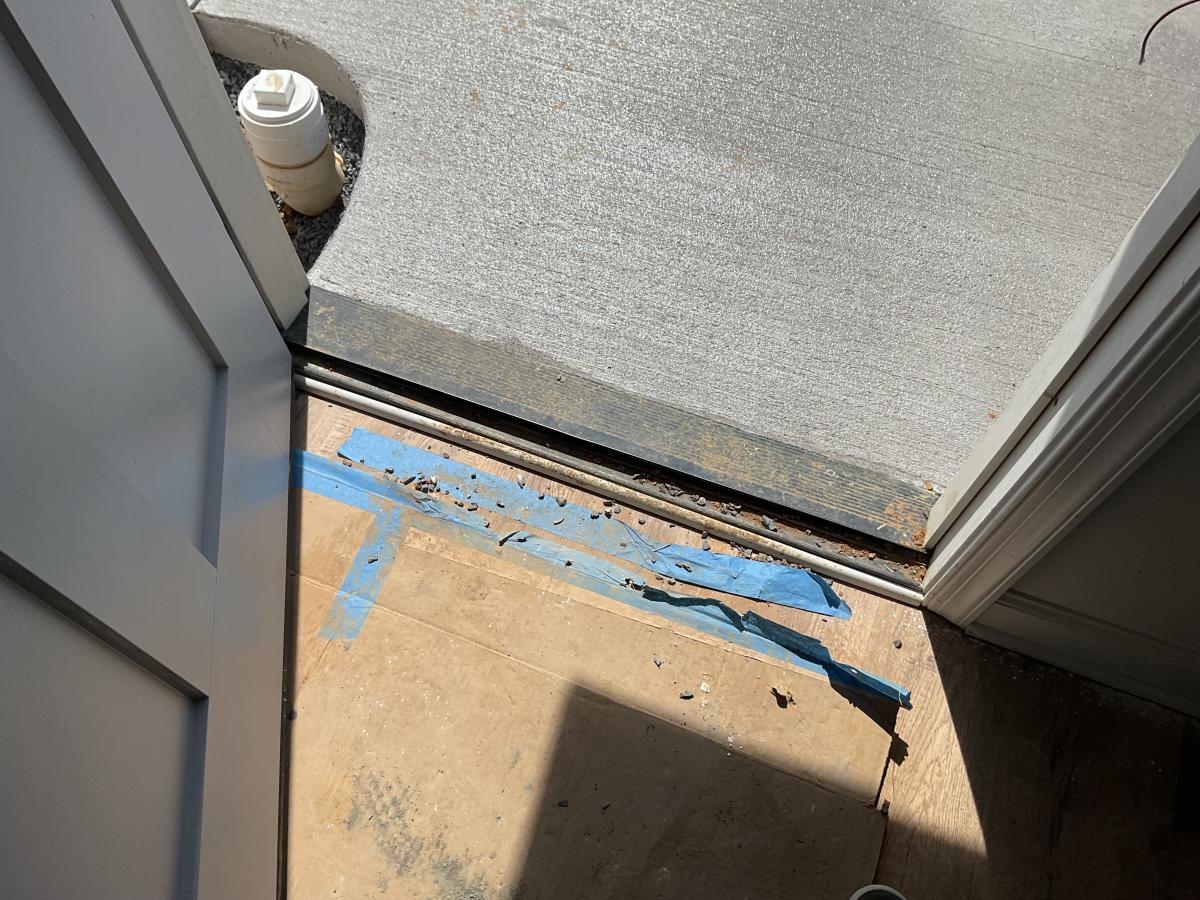

| -- | -- | Cover up pipe outside that looks like a trap hazard | ||
| -- | -- | Ratified Contract? (0) 07.21.2025 | ||
| Amendment to increase price by $6,020 | ||||
| -- | -- | $2500 Deposit Received (0) 07.29.2025 | ||
| -- | -- | Association Packet Requested (0) 07.21.2025 | ||
| -- | -- | Association Packet Received (0) 07.29.2025 | ||
| -- | -- | Selections Meeting (0) 08.21.2025 | ||
| -- | -- | Selections Sheet Signed (0) 08.21.2025 | ||
| -- | -- | Amendment for Upgrades (B,S,L,T,BCP) (0) 08.29.2025 | ||
| -- | -- | Deposit For Upgrades Received (0) 08.29.2025 | ||
| -- | -- | Building Permit (30) * 05.24.2025 | ||
| -- | -- | Order Roof & Floor Trusses (1) 09.15.2025 | ||
| -- | -- | Order Windows & Doors (0) 10.09.2025 | ||
| -- | -- | Stake Out Home (1) 05.29.2025 | ||

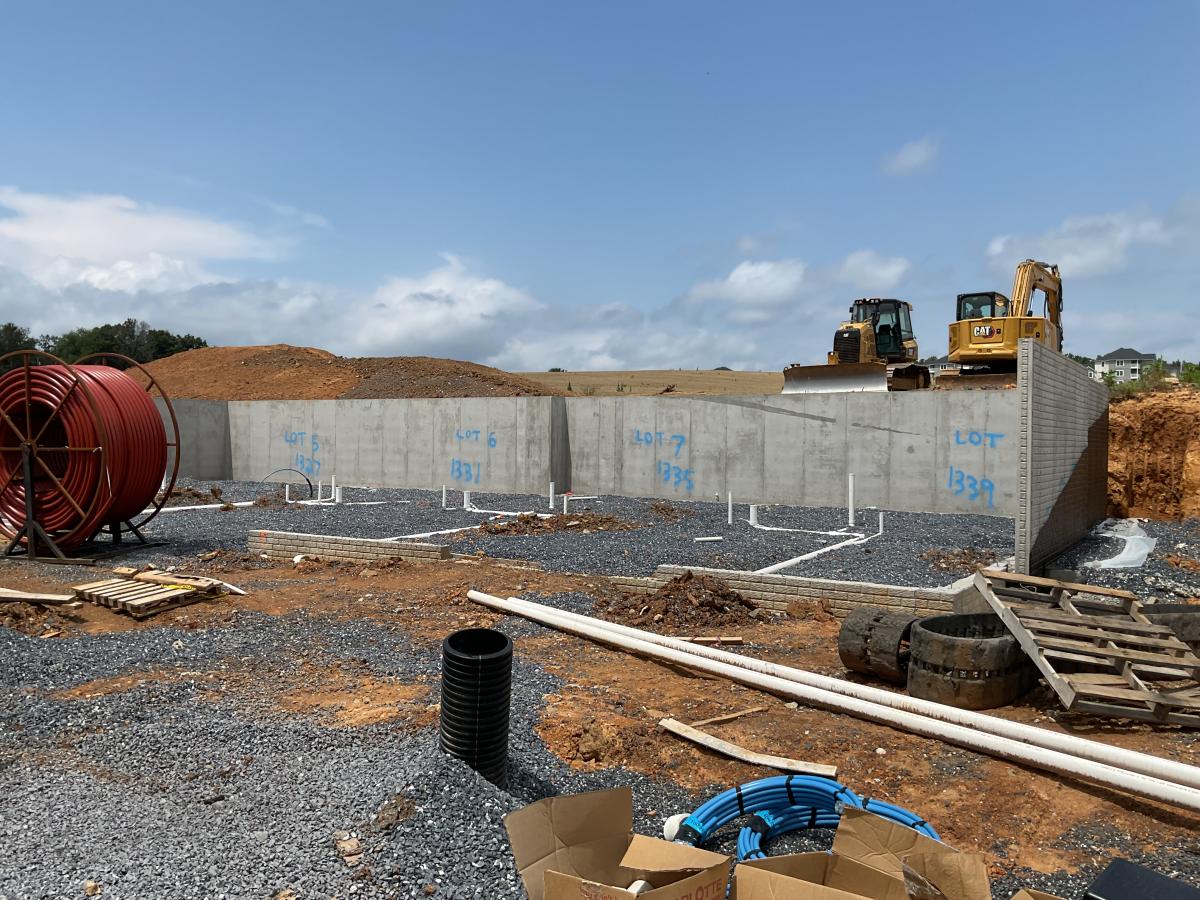

| -- | -- | Excavate (2) 05.29.2025 | ||
| -- | -- | Inspection (Footers) (1) 06.02.2025 | ||
| -- | -- | Inspection (Concrete Wall) (1) 08.25.2025 | ||

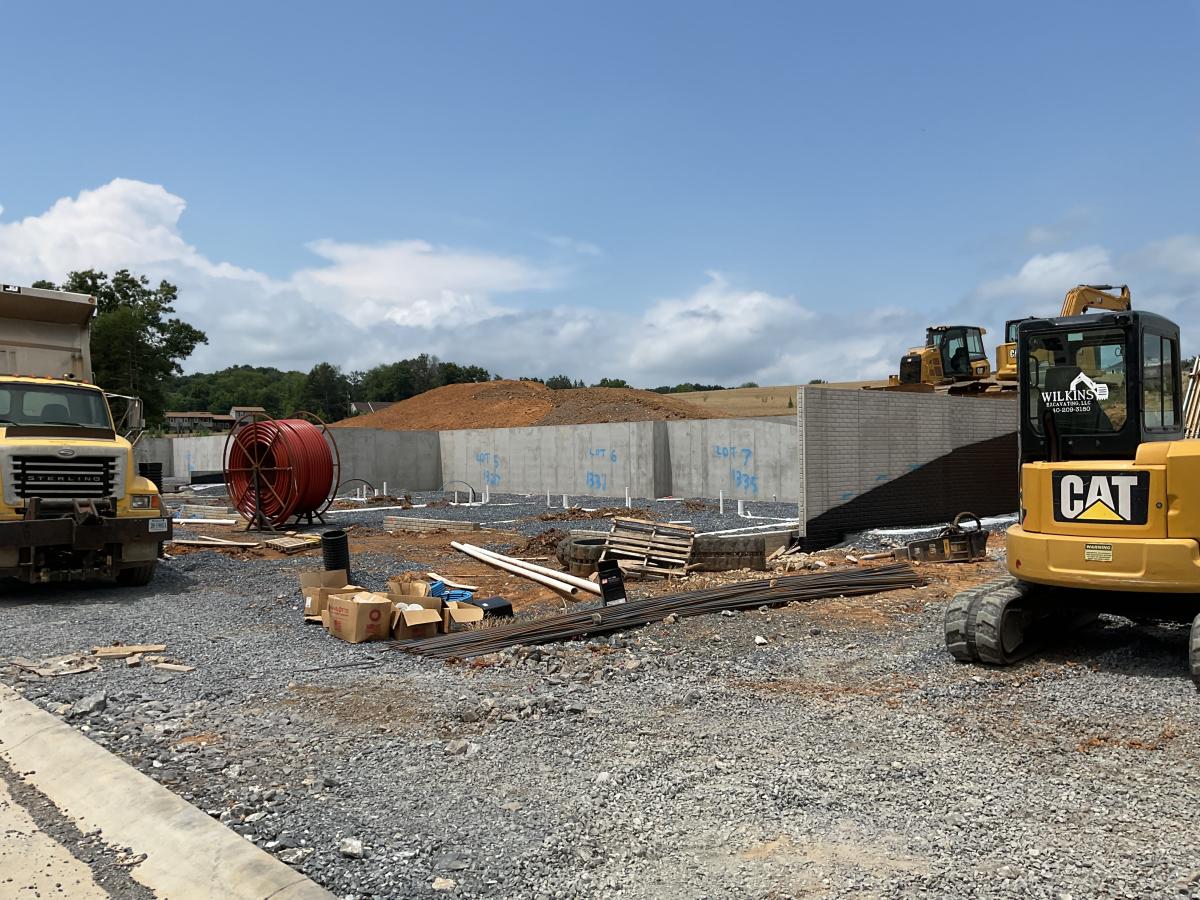

| -- | -- | Pour Footers (1) * 06.02.2025 | ||
| -- | -- | Set Forms (2) 06.05.2025 | ||

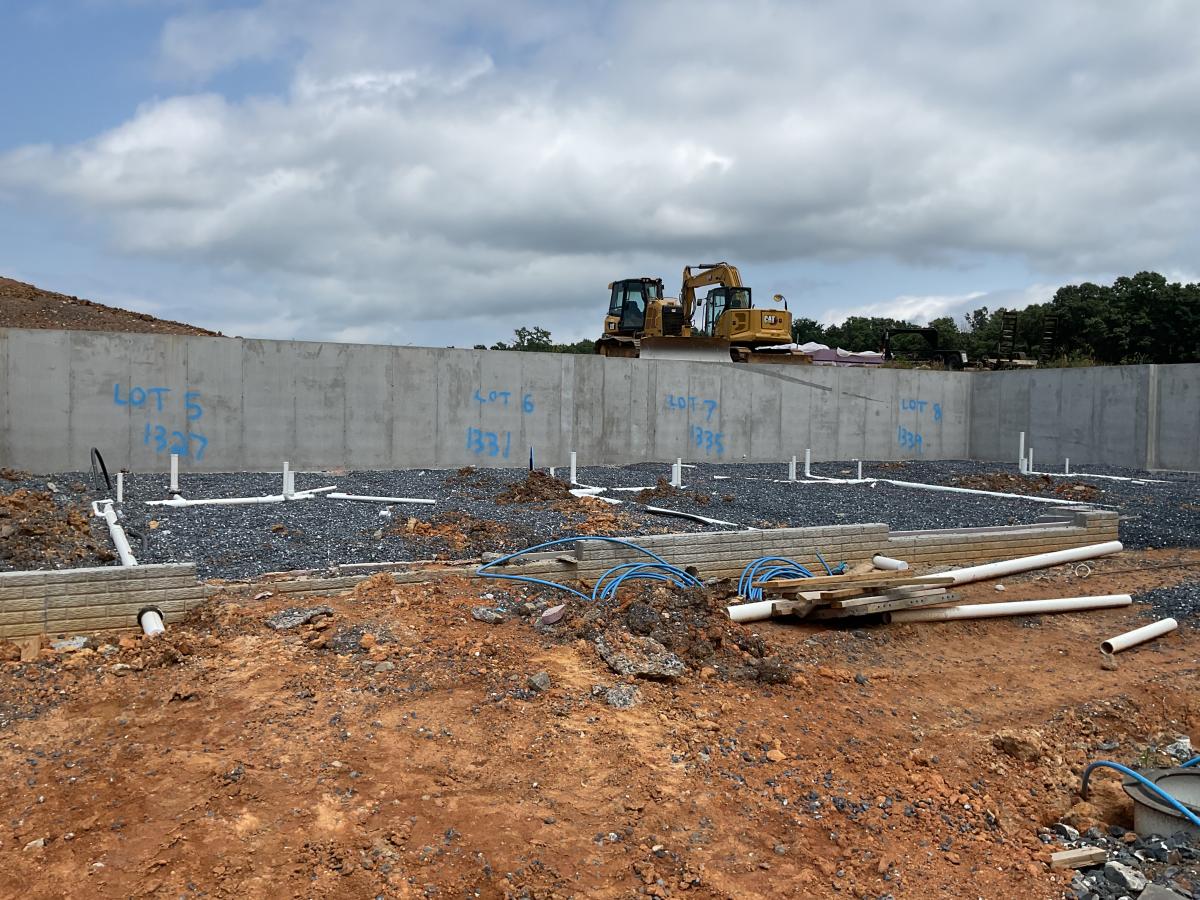

| -- | -- | Pour Foundation Walls (1) 07.31.2025 | ||
| -- | -- | Plumb Slab (2) 07.31.2025 | ||
| -- | -- | Inspection (Plumbing Under Slab) (1) 08.25.2025 | ||
| -- | -- | Inspection (Conduit Under Slab) (1) 08.25.2025 | ||
| -- | -- | Prepare Slab (1) 08.07.2025 | ||
| -- | -- | Inspection (Slab) (1) 08.25.2025 | ||
| -- | -- | Inspection (Drain Tile) (0) 08.25.2025 | ||
| -- | -- | Pour Slab (1) * 09.04.2025 | ||
| -- | -- | Settlement Agent Confirmed (0) 10.25.2025 | ||

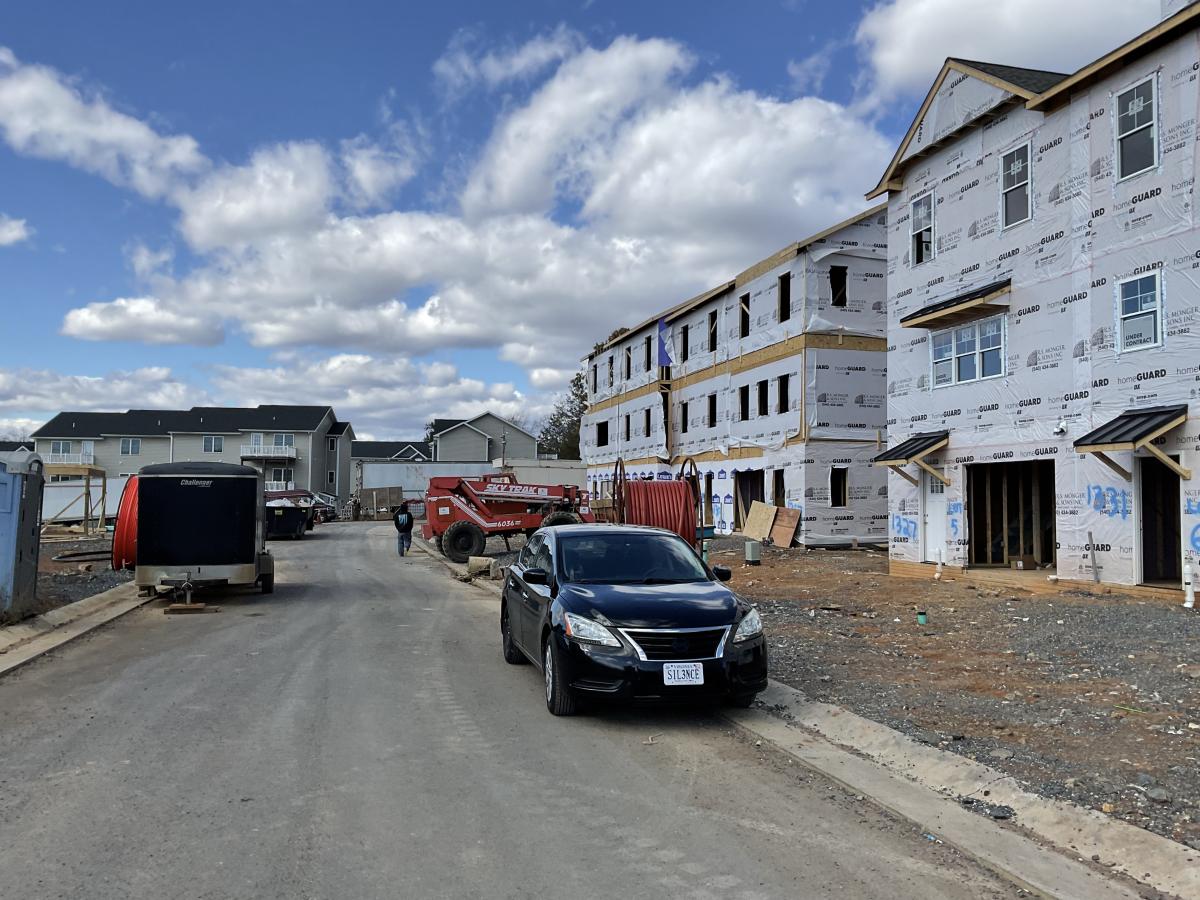

| -- | -- | Framing I (9) 09.15.2025 | ||
| -- | -- | Order Steps (0) 10.09.2025 | ||
| -- | -- | Order Tubs / Showers (0) 10.09.2025 | ||
| -- | -- | Framing II (8) 09.17.2025 | ||
| -- | -- | Framing III (8) * 10.09.2025 | ||
| -- | -- | Verify Window & Roof Structure (0) 10.09.2025 | ||
| -- | -- | Install Stairs (0) * 10.15.2025 | ||

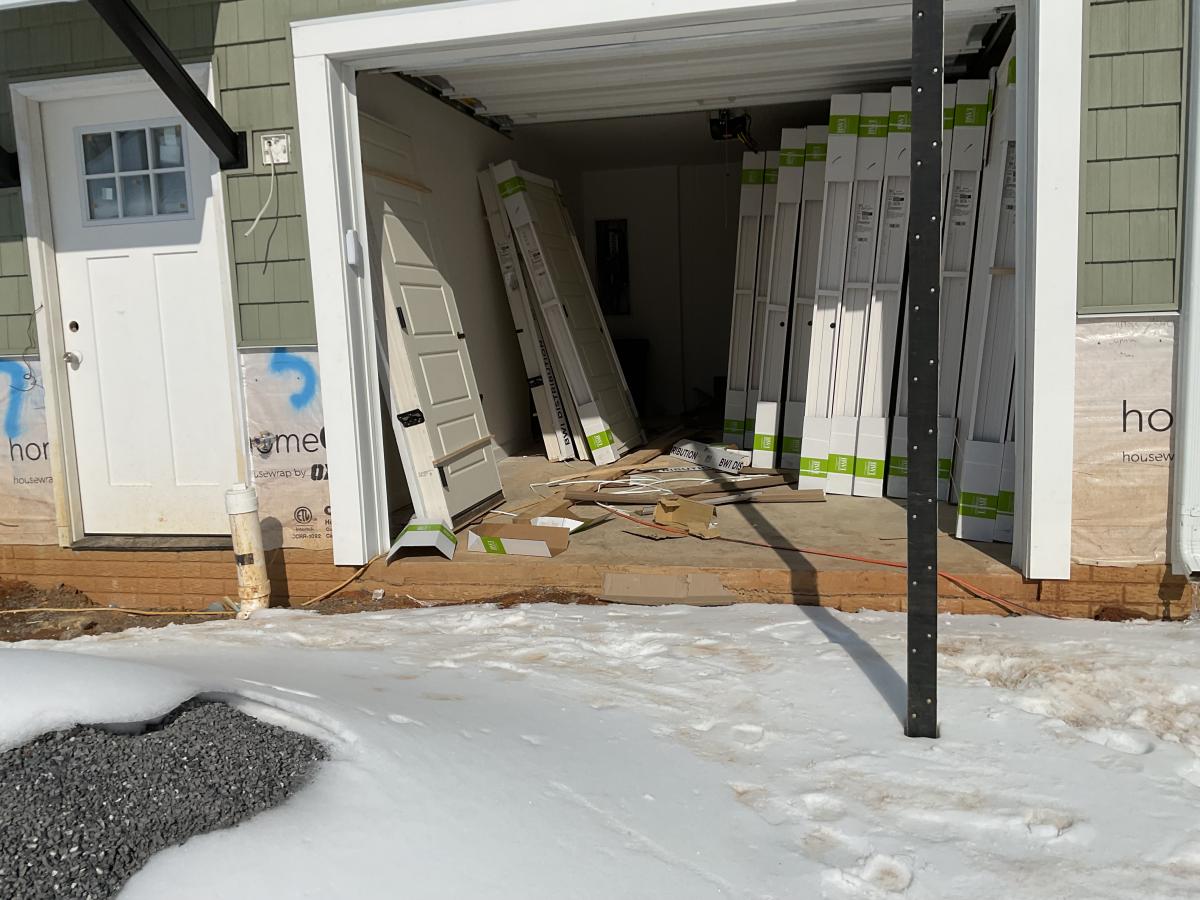

| -- | -- | Windows & Doors (0) * 10.15.2025 | ||
| -- | -- | House Number and Status in Window (0) 10.22.2025 | ||
| -- | -- | Roofing (0) * 10.15.2025 | ||
| -- | -- | Order Cabinets (0) 10.25.2025 | ||

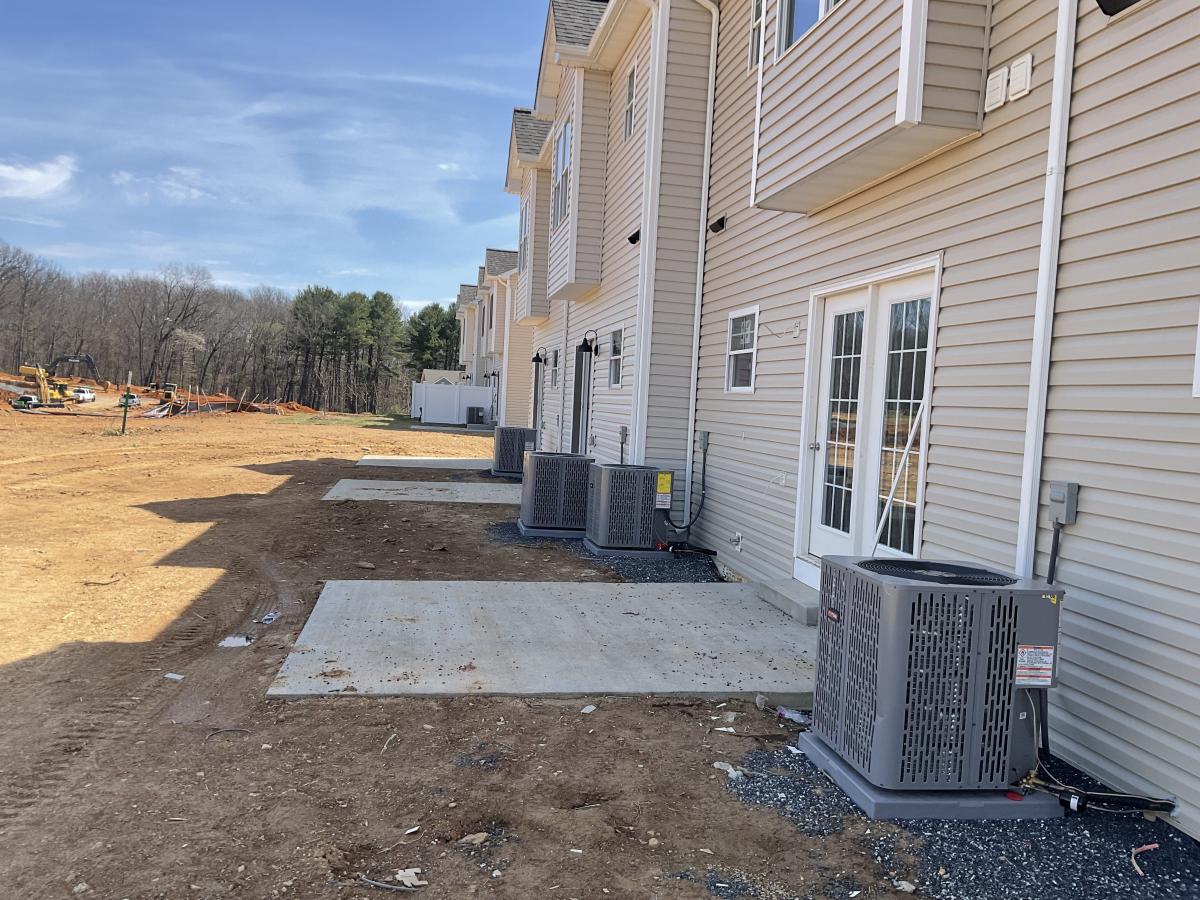

| -- | -- | HVAC Rough In (4) 10.15.2025 | ||
| -- | -- | Rough In Microwave Vent (0) 10.15.2025 | ||
| -- | -- | Inspection (Main Sewer Line) (0) 08.18.2025 | ||
| -- | -- | Inspection (Main Water Line) (0) 08.18.2025 | ||
