VILLAS - 501-301  ::  501 Roman Way #301
CRITICAL PATH   |   INSPECTIONS   |   FLOOR PLANS   |   SELECTIONS   |   SPECS   |   CHANGES   |   NHS
view photo archive

TO DO
---
UPGRADES
---
CRITICAL PATH
---
TO DO - COMPLETED OR DELETED
CL Mar 12 (163) Finish drywall over the sprinkler line in kitchen 3/11
CL Apr 16 (128) Drywall repairs needed on arch
CL May 9 (105) Countertop is too small
CL May 9 (105) Does sink need to be reinforced where it’s split on the back panel?
CL May 27 (87) Stairs in process (not accessible) 5/27
CL May 31 (83) The two fans in this condo have three blades, the rest of the building has five blade fans
CL Jun 10 (73) Install attic cover
CL Jun 13 (70) Few ceiling blemishes need to be painted Jesus
CL Jun 13 (70) Caulk inside panels of all sinks Side splash, Jesus
CL Jun 13 (70) Few touchups needed in bedroom Jesus
CL Jun 17 (66) Washer and dryer unit is very crooked Tom
CL Jun 21 (62) Some type of alarm is still needed near entryway Jesus
CL Jun 21 (62) Install vent in bedroom ceiling Jesus
CL Jun 21 (62) Touchup paint unit in bedroom in a few spots marked with blue tape Jesus
CL Jun 24 (59) Install hanger that goes near front door
CL Jun 29 (54) Patio set needed here
CL Jun 29 (54) Front door is quite difficult to open Tom
CL Jul 8 (45) Few touch up places
CL Jul 8 (45) Touchup top of shower
UPGRADES - COMPLETED
---
CRITICAL PATH - COMPLETED
-- -- Ratified Contract? (0)  09.25.2025
-- -- $2500 Deposit Received (0)  09.25.2025
-- -- Association Packet Requested (0)  09.25.2025
-- -- Association Packet Received (0)  09.25.2025
-- -- Selections Meeting (0)  09.25.2025
-- -- Selections Sheet Signed (0)  09.25.2025
-- -- Amendment for Upgrades (B,S,L,T,BCP) (0)  09.25.2025
-- -- Deposit For Upgrades Received (0)  09.25.2025
-- -- Building Permit (30) *   09.25.2025
-- -- Order Roof & Floor Trusses (0)  09.25.2025
-- -- Order Windows & Doors (0)  09.25.2025
-- -- Stake Out Home (1)  09.25.2025
-- -- Excavate (2)  09.25.2025
-- -- Inspection (Footers) (1)  09.25.2025
-- -- Pour Footers (1) *   05.08.2026
-- -- Set Forms (2)  09.25.2025
-- -- Inspection (Concrete Wall) (1)  09.25.2025
-- -- Pour Foundation Walls (1)  09.25.2025
-- -- Plumb Slab (2)  09.25.2025
-- -- Inspection (Plumbing Under Slab) (1)  09.25.2025
-- -- Inspection (Conduit Under Slab) (1)  09.25.2025
-- -- Prepare Slab (1)  09.25.2025
-- -- Inspection (Slab) (1)  09.25.2025
-- -- Inspection (Drain Tile) (0)  09.25.2025
-- -- Pour Slab (1) *   09.25.2025
-- -- Settlement Agent Confirmed (0)  09.25.2025

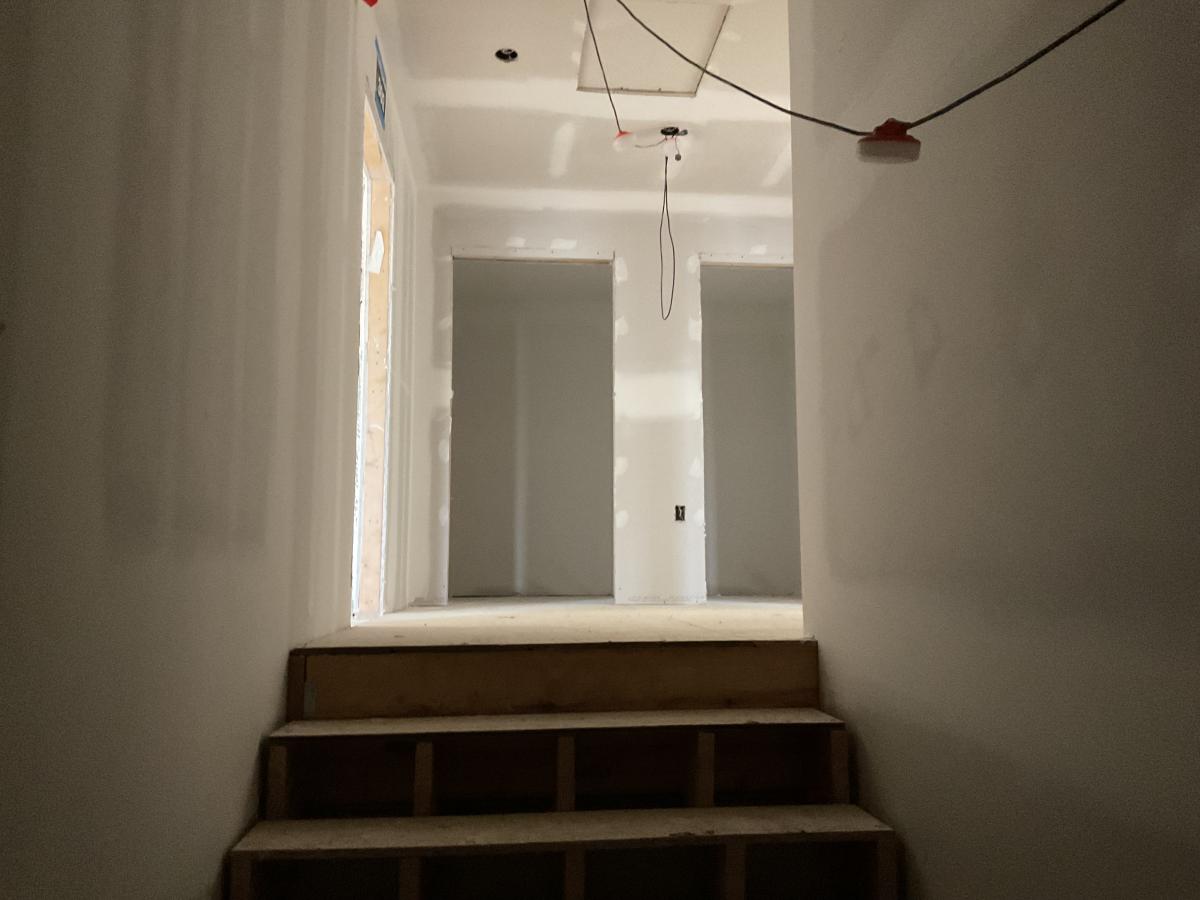

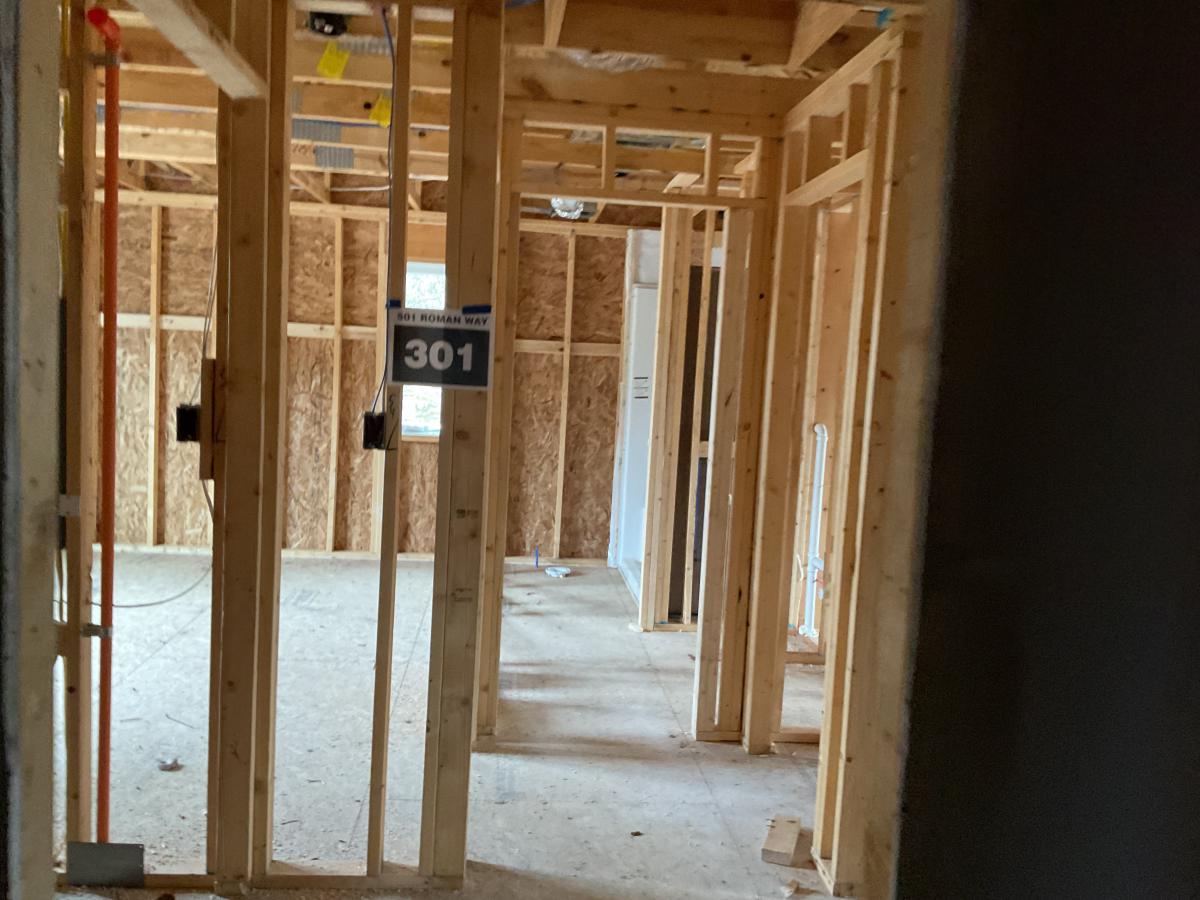

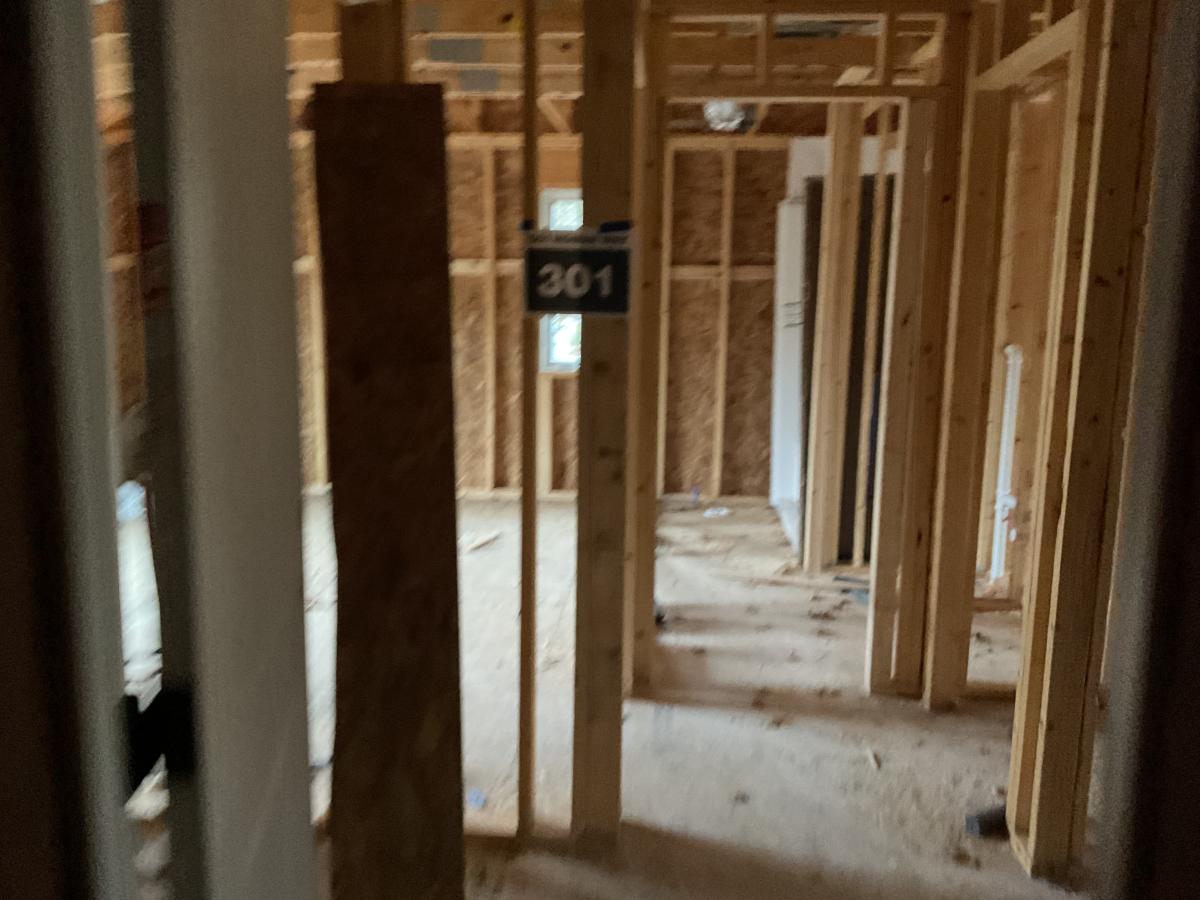

-- -- Framing I (9)  09.25.2025
-- -- Order Steps (0)  09.25.2025
-- -- Order Tubs / Showers (0)  09.25.2025
-- -- Framing II (8)  09.25.2025
-- -- Framing III (8) *   09.25.2025
-- -- Verify Window & Roof Structure (0)  09.25.2025
-- -- Install Stairs (0) *   10.02.2025
-- -- Windows & Doors (0) *   10.27.2025
-- -- House Number and Status in Window (0)  05.27.2026
-- -- Roofing (0) *   09.25.2025
-- -- Order Cabinets (0)  10.16.2025
-- -- Order Appliances (0)  05.21.2026
-- -- Deck (0)  10.27.2025
-- -- Gutters (0)  03.23.2026
-- -- Driveway (0) *   02.19.2026
-- -- Patio (0)  04.13.2026
-- -- Privacy Divider / Fence (0) *   09.25.2025
-- -- Sod / Seed / Landscaping (0)  06.12.2026

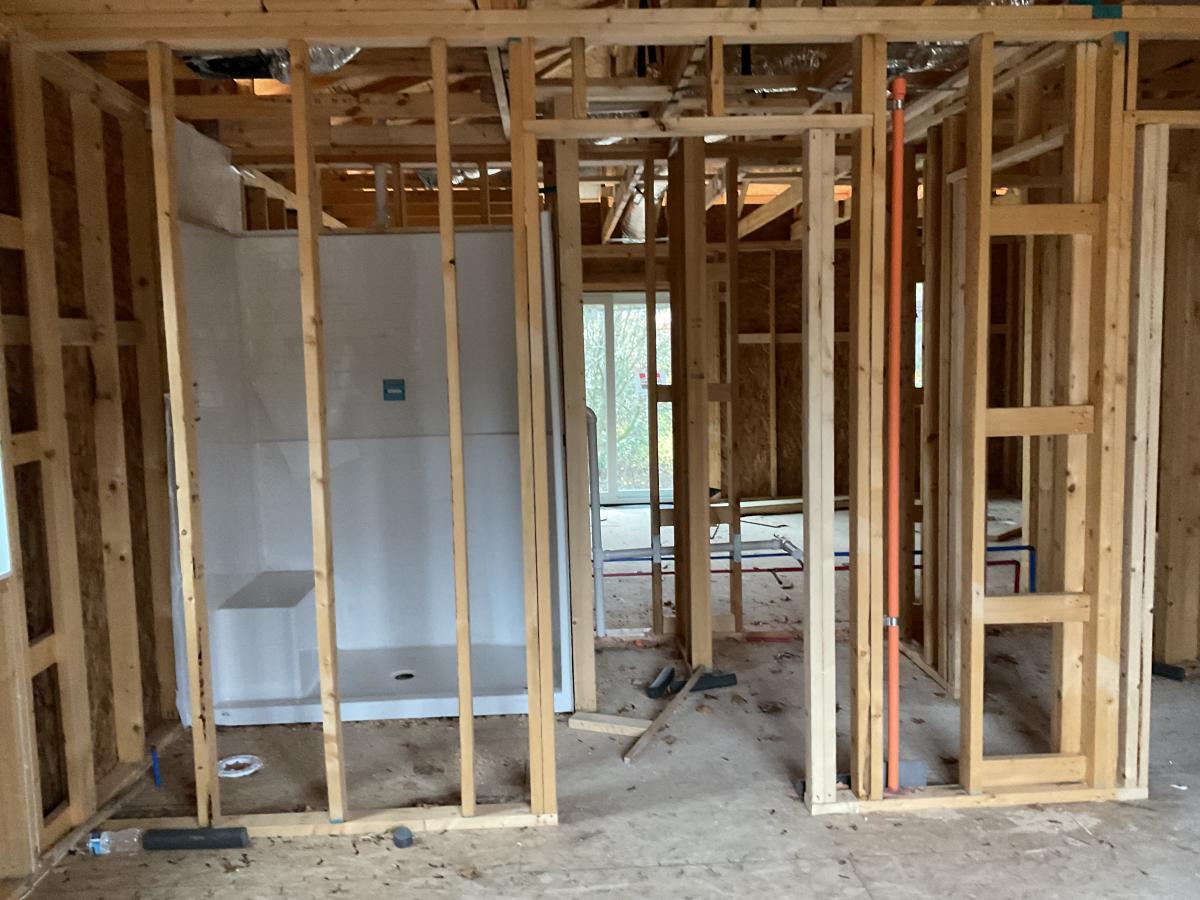

-- -- HVAC Rough In (4)  10.02.2025

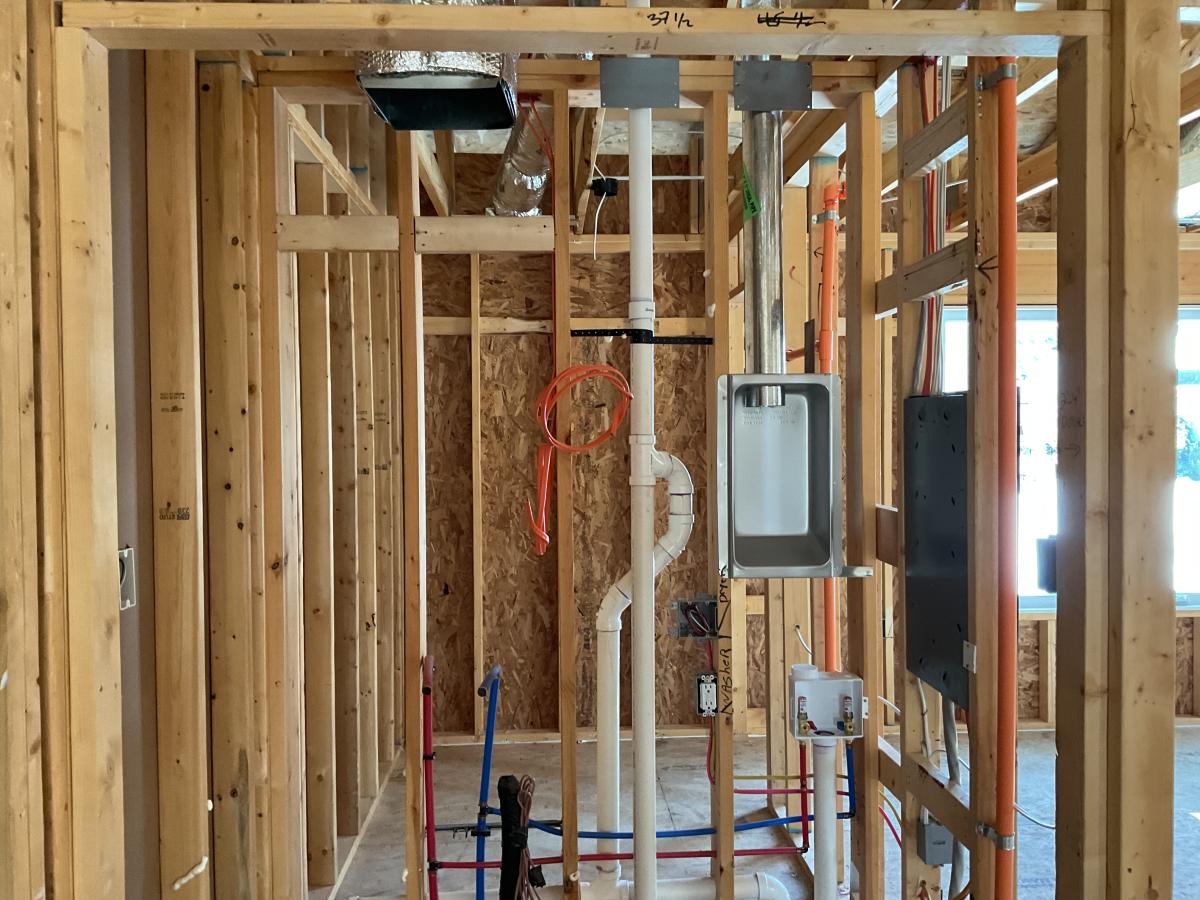

-- -- Plumbing Rough In (4)  10.09.2025
-- -- Electric Rough In (4)  01.11.2026     in process 12/3- almost completed
-- -- Inspection (Rough In HVAC) (1)  01.22.2026
-- -- Inspection (Rough In Plumbing) (1)  02.02.2026
-- -- Inspection (Rough In Electric) (1)  01.22.2026
-- -- Inspection (Framing) (1) *   02.19.2026
-- -- Inspection (Deck Piers) (0)  01.22.2026
-- -- Exterior Vinyl (0) *   02.02.2026
-- -- Exterior Stone (0)  02.02.2026
-- -- Insulation (2) *   02.19.2026
-- -- Inspection (Insulation) (1)  02.19.2026
-- -- Inspection (Electric Service) (0)  01.15.2026
-- -- Set Electric Meter (0) *   04.06.2026
-- -- Inspection (Main Sewer Line) (0)  06.11.2026
-- -- Inspection (Main Water Line) (0)  04.14.2026
-- -- Order Interior Doors & Trim (0)  03.30.2026

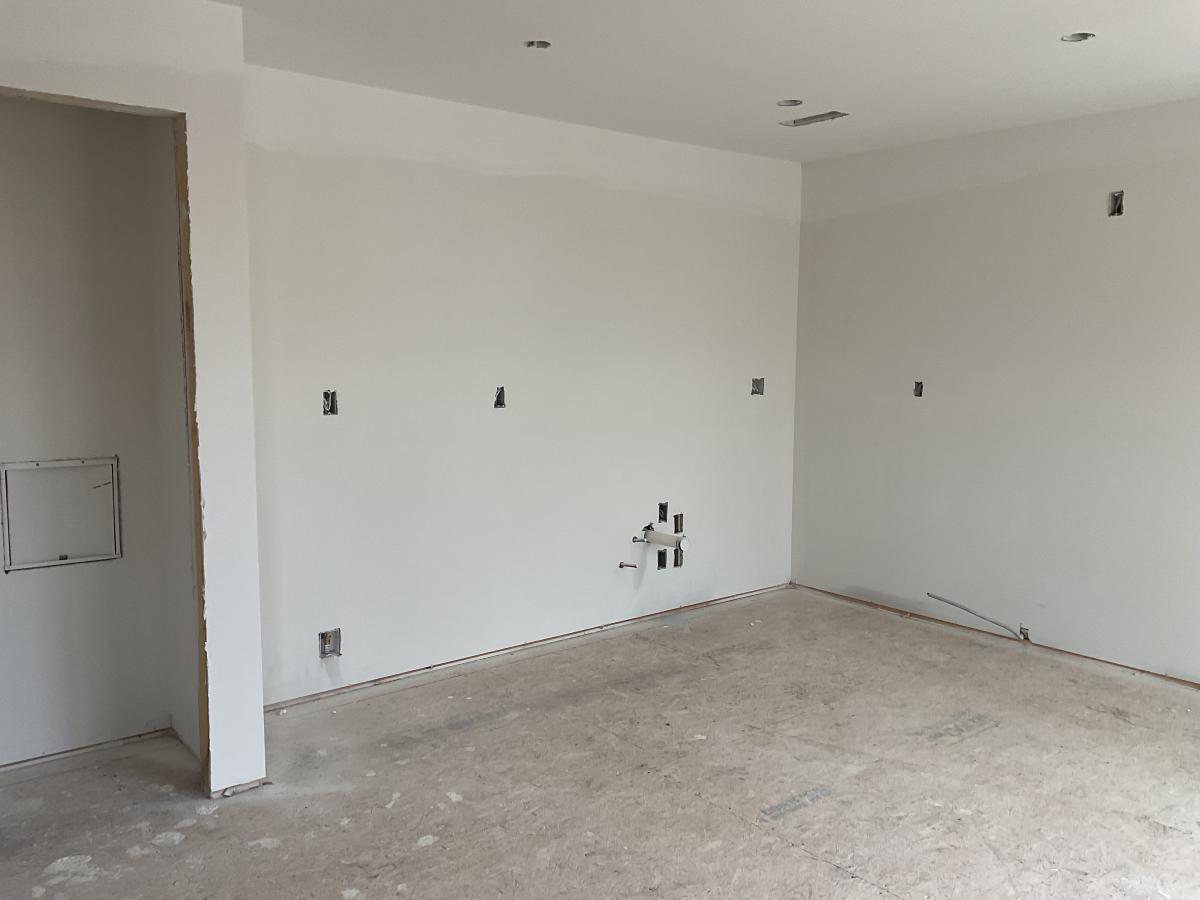

-- -- Drywall (Hang) (4) *   02.26.2026
-- -- Loan Approval (0)  09.25.2025
-- -- Deed Preparation (0)  09.25.2025

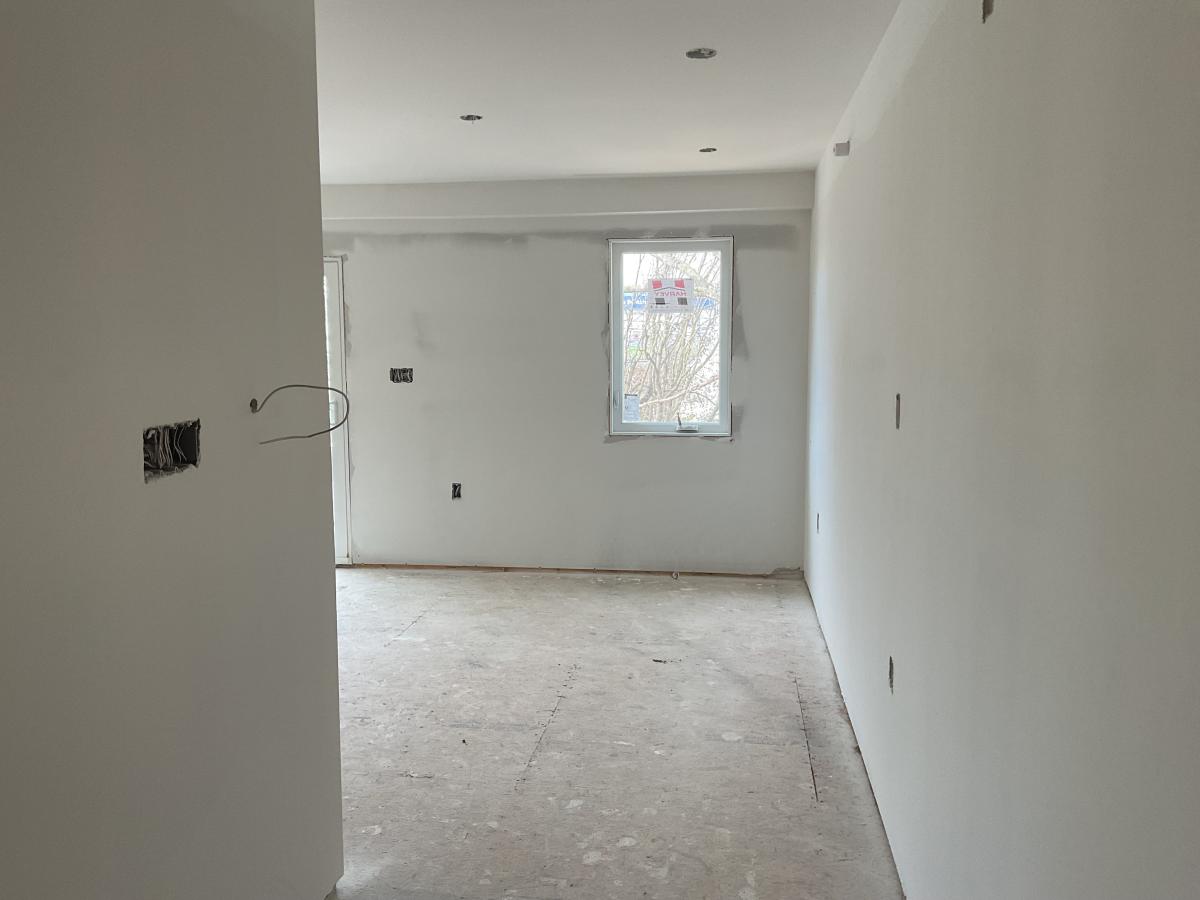

-- -- Drywall (Tape, Block, Skim, Sand) (6) *   03.12.2026     In process 3/7
-- -- Paint 1 (1)  03.16.2026
-- -- Garage Door (0)  09.25.2025
-- -- House Numbers (0)  05.27.2026
-- -- Mailbox (0)  06.04.2026

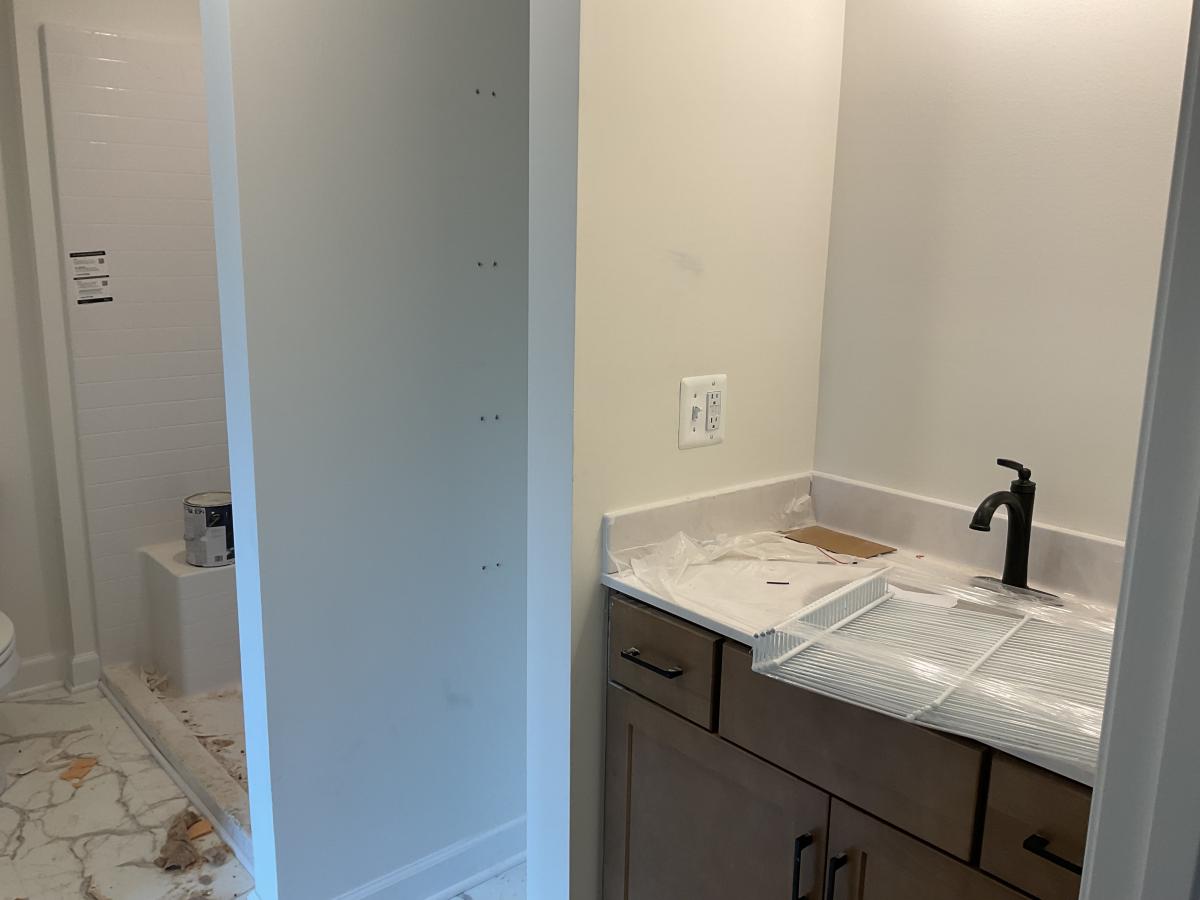

-- -- Cabinet Installation (2) *   04.04.2026
-- -- Granite Installation (1) *   04.30.2026
-- -- Interior Trim - Install (3) *   04.16.2026
-- -- Order Plumbing / Lighting Fixtures (0)  04.09.2026
-- -- Interior Trim - Paint (1)  04.23.2026
-- -- Luxury Vinyl Plank (3) *   04.30.2026
-- -- Luxury Vinyl Tile (0)  04.30.2026
-- -- Paint 2 (3)  05.09.2026     in process 5/6
-- -- Cover Floors (0)  05.27.2026
-- -- Deliver Plumbing / Lighting Fixtures (0)  05.07.2026
-- -- Shoe Moulding (0)  05.09.2026
-- -- Shelving, Door Knobs, Fire Extinguisher (1) *   06.04.2026     Needs bathroom accessories
-- -- Install Coded Lockbox (add extra keys) (0)  07.02.2026
-- -- Pay Water / Sewer Taps (0)  06.11.2026
-- -- Set Water Meter (1) *   06.15.2026
-- -- Electric Trim Out (3) *   05.14.2026

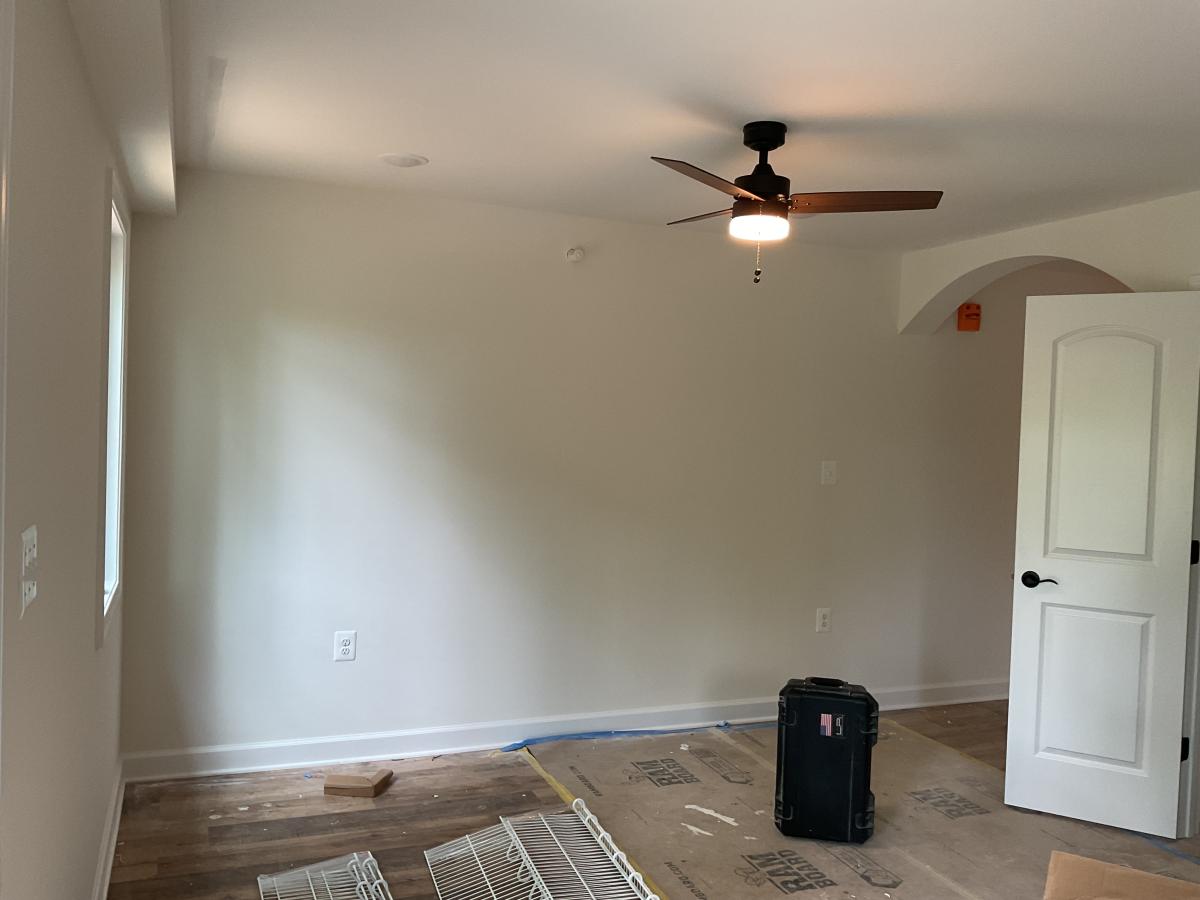

-- -- Ceiling Fans (0)  05.14.2026
-- -- HVAC Trim Out (1) *   05.14.2026
-- -- Blower Door Test (1)  07.06.2026
-- -- Plumbing Trim Out (2) *   06.10.2026     Just needs kitchen faucet 5/2
-- -- Install Appliances (0) *   06.24.2026
-- -- Paint 3 (2) *   06.13.2026
-- -- Carpet (2)  05.18.2026
-- -- Appraiser Confirms Construction Completion (0)  09.25.2025
-- -- Inspection (Final HVAC) (0)  06.25.2026
-- -- Inspection (Final Plumbing) (0)  06.25.2026
-- -- Inspection (Final Electric) (0)  06.25.2026
-- -- Inspection (Final Building) (4) *   07.15.2026
-- -- Pre Walk Through (0)  06.25.2026
-- -- Stain Hardwood Stairs (1) *   06.29.2026
-- -- Cleaning (1)  06.29.2026
-- -- Certificate of Occupancy (1) *   07.30.2026
-- -- C.O. to Lender (0)  09.25.2025
-- -- Schedule Closing (0)  09.25.2025
-- -- Buyer Walk Through (1) *   09.25.2025
-- -- Payment for Upgrades (0)  09.25.2025
-- -- Keys to Settlement Agent (0)  06.25.2026
-- -- Review Settlement Statement (0)  09.25.2025
-- -- Jerry Signs Closing Documents (0)  09.25.2025
-- -- Request Trash Tote From POA Manager (0)  06.25.2026
-- -- Closing (1)  06.25.2026
-- -- Remove Coded Lockbox (0)  06.25.2026
